Greenway construction progress

No completion date is registered for Greenway in Dubai World Central yet. At the last site inspection, in July 2026, it was 39% built. The developer is Emaar Dubai South Dwc.

39%

Built, at the site inspection of 20 July 2026

Finish at recent pace
August 2028
Construction started
October 2024
First registered
April 2024
Units
232
Escrow bank
Dubai Islamic Bank
Name in Arabic
جرينواي
Project number
3032
Site inspections
8

Schedule

Since September 2025 Greenway has added about 2.4 points a month. At that rate the site reaches 100% around August 2028. No completion date is on record to compare it with.

0%25%50%75%100%20252026
Progress at each site inspection

Site inspections

20 July 2026

39%+6.8 pts

  • Greenway construction site, inspection photo 1, 20 July 2026
  • Greenway construction site, inspection photo 2, 20 July 2026
  • Greenway construction site, inspection photo 3, 20 July 2026
  • Greenway construction site, inspection photo 4, 20 July 2026

17 March 2026

32%+9.1 pts

  • Greenway construction site, inspection photo 1, 17 March 2026
  • Greenway construction site, inspection photo 2, 17 March 2026
  • Greenway construction site, inspection photo 3, 17 March 2026
  • Greenway construction site, inspection photo 4, 17 March 2026

12 December 2025

23%+8.4 pts

  • Greenway construction site, inspection photo 1, 12 December 2025
  • Greenway construction site, inspection photo 2, 12 December 2025
  • Greenway construction site, inspection photo 3, 12 December 2025
  • Greenway construction site, inspection photo 4, 12 December 2025

19 September 2025

15%+7.8 pts

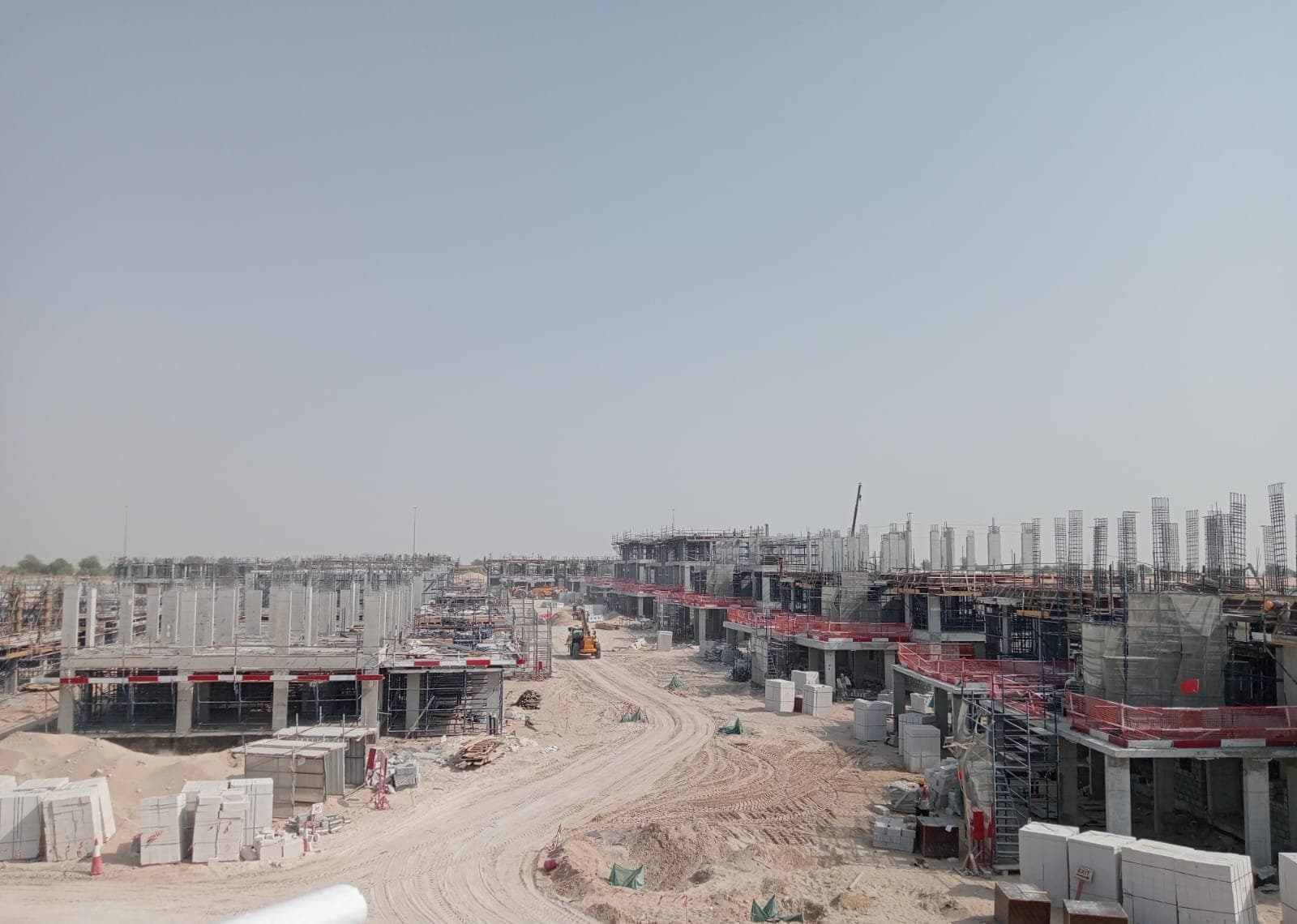

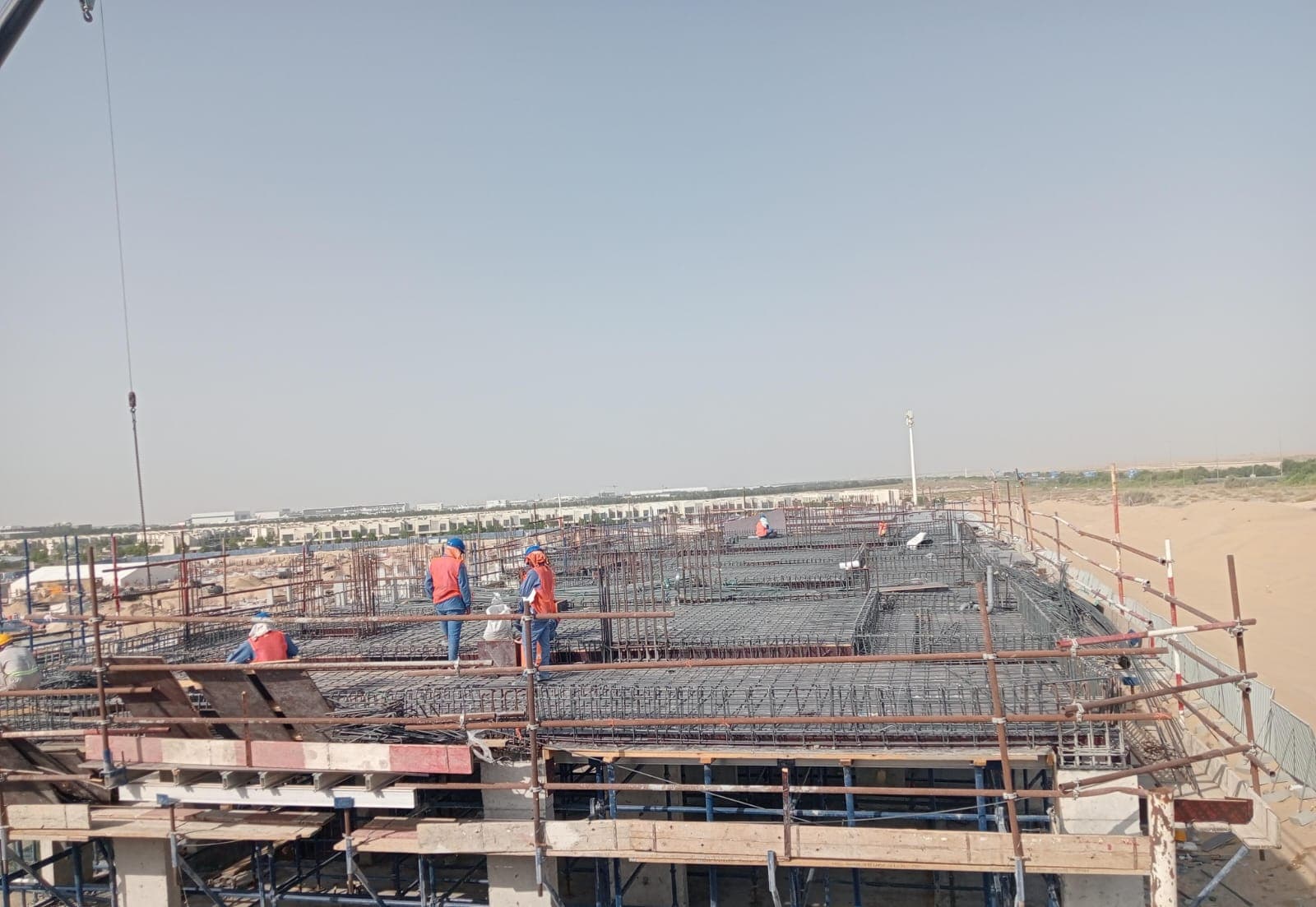

  • Greenway construction site, inspection photo 1, 19 September 2025
  • Greenway construction site, inspection photo 2, 19 September 2025
  • Greenway construction site, inspection photo 3, 19 September 2025
  • Greenway construction site, inspection photo 4, 19 September 2025

25 June 2025

7.0%+6.8 pts

  • Greenway construction site, inspection photo 1, 25 June 2025
  • Greenway construction site, inspection photo 2, 25 June 2025
  • Greenway construction site, inspection photo 3, 25 June 2025
  • Greenway construction site, inspection photo 4, 25 June 2025

7 March 2025

0.2%+0.2 pts

  • Greenway construction site, inspection photo 1, 7 March 2025
  • Greenway construction site, inspection photo 2, 7 March 2025
  • Greenway construction site, inspection photo 3, 7 March 2025
  • Greenway construction site, inspection photo 4, 7 March 2025

4 November 2024

0%+0.0 pts

  • Greenway construction site, inspection photo 1, 4 November 2024
  • Greenway construction site, inspection photo 2, 4 November 2024

1 April 2024

0%

  • Greenway construction site, inspection photo 1, 1 April 2024
  • Greenway construction site, inspection photo 2, 1 April 2024
  • Greenway construction site, inspection photo 3, 1 April 2024

All 41 site photos, by inspection date

Context

Dubai World Central has 53 projects under construction, 31% built on average.

Emaar Dubai South Dwc has 23 projects under construction in Dubai, none past their registered completion dates.

Own a unit in Greenway?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Greenway handover date?
No completion date is on record for Greenway yet. Handover follows completion, so there is no date to give.
What is the latest construction update on Greenway?
Greenway was 39% built at the site inspection on 20 July 2026. The site has been inspected 8 times since April 2024. The Land Department took 41 site photos at its inspections.
Who is building Greenway?
The registered developer is Emaar Dubai South Dwc. It has 22 other projects under construction in Dubai.
Which bank holds the escrow account for Greenway?
Dubai Islamic Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
