Expo City Valley construction progress

Expo City Valley in Dubai World Central is 66% built at the Land Department inspection of August 2026. Developer Expo City Valley Development Fzco. Completion registered for January 2026.

66%

Built, at the Land Department site inspection of 19 August 2026

8 months past its registered completion date

Completion date (Land Department)
January 2026
Finish at recent pace
June 2027
Construction started
May 2023
Registered with the Land Department
April 2023
Developer
Expo City Valley Development Fzco
Units
489
Escrow bank
Dubai Islamic Bank
Name in Arabic
إكسبو سيتي فالي
Land Department project number
2623
Land Department site inspections
7

Schedule

Expo City Valley was registered to complete in January 2026, 8 months ago, and is still under construction. Over the last year of inspections it has added about 3.6 points a month. Kept at that rate, the site would reach 100% around June 2027.

0%25%50%75%100%202420252026
Progress at each Land Department site inspectionStraight line from start to the Land Department completion date

Site inspections

19 August 2026

66%+14 pts

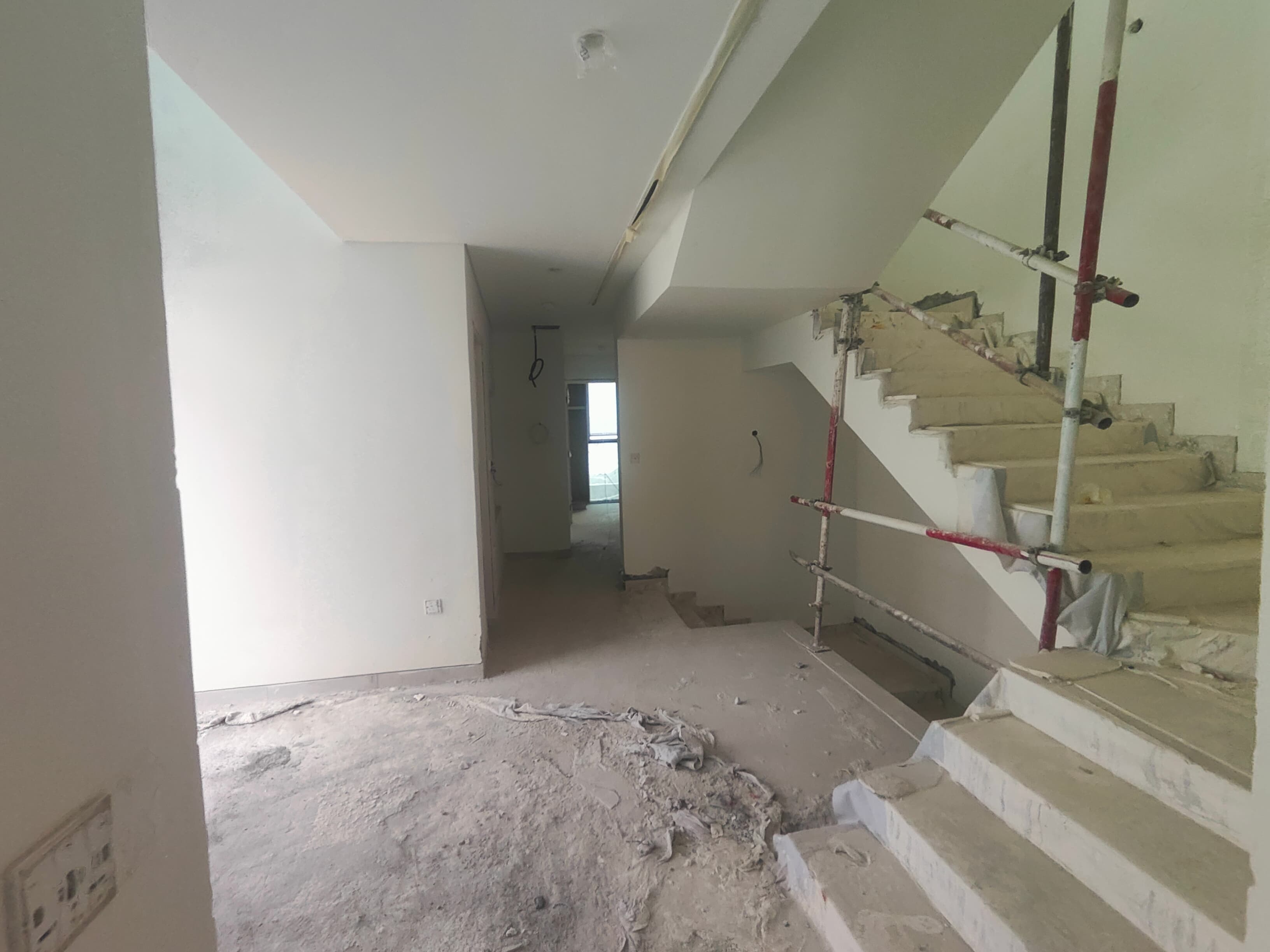

  • Expo City Valley construction site, Land Department inspection photo 1, 19 August 2026
  • Expo City Valley construction site, Land Department inspection photo 2, 19 August 2026
  • Expo City Valley construction site, Land Department inspection photo 3, 19 August 2026
  • Expo City Valley construction site, Land Department inspection photo 4, 19 August 2026

1 May 2026

52%+10 pts

  • Expo City Valley construction site, Land Department inspection photo 1, 1 May 2026
  • Expo City Valley construction site, Land Department inspection photo 2, 1 May 2026
  • Expo City Valley construction site, Land Department inspection photo 3, 1 May 2026
  • Expo City Valley construction site, Land Department inspection photo 4, 1 May 2026

24 December 2025

42%+18 pts

  • Expo City Valley construction site, Land Department inspection photo 1, 24 December 2025
  • Expo City Valley construction site, Land Department inspection photo 2, 24 December 2025
  • Expo City Valley construction site, Land Department inspection photo 3, 24 December 2025
  • Expo City Valley construction site, Land Department inspection photo 4, 24 December 2025

22 August 2025

24%+15 pts

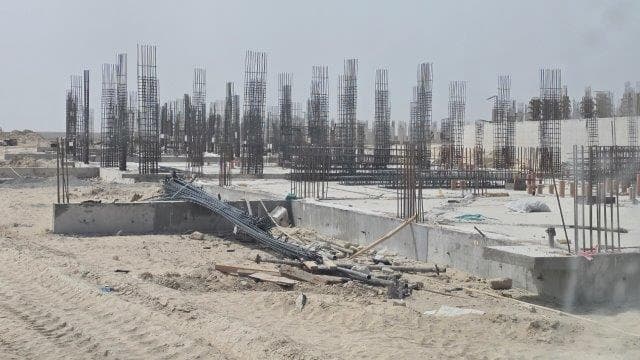

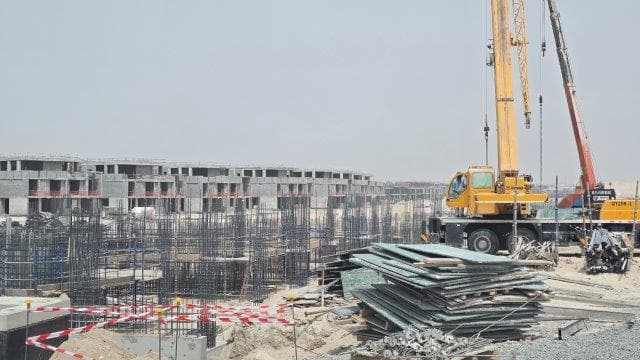

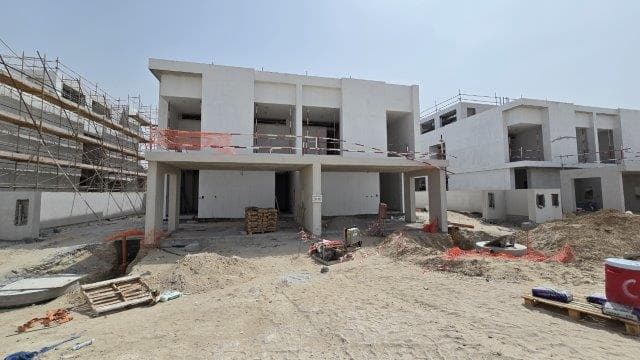

  • Expo City Valley construction site, Land Department inspection photo 1, 22 August 2025
  • Expo City Valley construction site, Land Department inspection photo 2, 22 August 2025
  • Expo City Valley construction site, Land Department inspection photo 3, 22 August 2025
  • Expo City Valley construction site, Land Department inspection photo 4, 22 August 2025

12 March 2025

8.3%+7.9 pts

  • Expo City Valley construction site, Land Department inspection photo 1, 12 March 2025
  • Expo City Valley construction site, Land Department inspection photo 2, 12 March 2025
  • Expo City Valley construction site, Land Department inspection photo 3, 12 March 2025
  • Expo City Valley construction site, Land Department inspection photo 4, 12 March 2025

11 December 2023

0.4%+0.4 pts

  • Expo City Valley construction site, Land Department inspection photo 1, 11 December 2023
  • Expo City Valley construction site, Land Department inspection photo 2, 11 December 2023
  • Expo City Valley construction site, Land Department inspection photo 3, 11 December 2023
  • Expo City Valley construction site, Land Department inspection photo 4, 11 December 2023

27 April 2023

0%

  • Expo City Valley construction site, Land Department inspection photo 1, 27 April 2023

All 76 site photos, by inspection date

Context

Dubai World Central has 51 projects under construction, 29% built on average.

Own a unit in Expo City Valley?

Mulki follows this project for you: each new Land Department inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When will Expo City Valley be completed?
The completion date registered with the Dubai Land Department is January 2026. At the pace of its recent inspections the site would reach 100% around June 2027. Developers can apply to the Land Department to extend the date, so check the register before relying on it.
How much of Expo City Valley is built?
66%, measured at the Land Department site inspection on 19 August 2026. The Land Department engineers have inspected the site 7 times since April 2023.
Is Expo City Valley delayed?
Yes. Its registered completion date of January 2026 has passed and the Land Department still lists it as under construction.
Who is building Expo City Valley?
The registered developer is Expo City Valley Development Fzco.
Which bank holds the escrow account for Expo City Valley?
Dubai Islamic Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of Land Department inspections, not a forecast from the developer. Site photos belong to the Dubai Land Department. See how Mulki works with Land Department data.
