Fairway Villas 3 construction progress

No completion date is registered for Fairway Villas 3 in Dubai World Central yet. At the last site inspection, in July 2026, it was 49% built. The developer is Emaar Dubai South Dwc.

49%

Built, at the site inspection of 7 July 2026

Finish at recent pace
January 2028
Construction started
July 2024
First registered
February 2024
Units
72
Escrow bank
Mashreq Bank
Name in Arabic
فيرواي فيلاز 3
Project number
2963
Site inspections
8

Schedule

Since September 2025 Fairway Villas 3 has added about 2.7 points a month. At that rate the site reaches 100% around January 2028. No completion date is on record to compare it with.

0%25%50%75%100%20252026
Progress at each site inspection

Site inspections

7 July 2026

49%+11 pts

  • Fairway Villas 3 construction site, inspection photo 1, 7 July 2026
  • Fairway Villas 3 construction site, inspection photo 2, 7 July 2026
  • Fairway Villas 3 construction site, inspection photo 3, 7 July 2026
  • Fairway Villas 3 construction site, inspection photo 4, 7 July 2026

17 March 2026

38%+11 pts

  • Fairway Villas 3 construction site, inspection photo 1, 17 March 2026
  • Fairway Villas 3 construction site, inspection photo 2, 17 March 2026
  • Fairway Villas 3 construction site, inspection photo 3, 17 March 2026
  • Fairway Villas 3 construction site, inspection photo 4, 17 March 2026

25 December 2025

27%+5.5 pts

  • Fairway Villas 3 construction site, inspection photo 1, 25 December 2025
  • Fairway Villas 3 construction site, inspection photo 2, 25 December 2025
  • Fairway Villas 3 construction site, inspection photo 3, 25 December 2025
  • Fairway Villas 3 construction site, inspection photo 4, 25 December 2025

9 September 2025

22%+11 pts

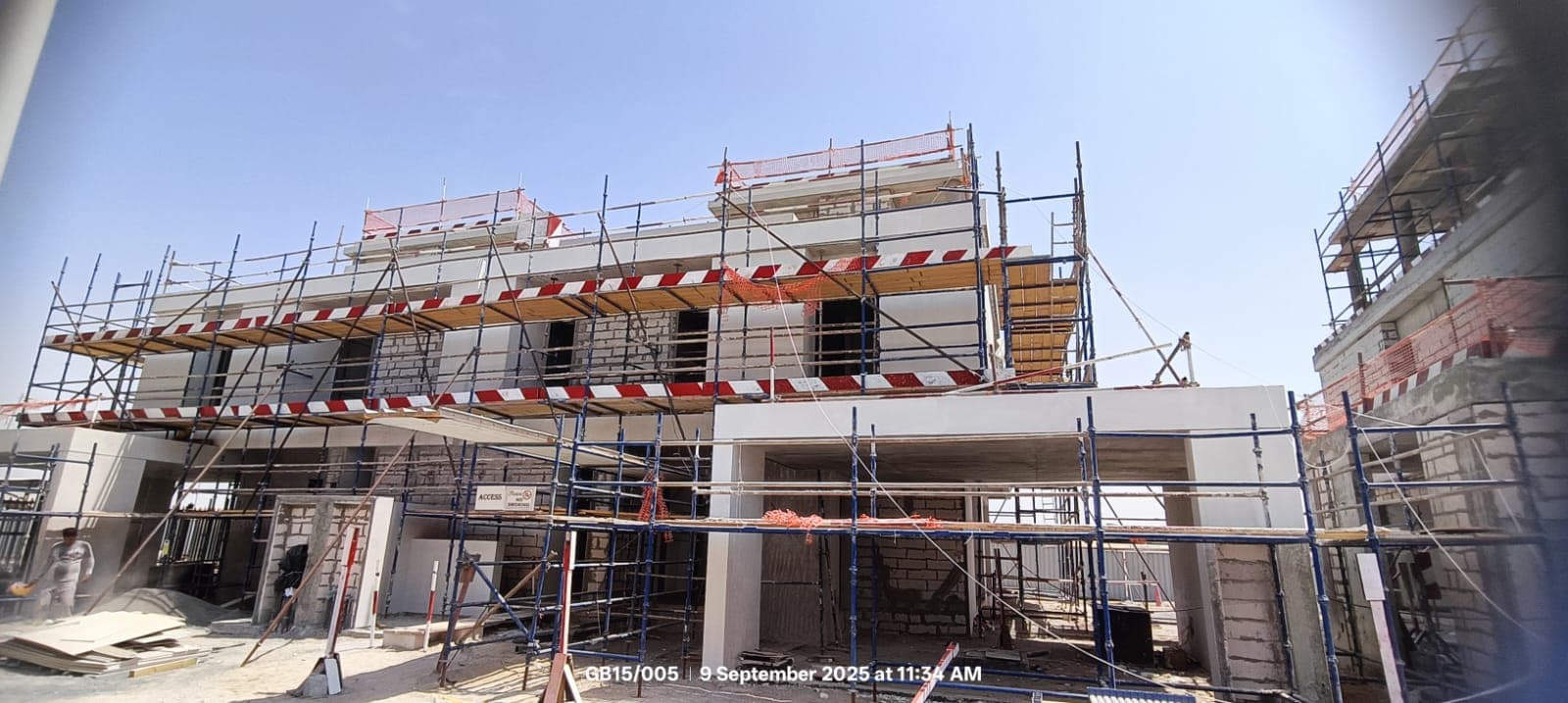

  • Fairway Villas 3 construction site, inspection photo 1, 9 September 2025
  • Fairway Villas 3 construction site, inspection photo 2, 9 September 2025
  • Fairway Villas 3 construction site, inspection photo 3, 9 September 2025
  • Fairway Villas 3 construction site, inspection photo 4, 9 September 2025

16 May 2025

11%+8.3 pts

  • Fairway Villas 3 construction site, inspection photo 1, 16 May 2025
  • Fairway Villas 3 construction site, inspection photo 2, 16 May 2025
  • Fairway Villas 3 construction site, inspection photo 3, 16 May 2025
  • Fairway Villas 3 construction site, inspection photo 4, 16 May 2025

28 January 2025

2.6%+2.3 pts

  • Fairway Villas 3 construction site, inspection photo 1, 28 January 2025
  • Fairway Villas 3 construction site, inspection photo 2, 28 January 2025
  • Fairway Villas 3 construction site, inspection photo 3, 28 January 2025
  • Fairway Villas 3 construction site, inspection photo 4, 28 January 2025

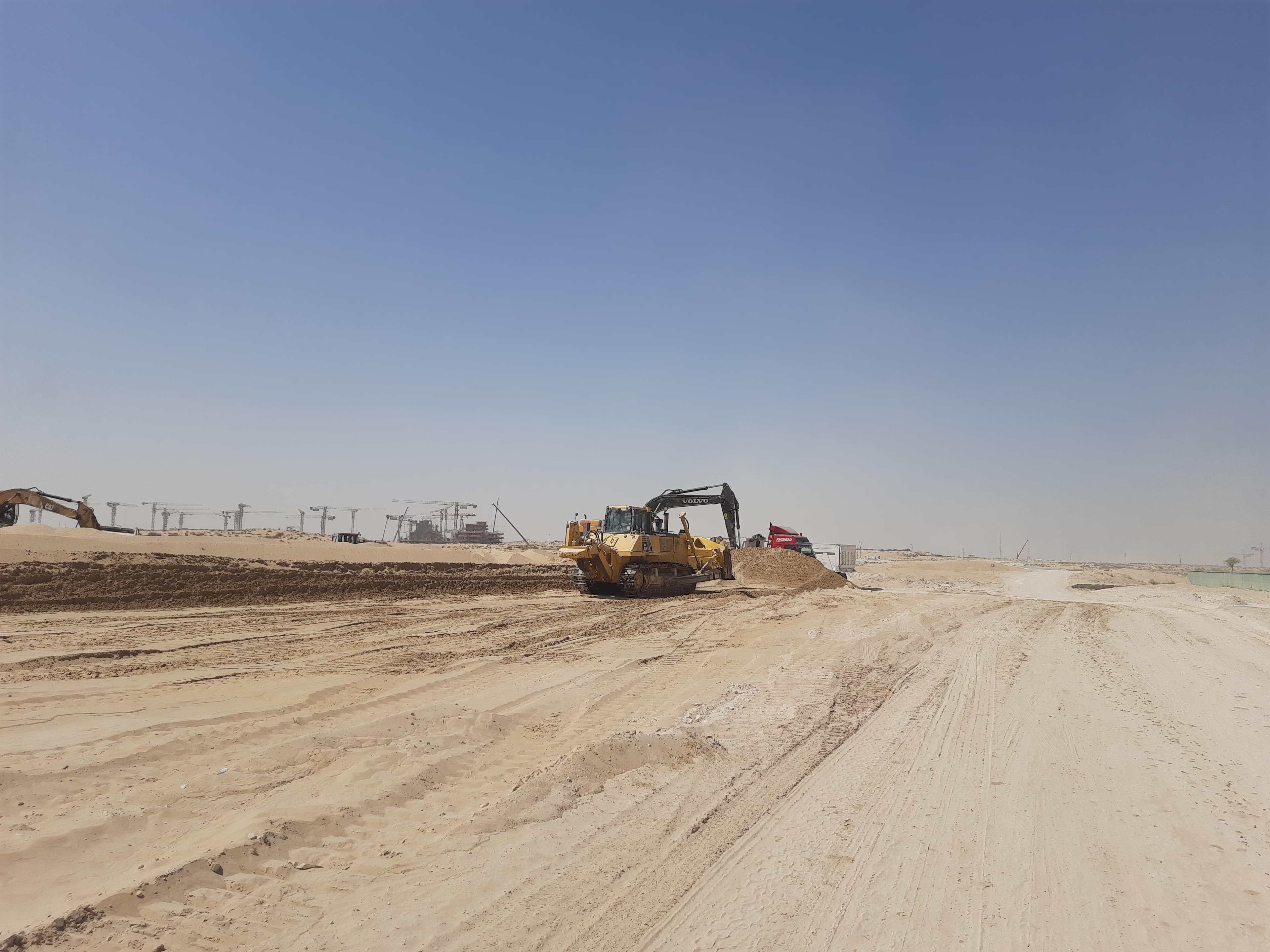

16 September 2024

0.3%+0.3 pts

  • Fairway Villas 3 construction site, inspection photo 1, 16 September 2024
  • Fairway Villas 3 construction site, inspection photo 2, 16 September 2024
  • Fairway Villas 3 construction site, inspection photo 3, 16 September 2024

12 February 2024

0%

  • Fairway Villas 3 construction site, inspection photo 1, 12 February 2024
  • Fairway Villas 3 construction site, inspection photo 2, 12 February 2024
  • Fairway Villas 3 construction site, inspection photo 3, 12 February 2024

All 52 site photos, by inspection date

Context

Dubai World Central has 53 projects under construction, 31% built on average.

Emaar Dubai South Dwc has 23 projects under construction in Dubai, none past their registered completion dates.

Own a unit in Fairway Villas 3?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Fairway Villas 3 handover date?
No completion date is on record for Fairway Villas 3 yet. Handover follows completion, so there is no date to give.
What is the latest construction update on Fairway Villas 3?
Fairway Villas 3 was 49% built at the site inspection on 7 July 2026. The site has been inspected 8 times since February 2024. The Land Department took 52 site photos at its inspections.
Who is building Fairway Villas 3?
The registered developer is Emaar Dubai South Dwc. It has 22 other projects under construction in Dubai.
Which bank holds the escrow account for Fairway Villas 3?
Mashreq Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
