Fairway Villas 3 construction photos

52 photos taken by Dubai Land Department engineers at 8 site inspections, newest first. The percentage is how much of Fairway Villas 3 was built on the day of each visit.

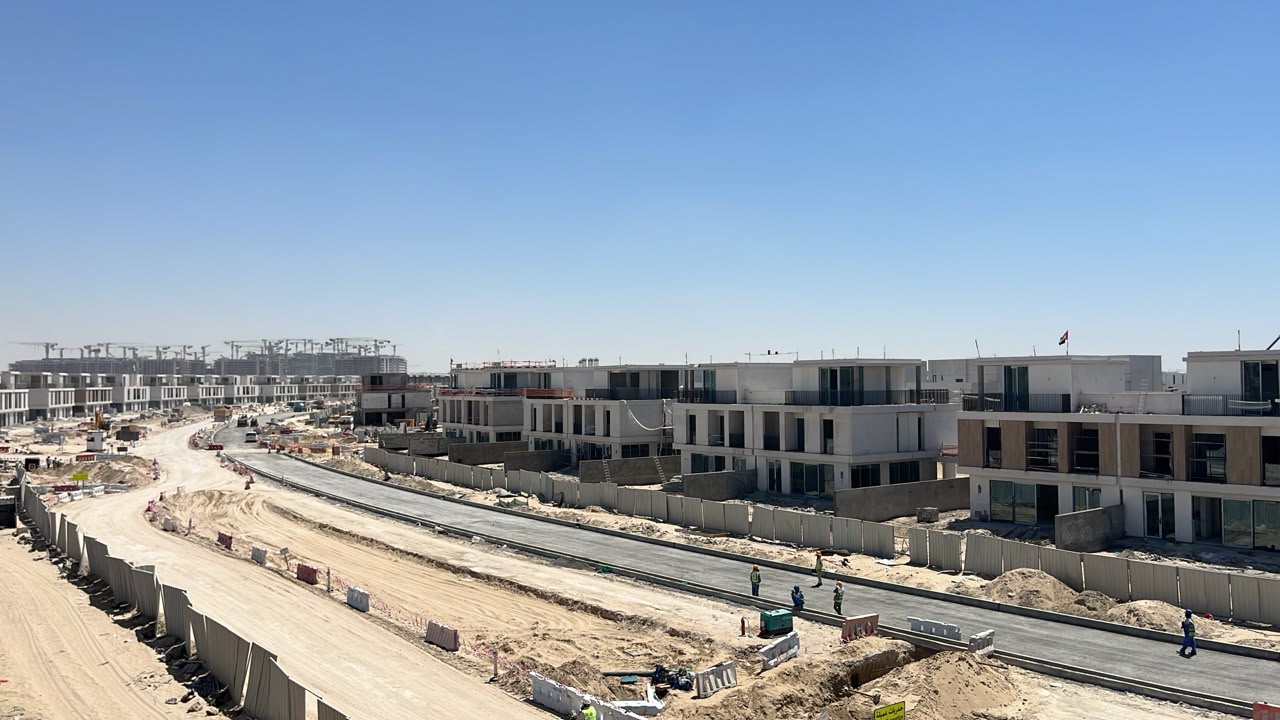

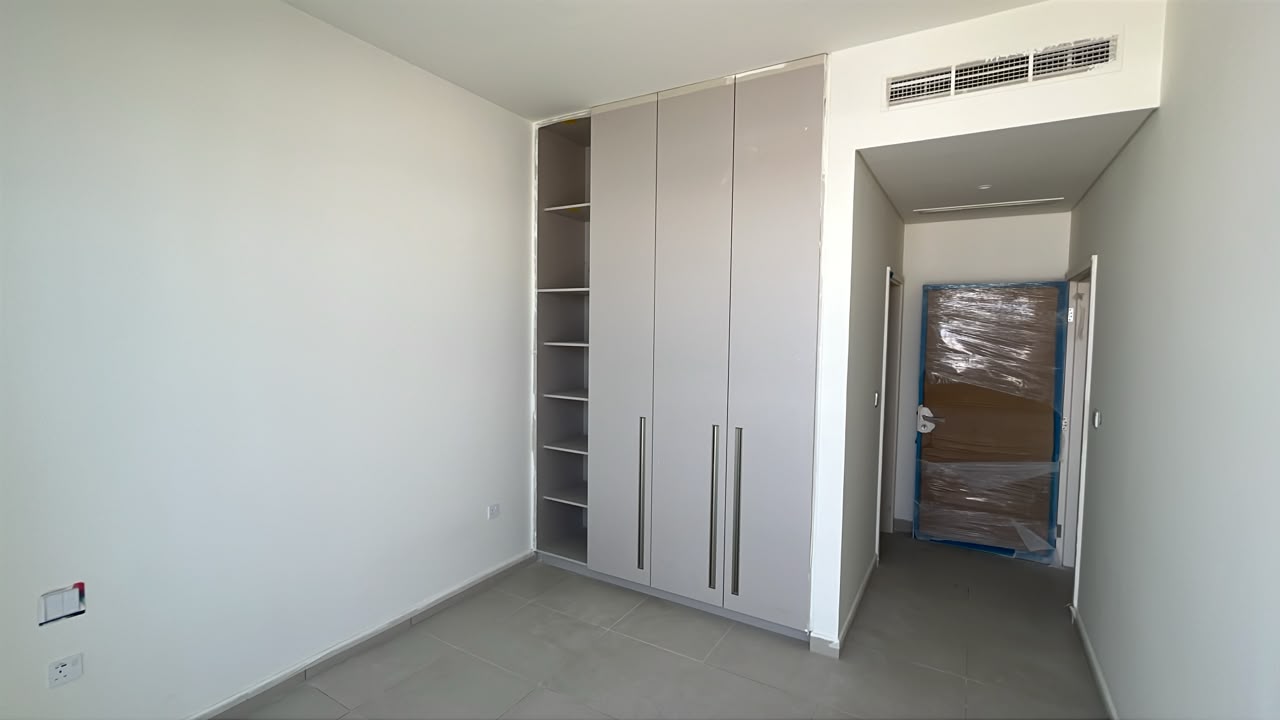

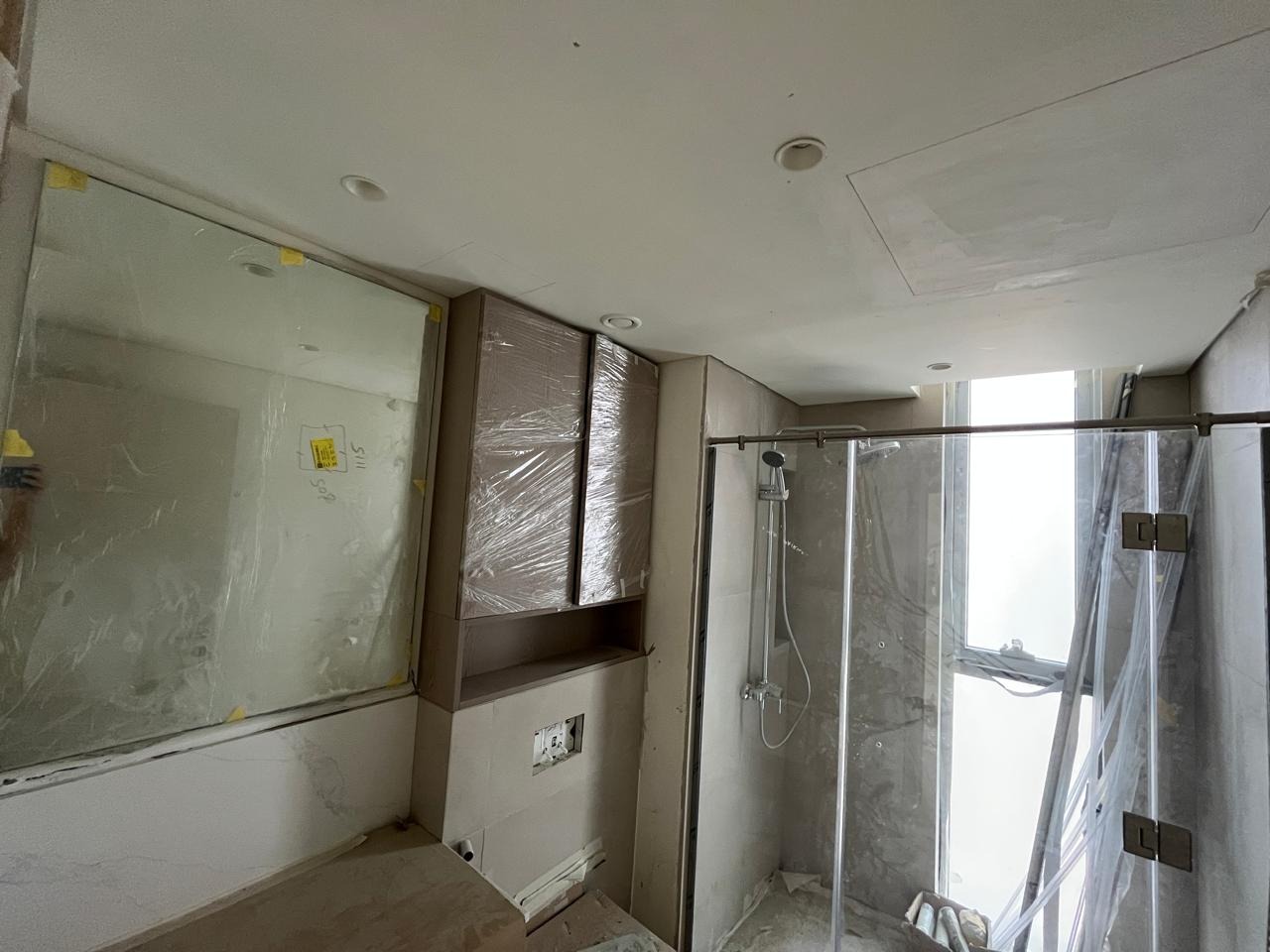

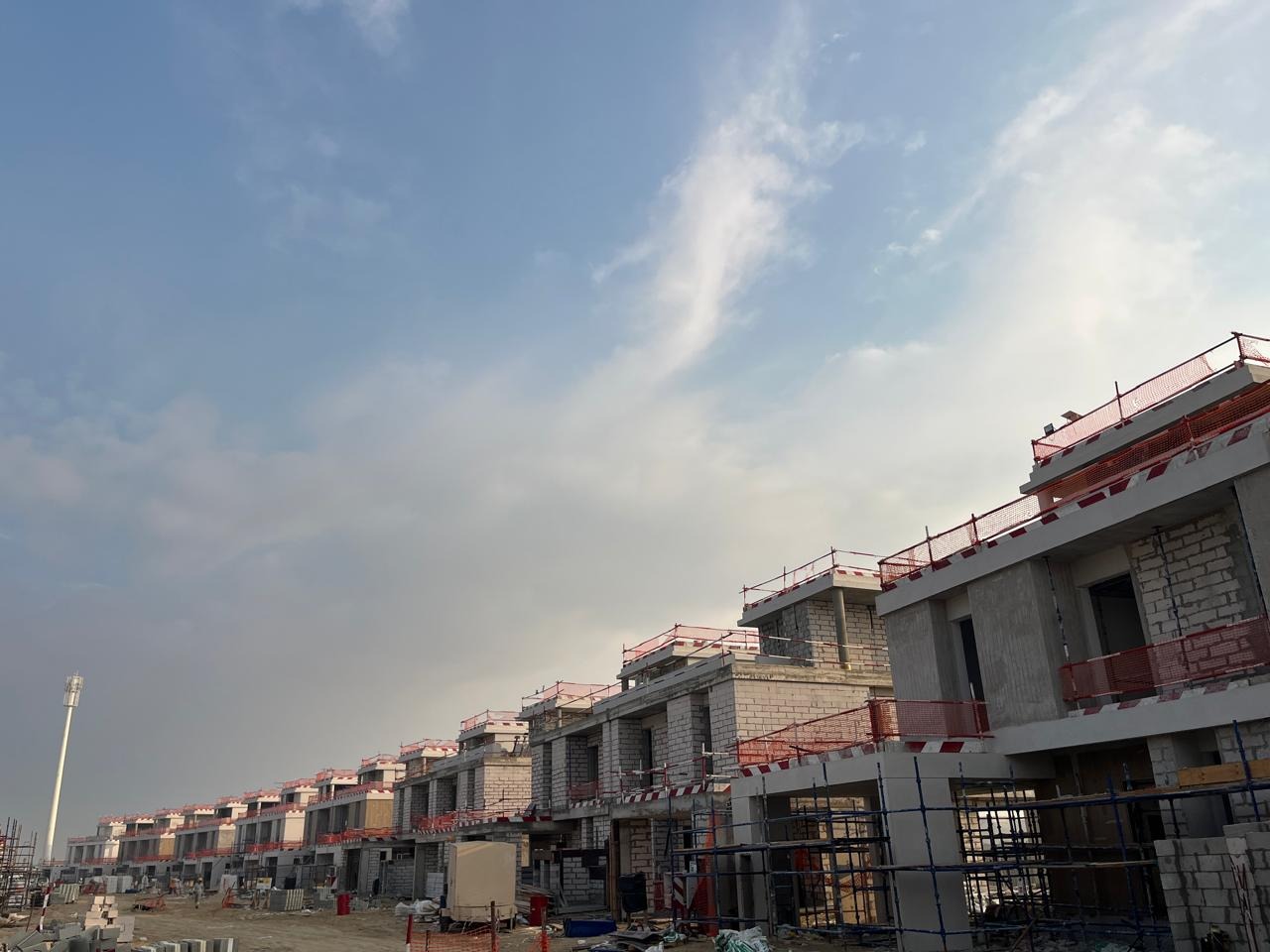

7 July 202649% built

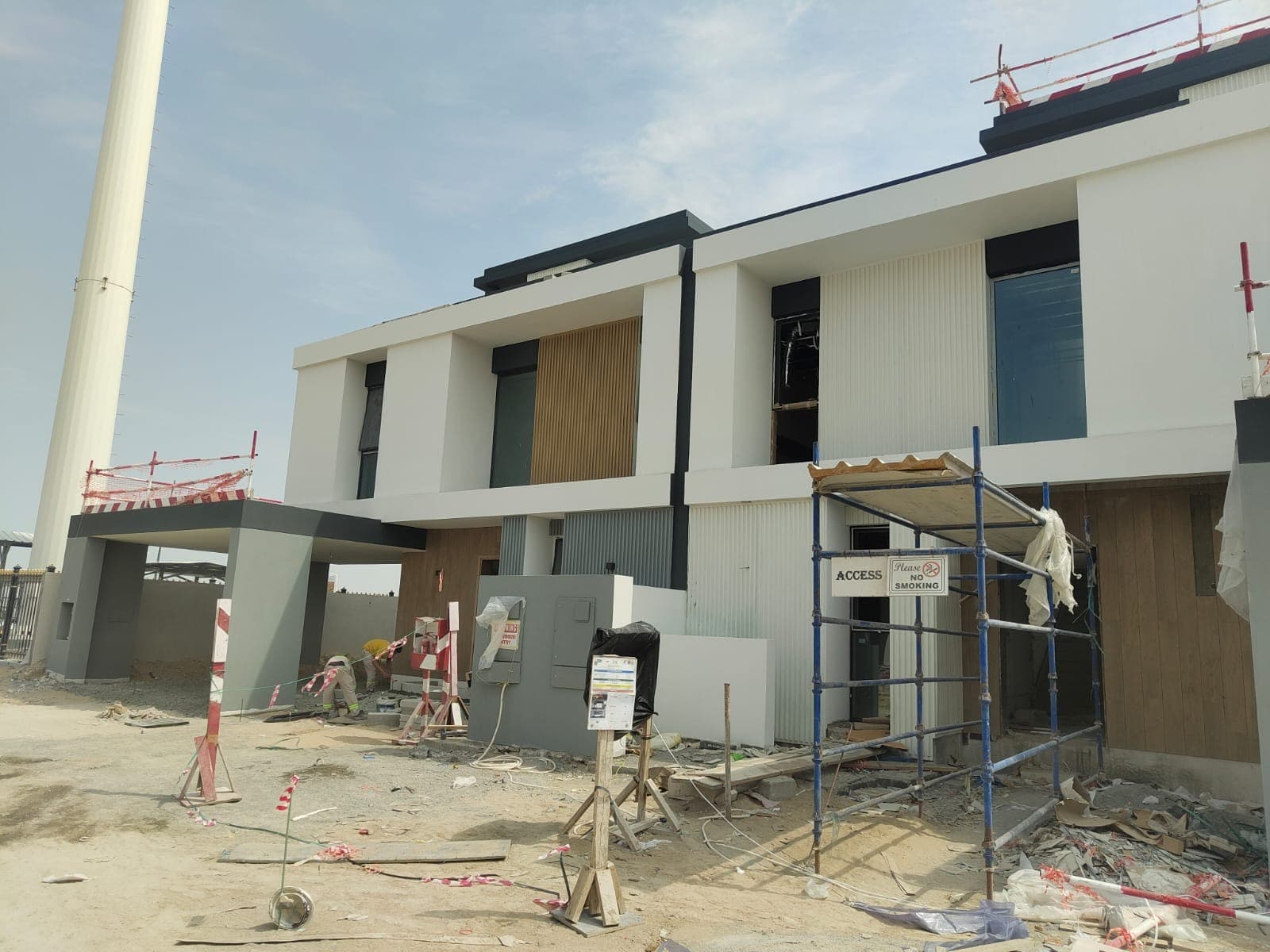

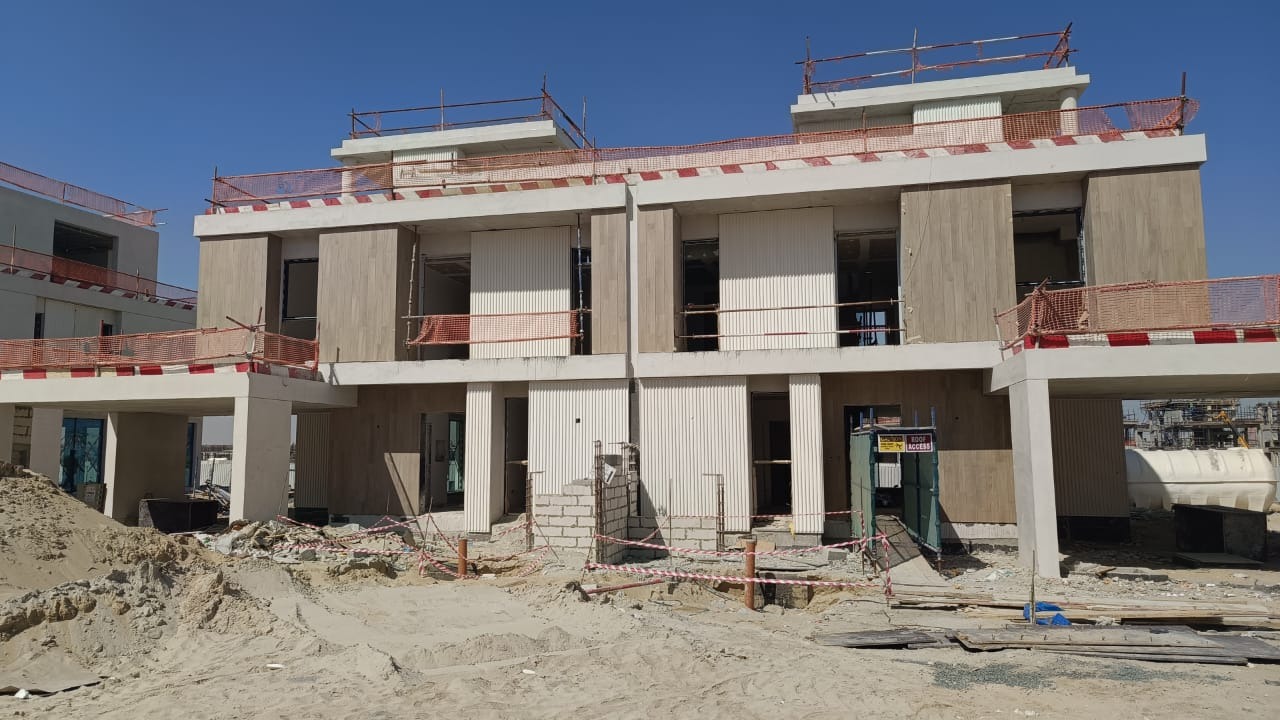

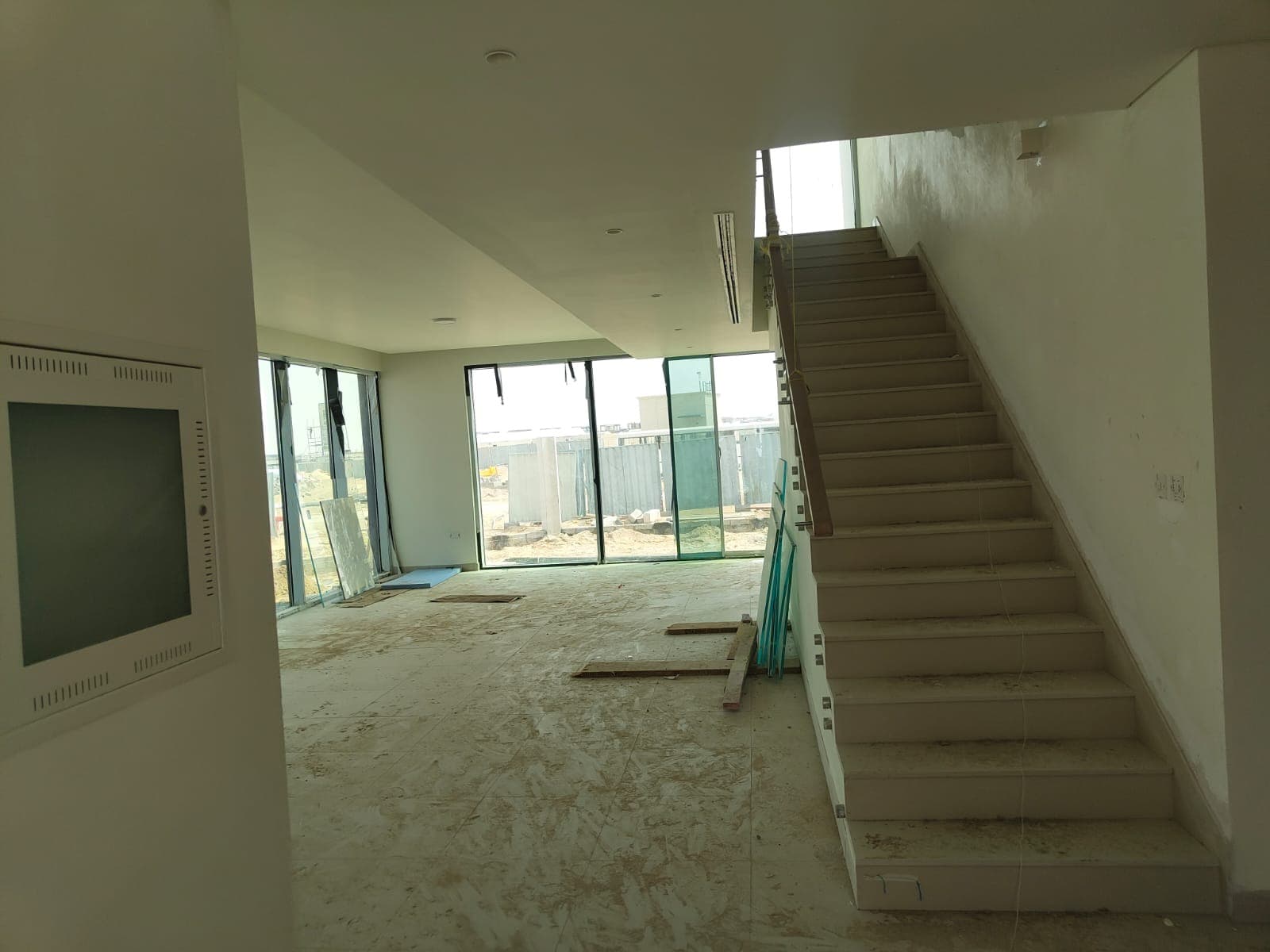

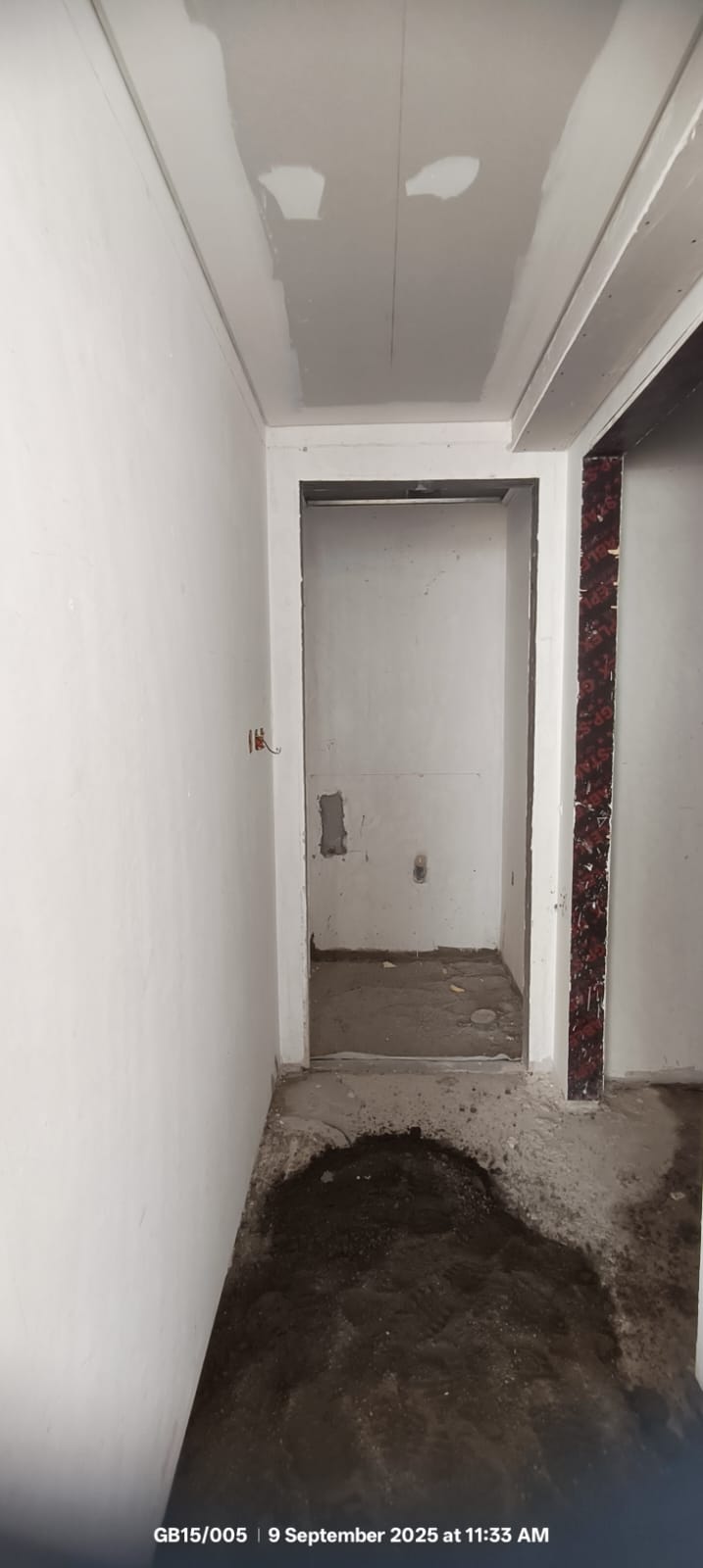

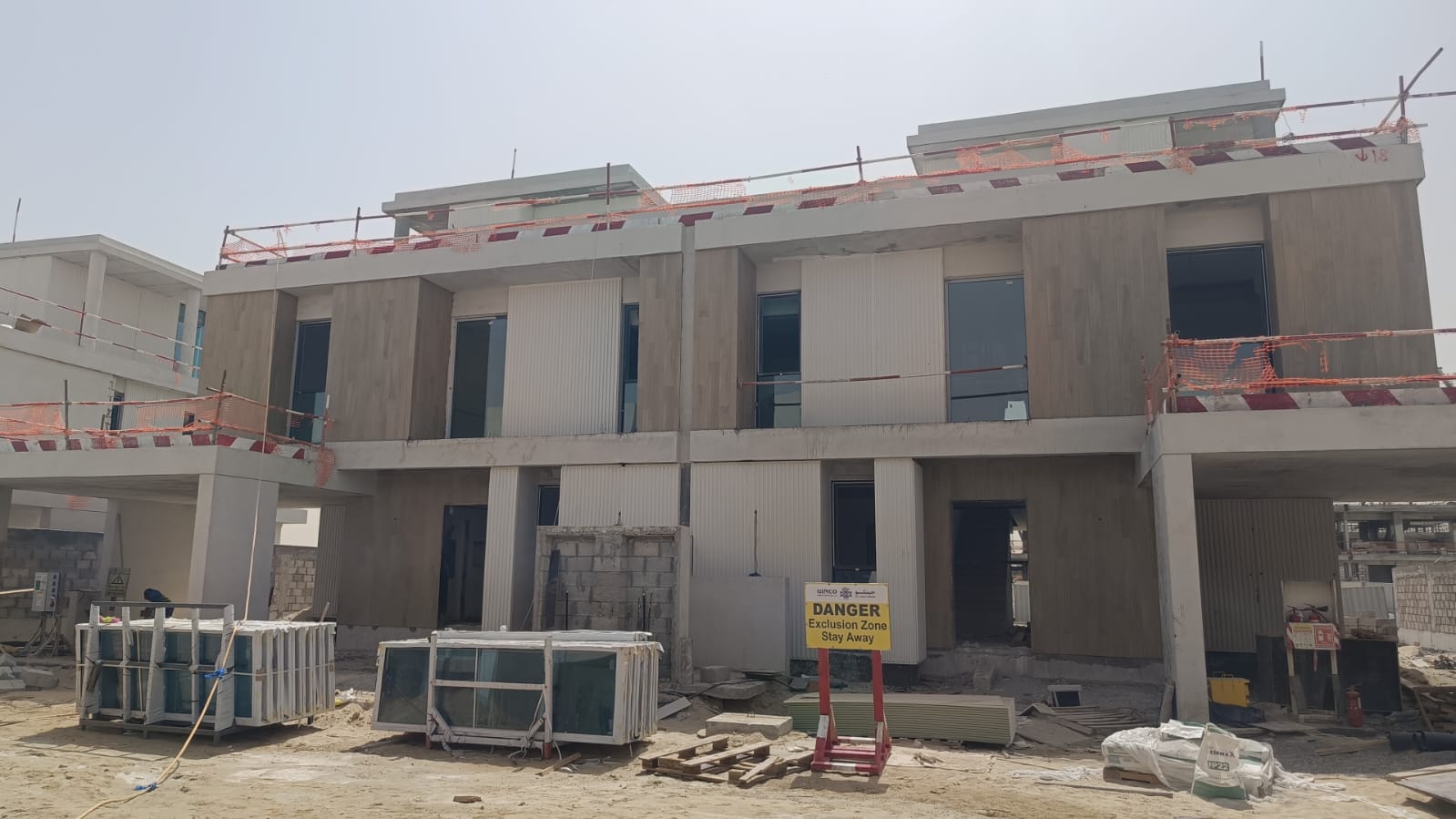

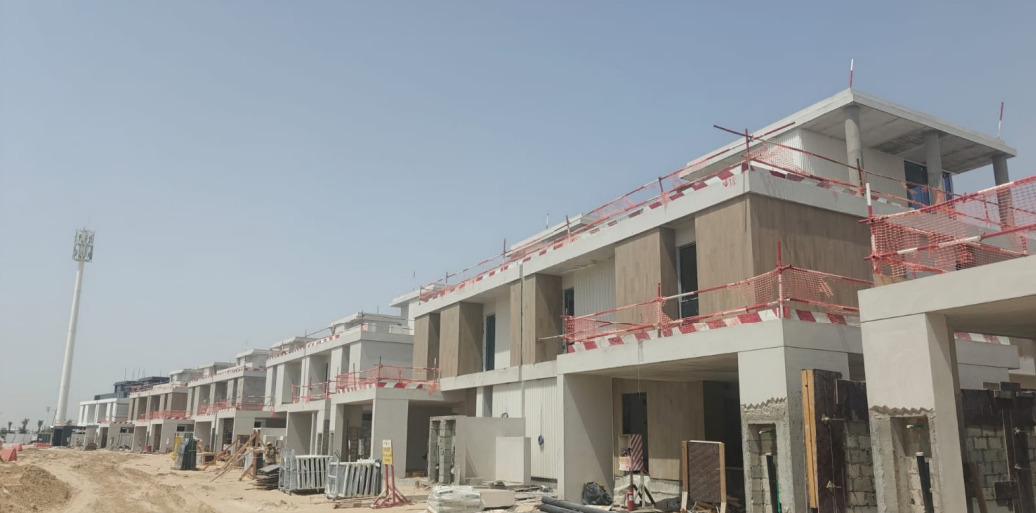

17 March 202638% built

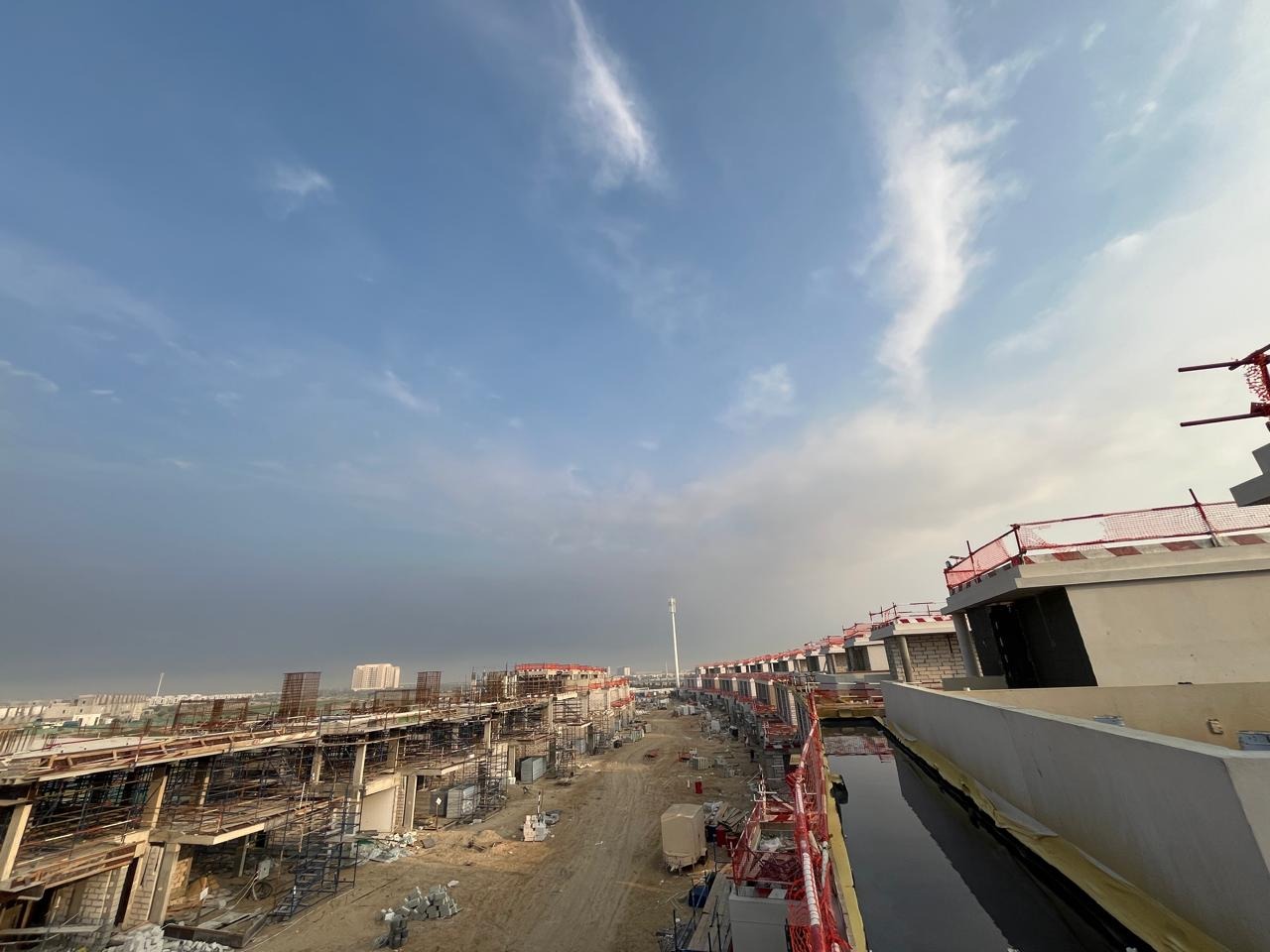

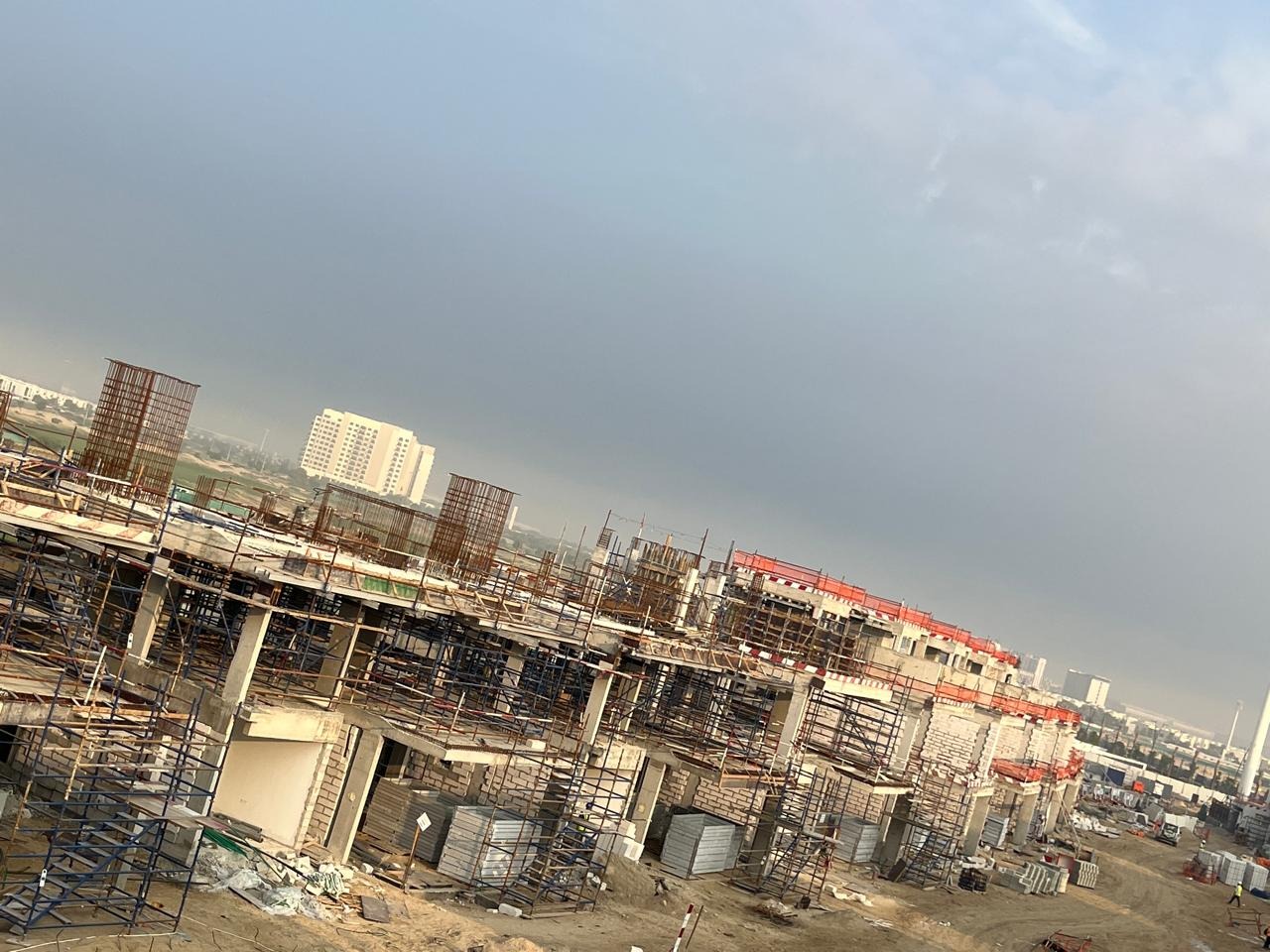

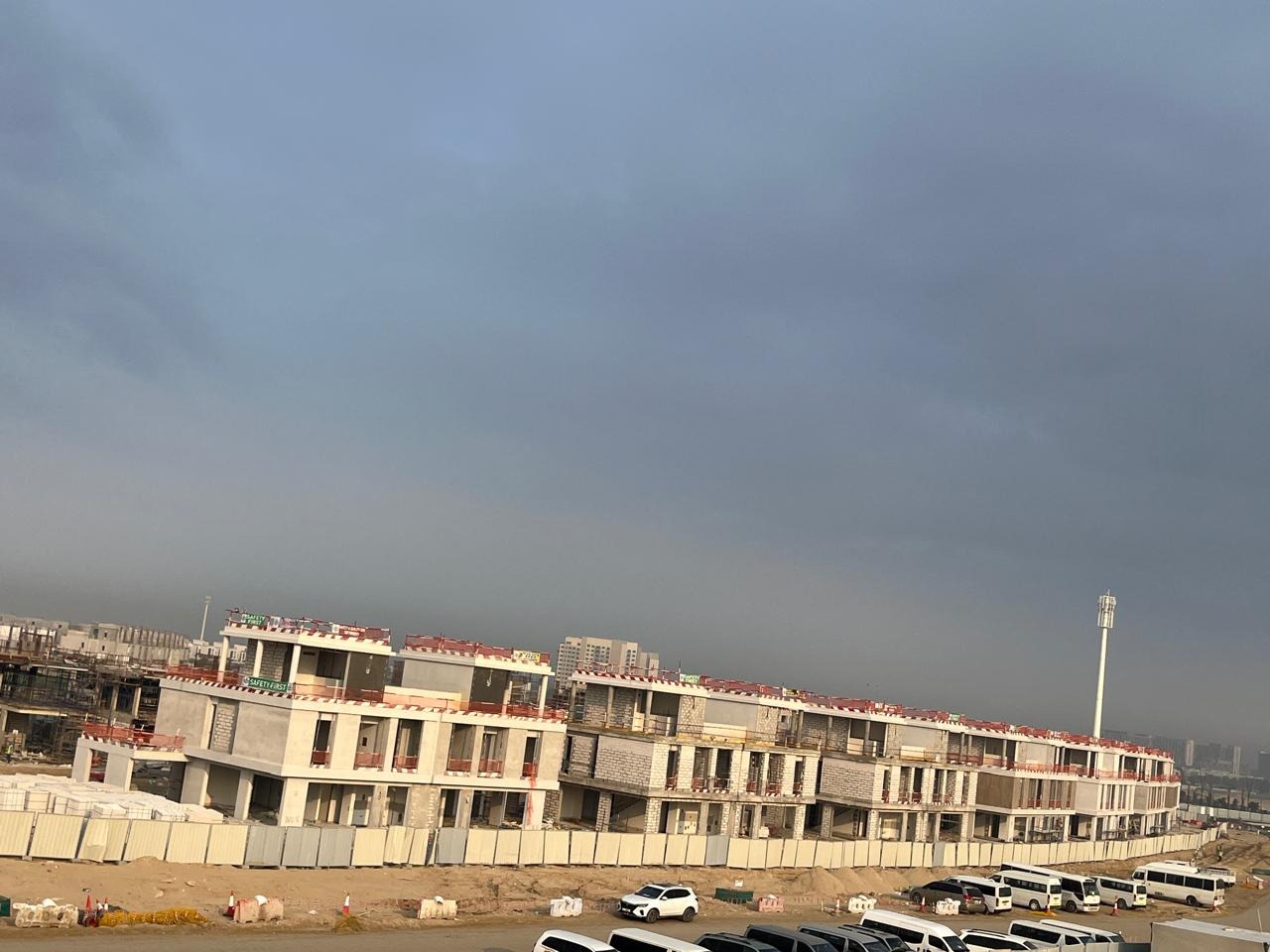

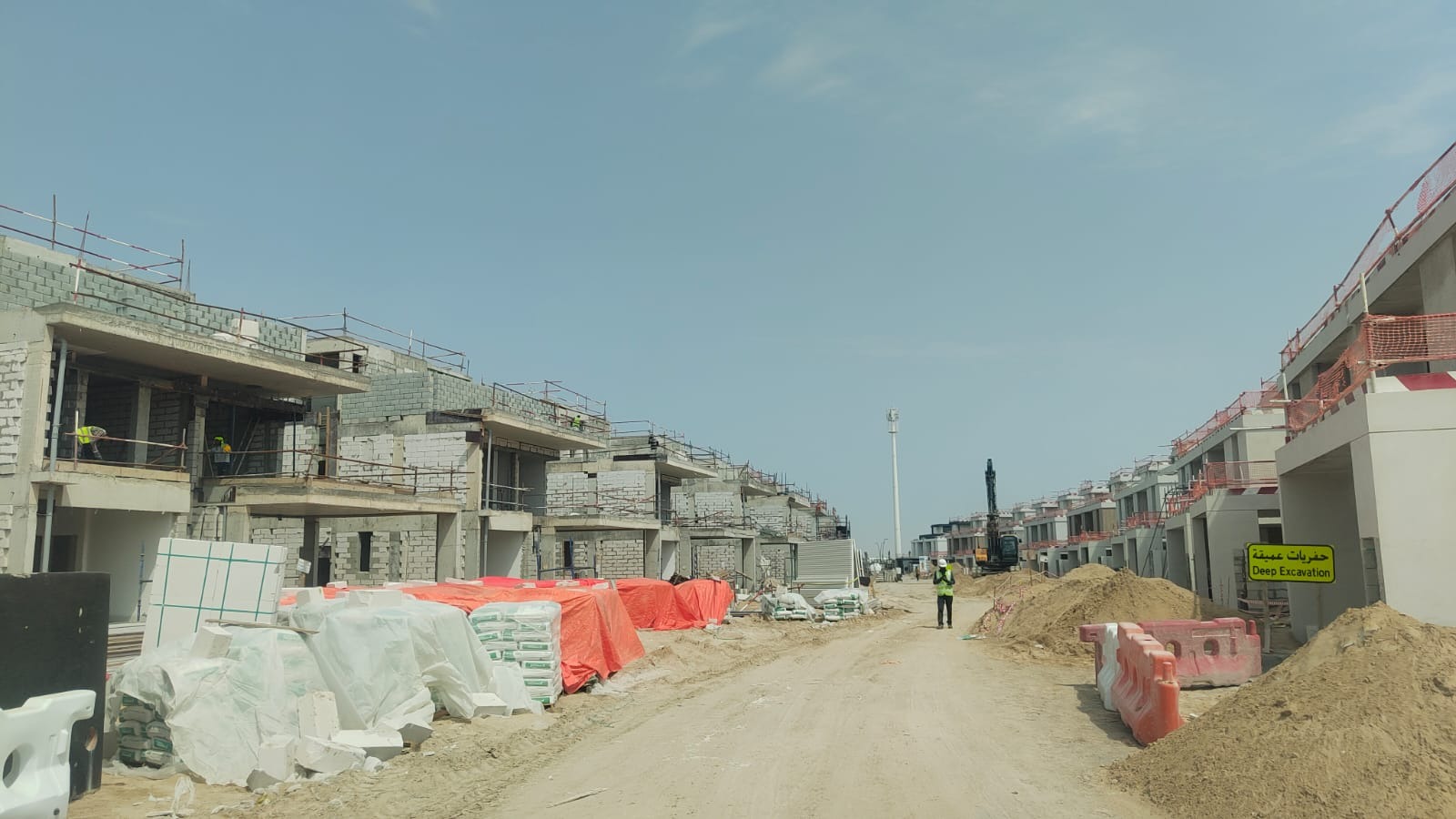

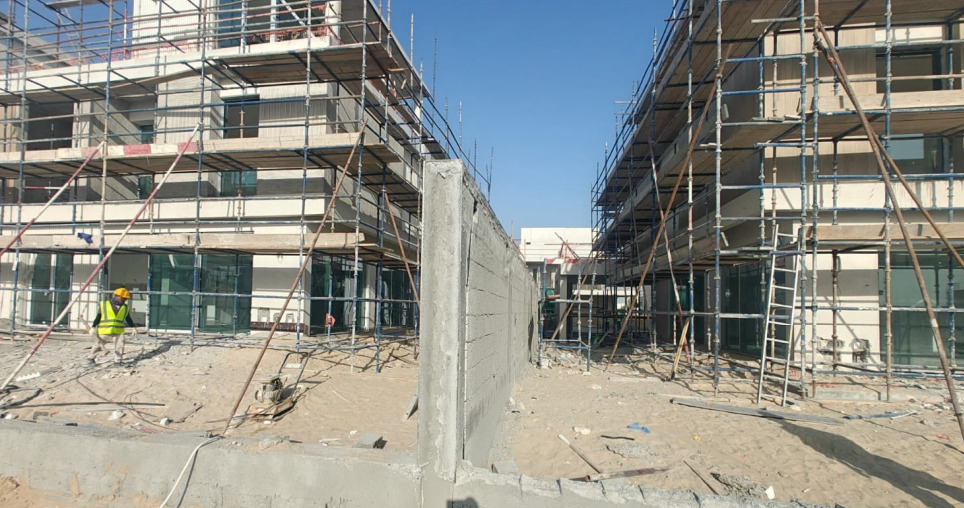

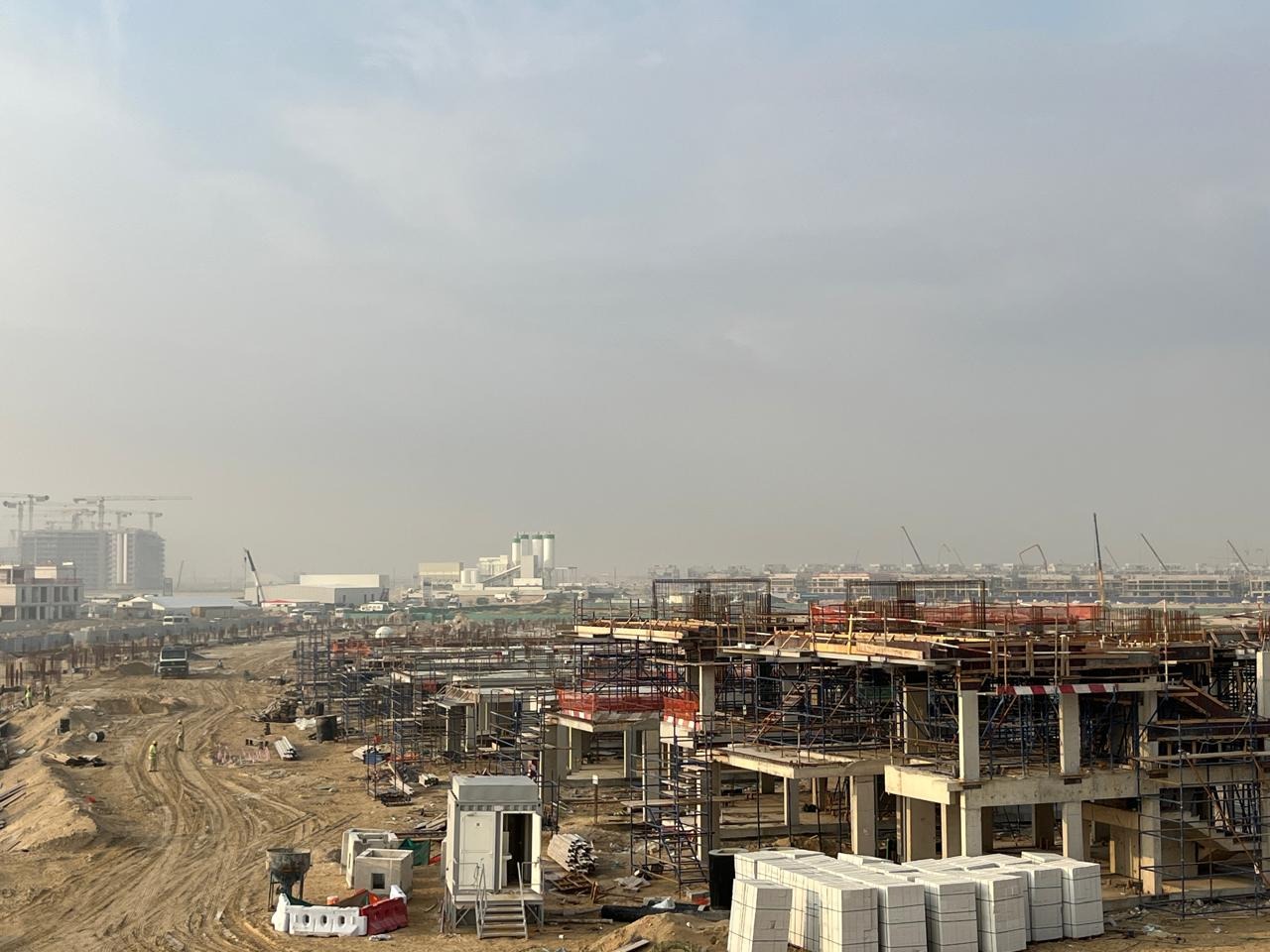

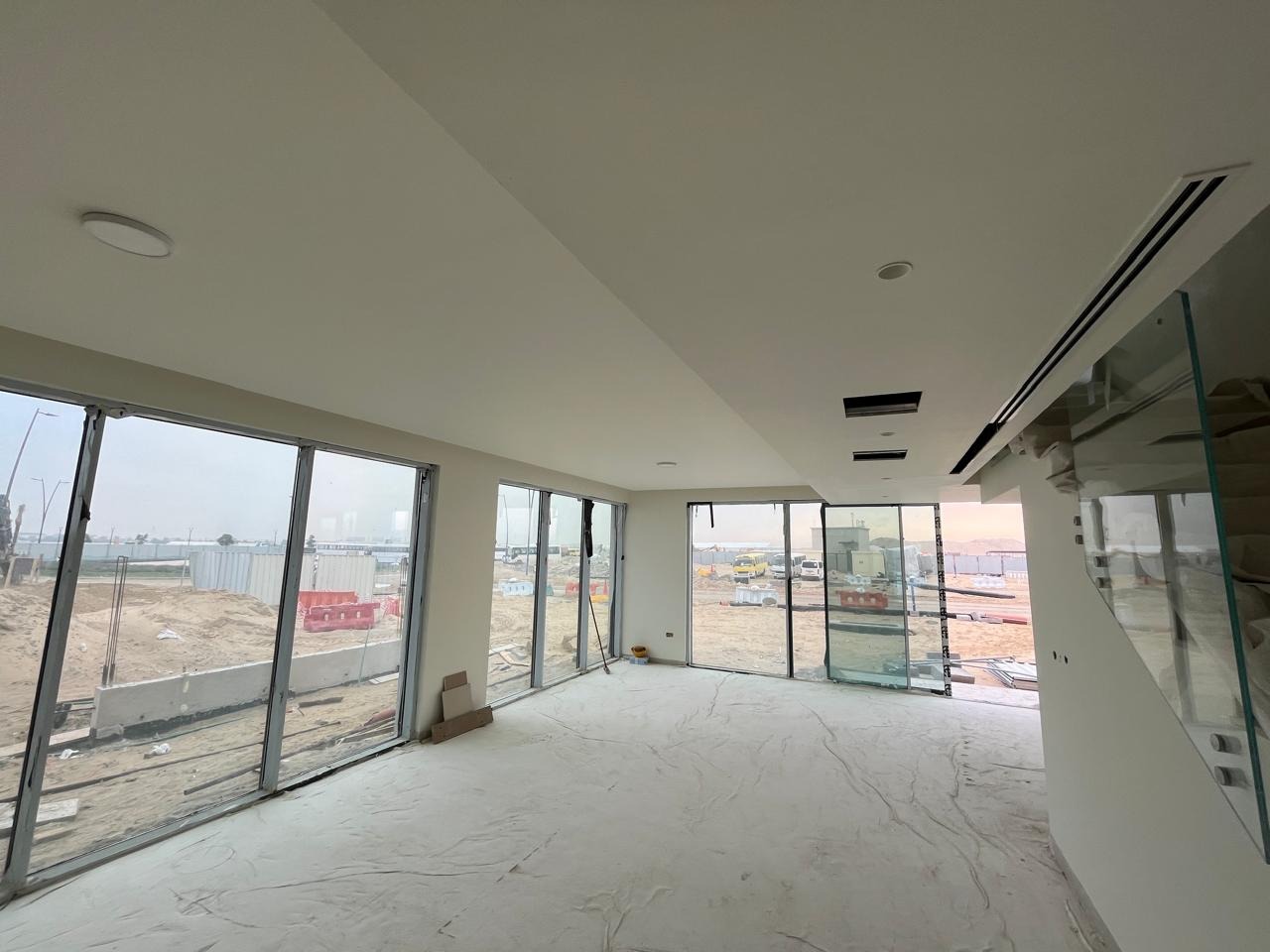

25 December 202527% built

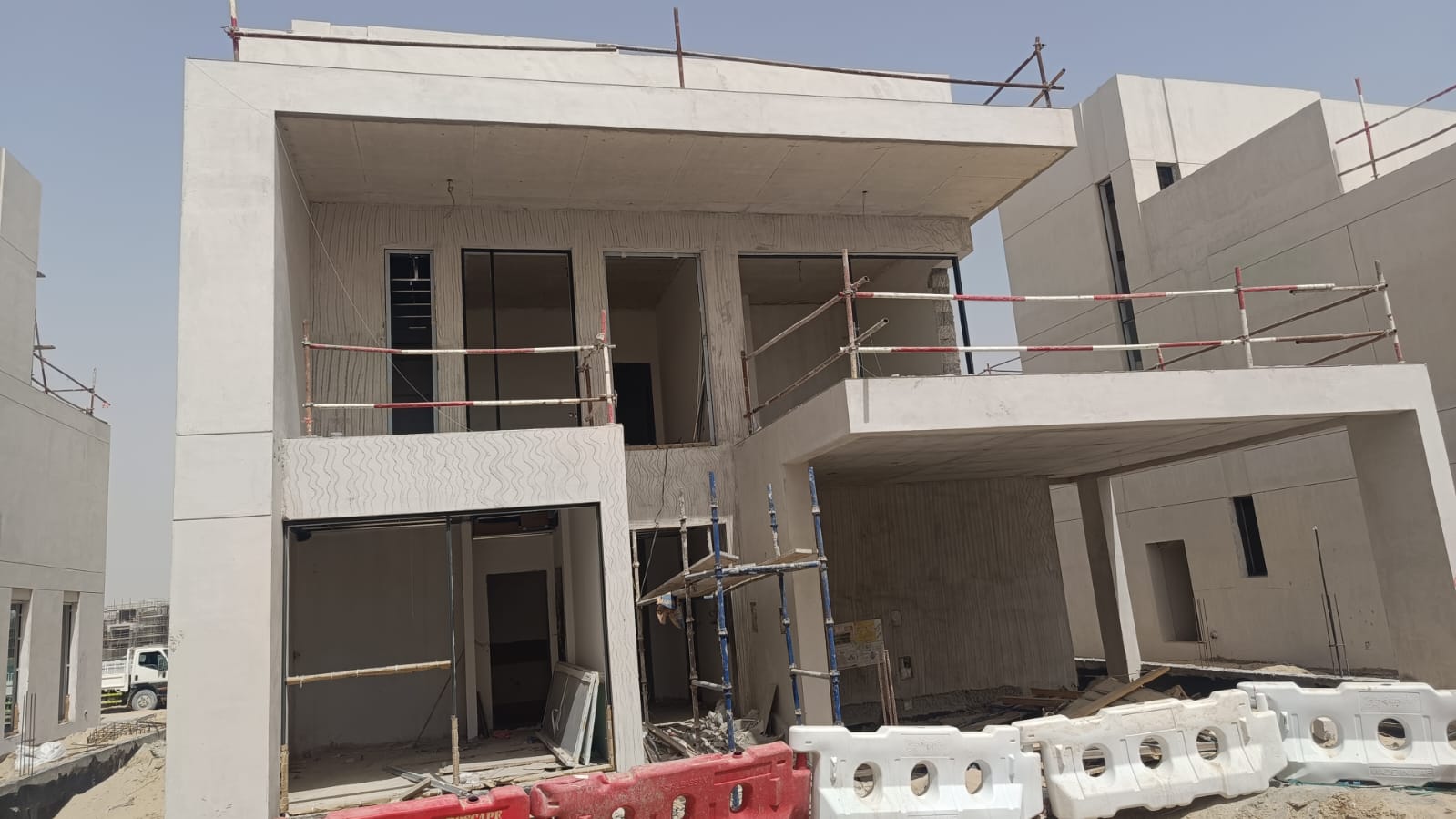

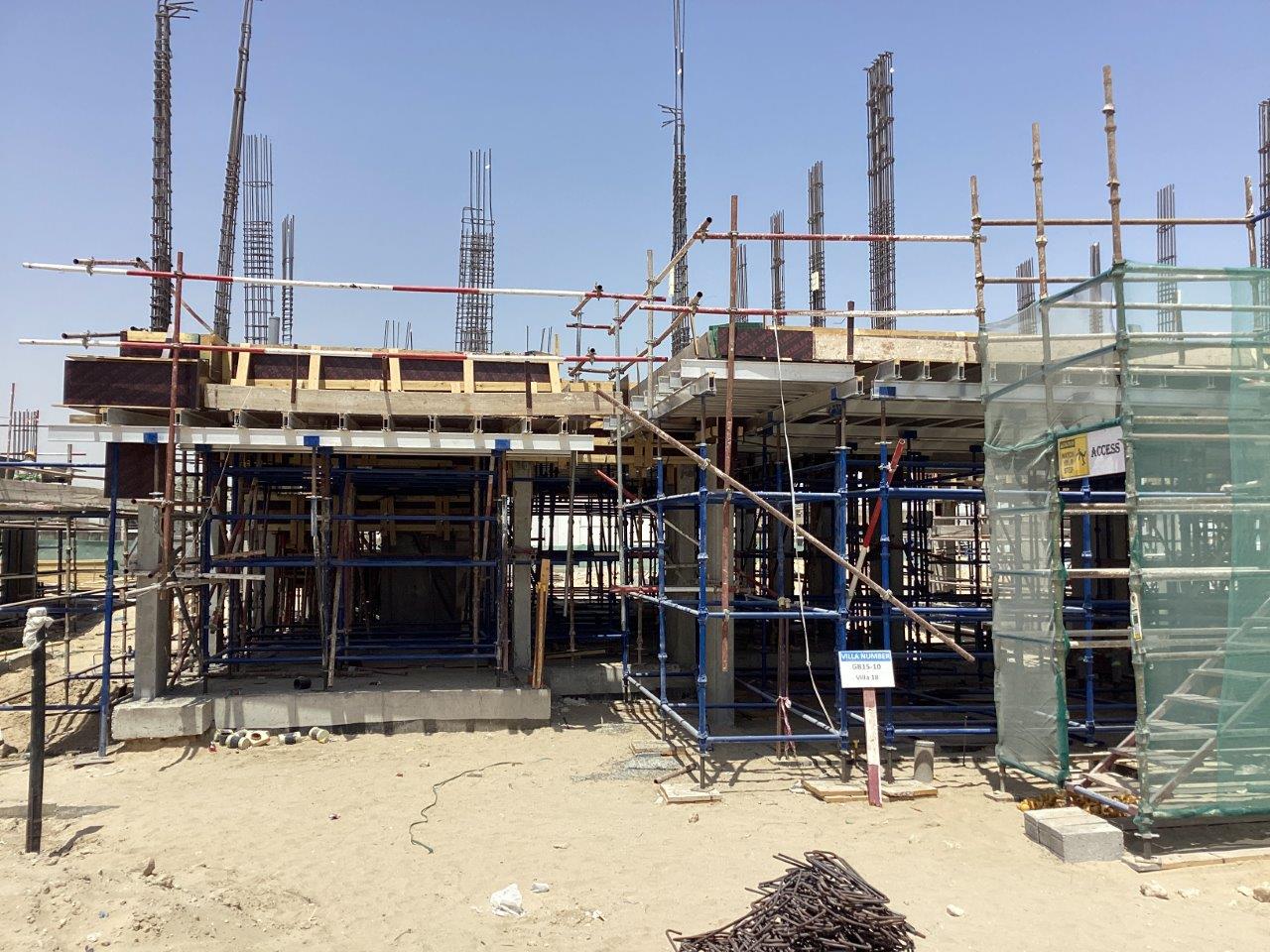

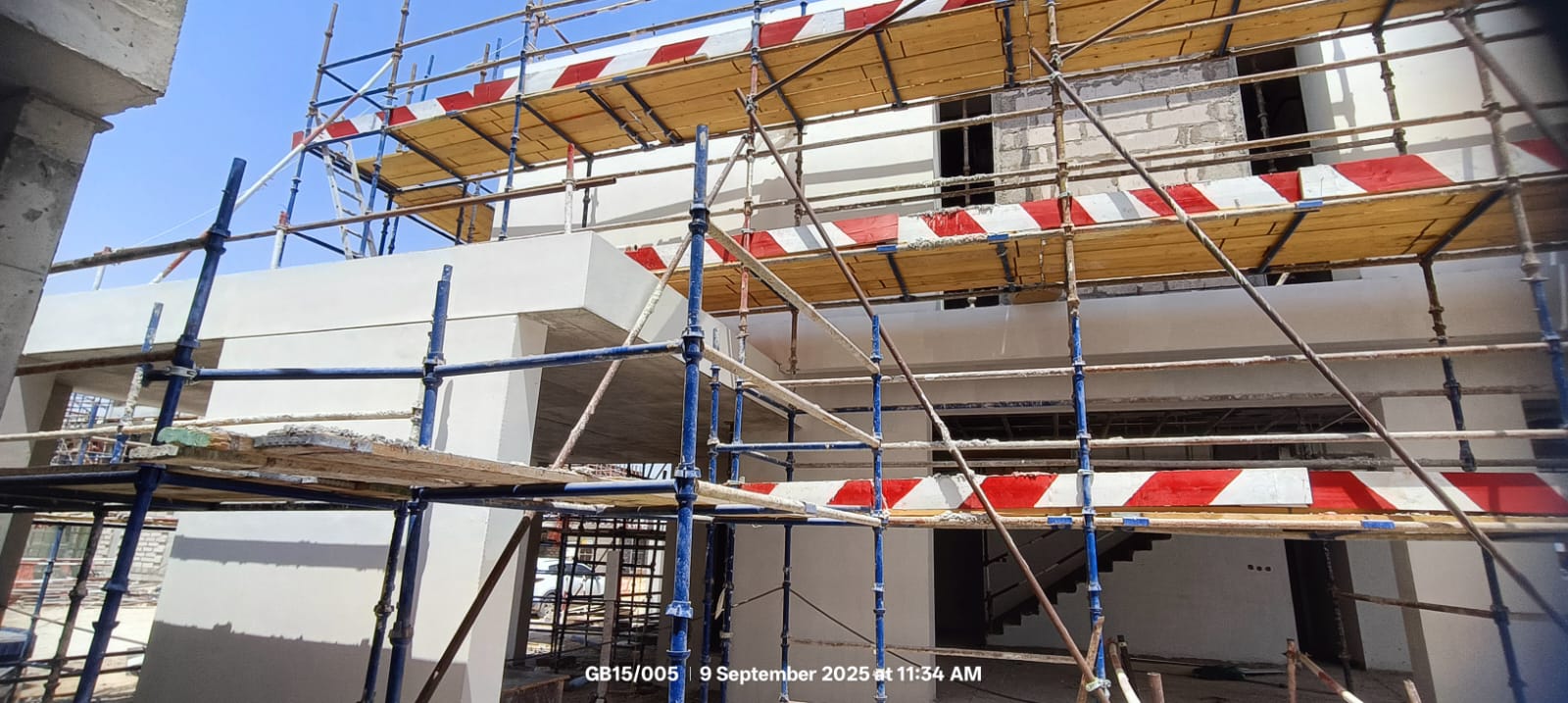

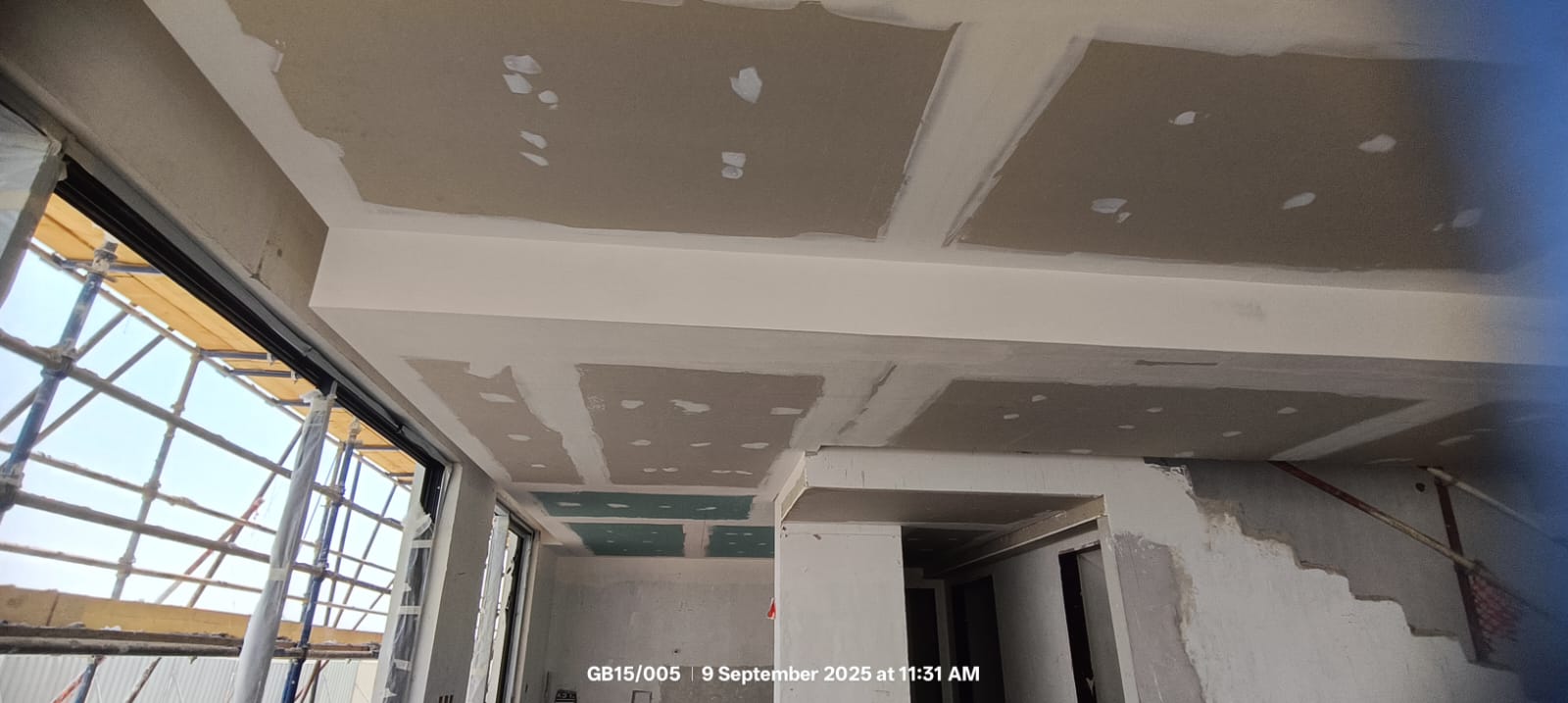

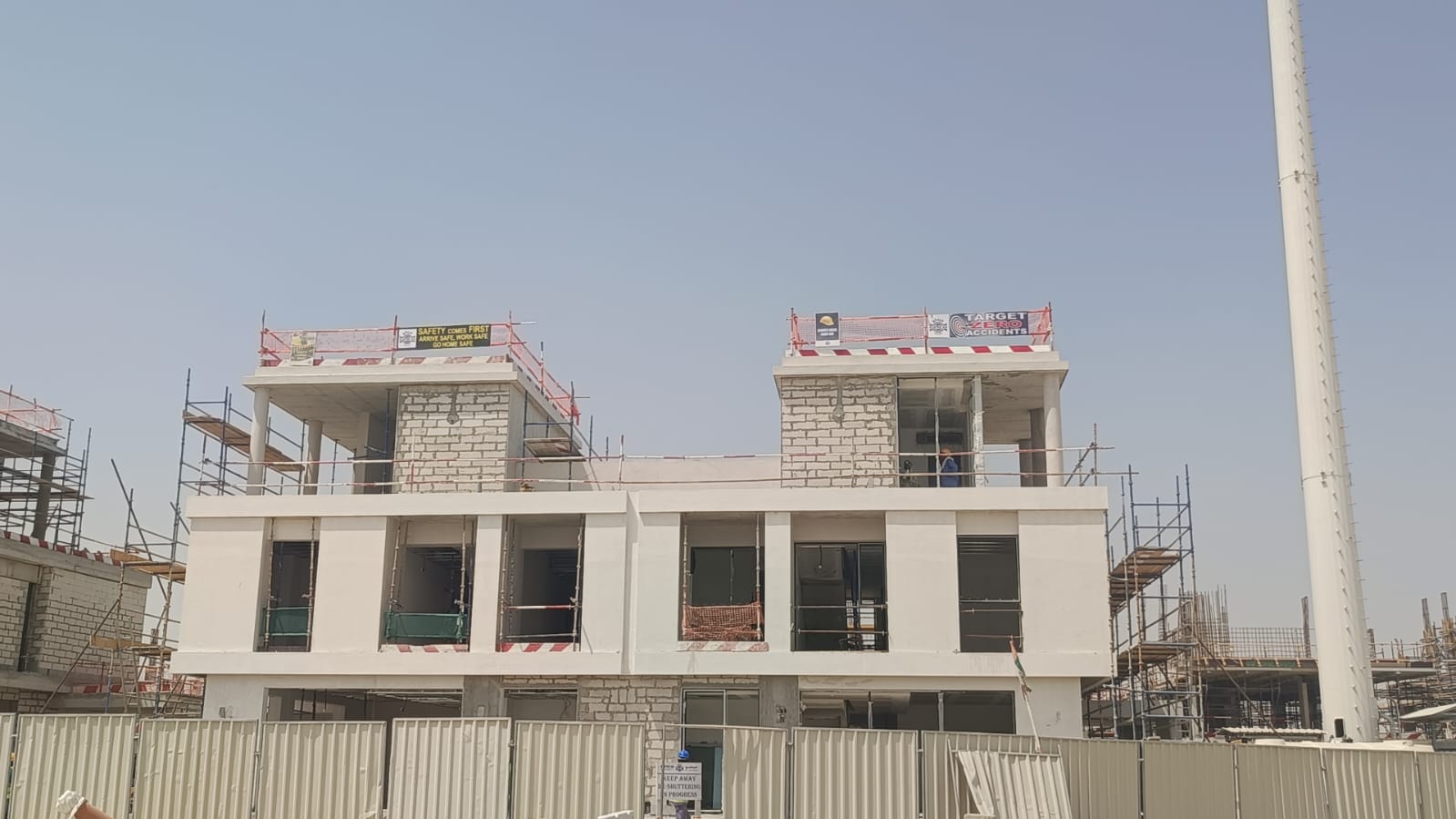

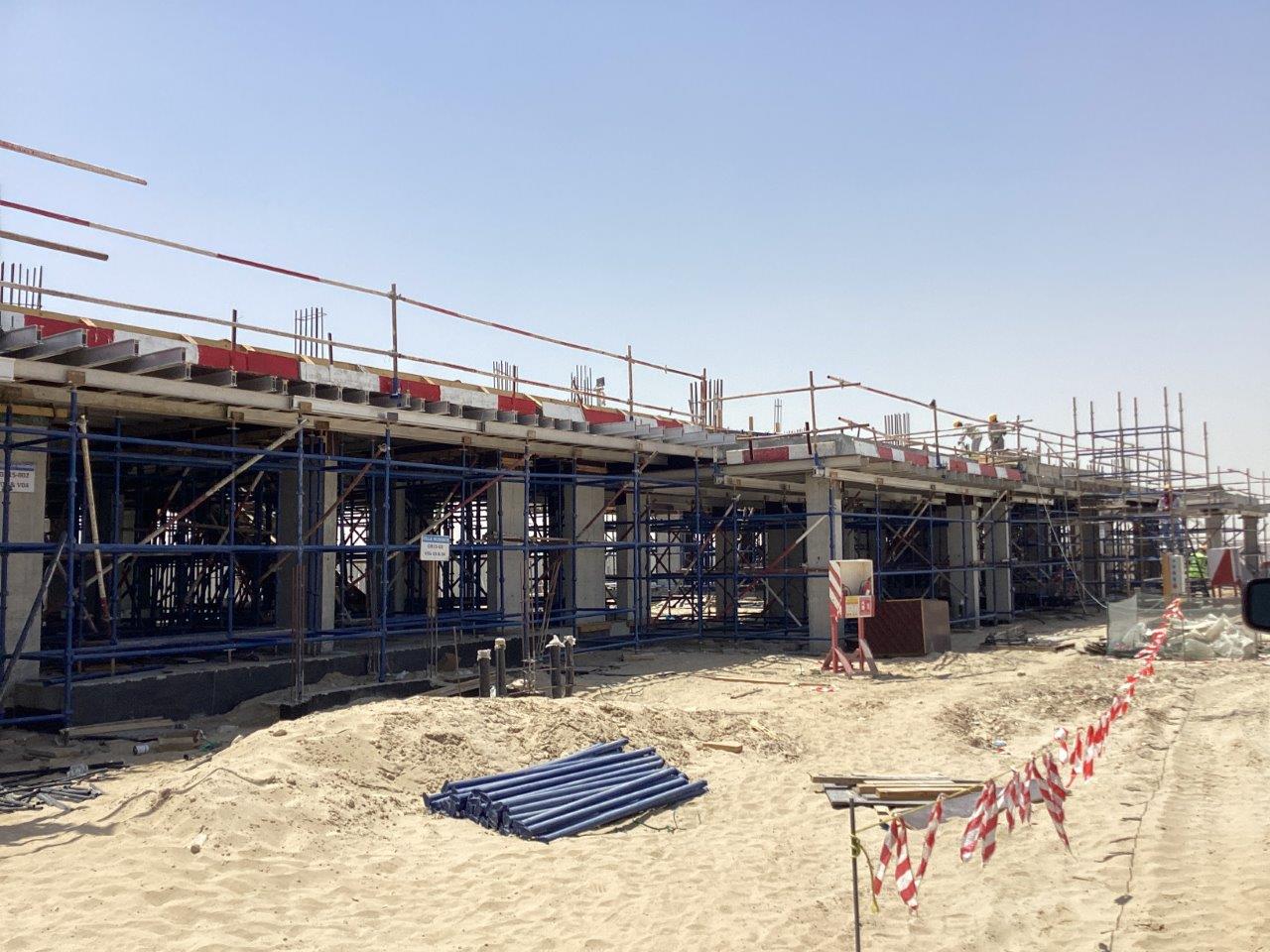

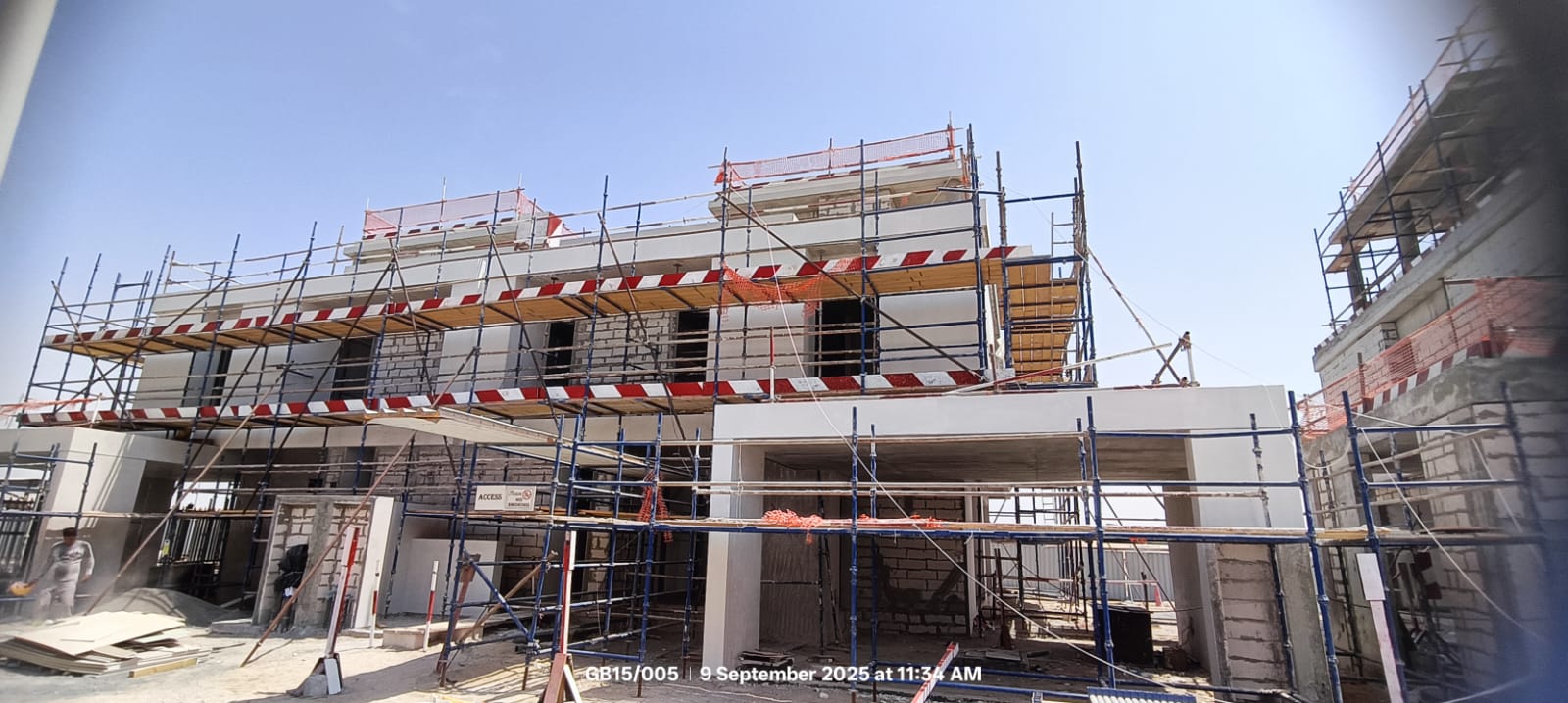

9 September 202522% built

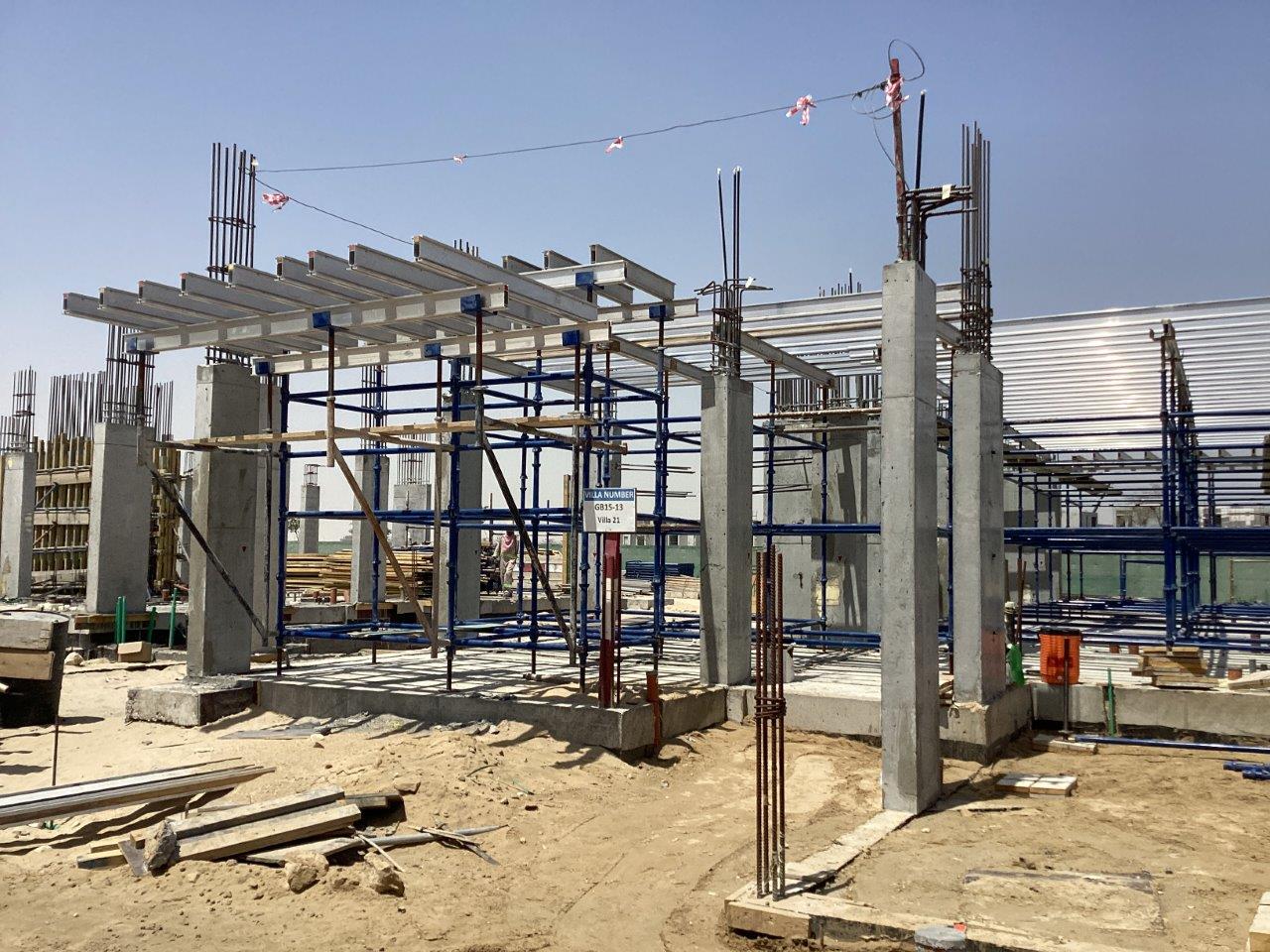

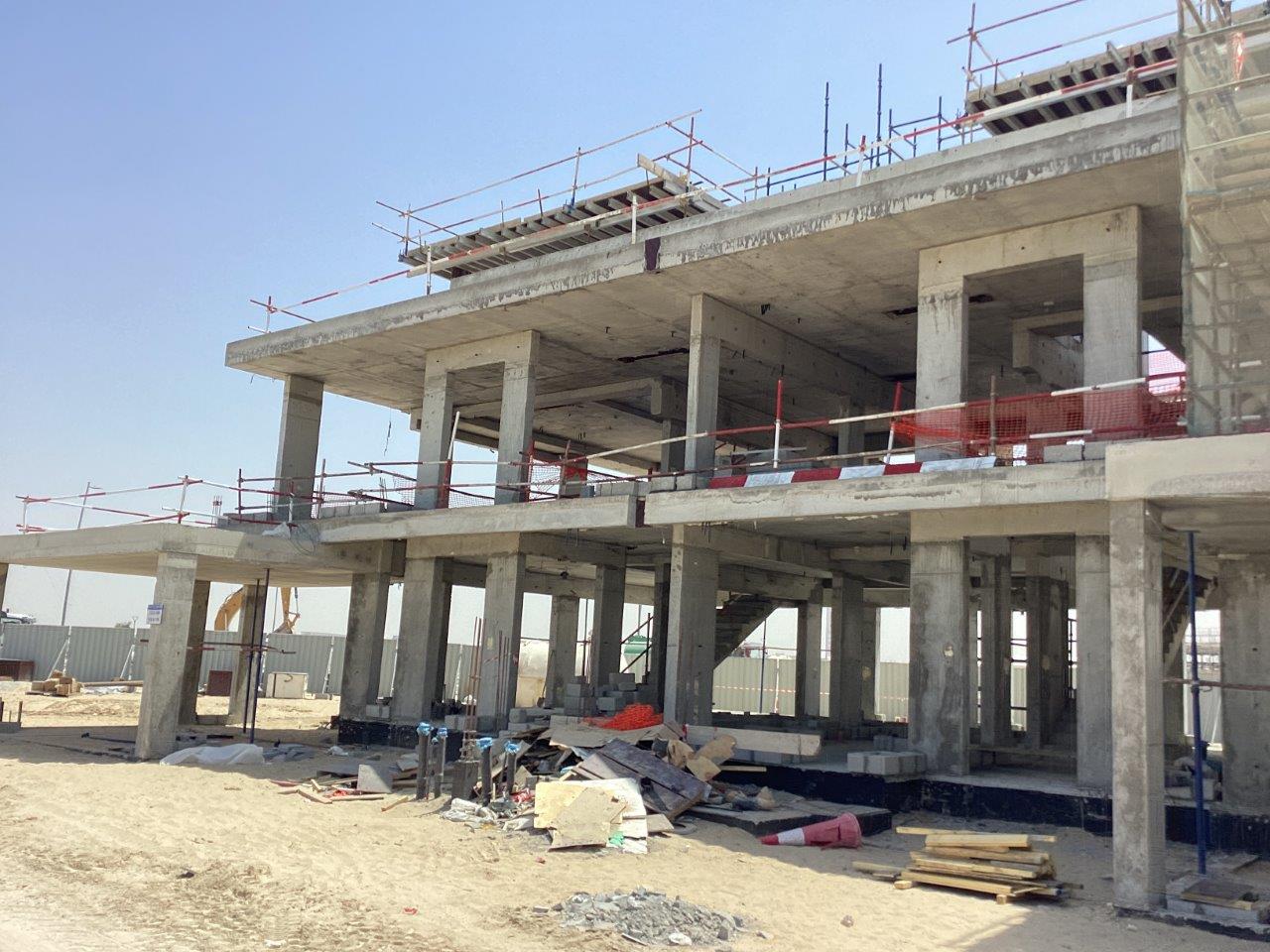

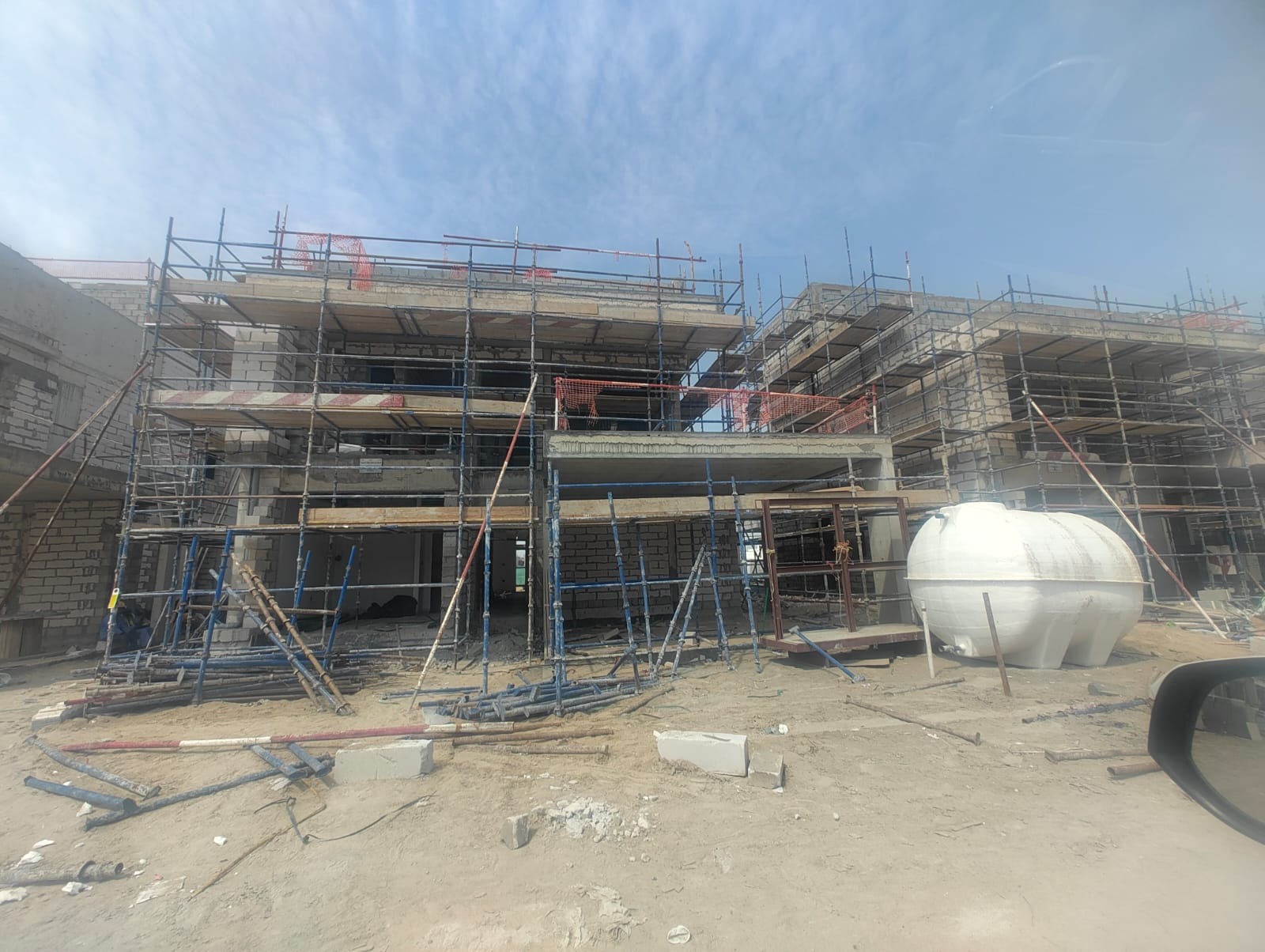

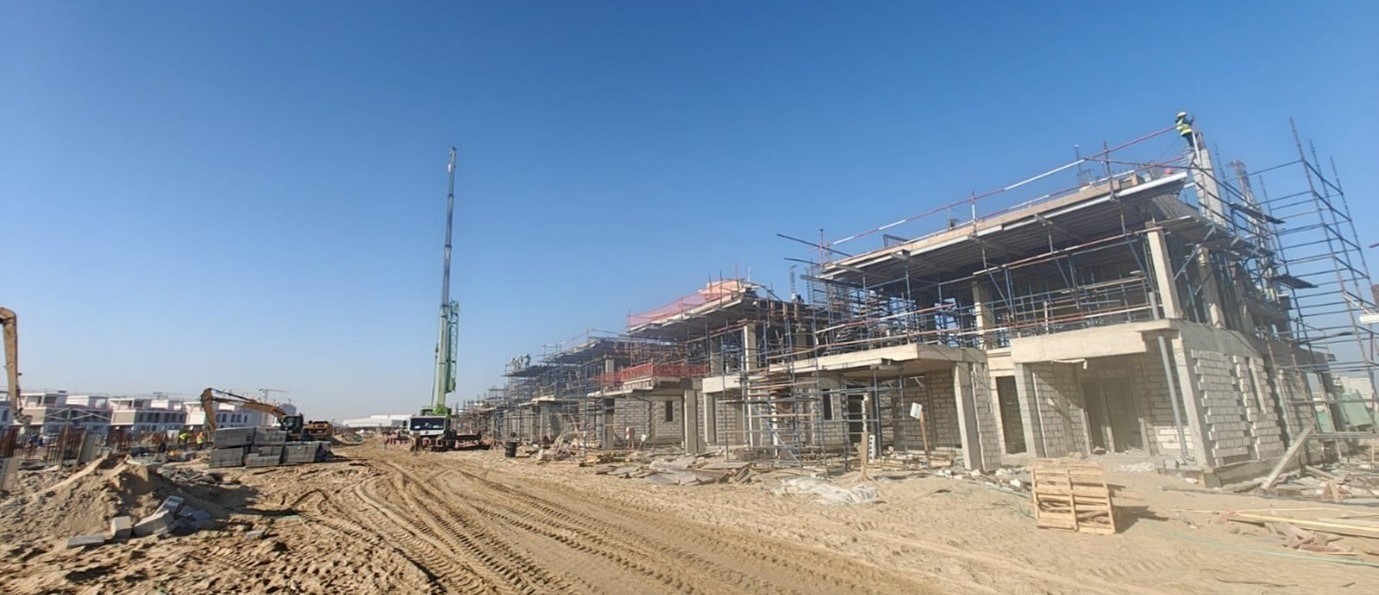

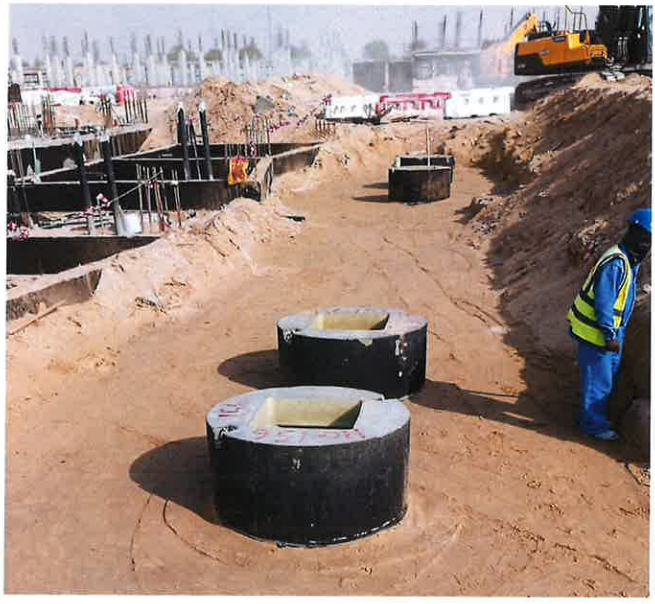

16 May 202511% built

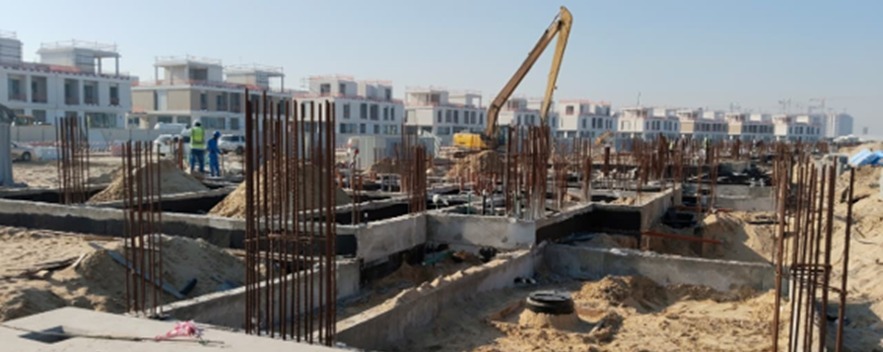

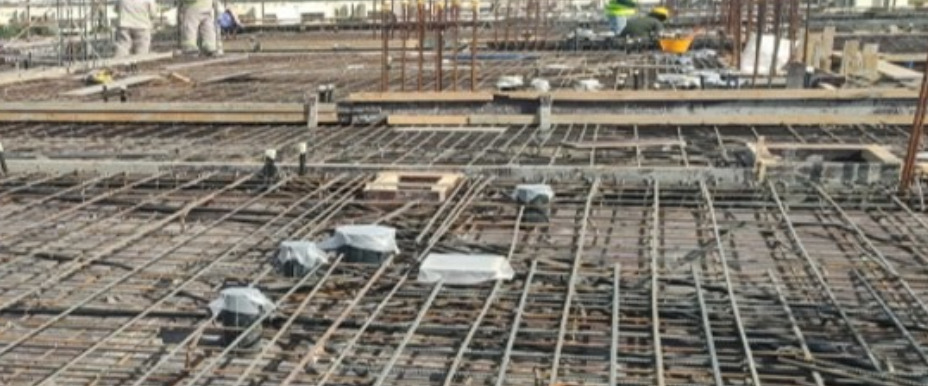

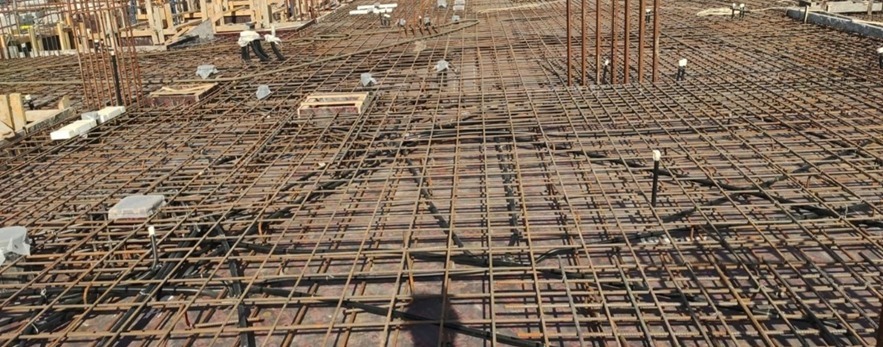

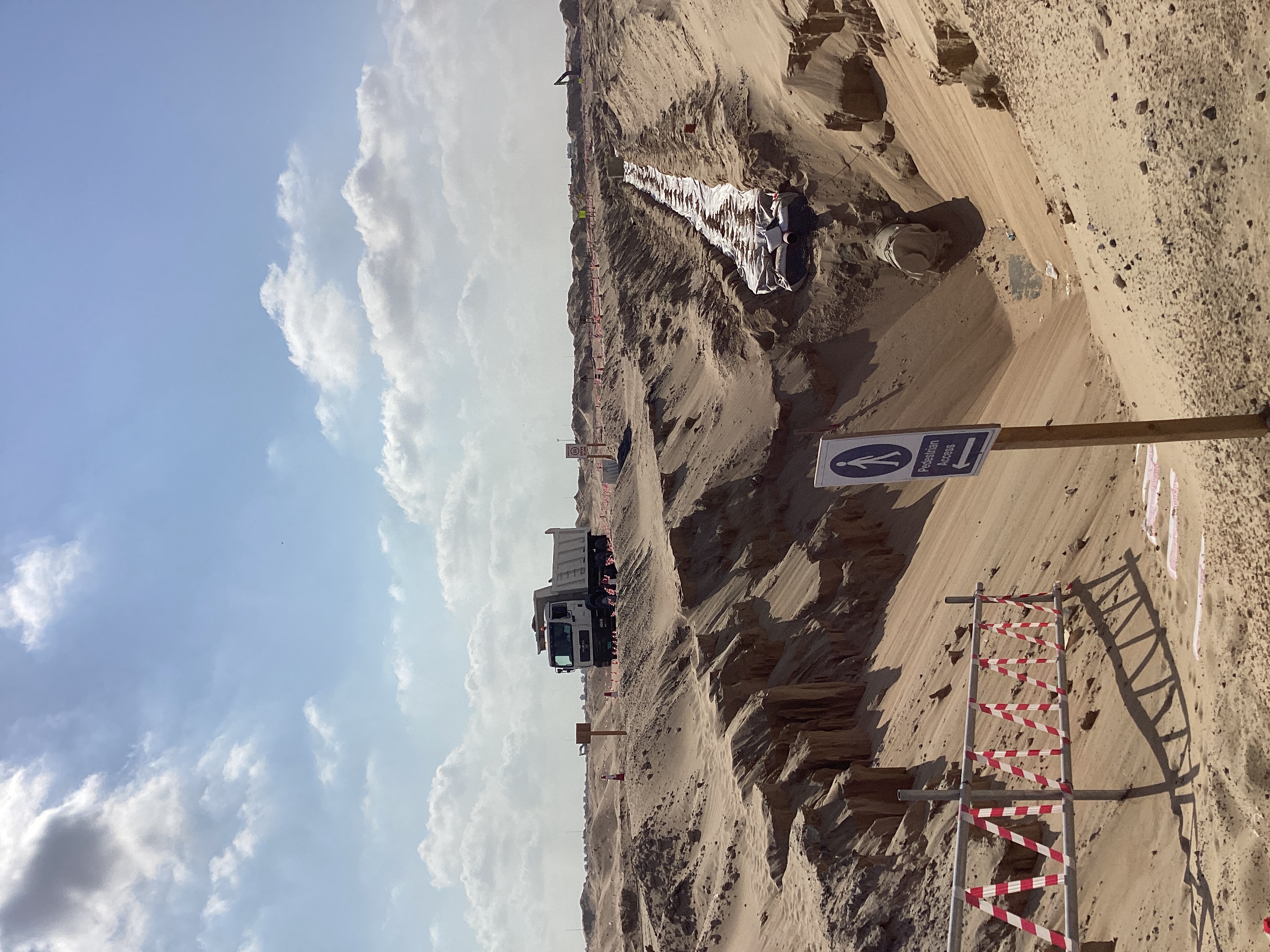

28 January 20252.6% built

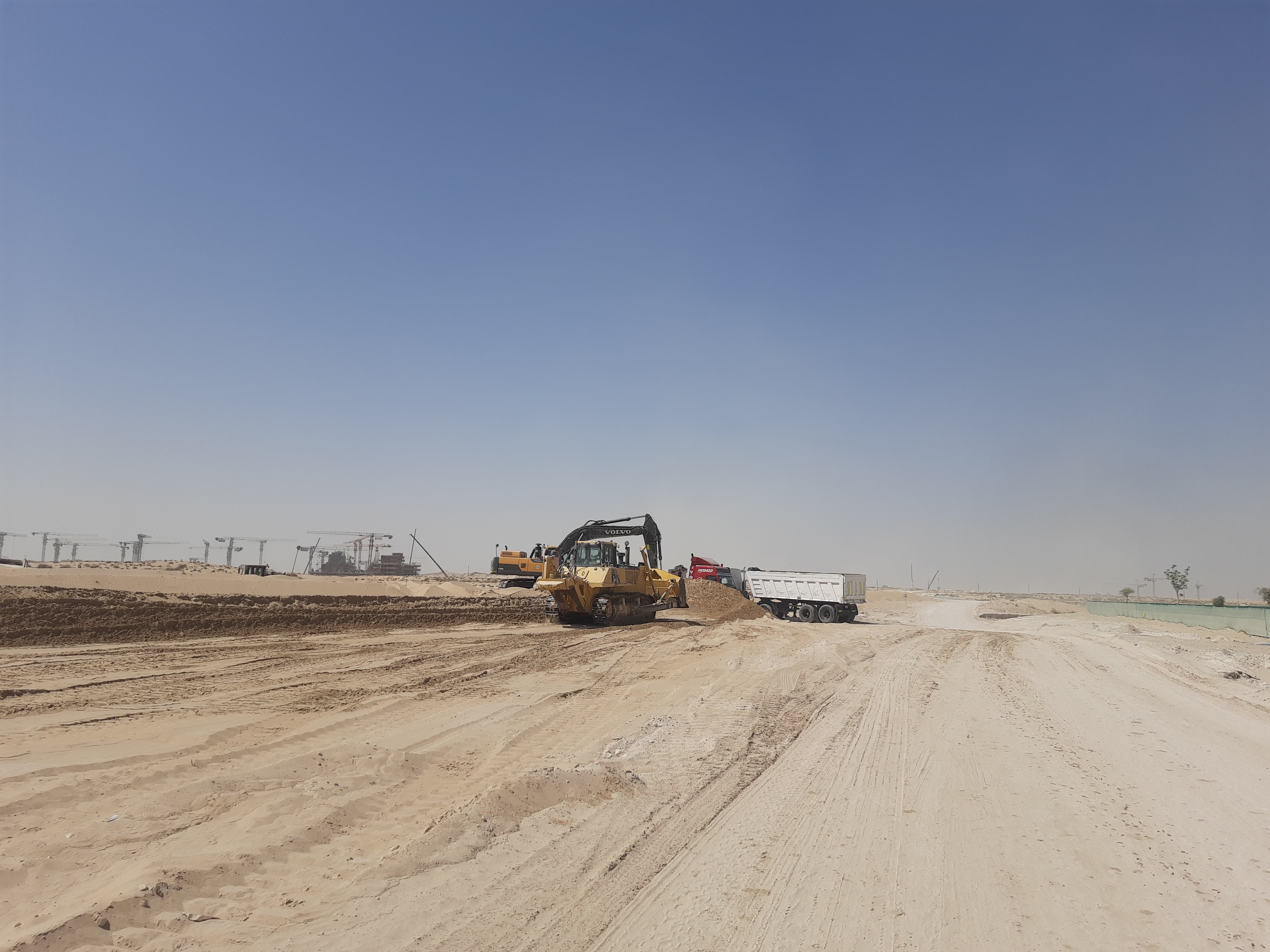

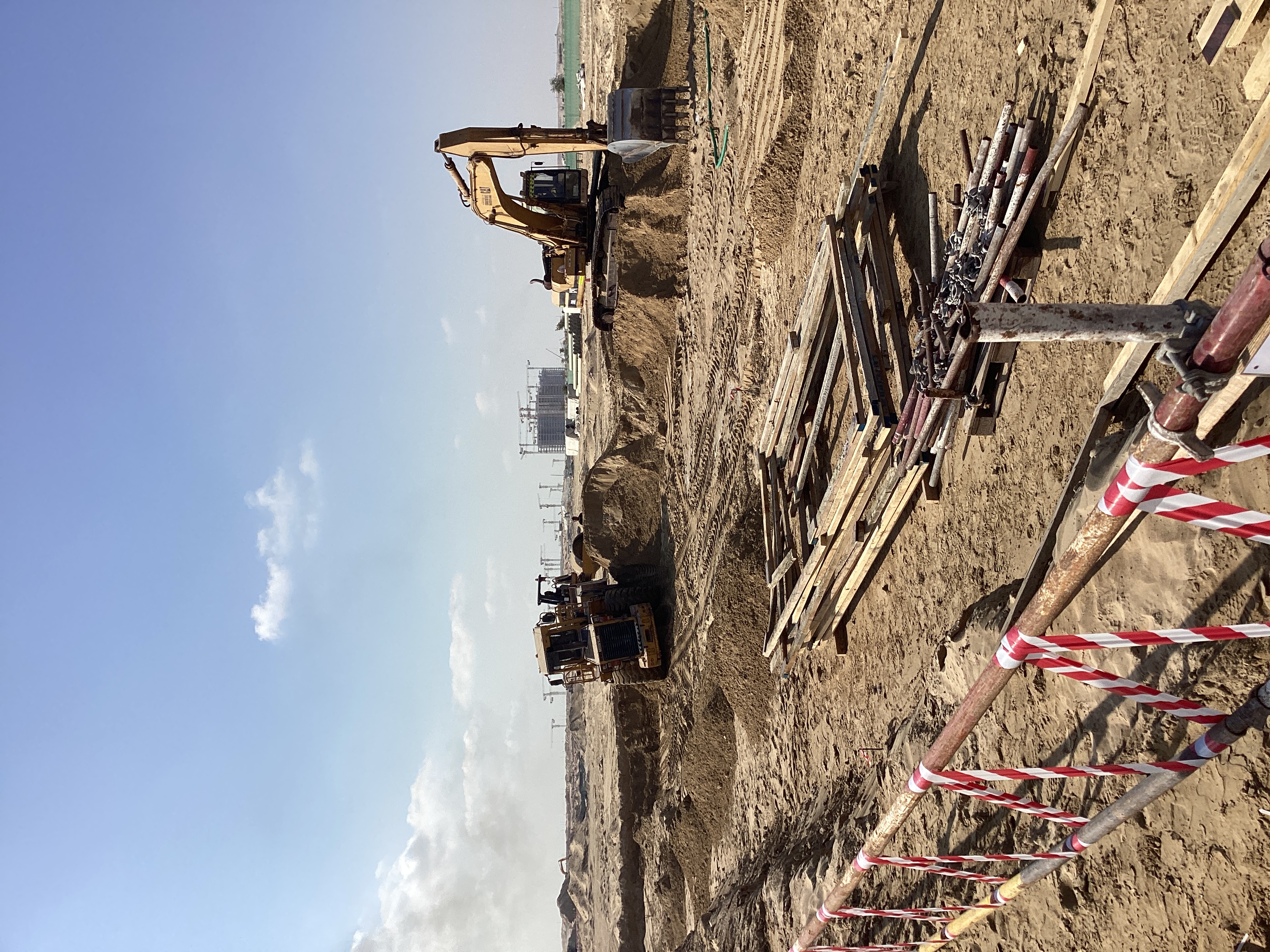

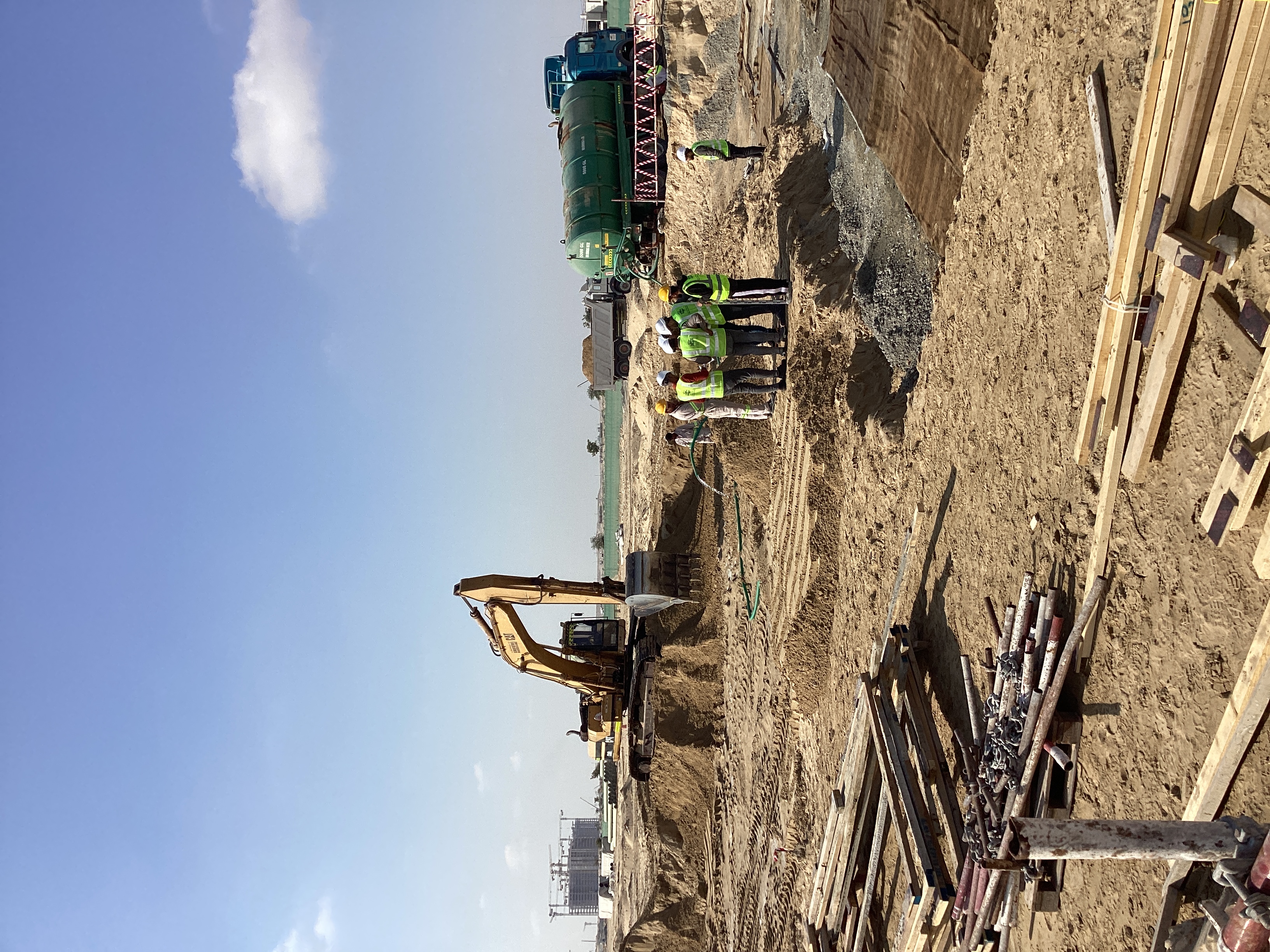

16 September 20240.3% built

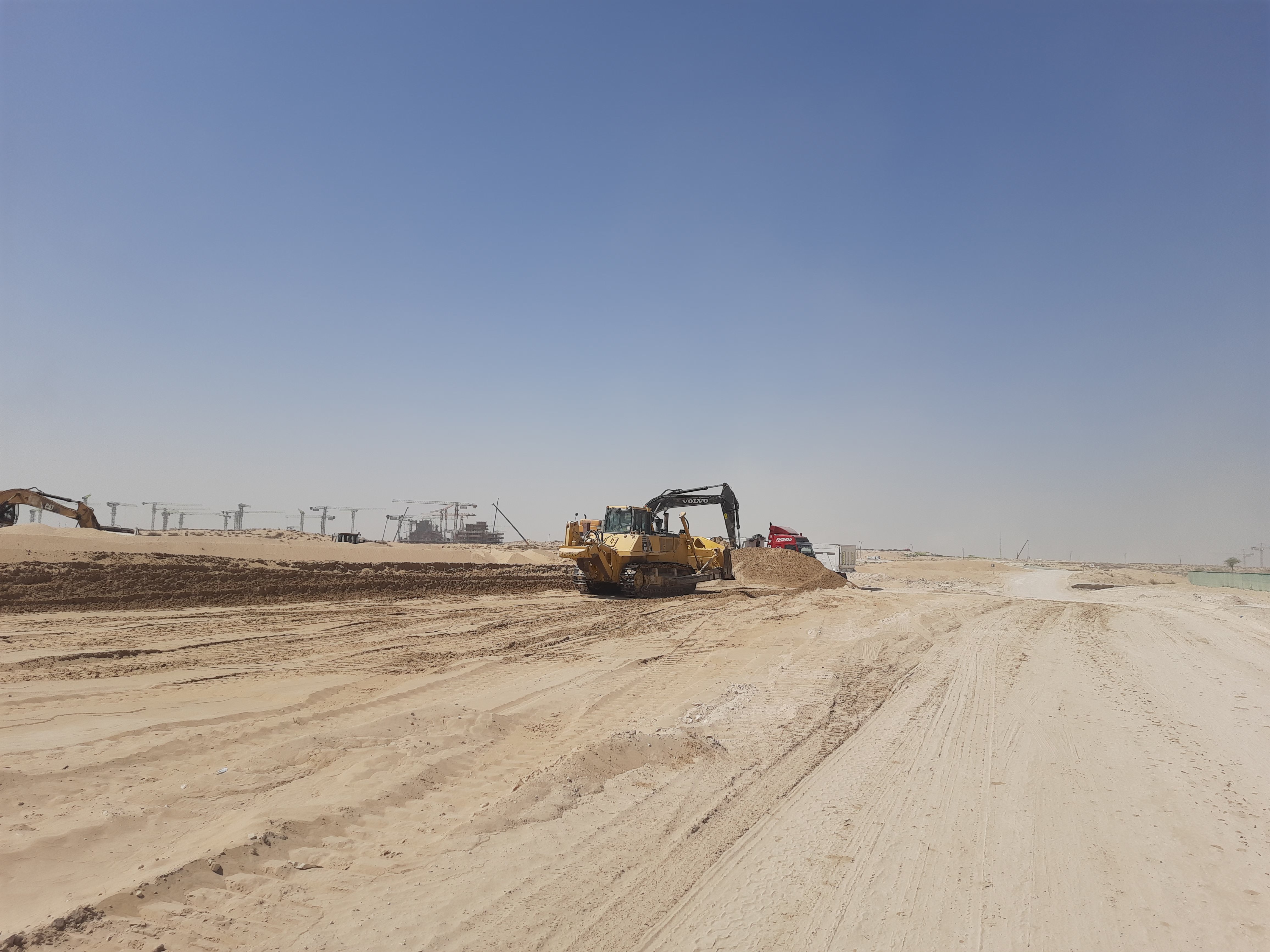

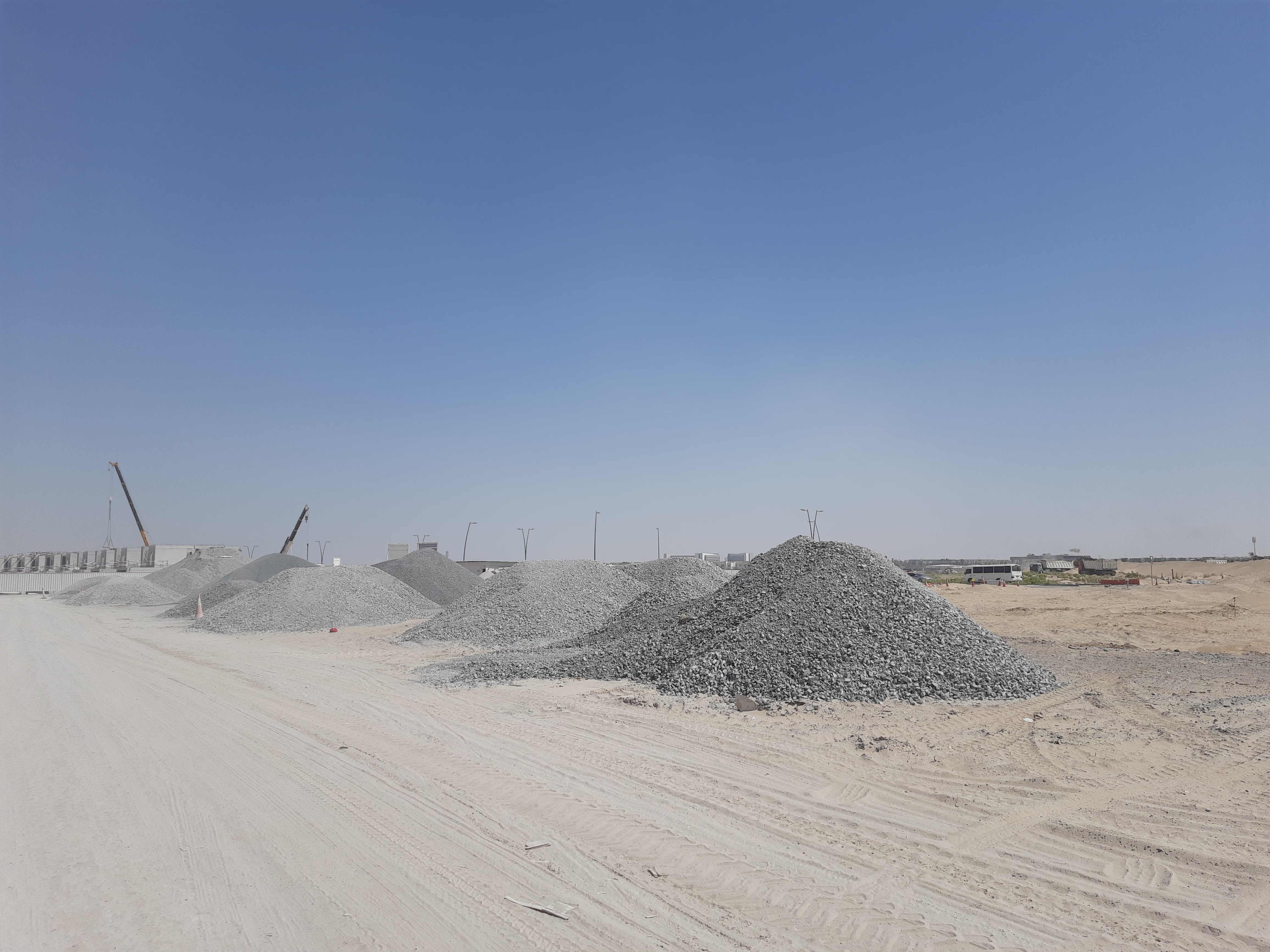

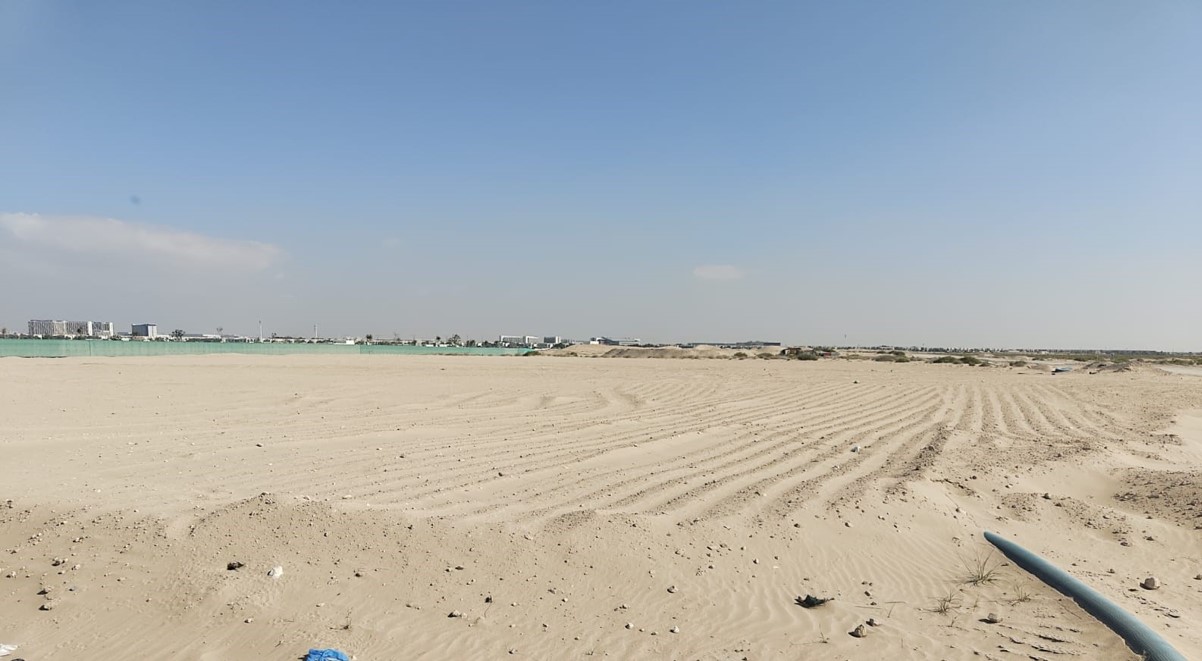

12 February 20240% built
