Greenspoint 2 construction progress

The registered completion date for Greenspoint 2 in Dubai World Central is March 2029. At the last site inspection, in August 2026, it was 40% built. The developer is Emaar Dubai South Dwc.

40%

Built, at the site inspection of 3 August 2026

On pace for its date

Registered completion date
March 2029
Finish at recent pace
December 2027
Construction started
January 2025
First registered
February 2025
Units
244
Escrow bank
Abu Dhabi Commercial Bank
Name in Arabic
جرينز بوينت 2
Project number
3558
Site inspections
4

Schedule

Since November 2025 Greenspoint 2 has added about 3.7 points a month. That puts 100% around December 2027, within three months of its registered completion date of March 2029.

0%25%50%75%100%2026202720282029
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

3 August 2026

40%+20 pts

  • Greenspoint 2 construction site, inspection photo 1, 3 August 2026
  • Greenspoint 2 construction site, inspection photo 2, 3 August 2026
  • Greenspoint 2 construction site, inspection photo 3, 3 August 2026
  • Greenspoint 2 construction site, inspection photo 4, 3 August 2026

21 April 2026

20%+11 pts

  • Greenspoint 2 construction site, inspection photo 1, 21 April 2026
  • Greenspoint 2 construction site, inspection photo 2, 21 April 2026
  • Greenspoint 2 construction site, inspection photo 3, 21 April 2026
  • Greenspoint 2 construction site, inspection photo 4, 21 April 2026

27 November 2025

9.6%+9.6 pts

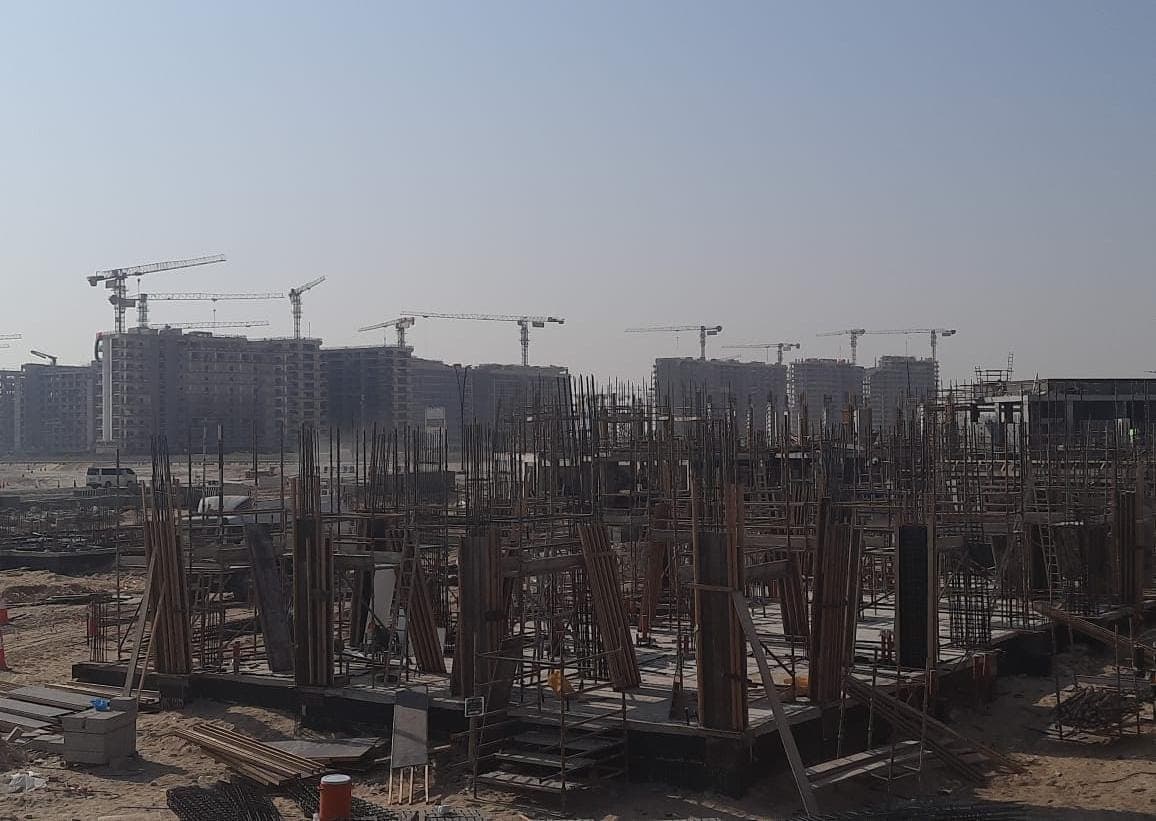

  • Greenspoint 2 construction site, inspection photo 1, 27 November 2025

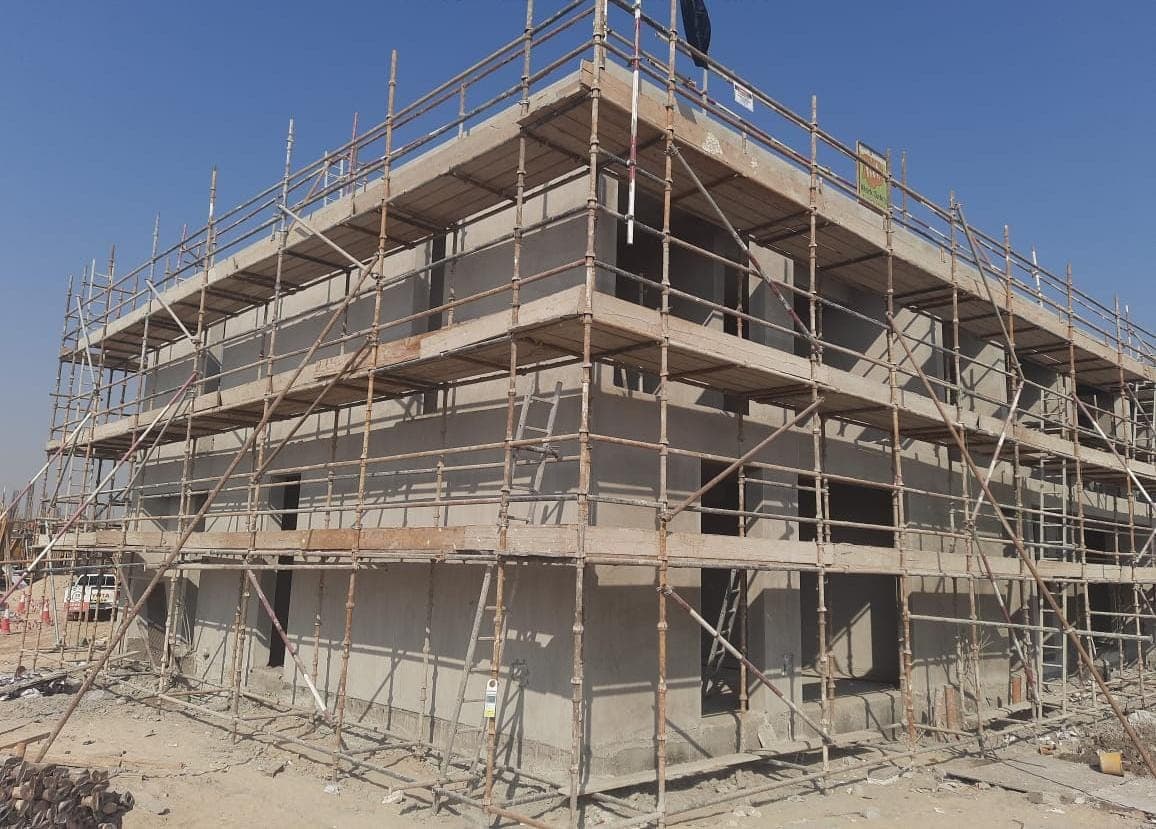

  • Greenspoint 2 construction site, inspection photo 2, 27 November 2025
  • Greenspoint 2 construction site, inspection photo 3, 27 November 2025
  • Greenspoint 2 construction site, inspection photo 4, 27 November 2025

11 February 2025

0%

  • Greenspoint 2 construction site, inspection photo 1, 11 February 2025
  • Greenspoint 2 construction site, inspection photo 2, 11 February 2025

All 24 site photos, by inspection date

Context

Dubai World Central has 53 projects under construction, 31% built on average.

Emaar Dubai South Dwc has 23 projects under construction in Dubai, none past their registered completion dates.

Own a unit in Greenspoint 2?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Greenspoint 2 handover date?
The registered completion date is March 2029. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around December 2027. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Greenspoint 2?
Greenspoint 2 was 40% built at the site inspection on 3 August 2026. The site has been inspected 4 times since February 2025. The Land Department took 24 site photos at its inspections.
Is Greenspoint 2 delayed?
Not on current figures. At the rate of the last year it finishes within three months of its registered date of March 2029.
Who is building Greenspoint 2?
The registered developer is Emaar Dubai South Dwc. It has 22 other projects under construction in Dubai.
Which bank holds the escrow account for Greenspoint 2?
Abu Dhabi Commercial Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
