Bluewaters Bay construction progress
The registered completion date for Bluewaters Bay in Dubai Marina is March 2027. At the last site inspection, in August 2026, it was 37% built. The developer is Dhre 2 Bts.
37%
Built, at the site inspection of 25 August 2026
Running behind its date
- Registered completion date
- March 2027
- Finish at recent pace
- March 2029
- Construction started
- February 2023
- First registered
- December 2022
- Developer
- Dhre 2 Bts
- Community
- Dubai Marina
- Units
- 679
- Escrow bank
- Abu Dhabi Commercial Bank
- Name in Arabic
- بلوواترز باي
- Project number
- 2530
- Site inspections
- 11
Schedule
Between October 2025 and August 2026 the site added about 2.0 points a month. At that rate it would finish around March 2029, more than three months after its registered date of March 2027.
Site inspections
25 August 2026
37%+8.6 pts
27 April 2026
28%+6.1 pts

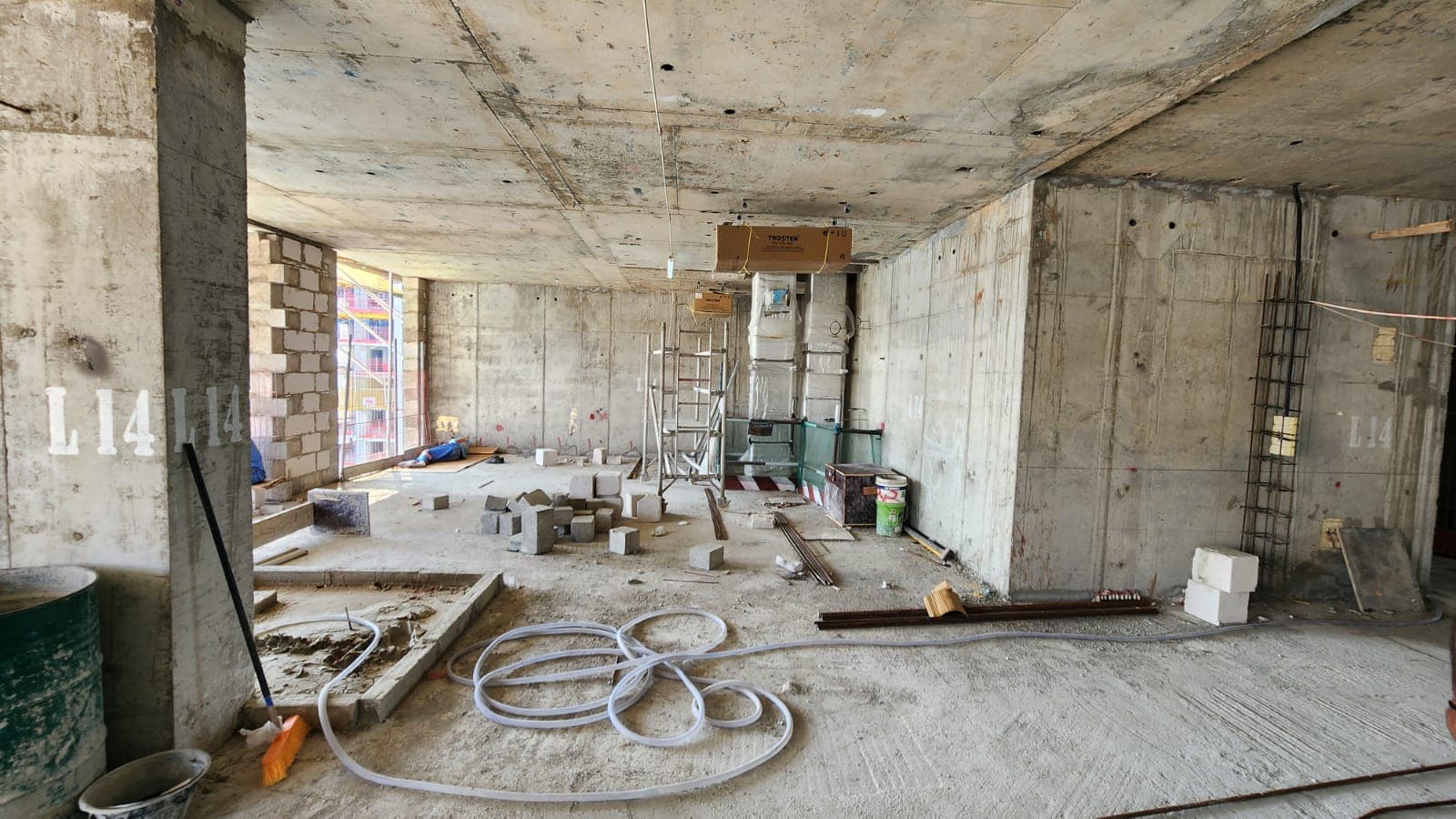

26 January 2026
22%+6.7 pts
7 October 2025
16%+3.1 pts
7 July 2025
13%+2.1 pts
18 April 2025
10%+3.0 pts
16 January 2025
7.4%+5.4 pts

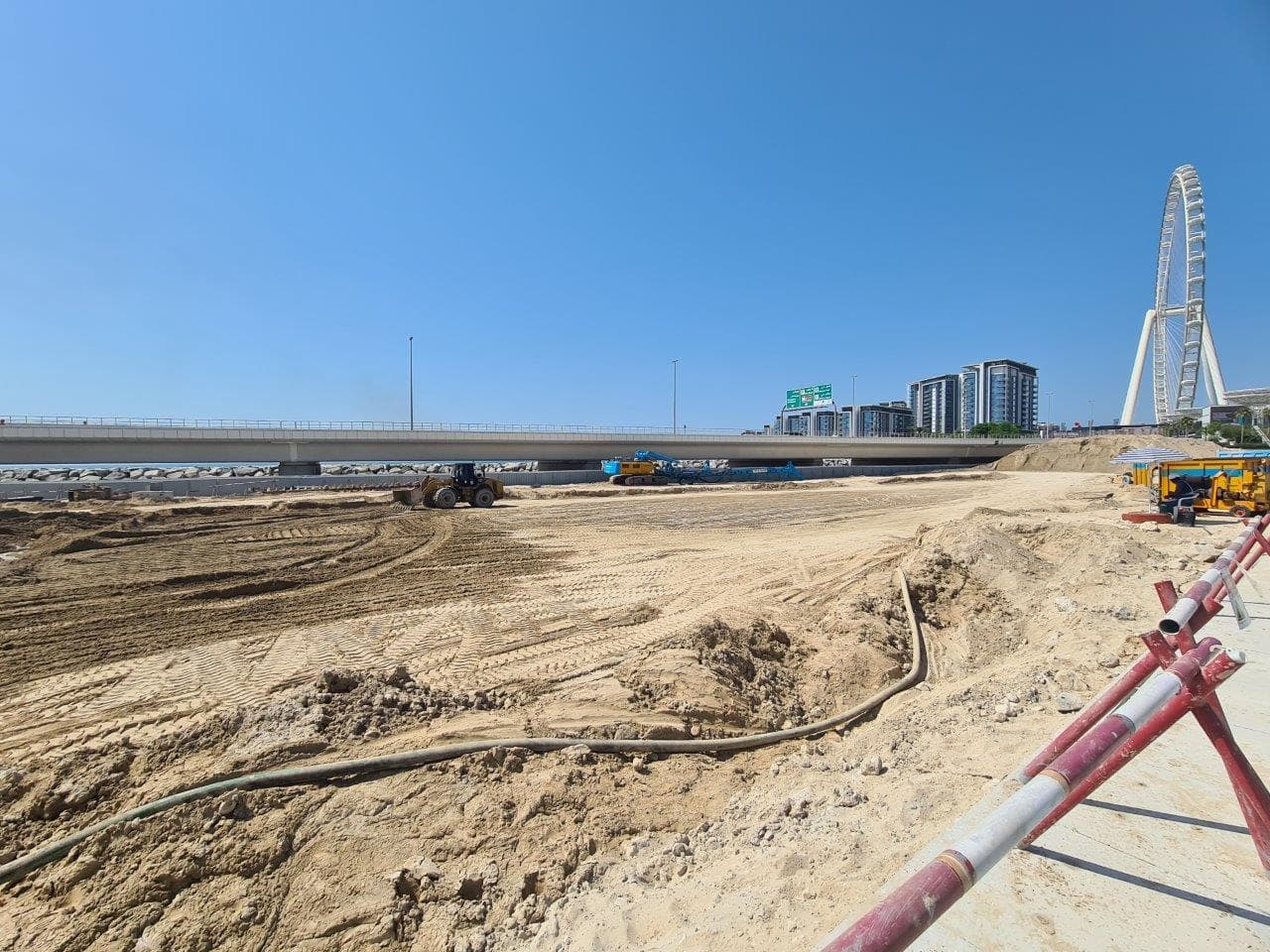

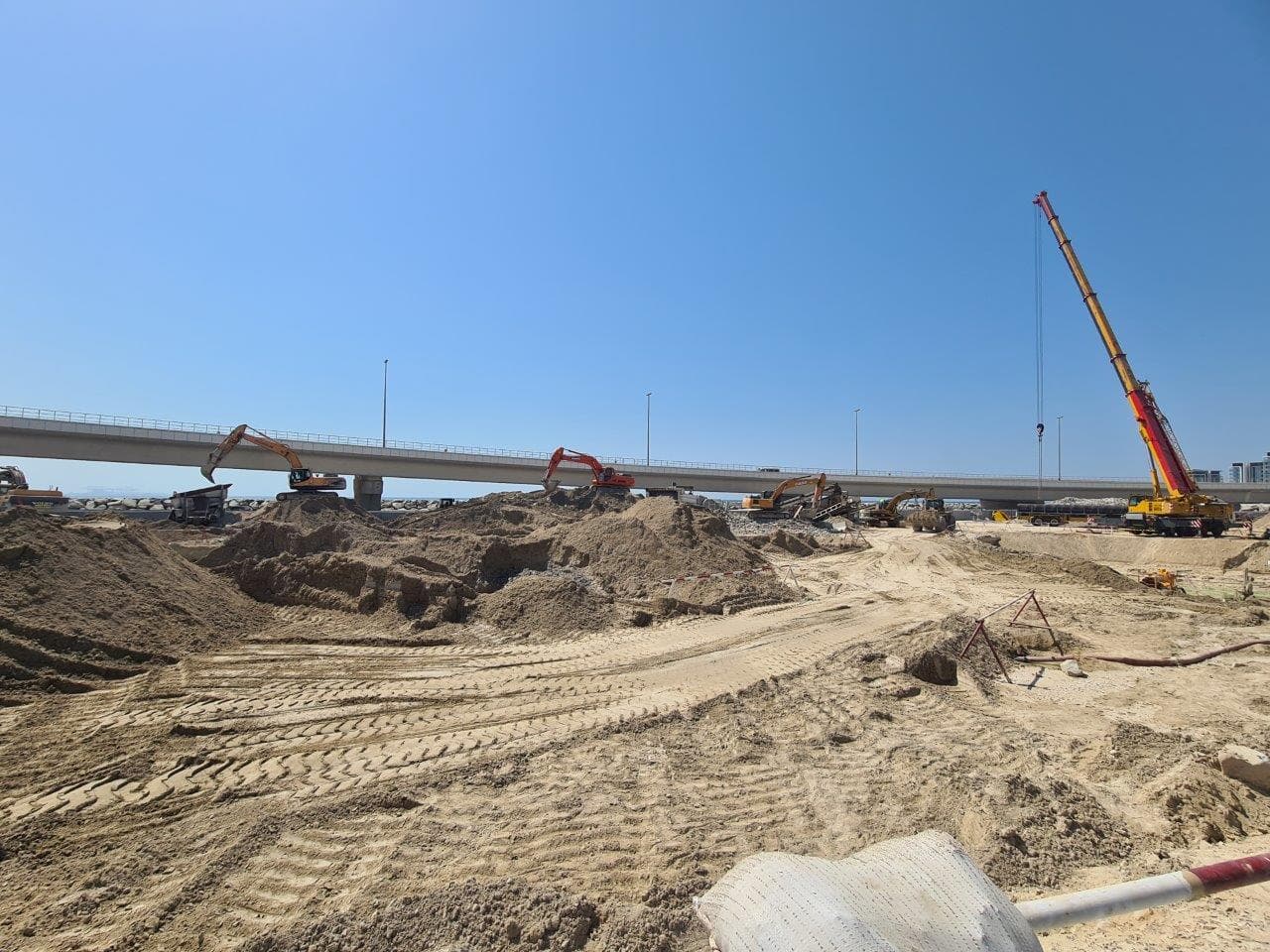

23 September 2024
2.0%+0.2 pts

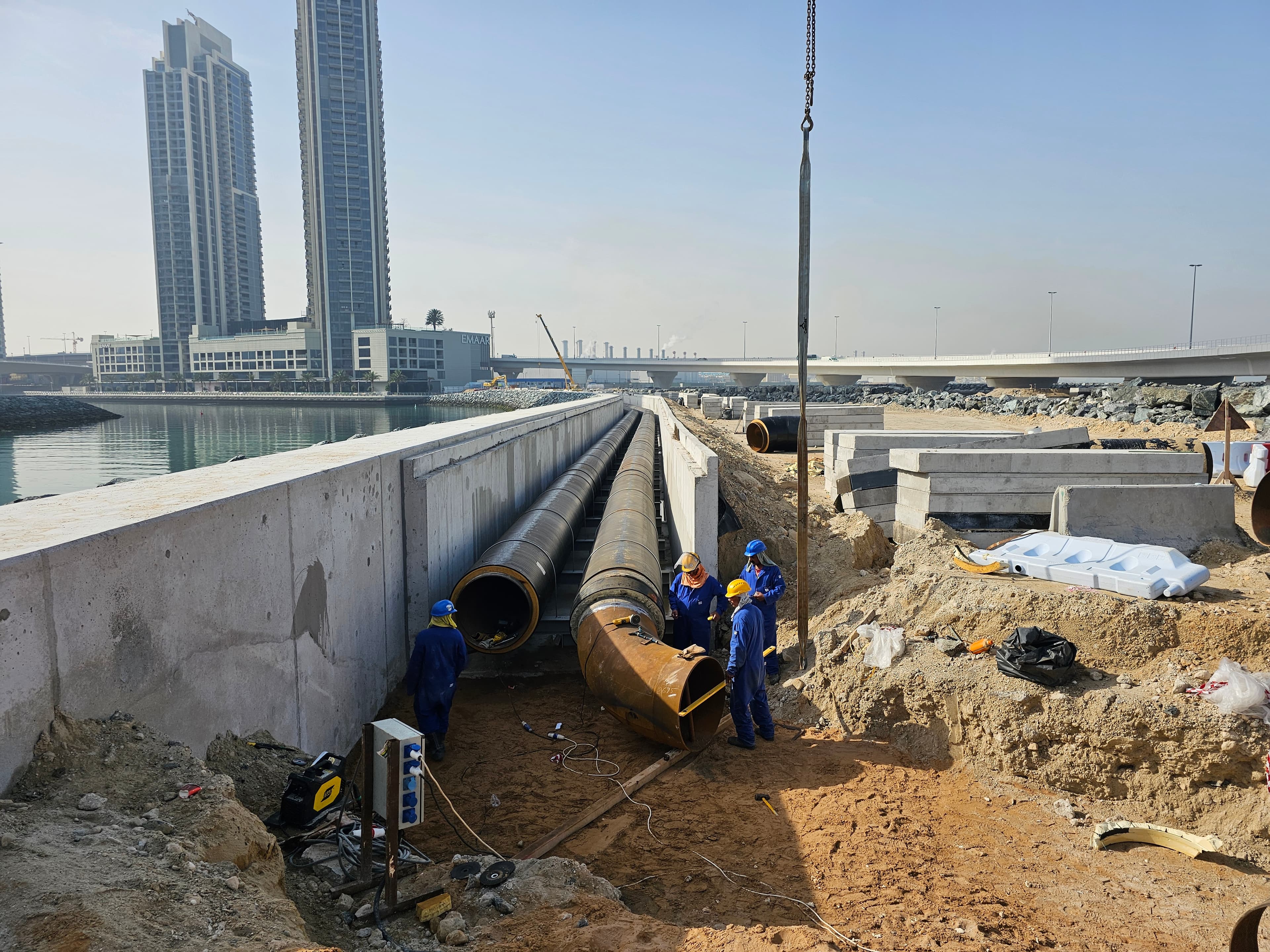

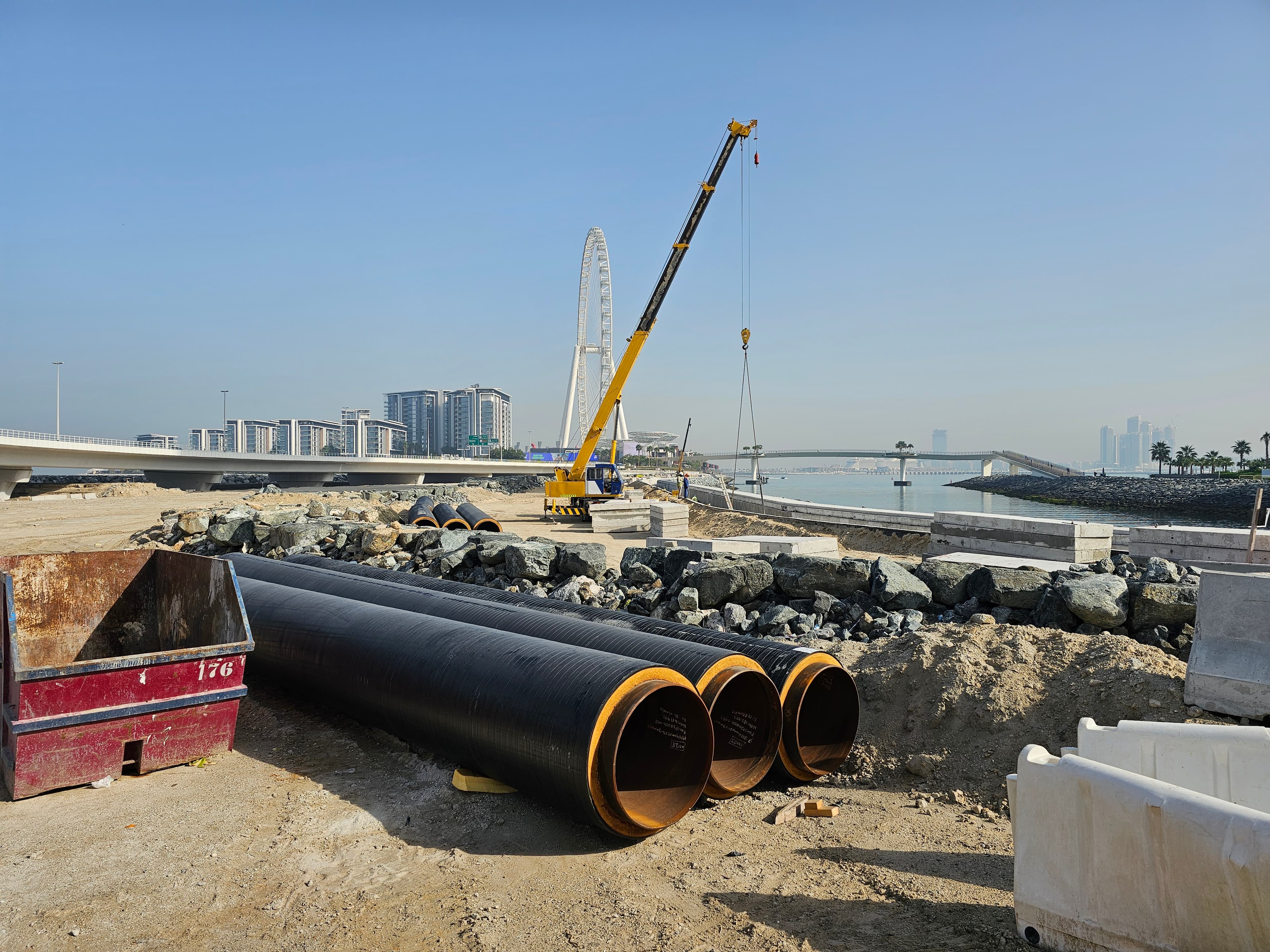

21 March 2024
1.9%+0.9 pts
9 August 2023
0.9%+0.9 pts
Context
Dubai Marina has 13 projects under construction, 46% built on average.
Dhre 2 Bts has 12 projects under construction in Dubai, none past their registered completion dates.
Own a unit in Bluewaters Bay?
Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When is the Bluewaters Bay handover date?
- The registered completion date is March 2027. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around March 2029. RERA asks developers to update their dates as projects move, so check the register before relying on it.
- What is the latest construction update on Bluewaters Bay?
- Bluewaters Bay was 37% built at the site inspection on 25 August 2026. The site has been inspected 11 times since November 2022. The Land Department took 70 site photos at its inspections.
- Is Bluewaters Bay delayed?
- It is running behind. At the rate of the last year it would finish more than three months after its registered date of March 2027.
- Who is building Bluewaters Bay?
- The registered developer is Dhre 2 Bts. It has 11 other projects under construction in Dubai.
- Which bank holds the escrow account for Bluewaters Bay?
- Abu Dhabi Commercial Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- Bulgari Lighthouse DubaiAlso by Dhre 2 Bts. 80%, Due March 2027.
- Design QuarterAlso by Dhre 2 Bts. 41%, Due February 2027.
- The AcresAlso by Dhre 2 Bts. 38%.
- The Acres 3 & EstatesAlso by Dhre 2 Bts. 15%, Due November 2027.
- Pier 8Nearby in Dubai Marina. 93%, Due March 2026, passed.
- Marina ShoresNearby in Dubai Marina. 87%, Due December 2026.
- Liv LuxNearby in Dubai Marina. 87%, Due December 2026.
- Aeternitas TowerNearby in Dubai Marina. 58%, Due December 2027.
- Checking an off-plan project's progressHow to read the completion percentage and what escrow allows when a payment runs ahead.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.




















.jpg&w=3840&q=75)
.jpg&w=3840&q=75)
.jpg&w=3840&q=75)
.jpg&w=3840&q=75)
