The Acres 3 & Estates construction progress

The registered completion date for The Acres 3 & Estates in Wadi Al Safa 7 is November 2027. At the last site inspection, in September 2026, it was 15% built. The developer is Dhre 2 Bts.

15%

Built, at the site inspection of 30 September 2026

Running behind its date

Registered completion date
November 2027
Finish at recent pace
September 2032
Construction started
November 2024
First registered
September 2024
Developer
Dhre 2 Bts
Units
291
Escrow bank
Abu Dhabi Commercial Bank
Name in Arabic
ذا إيكرز 3 آند إستيتس
Project number
3126
Site inspections
8

Schedule

Between October 2025 and September 2026 the site added about 1.2 points a month. At that rate it would finish around September 2032, more than three months after its registered date of November 2027.

0%25%50%75%100%202520262027
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

30 September 2026

15%+9.7 pts

  • The Acres 3 & Estates construction site, inspection photo 1, 30 September 2026
  • The Acres 3 & Estates construction site, inspection photo 2, 30 September 2026
  • The Acres 3 & Estates construction site, inspection photo 3, 30 September 2026
  • The Acres 3 & Estates construction site, inspection photo 4, 30 September 2026

24 June 2026

5.1%+4.4 pts

  • The Acres 3 & Estates construction site, inspection photo 1, 24 June 2026
  • The Acres 3 & Estates construction site, inspection photo 2, 24 June 2026

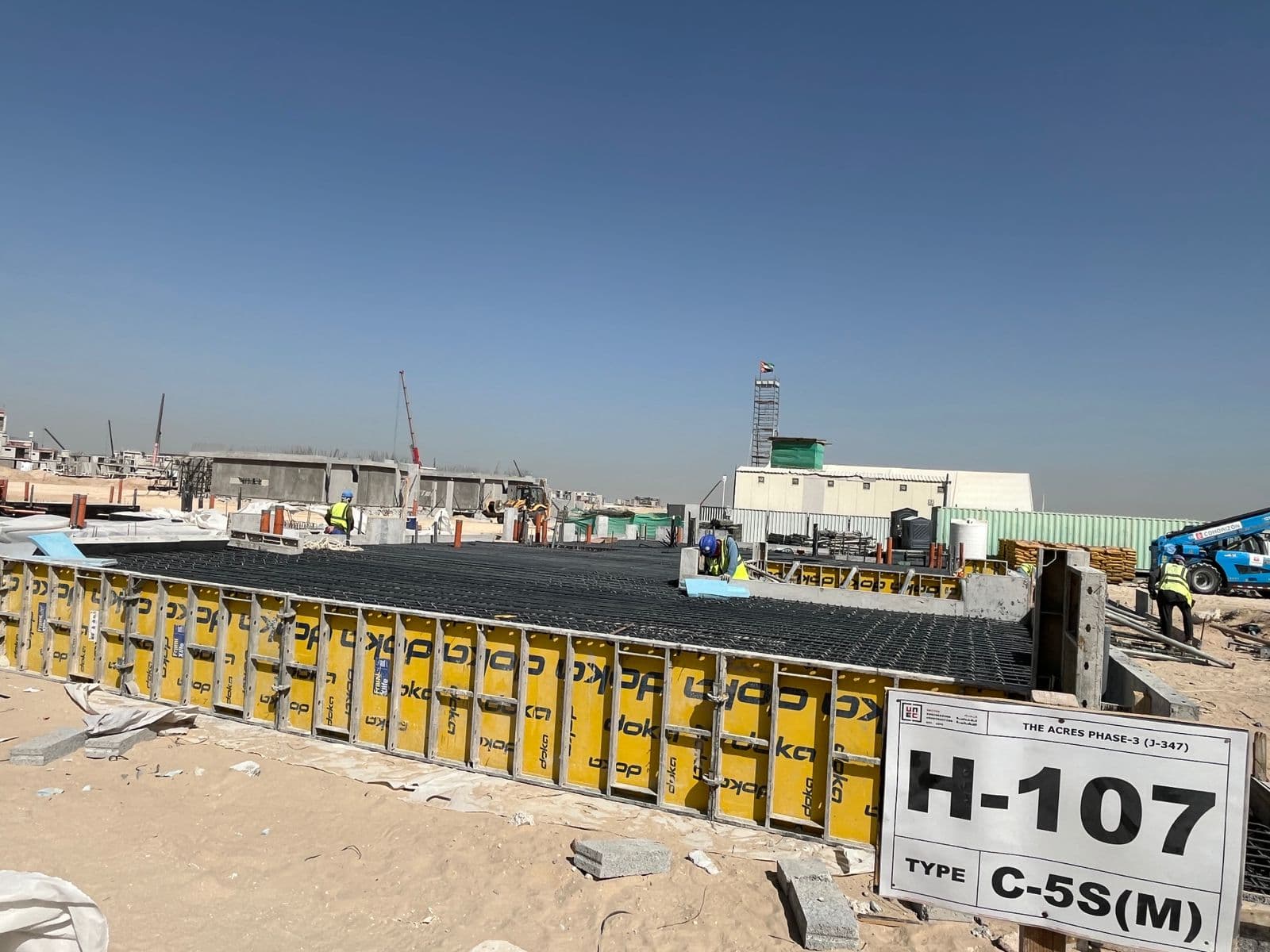

  • The Acres 3 & Estates construction site, inspection photo 3, 24 June 2026

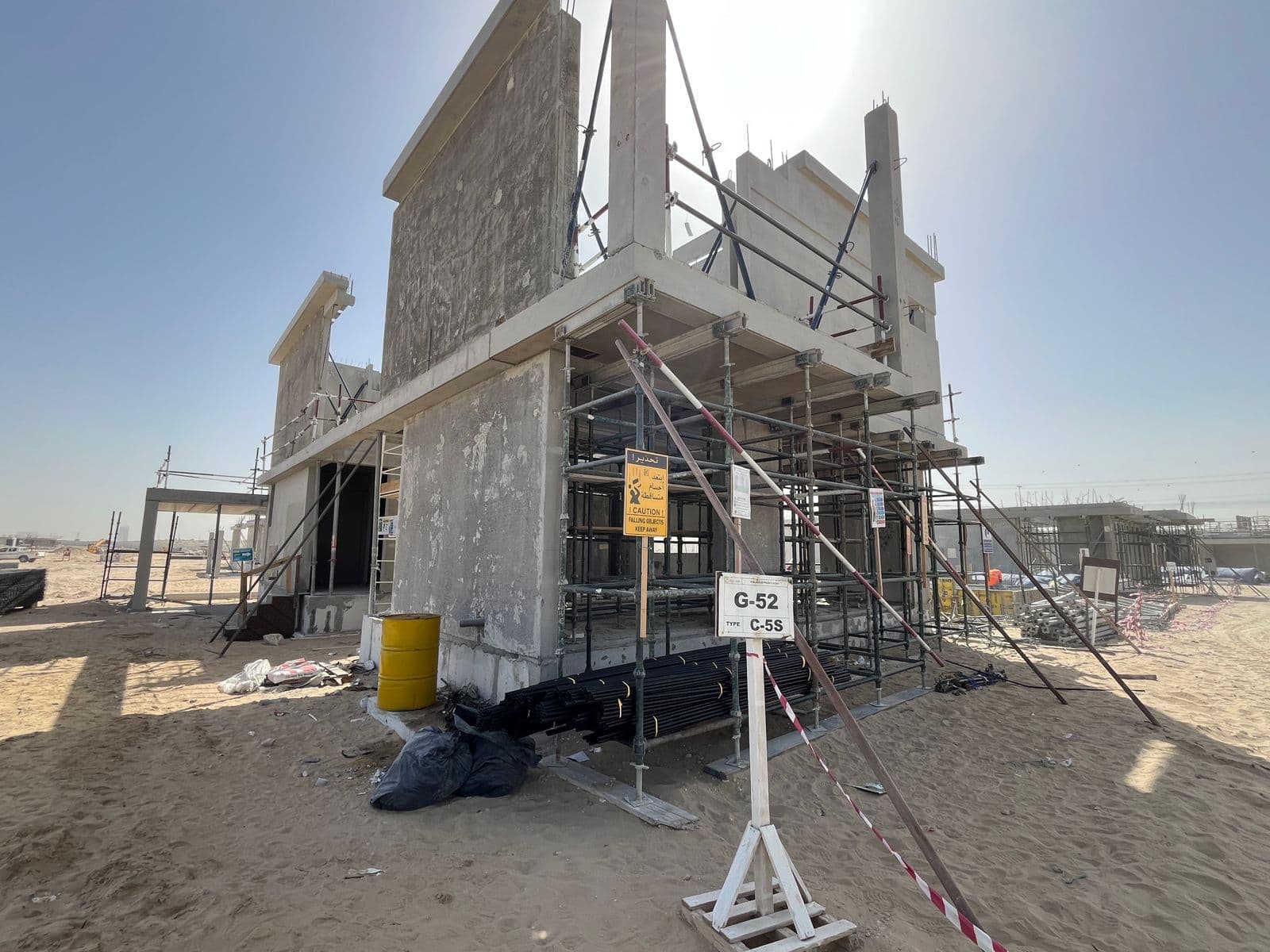

  • The Acres 3 & Estates construction site, inspection photo 4, 24 June 2026

16 March 2026

0.7%

  • The Acres 3 & Estates construction site, inspection photo 1, 16 March 2026
  • The Acres 3 & Estates construction site, inspection photo 2, 16 March 2026
  • The Acres 3 & Estates construction site, inspection photo 3, 16 March 2026

31 December 2025

0.7%

  • The Acres 3 & Estates construction site, inspection photo 1, 31 December 2025
  • The Acres 3 & Estates construction site, inspection photo 2, 31 December 2025

2 October 2025

0.7%

  • The Acres 3 & Estates construction site, inspection photo 1, 2 October 2025
  • The Acres 3 & Estates construction site, inspection photo 2, 2 October 2025
  • The Acres 3 & Estates construction site, inspection photo 3, 2 October 2025
  • The Acres 3 & Estates construction site, inspection photo 4, 2 October 2025

7 July 2025

0.7%+0.5 pts

  • The Acres 3 & Estates construction site, inspection photo 1, 7 July 2025
  • The Acres 3 & Estates construction site, inspection photo 2, 7 July 2025
  • The Acres 3 & Estates construction site, inspection photo 3, 7 July 2025
  • The Acres 3 & Estates construction site, inspection photo 4, 7 July 2025

7 April 2025

0.3%+0.3 pts

  • The Acres 3 & Estates construction site, inspection photo 1, 7 April 2025
  • The Acres 3 & Estates construction site, inspection photo 2, 7 April 2025
  • The Acres 3 & Estates construction site, inspection photo 3, 7 April 2025
  • The Acres 3 & Estates construction site, inspection photo 4, 7 April 2025

3 June 2024

0%

  • The Acres 3 & Estates construction site, inspection photo 1, 3 June 2024
  • The Acres 3 & Estates construction site, inspection photo 2, 3 June 2024

All 42 site photos, by inspection date

Context

Wadi Al Safa 7 has 4 projects under construction, 24% built on average.

Dhre 2 Bts has 12 projects under construction in Dubai, none past their registered completion dates.

Own a unit in The Acres 3 & Estates?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the The Acres 3 & Estates handover date?
The registered completion date is November 2027. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around September 2032. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on The Acres 3 & Estates?
The Acres 3 & Estates was 15% built at the site inspection on 30 September 2026. The site has been inspected 8 times since June 2024. The Land Department took 42 site photos at its inspections.
Is The Acres 3 & Estates delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of November 2027.
Who is building The Acres 3 & Estates?
The registered developer is Dhre 2 Bts. It has 11 other projects under construction in Dubai.
Which bank holds the escrow account for The Acres 3 & Estates?
Abu Dhabi Commercial Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
