The Oasis - Address Villas - Tierra construction progress

The registered completion date for The Oasis - Address Villas - Tierra in Me'aisem Second is June 2029. At the last site inspection, in July 2026, it was 6.8% built. The developer is Emaar Development.

6.8%

Built, at the site inspection of 21 July 2026

Running behind its date

Registered completion date
June 2029
Finish at recent pace
July 2038
Construction started
May 2025
First registered
March 2025
Units
487
Escrow bank
Emirates Islamic Bank
Name in Arabic
ذا اويسيس - ادرس فيلا - تييرا
Project number
3580
Site inspections
4

Schedule

Between October 2025 and July 2026 the site added about 0.6 points a month. At that rate it would finish around July 2038, more than three months after its registered date of June 2029.

0%25%50%75%100%2026202720282029
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

21 July 2026

6.8%+2.9 pts

  • The Oasis - Address Villas - Tierra construction site, inspection photo 1, 21 July 2026
  • The Oasis - Address Villas - Tierra construction site, inspection photo 2, 21 July 2026
  • The Oasis - Address Villas - Tierra construction site, inspection photo 3, 21 July 2026
  • The Oasis - Address Villas - Tierra construction site, inspection photo 4, 21 July 2026

16 March 2026

3.9%+2.9 pts

  • The Oasis - Address Villas - Tierra construction site, inspection photo 1, 16 March 2026
  • The Oasis - Address Villas - Tierra construction site, inspection photo 2, 16 March 2026
  • The Oasis - Address Villas - Tierra construction site, inspection photo 3, 16 March 2026

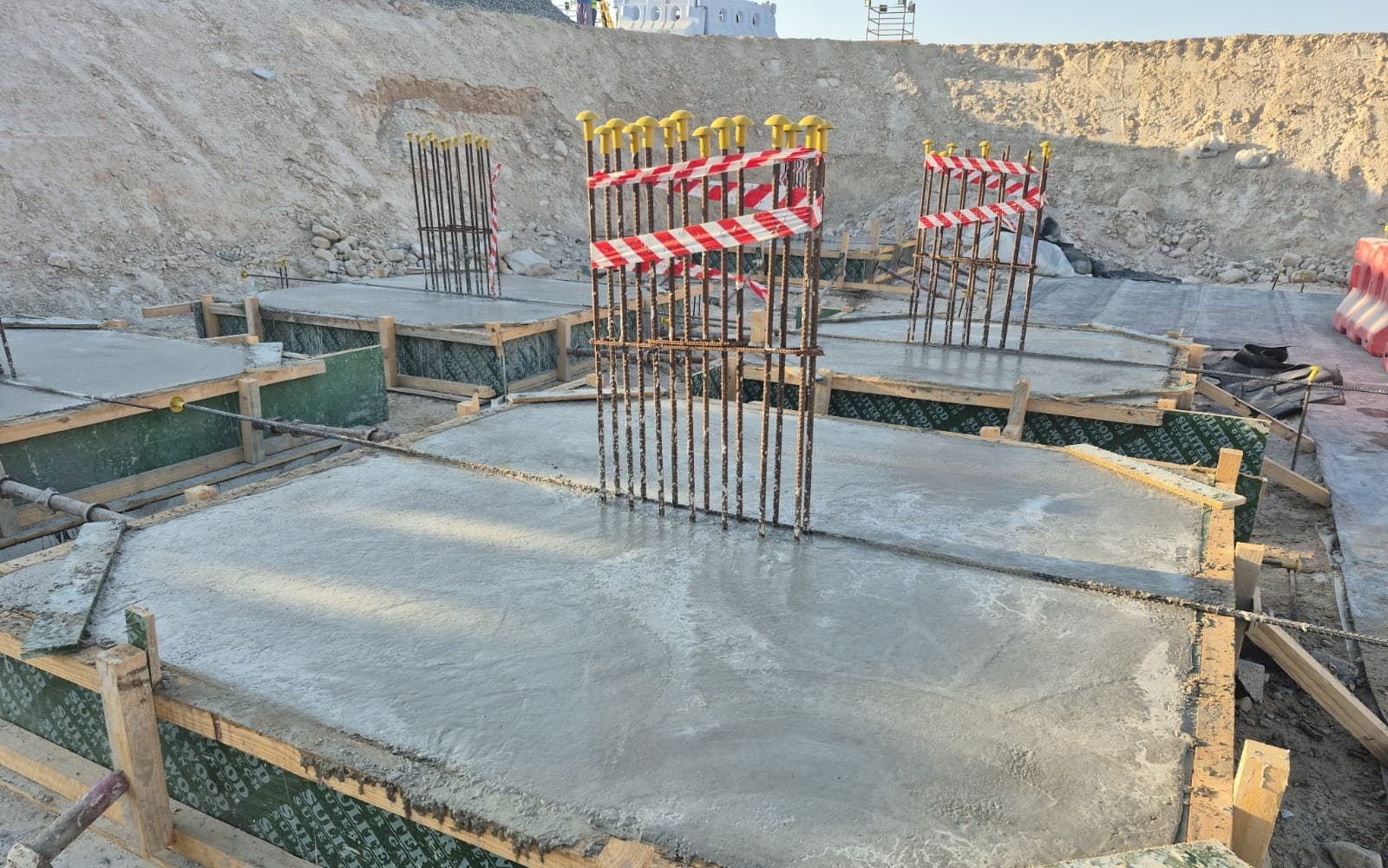

  • The Oasis - Address Villas - Tierra construction site, inspection photo 4, 16 March 2026

22 October 2025

1.0%+1.0 pts

  • The Oasis - Address Villas - Tierra construction site, inspection photo 1, 22 October 2025
  • The Oasis - Address Villas - Tierra construction site, inspection photo 2, 22 October 2025

25 February 2025

0%

  • The Oasis - Address Villas - Tierra construction site, inspection photo 1, 25 February 2025
  • The Oasis - Address Villas - Tierra construction site, inspection photo 2, 25 February 2025

All 18 site photos, by inspection date

Context

Me'aisem Second has 7 projects under construction, 45% built on average.

Emaar Development has 52 projects under construction in Dubai, none past their registered completion dates.

Own a unit in The Oasis - Address Villas - Tierra?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the The Oasis - Address Villas - Tierra handover date?
The registered completion date is June 2029. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around July 2038. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on The Oasis - Address Villas - Tierra?
The Oasis - Address Villas - Tierra was 6.8% built at the site inspection on 21 July 2026. The site has been inspected 4 times since February 2025. The Land Department took 18 site photos at its inspections.
Is The Oasis - Address Villas - Tierra delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of June 2029.
Who is building The Oasis - Address Villas - Tierra?
The registered developer is Emaar Development. It has 51 other projects under construction in Dubai.
Which bank holds the escrow account for The Oasis - Address Villas - Tierra?
Emirates Islamic Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
