The Oasis - Palmiera construction progress

No completion date is registered for The Oasis - Palmiera in Me'aisem Second yet. At the last site inspection, in July 2026, it was 82% built. The developer is Emaar Properties.

82%

Built, at the site inspection of 20 July 2026

Finish at recent pace
November 2026
Construction started
August 2023
First registered
July 2023
Units
265
Escrow bank
Emirates NBD
Name in Arabic
ذا اويسيس - بالمييرا
Project number
2732
Site inspections
8

Schedule

Since October 2025 The Oasis - Palmiera has added about 4.2 points a month. At that rate the site reaches 100% around November 2026. No completion date is on record to compare it with.

0%25%50%75%100%202420252026
Progress at each site inspection

Site inspections

20 July 2026

82%+9.2 pts

  • The Oasis - Palmiera construction site, inspection photo 1, 20 July 2026
  • The Oasis - Palmiera construction site, inspection photo 2, 20 July 2026
  • The Oasis - Palmiera construction site, inspection photo 3, 20 July 2026
  • The Oasis - Palmiera construction site, inspection photo 4, 20 July 2026

27 March 2026

73%+12 pts

  • The Oasis - Palmiera construction site, inspection photo 1, 27 March 2026

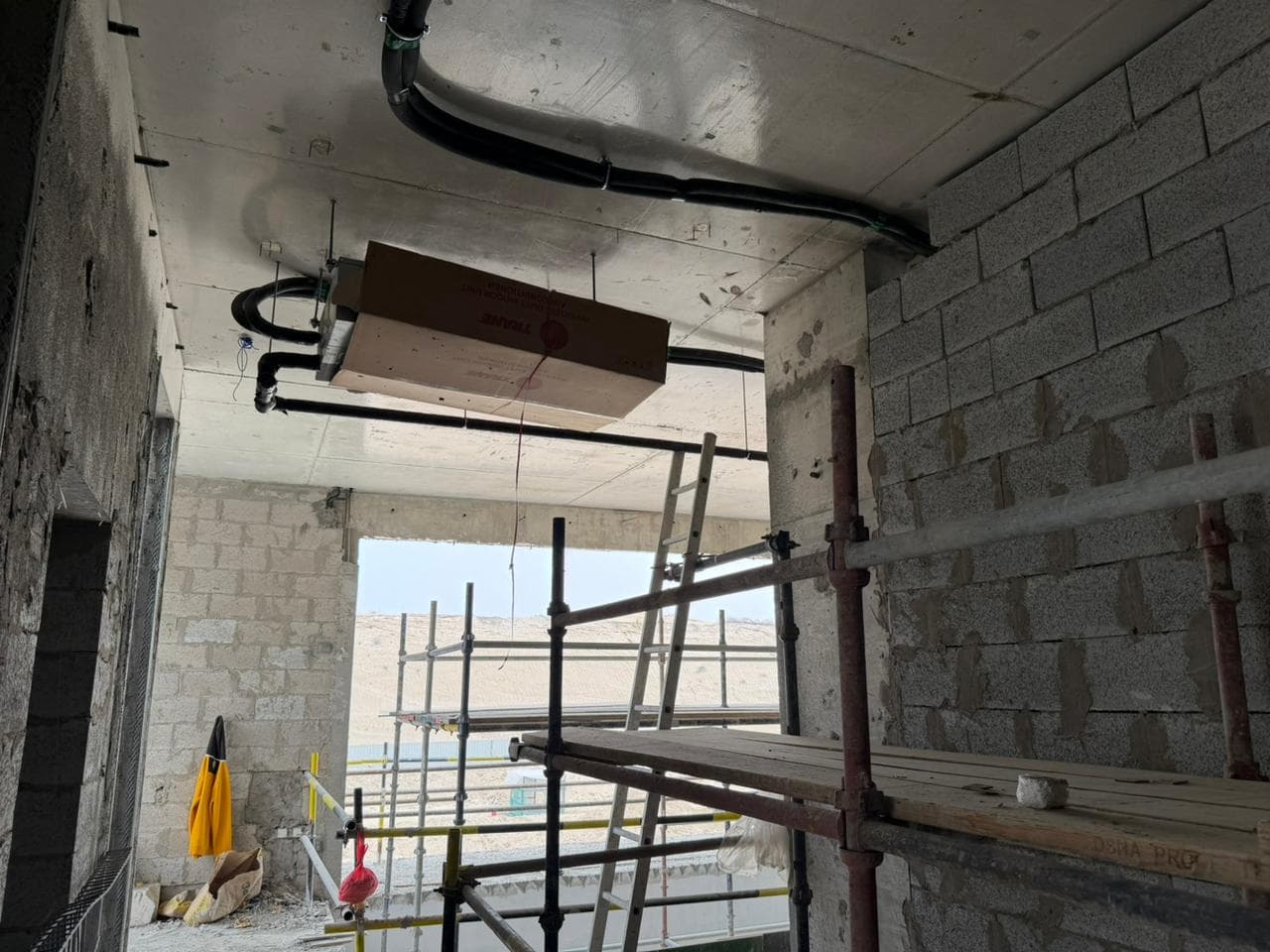

  • The Oasis - Palmiera construction site, inspection photo 2, 27 March 2026
  • The Oasis - Palmiera construction site, inspection photo 3, 27 March 2026
  • The Oasis - Palmiera construction site, inspection photo 4, 27 March 2026

25 November 2025

61%+19 pts

  • The Oasis - Palmiera construction site, inspection photo 1, 25 November 2025
  • The Oasis - Palmiera construction site, inspection photo 2, 25 November 2025
  • The Oasis - Palmiera construction site, inspection photo 3, 25 November 2025
  • The Oasis - Palmiera construction site, inspection photo 4, 25 November 2025

1 October 2025

42%+8.2 pts

  • The Oasis - Palmiera construction site, inspection photo 1, 1 October 2025
  • The Oasis - Palmiera construction site, inspection photo 2, 1 October 2025
  • The Oasis - Palmiera construction site, inspection photo 3, 1 October 2025
  • The Oasis - Palmiera construction site, inspection photo 4, 1 October 2025

3 June 2025

34%+11 pts

  • The Oasis - Palmiera construction site, inspection photo 1, 3 June 2025
  • The Oasis - Palmiera construction site, inspection photo 2, 3 June 2025
  • The Oasis - Palmiera construction site, inspection photo 3, 3 June 2025
  • The Oasis - Palmiera construction site, inspection photo 4, 3 June 2025

24 February 2025

22%+16 pts

  • The Oasis - Palmiera construction site, inspection photo 1, 24 February 2025
  • The Oasis - Palmiera construction site, inspection photo 2, 24 February 2025
  • The Oasis - Palmiera construction site, inspection photo 3, 24 February 2025
  • The Oasis - Palmiera construction site, inspection photo 4, 24 February 2025

15 October 2024

6.5%+6.5 pts

  • The Oasis - Palmiera construction site, inspection photo 1, 15 October 2024
  • The Oasis - Palmiera construction site, inspection photo 2, 15 October 2024
  • The Oasis - Palmiera construction site, inspection photo 3, 15 October 2024
  • The Oasis - Palmiera construction site, inspection photo 4, 15 October 2024

25 July 2023

0%

  • The Oasis - Palmiera construction site, inspection photo 1, 25 July 2023
  • The Oasis - Palmiera construction site, inspection photo 2, 25 July 2023
  • The Oasis - Palmiera construction site, inspection photo 3, 25 July 2023

All 69 site photos, by inspection date

Context

Me'aisem Second has 7 projects under construction, 45% built on average.

Emaar Properties has 7 projects under construction in Dubai, none past their registered completion dates.

Own a unit in The Oasis - Palmiera?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the The Oasis - Palmiera handover date?
No completion date is on record for The Oasis - Palmiera yet. Handover follows completion, so there is no date to give.
What is the latest construction update on The Oasis - Palmiera?
The Oasis - Palmiera was 82% built at the site inspection on 20 July 2026. The site has been inspected 8 times since July 2023. The Land Department took 69 site photos at its inspections.
Who is building The Oasis - Palmiera?
The registered developer is Emaar Properties. It has 6 other projects under construction in Dubai.
Which bank holds the escrow account for The Oasis - Palmiera?
Emirates NBD. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
