Azizi Venice 7 construction progress

Azizi Venice 7 in Dubai World Central was registered to complete in January 2026 and is still under construction. At the last site inspection, in June 2026, it was 29% built. The developer is Azizi Developments.

29%

Built, at the site inspection of 22 June 2026

10 months past its registered completion date

Registered completion date
January 2026
Finish at recent pace
February 2030
Construction started
January 2024
First registered
February 2024
Units
2,277
Escrow bank
Abu Dhabi Commercial Bank
Name in Arabic
عزيزى فينس 7
Project number
2956
Site inspections
3

Schedule

Azizi Venice 7 was registered to complete in January 2026, 10 months ago, and is still under construction. Over the last year of inspections it has added about 1.6 points a month. Kept at that rate, the site would reach 100% around February 2030.

0%25%50%75%100%20252026
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

22 June 2026

29%+8.1 pts

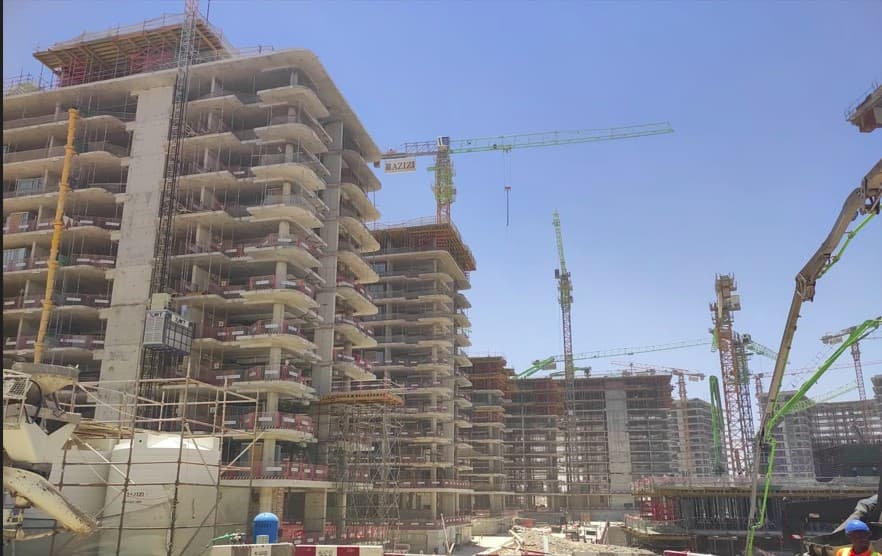

  • Azizi Venice 7 construction site, inspection photo 1, 22 June 2026
  • Azizi Venice 7 construction site, inspection photo 2, 22 June 2026
  • Azizi Venice 7 construction site, inspection photo 3, 22 June 2026

21 January 2026

21%+21 pts

  • Azizi Venice 7 construction site, inspection photo 1, 21 January 2026
  • Azizi Venice 7 construction site, inspection photo 2, 21 January 2026
  • Azizi Venice 7 construction site, inspection photo 3, 21 January 2026
  • Azizi Venice 7 construction site, inspection photo 4, 21 January 2026

6 February 2024

0%

  • Azizi Venice 7 construction site, inspection photo 1, 6 February 2024

All 19 site photos, by inspection date

Context

Dubai World Central has 53 projects under construction, 31% built on average.

Azizi Developments has 56 projects under construction in Dubai; 10 have passed their registered completion date.

Own a unit in Azizi Venice 7?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Azizi Venice 7 handover date?
The registered completion date was January 2026, and the register still lists Azizi Venice 7 as under construction. At the pace of its recent inspections the site would reach 100% around February 2030. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Azizi Venice 7?
Azizi Venice 7 was 29% built at the site inspection on 22 June 2026. The site has been inspected 3 times since February 2024. The Land Department took 19 site photos at its inspections.
Is Azizi Venice 7 delayed?
Yes. Its registered completion date of January 2026 has passed and the project is still listed as under construction.
Who is building Azizi Venice 7?
The registered developer is Azizi Developments. It has 55 other projects under construction in Dubai.
Which bank holds the escrow account for Azizi Venice 7?
Abu Dhabi Commercial Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
