Skip to content

Azizi Venice 2 construction progress

Azizi Venice 2 in Dubai World Central is 57% built at the Land Department inspection of June 2026. Developer Azizi Developments. Completion registered for December 2025.

57%

Built, at the Land Department site inspection of 22 June 2026

9 months past its registered completion date

Completion date (Land Department)
December 2025
Finish at recent pace
March 2033
Construction started
October 2023
Registered with the Land Department
November 2023
Units
526
Escrow bank
Emirates NBD
Name in Arabic
عزيزى فينيس 2
Land Department project number
2820
Land Department site inspections
5

Schedule

Azizi Venice 2 was registered to complete in December 2025, 9 months ago, and is still under construction. Over the last year of inspections it has added about 0.5 points a month. Kept at that rate, the site would reach 100% around March 2033.

0%25%50%75%100%202420252026
Progress at each Land Department site inspectionStraight line from start to the Land Department completion date

Site inspections

22 June 2026

57%+2.6 pts

  • Azizi Venice 2 construction site, Land Department inspection photo 1, 22 June 2026
  • Azizi Venice 2 construction site, Land Department inspection photo 2, 22 June 2026
  • Azizi Venice 2 construction site, Land Department inspection photo 3, 22 June 2026
  • Azizi Venice 2 construction site, Land Department inspection photo 4, 22 June 2026

21 January 2026

55%+12 pts

  • Azizi Venice 2 construction site, Land Department inspection photo 1, 21 January 2026
  • Azizi Venice 2 construction site, Land Department inspection photo 2, 21 January 2026
  • Azizi Venice 2 construction site, Land Department inspection photo 3, 21 January 2026
  • Azizi Venice 2 construction site, Land Department inspection photo 4, 21 January 2026

10 April 2025

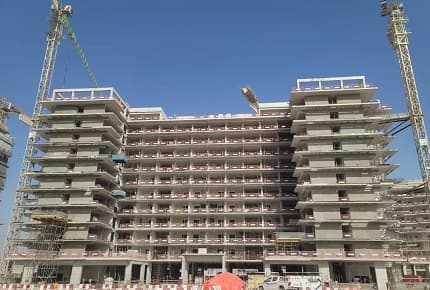

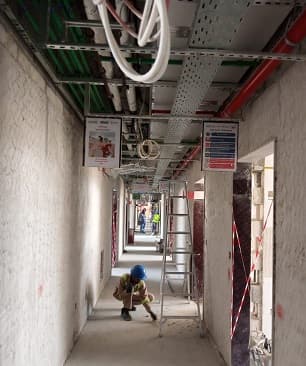

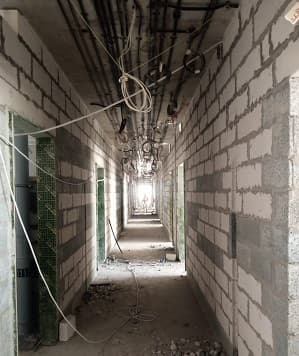

42%+21 pts

  • Azizi Venice 2 construction site, Land Department inspection photo 1, 10 April 2025
  • Azizi Venice 2 construction site, Land Department inspection photo 2, 10 April 2025
  • Azizi Venice 2 construction site, Land Department inspection photo 3, 10 April 2025
  • Azizi Venice 2 construction site, Land Department inspection photo 4, 10 April 2025

10 September 2024

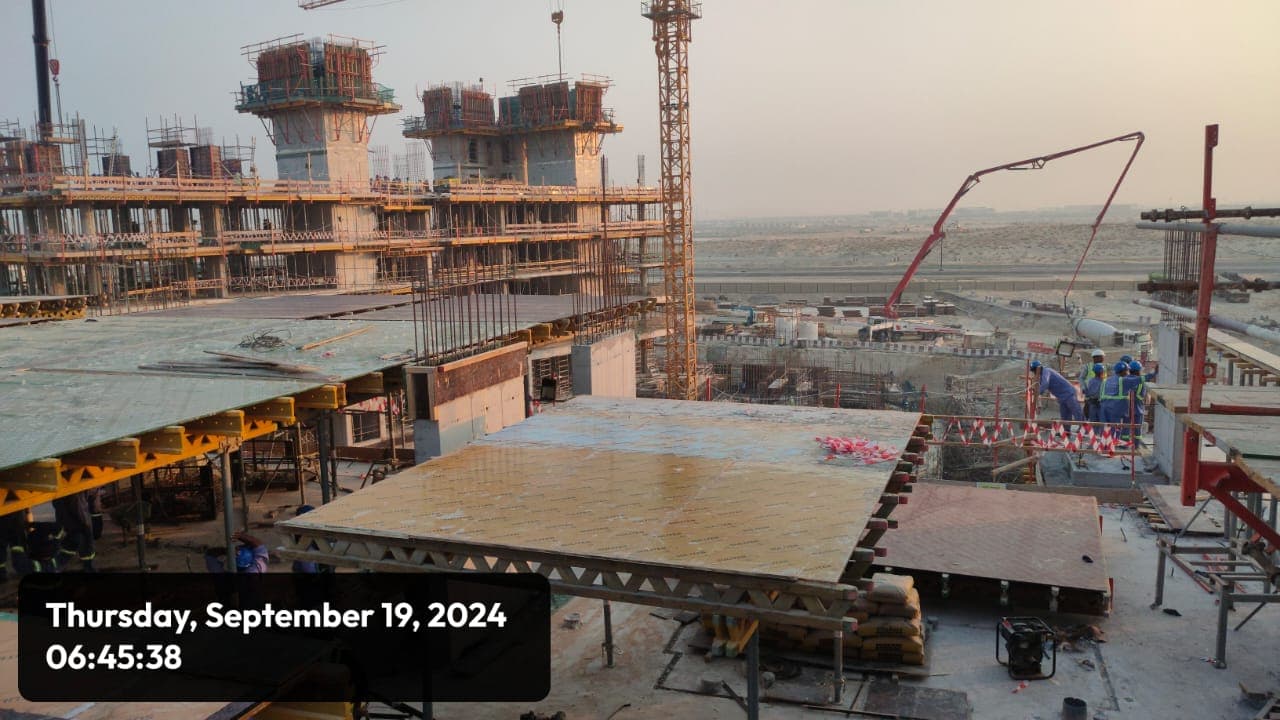

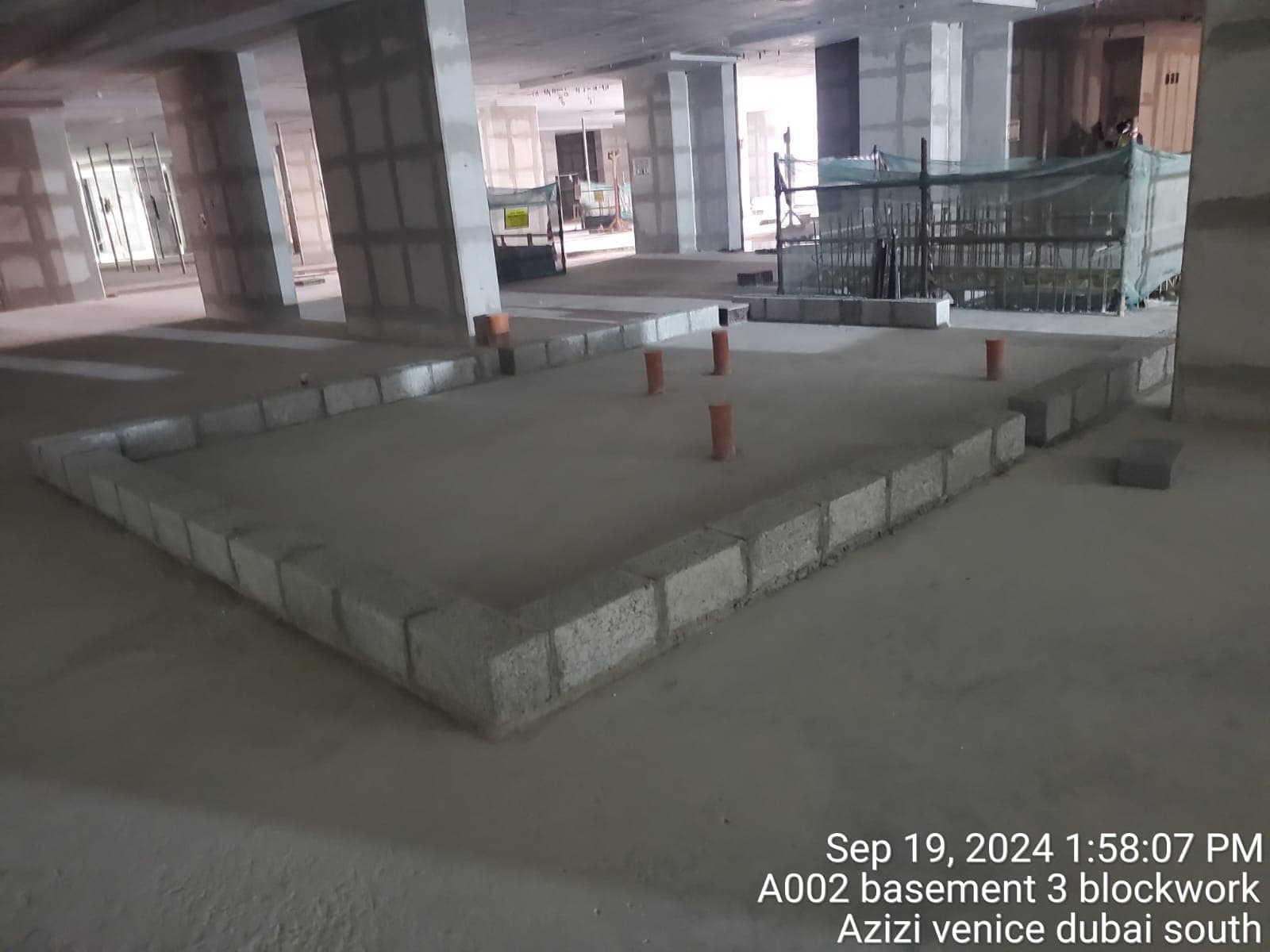

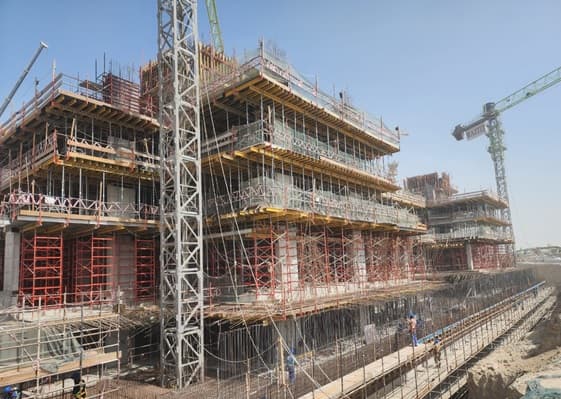

21%+21 pts

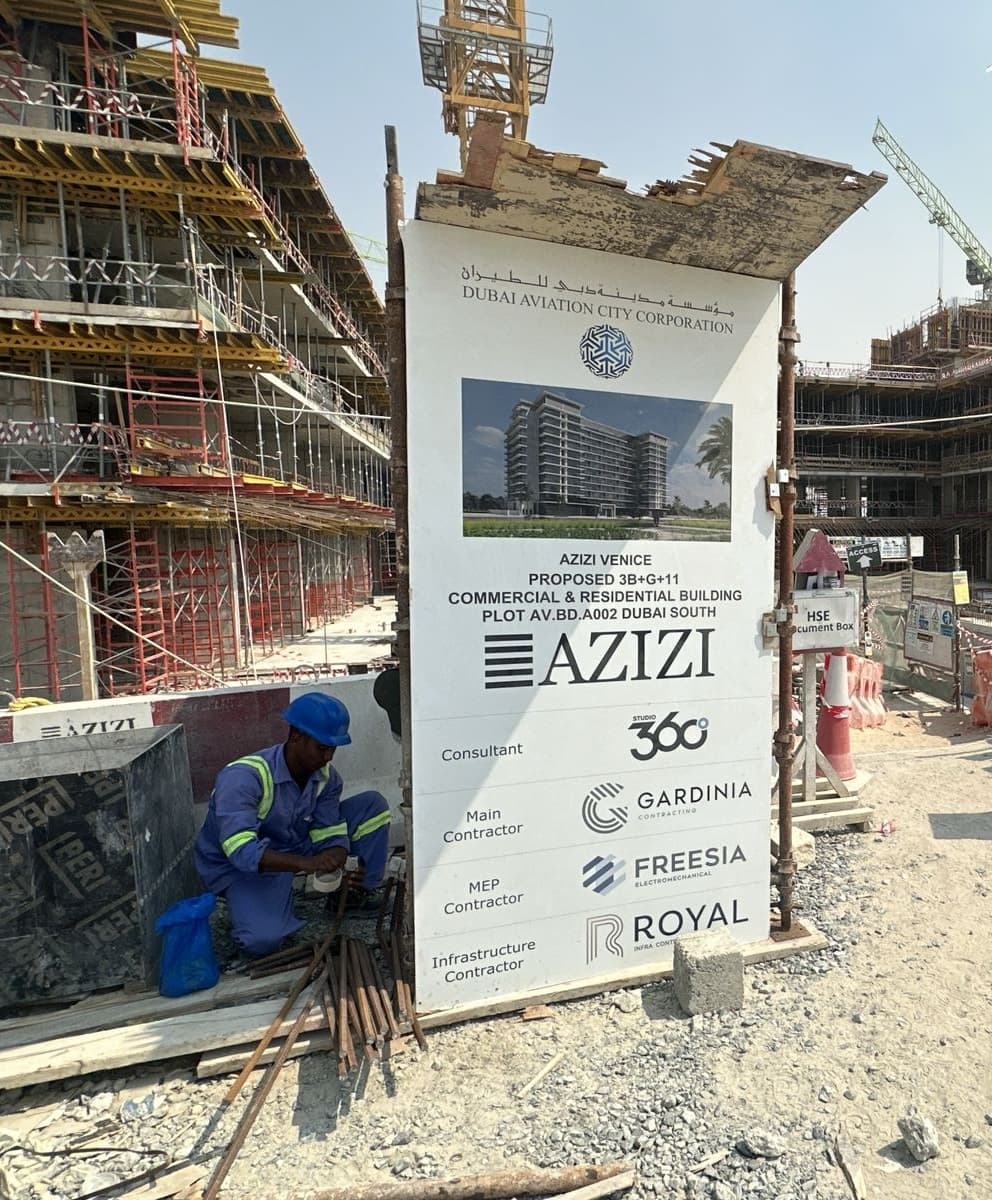

  • Azizi Venice 2 construction site, Land Department inspection photo 1, 10 September 2024
  • Azizi Venice 2 construction site, Land Department inspection photo 2, 10 September 2024
  • Azizi Venice 2 construction site, Land Department inspection photo 3, 10 September 2024
  • Azizi Venice 2 construction site, Land Department inspection photo 4, 10 September 2024

25 October 2023

0%

  • Azizi Venice 2 construction site, Land Department inspection photo 1, 25 October 2023
  • Azizi Venice 2 construction site, Land Department inspection photo 2, 25 October 2023
  • Azizi Venice 2 construction site, Land Department inspection photo 3, 25 October 2023

All 37 site photos, by inspection date

Context

Dubai World Central has 51 projects under construction, 29% built on average.

Azizi Developments has 57 projects under construction in Dubai; 9 have passed their registered completion date.

Own a unit in Azizi Venice 2?

Mulki follows this project for you: each new Land Department inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When will Azizi Venice 2 be completed?
The completion date registered with the Dubai Land Department is December 2025. At the pace of its recent inspections the site would reach 100% around March 2033. Developers can apply to the Land Department to extend the date, so check the register before relying on it.
How much of Azizi Venice 2 is built?
57%, measured at the Land Department site inspection on 22 June 2026. The Land Department engineers have inspected the site 5 times since October 2023.
Is Azizi Venice 2 delayed?
Yes. Its registered completion date of December 2025 has passed and the Land Department still lists it as under construction.
Who is building Azizi Venice 2?
The registered developer is Azizi Developments. It has 56 other projects under construction in Dubai.
Which bank holds the escrow account for Azizi Venice 2?
Emirates NBD. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of Land Department inspections, not a forecast from the developer. Site photos belong to the Dubai Land Department. See how Mulki works with Land Department data.
