Fairway Residences By Prescott construction progress
No completion date is registered for Fairway Residences By Prescott in Dubai Sports City yet. At the last site inspection, in September 2026, it was 50% built. The developer is Prescott Real Estate Development.
50%
Built, at the site inspection of 30 September 2026
- Finish at recent pace
- February 2028
- Construction started
- June 2024
- First registered
- May 2024
- Developer
- Prescott Real Estate Development
- Community
- Dubai Sports City
- Units
- 156
- Escrow bank
- United Bank Limited
- Name in Arabic
- فيرواي ريزيدنسز من بريسكوت
- Project number
- 3086
- Site inspections
- 8
Schedule
Since October 2025 Fairway Residences By Prescott has added about 2.9 points a month. At that rate the site reaches 100% around February 2028. No completion date is on record to compare it with.
Site inspections

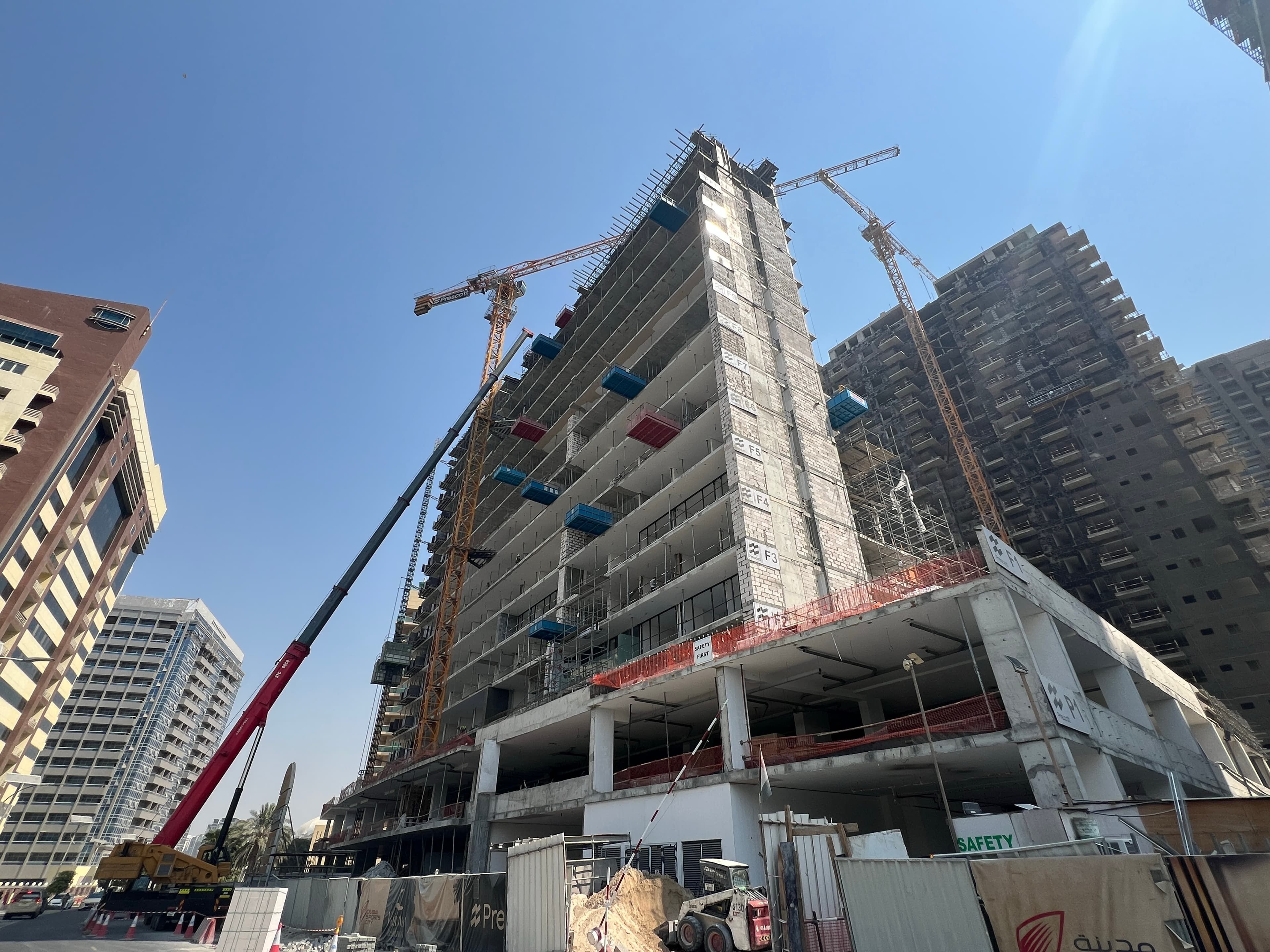

30 September 2026
50%+7.4 pts
23 June 2026
43%+9.9 pts
18 March 2026
33%+12 pts
18 December 2025
21%+4.9 pts

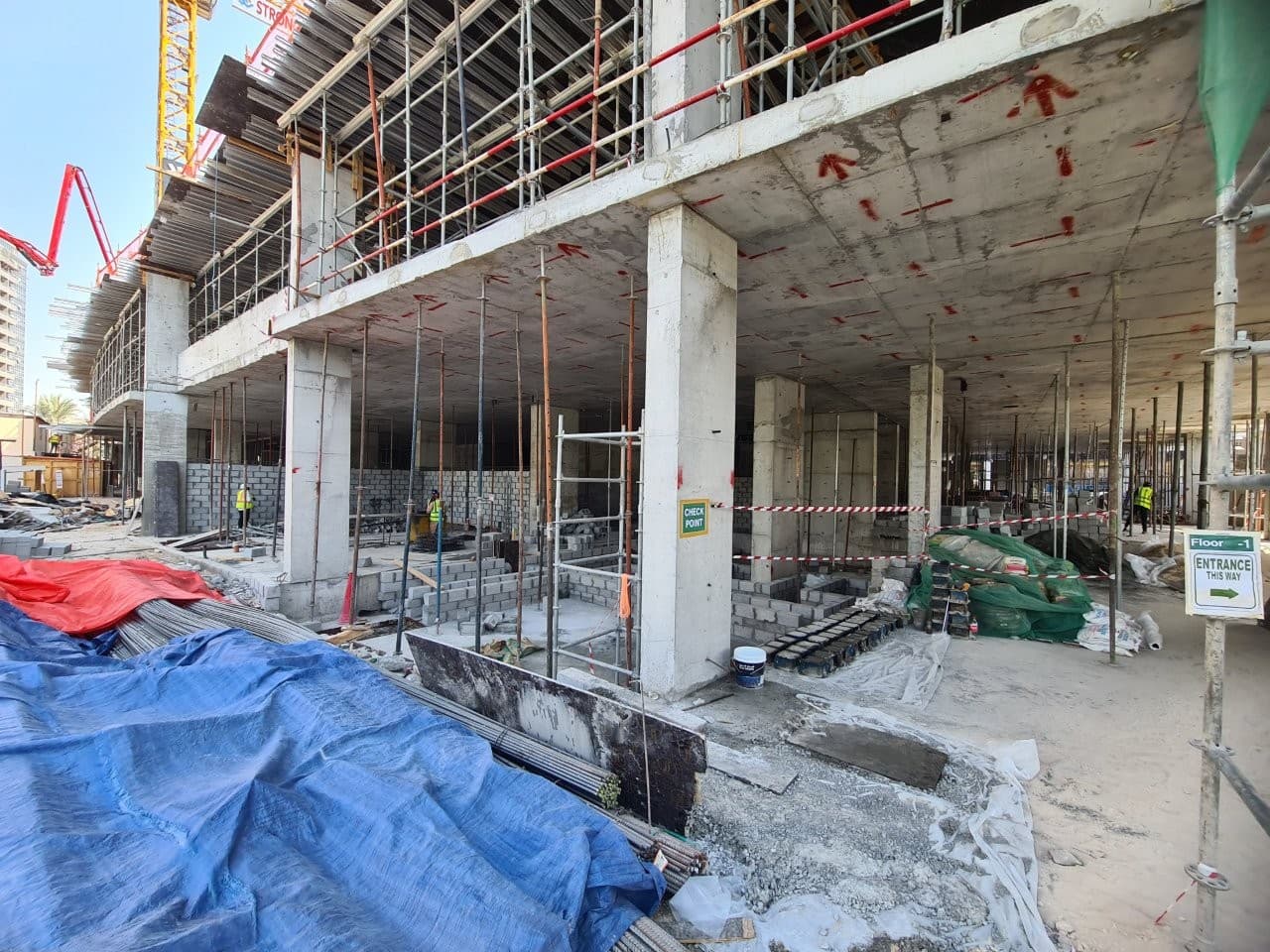

17 October 2025
16%+8.9 pts

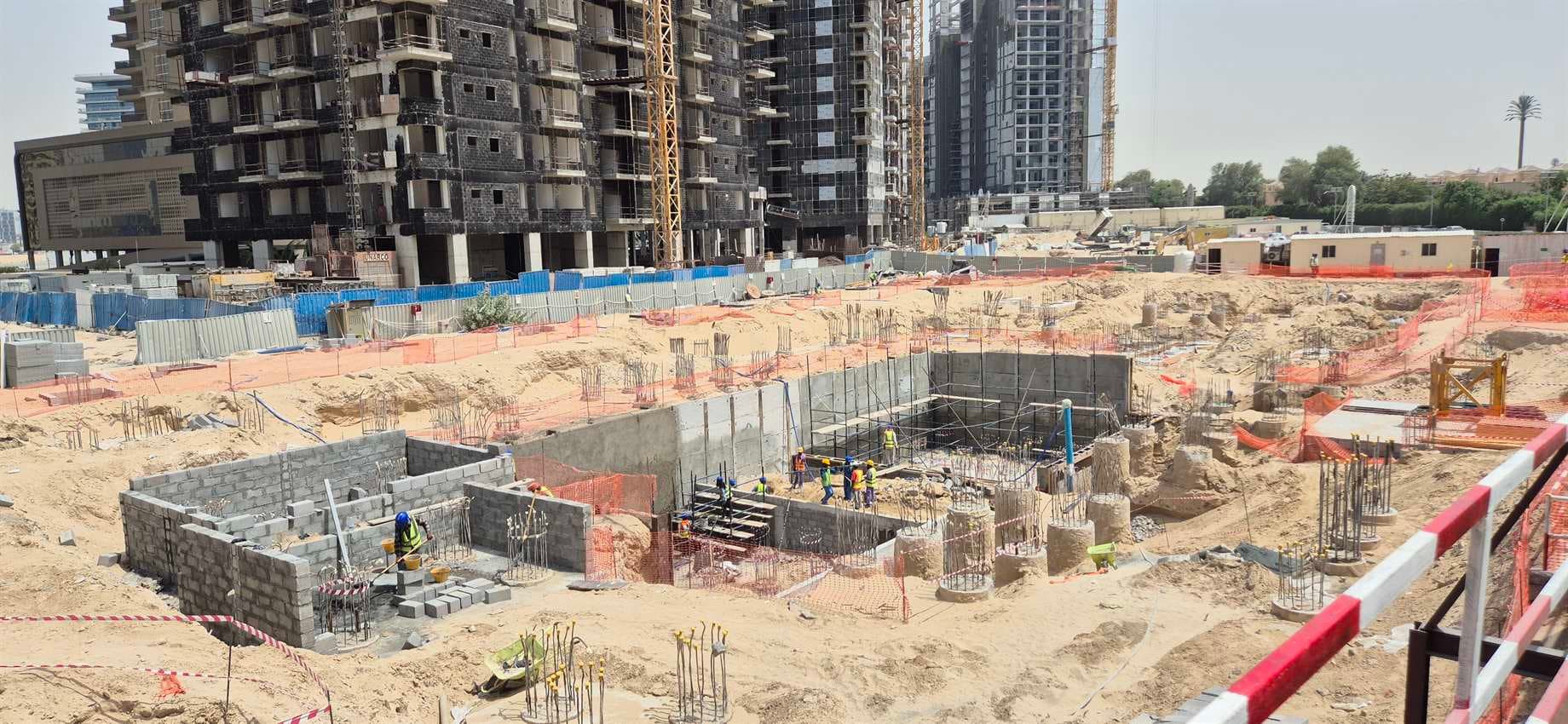

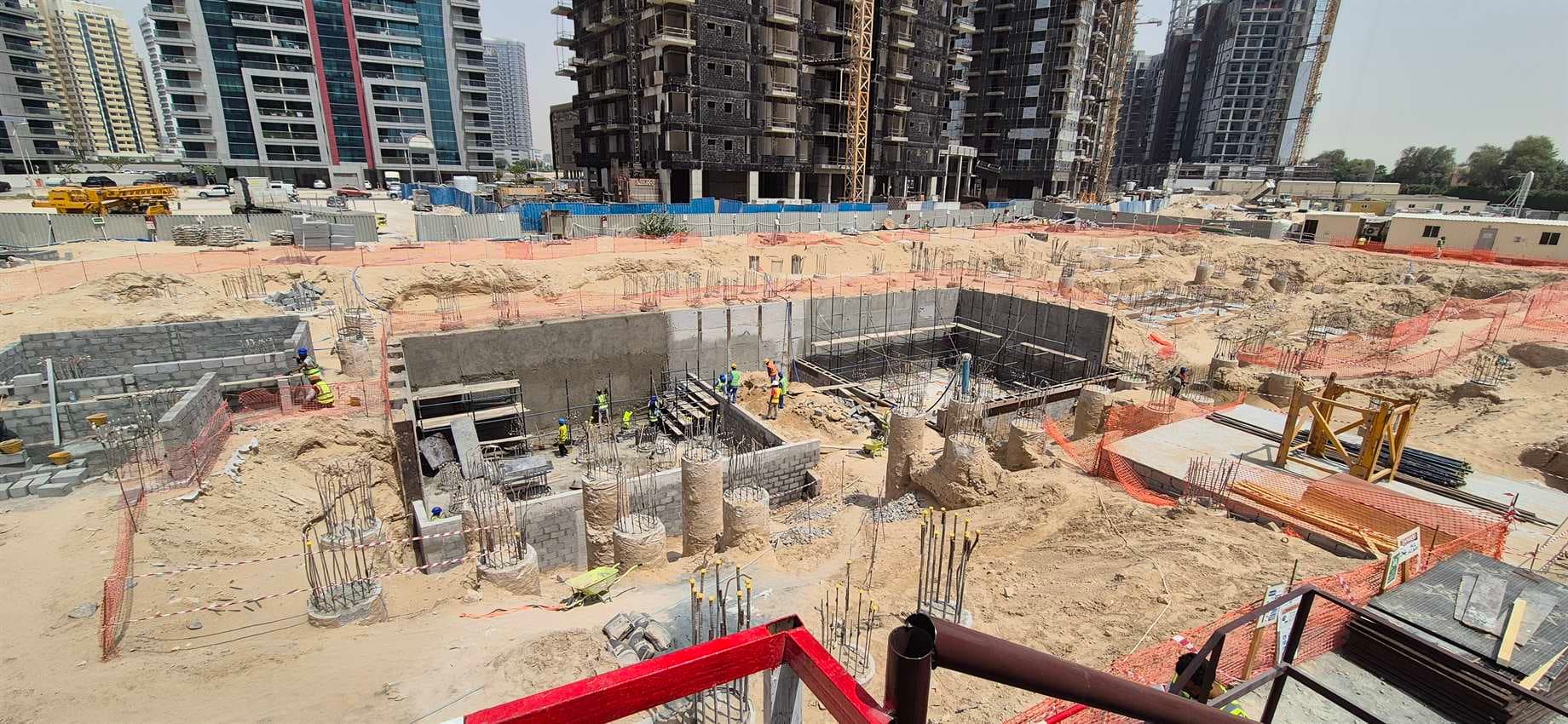

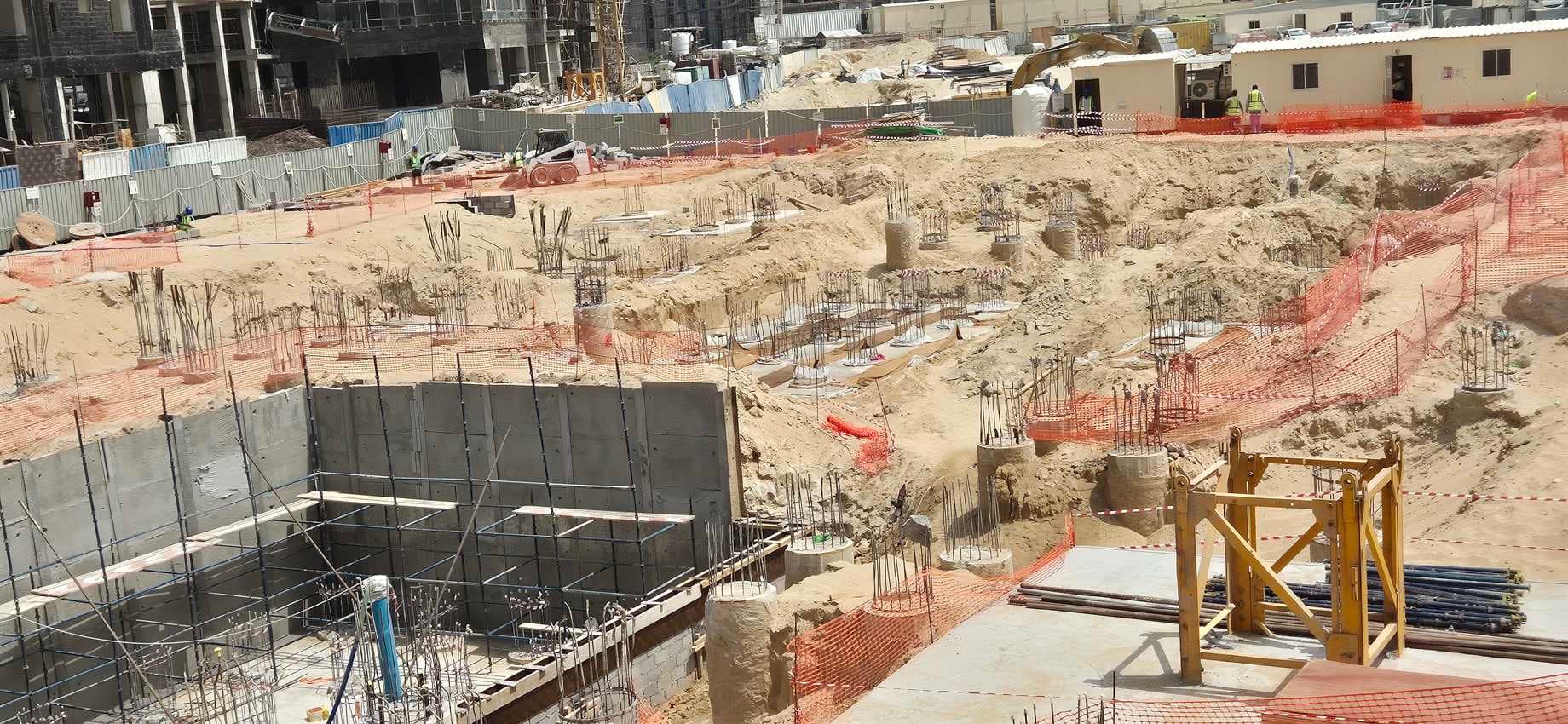

19 May 2025
7.4%+5.9 pts
28 January 2025
1.5%+1.5 pts
15 May 2024
0%
Context
Dubai Sports City has 21 projects under construction, 46% built on average.
Prescott Real Estate Development has 6 projects under construction in Dubai, none past their registered completion dates.
Own a unit in Fairway Residences By Prescott?
Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When is the Fairway Residences By Prescott handover date?
- No completion date is on record for Fairway Residences By Prescott yet. Handover follows completion, so there is no date to give.
- What is the latest construction update on Fairway Residences By Prescott?
- Fairway Residences By Prescott was 50% built at the site inspection on 30 September 2026. The site has been inspected 8 times since May 2024. The Land Department took 55 site photos at its inspections.
- Who is building Fairway Residences By Prescott?
- The registered developer is Prescott Real Estate Development. It has 5 other projects under construction in Dubai.
- Which bank holds the escrow account for Fairway Residences By Prescott?
- United Bank Limited. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- Serene Gardens By PrescottAlso by Prescott Real Estate Development. 62%.
- Serene Gardens 2 By PrescottAlso by Prescott Real Estate Development. 70%.
- Legado By PrescottAlso by Prescott Real Estate Development. 23%, Due August 2027.
- Verano By PrescottAlso by Prescott Real Estate Development. 41%, Due December 2026.
- Eden GardenNearby in Dubai Sports City. 96%, Due August 2022, passed.
- Mars ResidencesNearby in Dubai Sports City. 80%, Due March 2024, passed.
- Lime Light Twin TowersNearby in Dubai Sports City. 71%, Due June 2026, passed.
- Azizi GrandNearby in Dubai Sports City. 82%, Due February 2025, passed.
- Checking an off-plan project's progressHow to read the completion percentage and what escrow allows when a payment runs ahead.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.






.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)
