Marina Cove construction progress

The registered completion date for Marina Cove in Dubai Marina is September 2029. At the last site inspection, in October 2026, it was 5.7% built. The developer is Emaar Development.

5.7%

Built, at the site inspection of 1 October 2026

Running behind its date

Registered completion date
September 2029
Finish at recent pace
October 2036
Construction started
October 2024
First registered
October 2024
Community
Dubai Marina
Units
227
Escrow bank
Emirates NBD
Name in Arabic
مارينا كوف
Project number
3328
Site inspections
3

Schedule

Between March 2026 and October 2026 the site added about 0.8 points a month. At that rate it would finish around October 2036, more than three months after its registered date of September 2029.

0%25%50%75%100%20252026202720282029
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

1 October 2026

5.7%+4.9 pts

  • Marina Cove construction site, inspection photo 1, 1 October 2026
  • Marina Cove construction site, inspection photo 2, 1 October 2026
  • Marina Cove construction site, inspection photo 3, 1 October 2026

25 March 2026

0.8%+0.8 pts

  • Marina Cove construction site, inspection photo 1, 25 March 2026
  • Marina Cove construction site, inspection photo 2, 25 March 2026

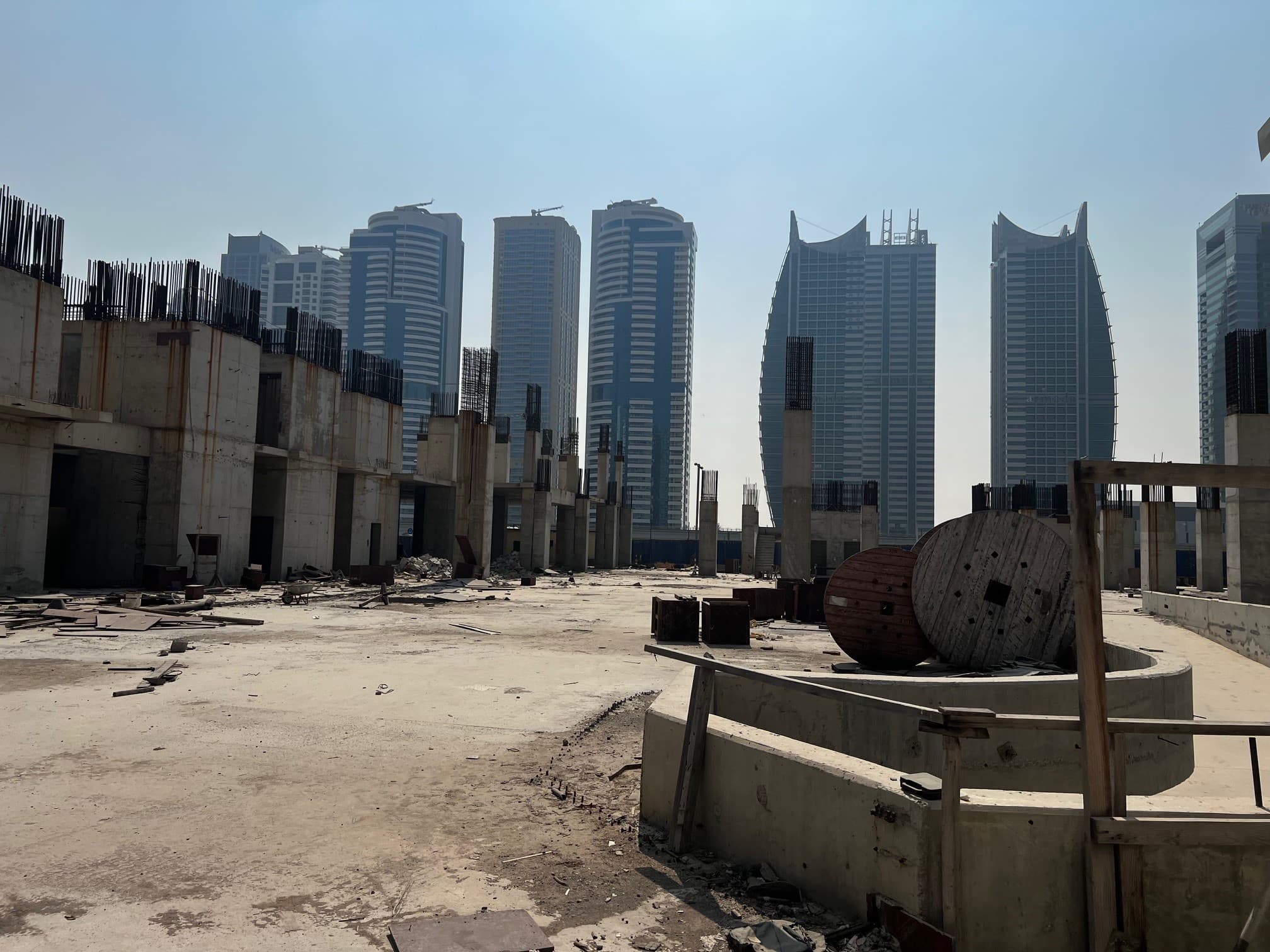

8 October 2024

0%

  • Marina Cove construction site, inspection photo 1, 8 October 2024
  • Marina Cove construction site, inspection photo 2, 8 October 2024

All 7 site photos, by inspection date

Context

Dubai Marina has 13 projects under construction, 46% built on average.

Emaar Development has 52 projects under construction in Dubai, none past their registered completion dates.

Own a unit in Marina Cove?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Marina Cove handover date?
The registered completion date is September 2029. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around October 2036. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Marina Cove?
Marina Cove was 5.7% built at the site inspection on 1 October 2026. The site has been inspected 3 times since October 2024. The Land Department took 7 site photos at its inspections.
Is Marina Cove delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of September 2029.
Who is building Marina Cove?
The registered developer is Emaar Development. It has 51 other projects under construction in Dubai.
Which bank holds the escrow account for Marina Cove?
Emirates NBD. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
