Verdania 1 construction progress
The registered completion date for Verdania 1 in Dubai Land Residence Complex is March 2027. At the last site inspection, in October 2026, it was 31% built. The developer is Obj1 Real Estate Development.
31%
Built, at the site inspection of 28 October 2026
Running behind its date
- Registered completion date
- March 2027
- Finish at recent pace
- April 2029
- Construction started
- March 2025
- First registered
- June 2025
- Developer
- Obj1 Real Estate Development
- Community
- Dubai Land Residence Complex
- Units
- 208
- Escrow bank
- Abu Dhabi Islamic Bank
- Name in Arabic
- فيردانيا 1
- Project number
- 3543
- Site inspections
- 5
Schedule
Between February 2026 and October 2026 the site added about 2.3 points a month. At that rate it would finish around April 2029, more than three months after its registered date of March 2027.
Site inspections
28 October 2026
31%+14 pts
18 June 2026
17%+4.4 pts
24 February 2026
12%+9.3 pts

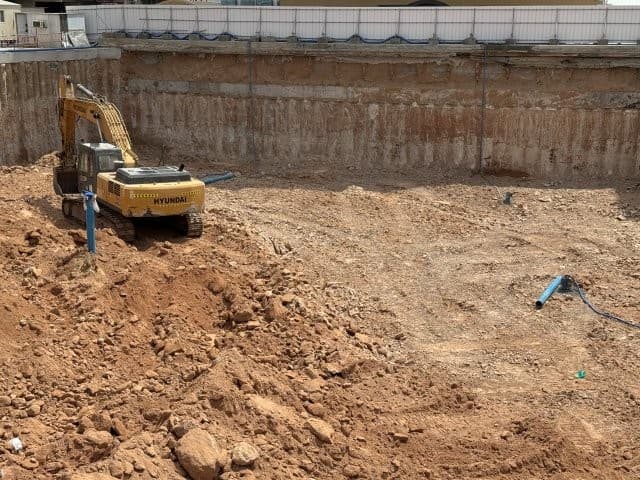

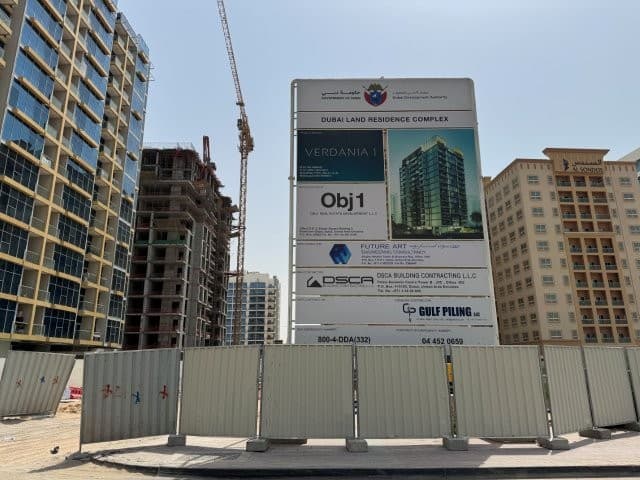

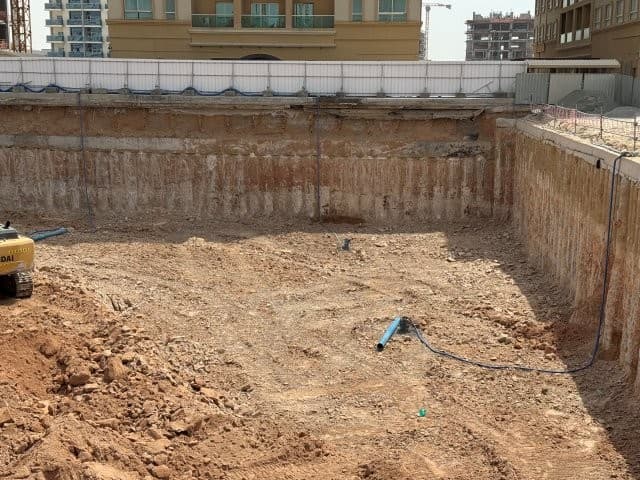

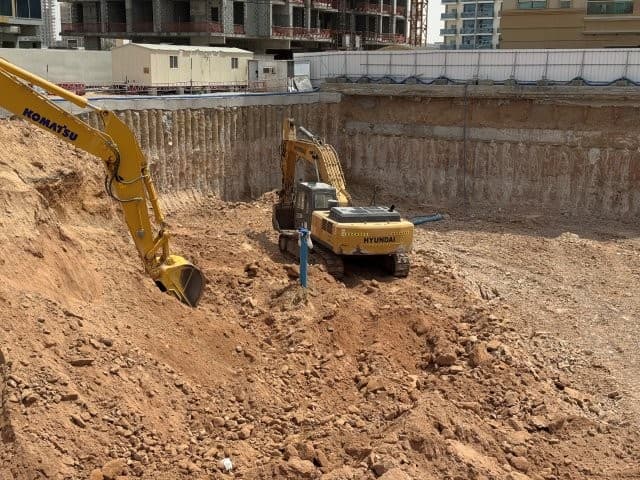

28 July 2025
3.0%+3.0 pts

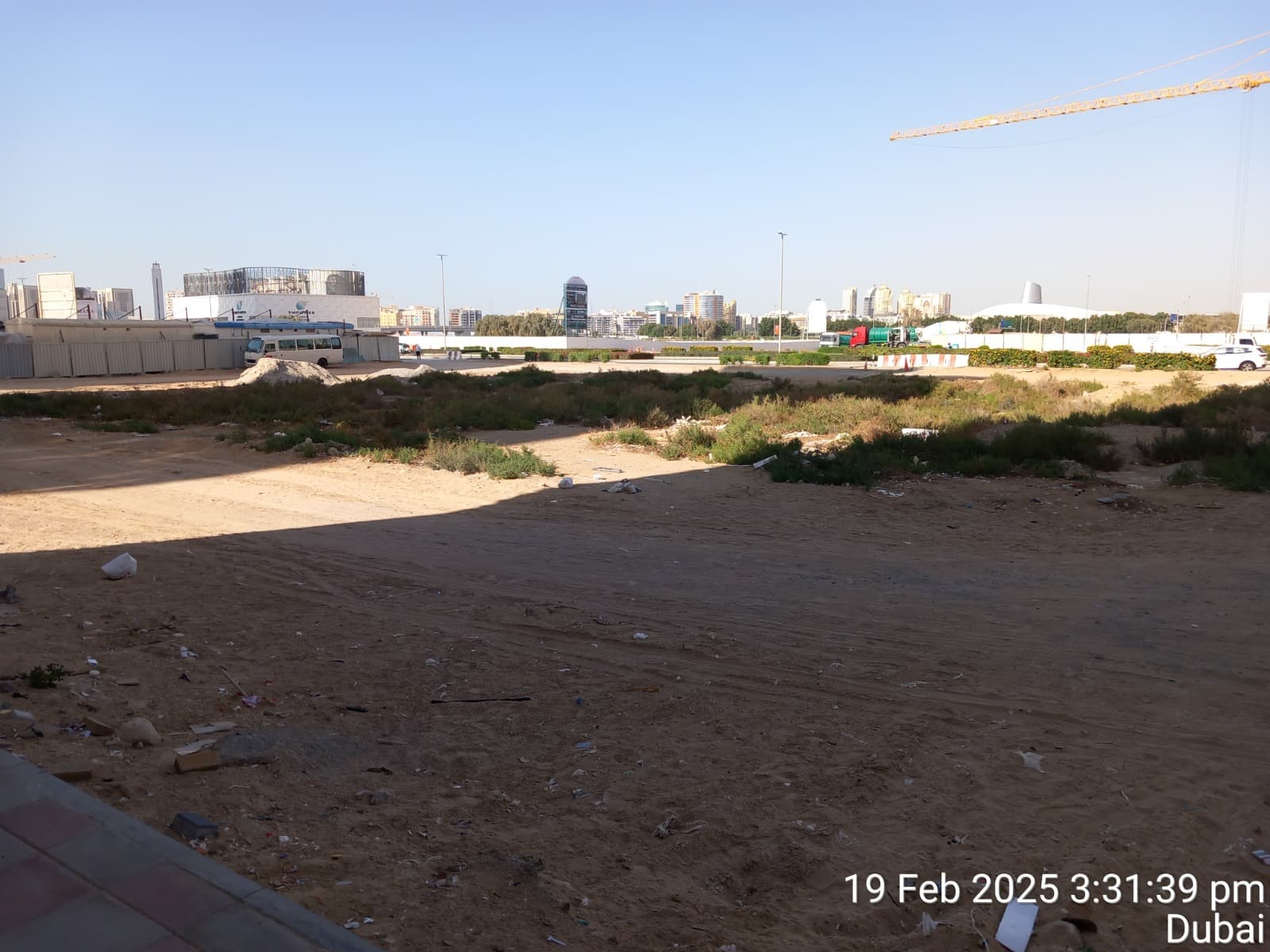

26 May 2025
0%
Context
Dubai Land Residence Complex has 63 projects under construction, 28% built on average.
Obj1 Real Estate Development has 14 projects under construction in Dubai; 3 have passed their registered completion date.
Own a unit in Verdania 1?
Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When is the Verdania 1 handover date?
- The registered completion date is March 2027. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around April 2029. RERA asks developers to update their dates as projects move, so check the register before relying on it.
- What is the latest construction update on Verdania 1?
- Verdania 1 was 31% built at the site inspection on 28 October 2026. The site has been inspected 5 times since May 2025. The Land Department took 23 site photos at its inspections.
- Is Verdania 1 delayed?
- It is running behind. At the rate of the last year it would finish more than three months after its registered date of March 2027.
- Who is building Verdania 1?
- The registered developer is Obj1 Real Estate Development. It has 13 other projects under construction in Dubai.
- Which bank holds the escrow account for Verdania 1?
- Abu Dhabi Islamic Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- Luminar Tower 1Also by Obj1 Real Estate Development. 40%, Due October 2026, passed.
- Evergrin HouseAlso by Obj1 Real Estate Development. 55%, Due June 2026, passed.
- Luminar Tower 2Also by Obj1 Real Estate Development. 40%, Due October 2026, passed.
- Vivid TowerAlso by Obj1 Real Estate Development. 12%, Due November 2026.
- Ag CentralNearby in Dubai Land Residence Complex. 59%, Due October 2026, passed.
- Ag SquareNearby in Dubai Land Residence Complex. 69%, Due September 2026, passed.
- Time 2Nearby in Dubai Land Residence Complex. 87%, Due June 2026, passed.
- Ag 7evenNearby in Dubai Land Residence Complex. 94%, Due March 2027.
- Checking an off-plan project's progressHow to read the completion percentage and what escrow allows when a payment runs ahead.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.




.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)

.jpeg&w=3840&q=75)
