Time 2 construction progress

Time 2 in Dubai Land Residence Complex was registered to complete in June 2026 and is still under construction. At the last site inspection, in April 2026, it was 87% built. The developer is Time Properties.

87%

Built, at the site inspection of 28 April 2026

6 months past its registered completion date

Registered completion date
June 2026
Finish at recent pace
August 2026
Construction started
January 2023
First registered
February 2023
Developer
Time Properties
Units
304
Escrow bank
Emirates Islamic Bank
Name in Arabic
تايم 2
Project number
2541
Site inspections
8

Schedule

Time 2 was registered to complete in June 2026, 6 months ago, and is still under construction. Over the last year of inspections it has added about 3.1 points a month. Kept at that rate, the site would reach 100% around August 2026.

0%25%50%75%100%2023202420252026
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

28 April 2026

87%+15 pts

  • Time 2 construction site, inspection photo 1, 28 April 2026
  • Time 2 construction site, inspection photo 2, 28 April 2026
  • Time 2 construction site, inspection photo 3, 28 April 2026
  • Time 2 construction site, inspection photo 4, 28 April 2026

8 December 2025

72%+13 pts

  • Time 2 construction site, inspection photo 1, 8 December 2025
  • Time 2 construction site, inspection photo 2, 8 December 2025
  • Time 2 construction site, inspection photo 3, 8 December 2025
  • Time 2 construction site, inspection photo 4, 8 December 2025

31 July 2025

59%+14 pts

  • Time 2 construction site, inspection photo 1, 31 July 2025
  • Time 2 construction site, inspection photo 2, 31 July 2025
  • Time 2 construction site, inspection photo 3, 31 July 2025
  • Time 2 construction site, inspection photo 4, 31 July 2025

25 February 2025

45%+14 pts

  • Time 2 construction site, inspection photo 1, 25 February 2025
  • Time 2 construction site, inspection photo 2, 25 February 2025
  • Time 2 construction site, inspection photo 3, 25 February 2025
  • Time 2 construction site, inspection photo 4, 25 February 2025

8 November 2024

31%+8.8 pts

  • Time 2 construction site, inspection photo 1, 8 November 2024
  • Time 2 construction site, inspection photo 2, 8 November 2024
  • Time 2 construction site, inspection photo 3, 8 November 2024
  • Time 2 construction site, inspection photo 4, 8 November 2024

4 June 2024

22%+4.2 pts

  • Time 2 construction site, inspection photo 1, 4 June 2024
  • Time 2 construction site, inspection photo 2, 4 June 2024
  • Time 2 construction site, inspection photo 3, 4 June 2024
  • Time 2 construction site, inspection photo 4, 4 June 2024

14 March 2024

18%+18 pts

  • Time 2 construction site, inspection photo 1, 14 March 2024
  • Time 2 construction site, inspection photo 2, 14 March 2024

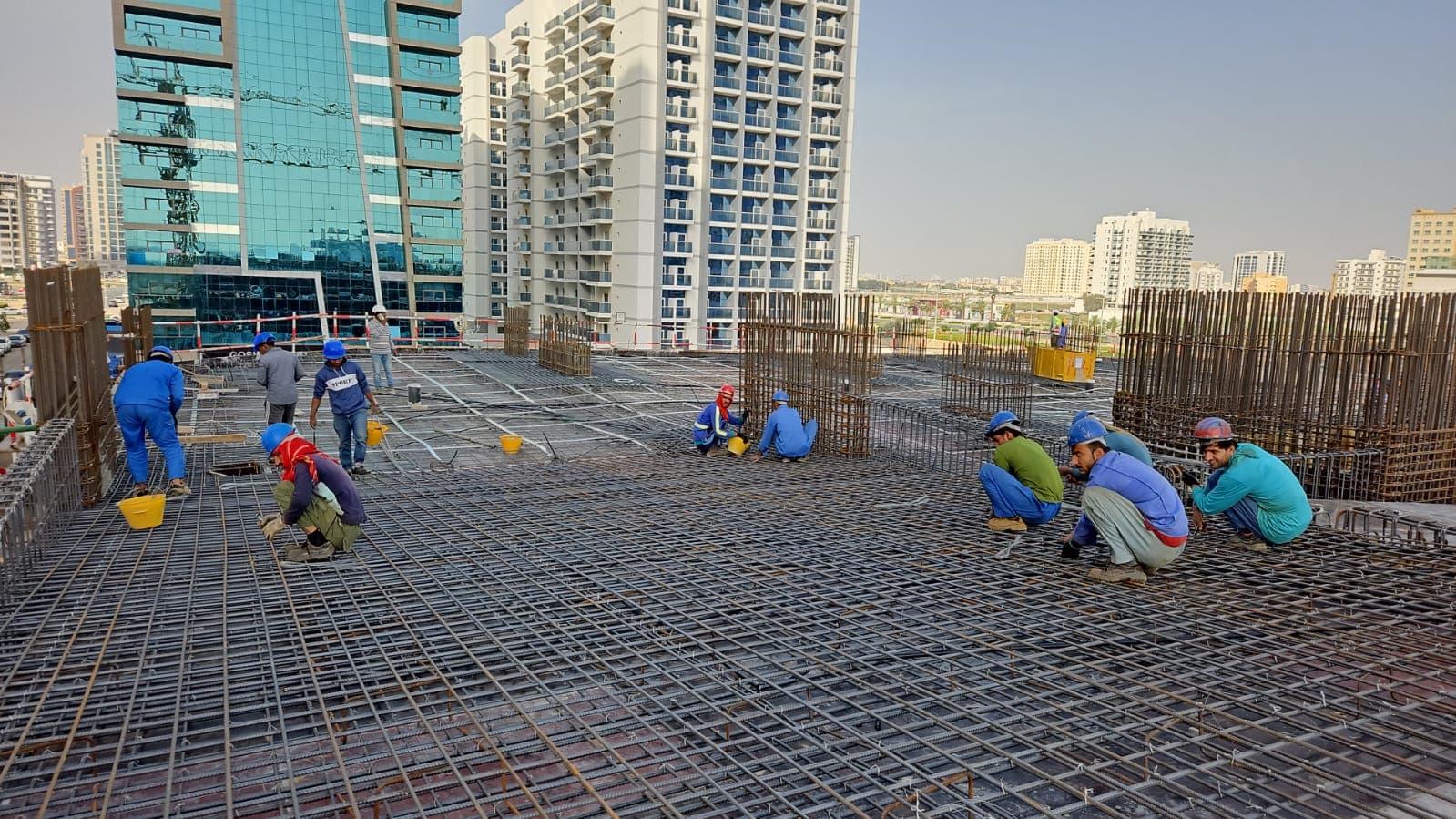

  • Time 2 construction site, inspection photo 3, 14 March 2024
  • Time 2 construction site, inspection photo 4, 14 March 2024

20 December 2022

0%

  • Time 2 construction site, inspection photo 1, 20 December 2022
  • Time 2 construction site, inspection photo 2, 20 December 2022
  • Time 2 construction site, inspection photo 3, 20 December 2022
  • Time 2 construction site, inspection photo 4, 20 December 2022

All 61 site photos, by inspection date

Context

Dubai Land Residence Complex has 63 projects under construction, 28% built on average.

Time Properties has 2 projects under construction in Dubai; 1 has passed its registered completion date.

Own a unit in Time 2?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Time 2 handover date?
The registered completion date was June 2026, and the register still lists Time 2 as under construction. At the pace of its recent inspections the site would reach 100% around August 2026. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Time 2?
Time 2 was 87% built at the site inspection on 28 April 2026. The site has been inspected 8 times since December 2022. The Land Department took 61 site photos at its inspections.
Is Time 2 delayed?
Yes. Its registered completion date of June 2026 has passed and the project is still listed as under construction.
Who is building Time 2?
The registered developer is Time Properties. It has 1 other project under construction in Dubai.
Which bank holds the escrow account for Time 2?
Emirates Islamic Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
