Samana Waves construction progress

Samana Waves in Jumeirah Village Circle was registered to complete in April 2026 and is still under construction. At the last site inspection, in October 2026, it was 91% built. The developer is Samana Si Holding Limited Dubai Branch.

91%

Built, at the site inspection of 16 October 2026

7 months past its registered completion date

Registered completion date
April 2026
Finish at recent pace
April 2027
Construction started
July 2022
First registered
February 2022
Units
197
Escrow bank
Mashreq Bank
Name in Arabic
سمانا ويفز
Project number
2345
Site inspections
10

Schedule

Samana Waves was registered to complete in April 2026, 7 months ago, and is still under construction. Over the last year of inspections it has added about 1.6 points a month. Kept at that rate, the site would reach 100% around April 2027.

0%25%50%75%100%2023202420252026
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

16 October 2026

91%+0.5 pts

  • Samana Waves construction site, inspection photo 1, 16 October 2026
  • Samana Waves construction site, inspection photo 2, 16 October 2026
  • Samana Waves construction site, inspection photo 3, 16 October 2026
  • Samana Waves construction site, inspection photo 4, 16 October 2026

19 June 2026

90%+13 pts

  • Samana Waves construction site, inspection photo 1, 19 June 2026
  • Samana Waves construction site, inspection photo 2, 19 June 2026
  • Samana Waves construction site, inspection photo 3, 19 June 2026
  • Samana Waves construction site, inspection photo 4, 19 June 2026

5 February 2026

77%+3.7 pts

  • Samana Waves construction site, inspection photo 1, 5 February 2026
  • Samana Waves construction site, inspection photo 2, 5 February 2026
  • Samana Waves construction site, inspection photo 3, 5 February 2026
  • Samana Waves construction site, inspection photo 4, 5 February 2026

20 November 2025

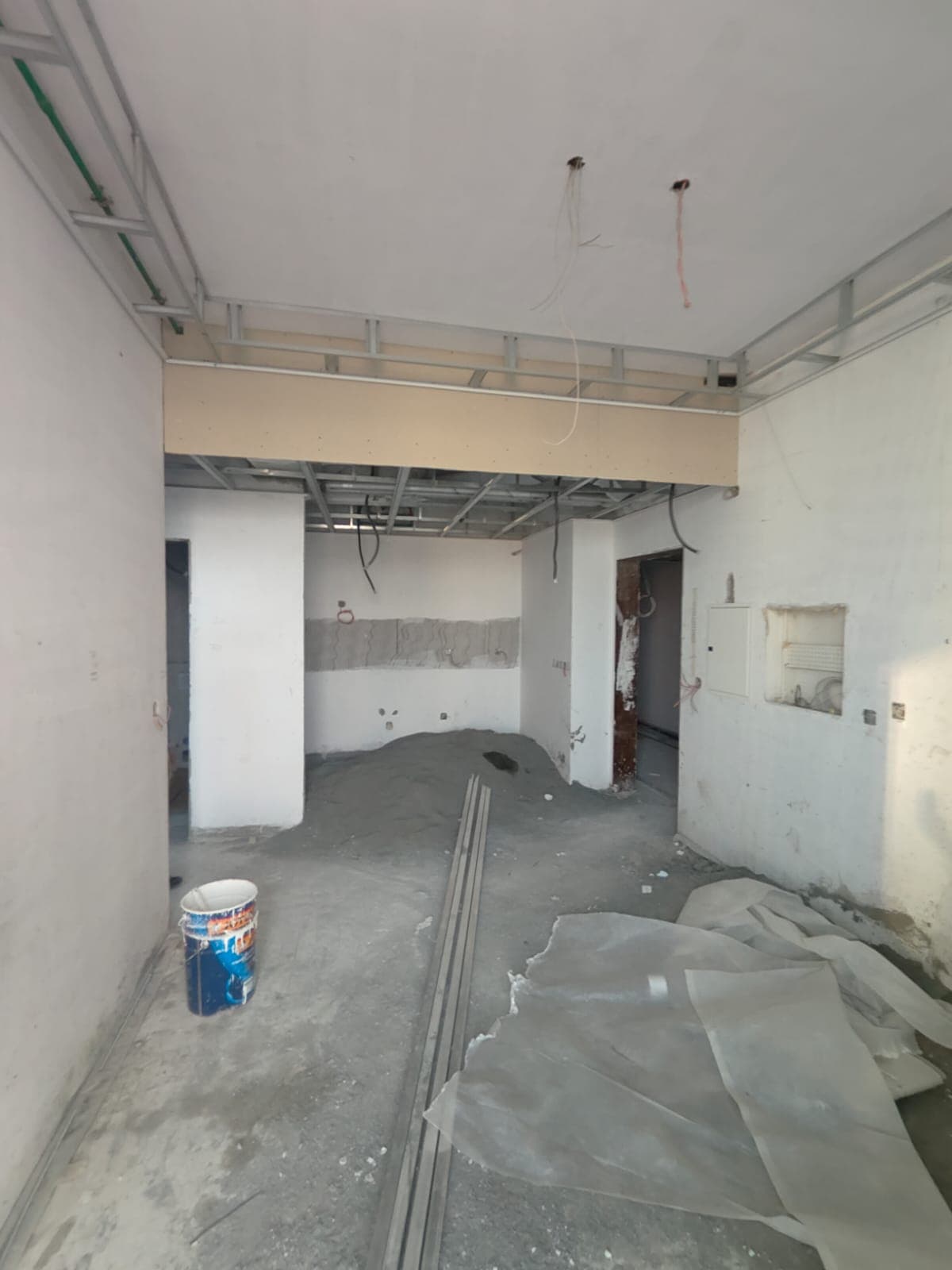

73%+19 pts

  • Samana Waves construction site, inspection photo 1, 20 November 2025
  • Samana Waves construction site, inspection photo 2, 20 November 2025
  • Samana Waves construction site, inspection photo 3, 20 November 2025
  • Samana Waves construction site, inspection photo 4, 20 November 2025

14 July 2025

54%+14 pts

  • Samana Waves construction site, inspection photo 1, 14 July 2025
  • Samana Waves construction site, inspection photo 2, 14 July 2025
  • Samana Waves construction site, inspection photo 3, 14 July 2025
  • Samana Waves construction site, inspection photo 4, 14 July 2025

31 January 2025

40%+13 pts

  • Samana Waves construction site, inspection photo 1, 31 January 2025
  • Samana Waves construction site, inspection photo 2, 31 January 2025
  • Samana Waves construction site, inspection photo 3, 31 January 2025
  • Samana Waves construction site, inspection photo 4, 31 January 2025

13 November 2024

27%+17 pts

  • Samana Waves construction site, inspection photo 1, 13 November 2024
  • Samana Waves construction site, inspection photo 2, 13 November 2024
  • Samana Waves construction site, inspection photo 3, 13 November 2024
  • Samana Waves construction site, inspection photo 4, 13 November 2024

14 May 2024

10%+6.6 pts

  • Samana Waves construction site, inspection photo 1, 14 May 2024
  • Samana Waves construction site, inspection photo 2, 14 May 2024
  • Samana Waves construction site, inspection photo 3, 14 May 2024
  • Samana Waves construction site, inspection photo 4, 14 May 2024

15 March 2023

3.6%+3.6 pts

  • Samana Waves construction site, inspection photo 1, 15 March 2023
  • Samana Waves construction site, inspection photo 2, 15 March 2023
  • Samana Waves construction site, inspection photo 3, 15 March 2023
  • Samana Waves construction site, inspection photo 4, 15 March 2023

5 December 2022

0%

  • Samana Waves construction site, inspection photo 1, 5 December 2022
  • Samana Waves construction site, inspection photo 2, 5 December 2022
  • Samana Waves construction site, inspection photo 3, 5 December 2022

All 75 site photos, by inspection date

Context

Jumeirah Village Circle has 118 projects under construction, 42% built on average.

Samana Si Holding Limited Dubai Branch has 4 projects under construction in Dubai; 3 have passed their registered completion date.

Own a unit in Samana Waves?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Samana Waves handover date?
The registered completion date was April 2026, and the register still lists Samana Waves as under construction. At the pace of its recent inspections the site would reach 100% around April 2027. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Samana Waves?
Samana Waves was 91% built at the site inspection on 16 October 2026. The site has been inspected 10 times since December 2022. The Land Department took 75 site photos at its inspections.
Is Samana Waves delayed?
Yes. Its registered completion date of April 2026 has passed and the project is still listed as under construction.
Who is building Samana Waves?
The registered developer is Samana Si Holding Limited Dubai Branch. It has 3 other projects under construction in Dubai.
Which bank holds the escrow account for Samana Waves?
Mashreq Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
