Hayat 3 construction progress

The registered completion date for Hayat 3 in Dubai World Central is May 2028. At the last site inspection, in September 2026, it was 3.9% built. The developer is Dubai South Properties Dwc.

3.9%

Built, at the site inspection of 24 September 2026

Running behind its date

Registered completion date
May 2028
Finish at recent pace
November 2038
Construction started
January 2026
First registered
June 2025
Units
144
Escrow bank
Emirates NBD
Name in Arabic
حياة 3
Project number
3810
Site inspections
3

Schedule

Between March 2026 and September 2026 the site added about 0.7 points a month. At that rate it would finish around November 2038, more than three months after its registered date of May 2028.

0%25%50%75%100%202620272028
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

24 September 2026

3.9%+3.9 pts

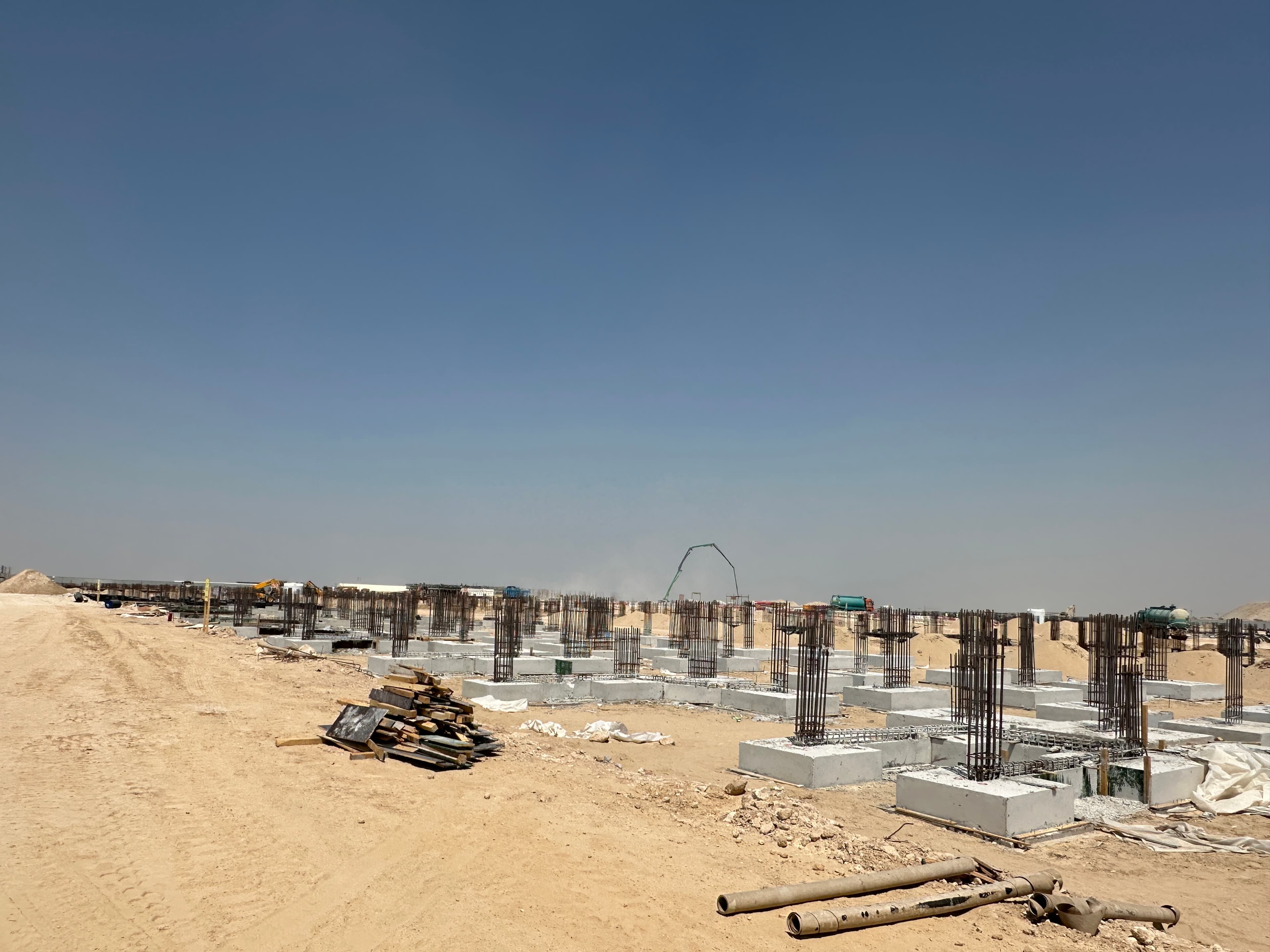

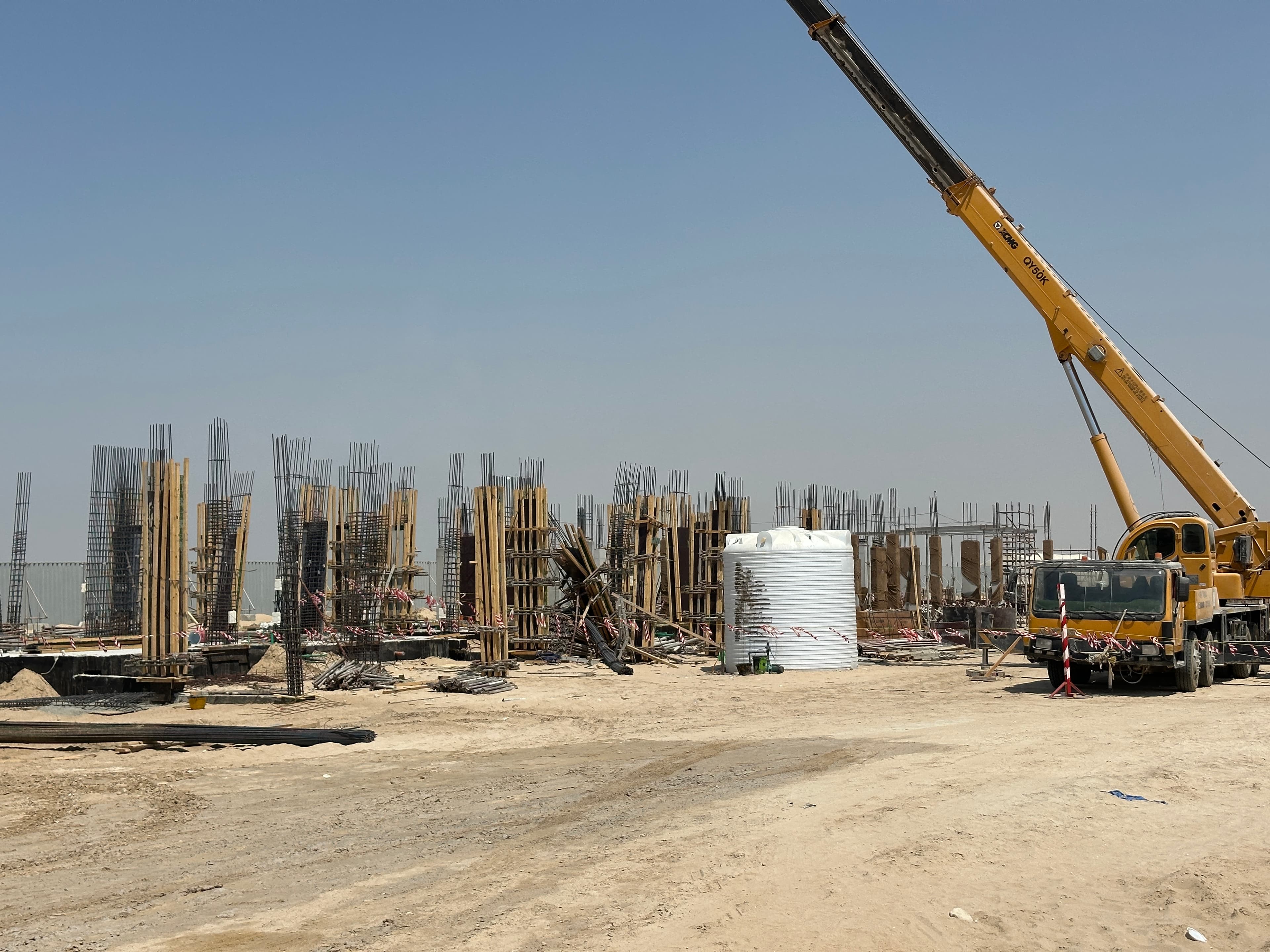

  • Hayat 3 construction site, inspection photo 1, 24 September 2026
  • Hayat 3 construction site, inspection photo 2, 24 September 2026
  • Hayat 3 construction site, inspection photo 3, 24 September 2026

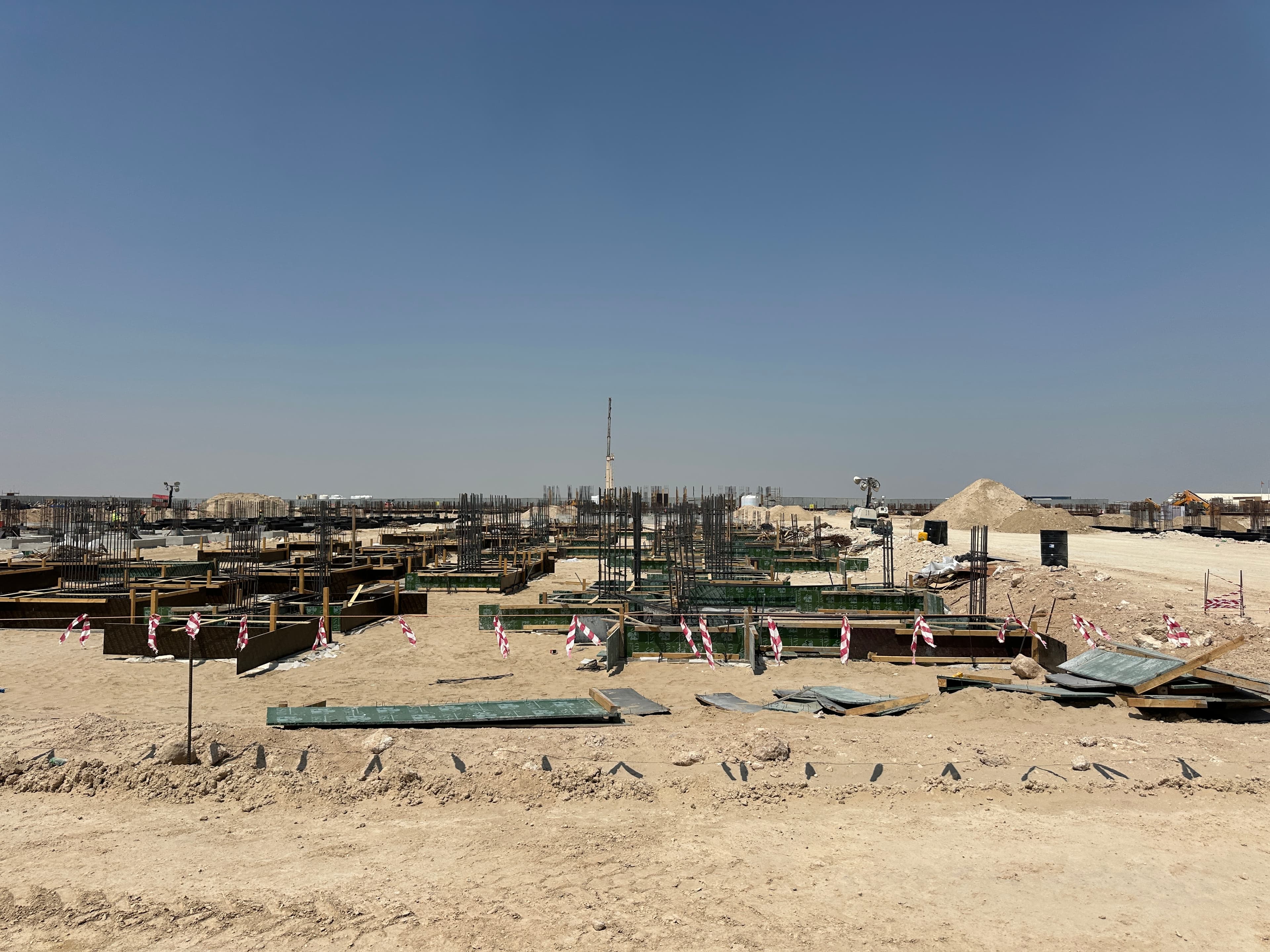

  • Hayat 3 construction site, inspection photo 4, 24 September 2026

26 March 2026

0%

  • Hayat 3 construction site, inspection photo 1, 26 March 2026

  • Hayat 3 construction site, inspection photo 2, 26 March 2026

10 June 2025

0%

  • Hayat 3 construction site, inspection photo 1, 10 June 2025
  • Hayat 3 construction site, inspection photo 2, 10 June 2025

All 8 site photos, by inspection date

Context

Dubai World Central has 53 projects under construction, 31% built on average.

Dubai South Properties Dwc has 19 projects under construction in Dubai; 2 have passed their registered completion date.

Own a unit in Hayat 3?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Hayat 3 handover date?
The registered completion date is May 2028. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around November 2038. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Hayat 3?
Hayat 3 was 3.9% built at the site inspection on 24 September 2026. The site has been inspected 3 times since June 2025. The Land Department took 8 site photos at its inspections.
Is Hayat 3 delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of May 2028.
Who is building Hayat 3?
The registered developer is Dubai South Properties Dwc. It has 18 other projects under construction in Dubai.
Which bank holds the escrow account for Hayat 3?
Emirates NBD. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
