Verde By Vision construction progress

Verde By Vision in Dubai Sports City is 1.6% built at the Land Department inspection of April 2026. Developer Clear Vision Real Estate Development. Completion registered for September 2027.

1.6%

Built, at the Land Department site inspection of 14 April 2026

Running behind its date

Completion date (Land Department)
September 2027
Finish at recent pace
July 2060
Construction started
December 2025
Registered with the Land Department
October 2025
Units
253
Escrow bank
The National Bank of Fujairah
Name in Arabic
فيردي باي فيجن
Land Department project number
4124
Land Department site inspections
2

Schedule

Between September 2025 and April 2026 the site added about 0.2 points a month. At that rate it would finish around July 2060, more than three months after the September 2027 date registered with the Land Department.

0%25%50%75%100%20262027
Progress at each Land Department site inspectionStraight line from start to the Land Department completion date

Site inspections

14 April 2026

1.6%+1.6 pts

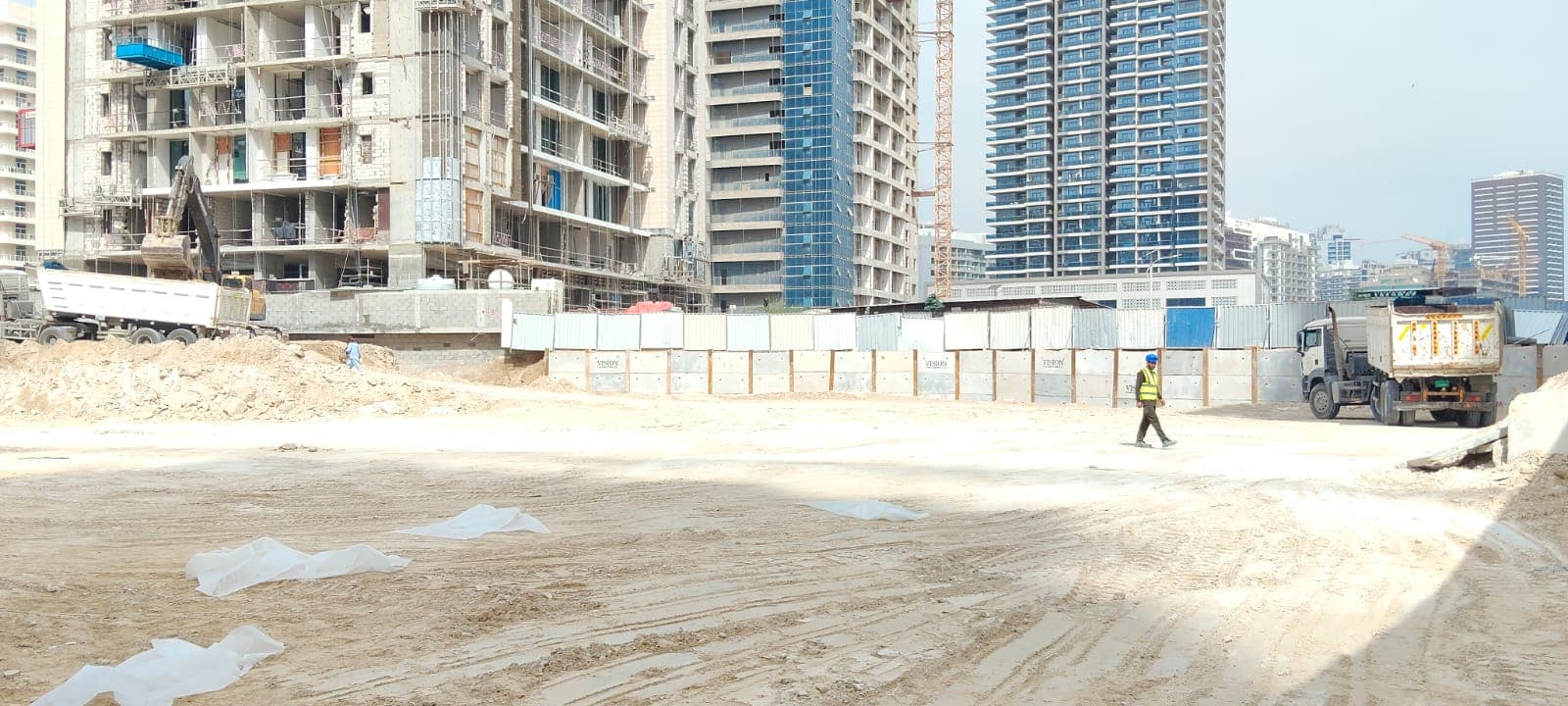

  • Verde By Vision construction site, Land Department inspection photo 1, 14 April 2026

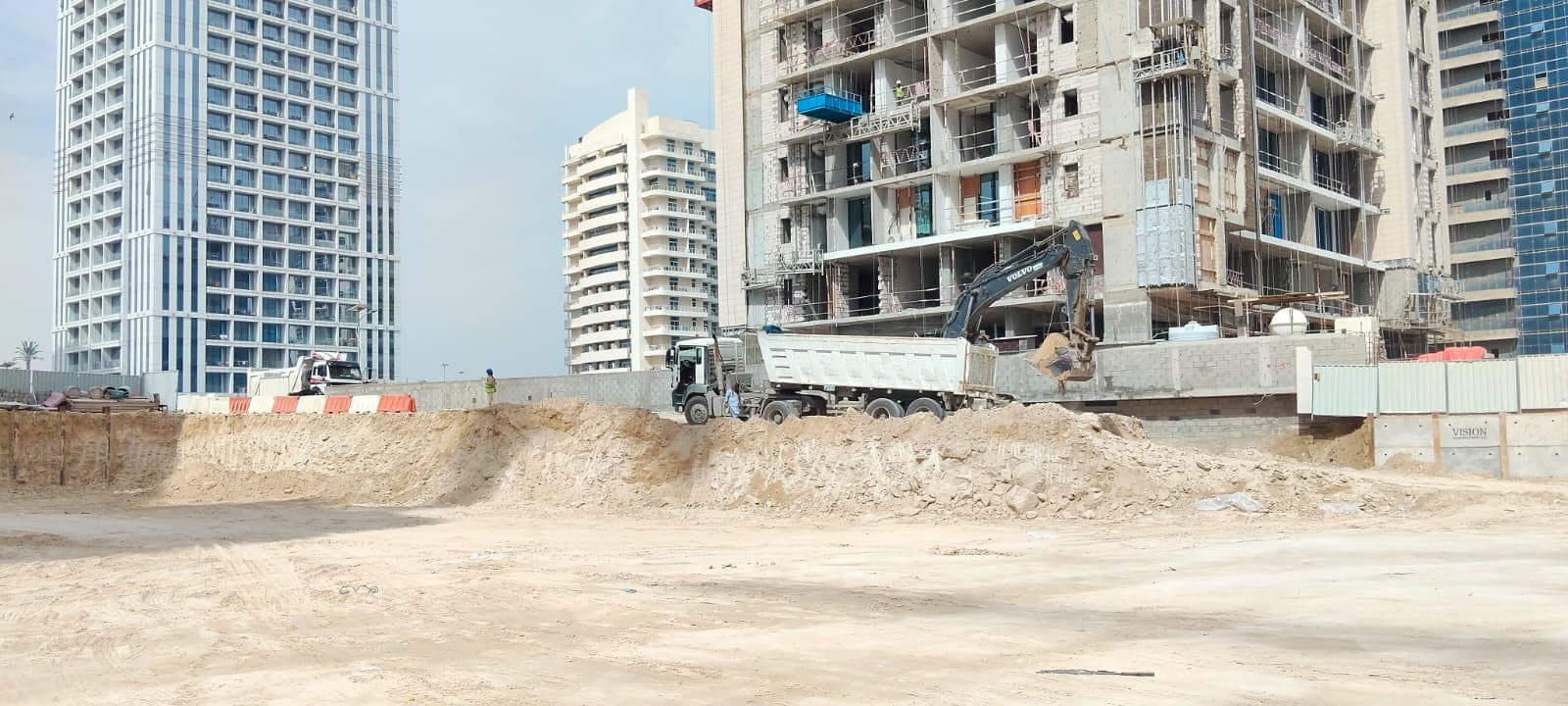

  • Verde By Vision construction site, Land Department inspection photo 2, 14 April 2026
  • Verde By Vision construction site, Land Department inspection photo 3, 14 April 2026

24 September 2025

0%

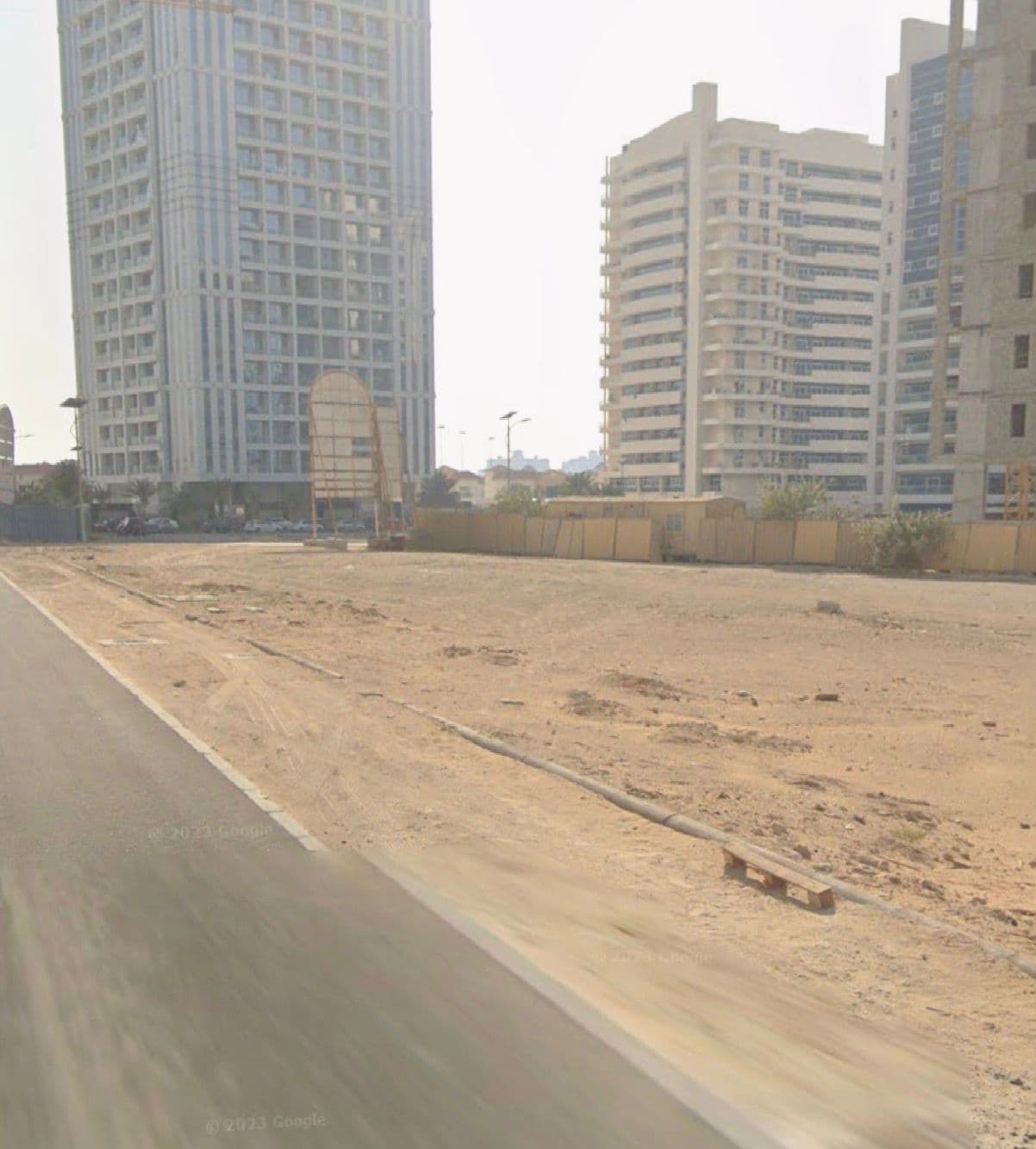

  • Verde By Vision construction site, Land Department inspection photo 1, 24 September 2025

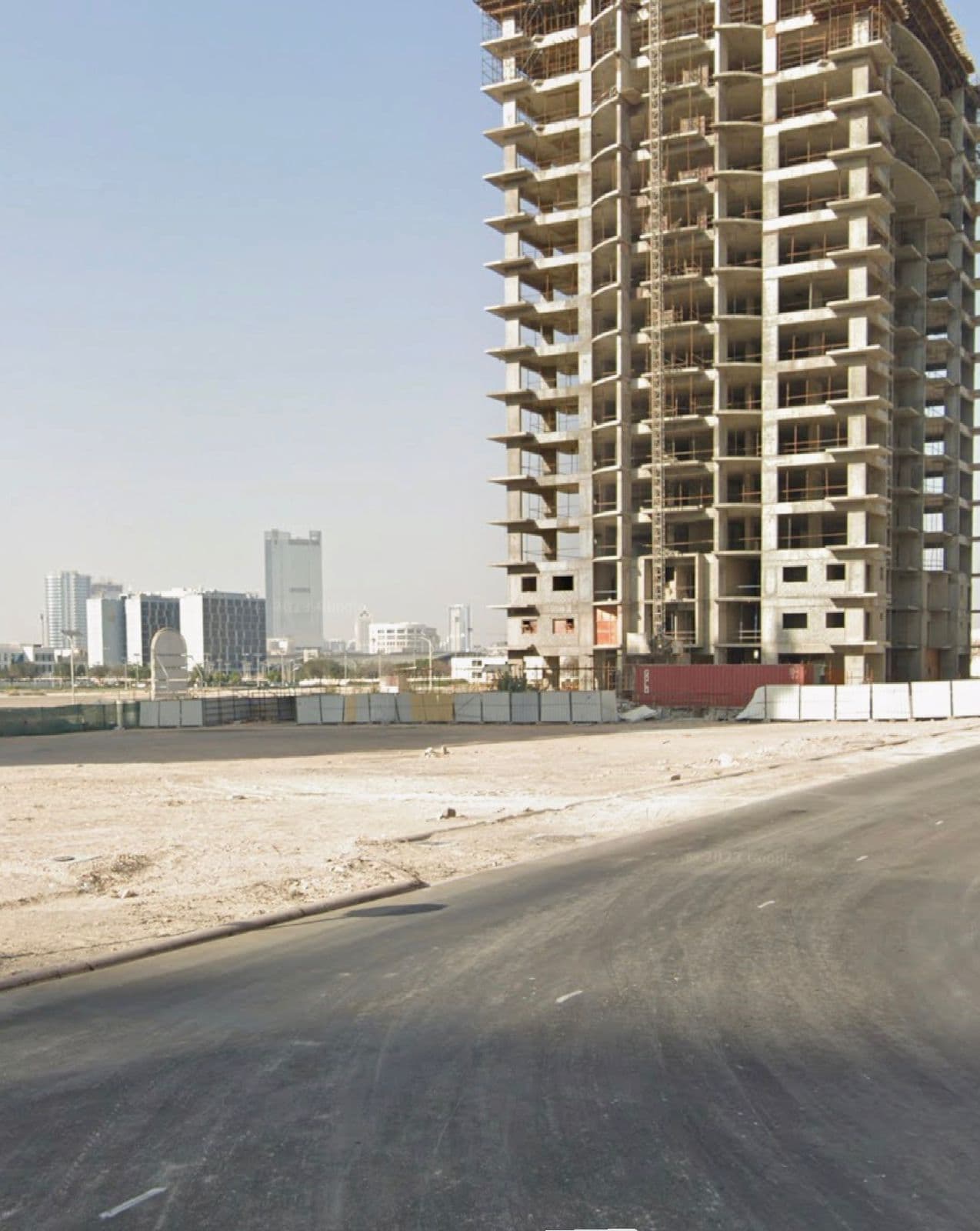

  • Verde By Vision construction site, Land Department inspection photo 2, 24 September 2025

All 5 site photos, by inspection date

Context

Dubai Sports City has 21 projects under construction, 44% built on average.

Clear Vision Real Estate Development has 4 projects under construction in Dubai, none past their registered completion dates.

Own a unit in Verde By Vision?

Mulki follows this project for you: each new Land Department inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When will Verde By Vision be completed?
The completion date registered with the Dubai Land Department is September 2027. At the pace of its recent inspections the site would reach 100% around July 2060. Developers can apply to the Land Department to extend the date, so check the register before relying on it.
How much of Verde By Vision is built?
1.6%, measured at the Land Department site inspection on 14 April 2026. The Land Department engineers have inspected the site 2 times since September 2025.
Is Verde By Vision delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of September 2027.
Who is building Verde By Vision?
The registered developer is Clear Vision Real Estate Development. It has 3 other projects under construction in Dubai.
Which bank holds the escrow account for Verde By Vision?
The National Bank of Fujairah. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of Land Department inspections, not a forecast from the developer. Site photos belong to the Dubai Land Department. See how Mulki works with Land Department data.
