Verdania 2 construction progress
Verdania 2 in Dubai Land Residence Complex is 9.0% built at the Land Department inspection of June 2026. Developer Obj1 Real Estate Development. Completion registered for March 2027.
9.0%
Built, at the Land Department site inspection of 18 June 2026
Running behind its date
- Completion date (Land Department)
- March 2027
- Finish at recent pace
- July 2035
- Construction started
- June 2025
- Registered with the Land Department
- June 2025
- Developer
- Obj1 Real Estate Development
- Community
- Dubai Land Residence Complex
- Units
- 108
- Escrow bank
- Abu Dhabi Islamic Bank
- Name in Arabic
- فيردانيا 2
- Land Department project number
- 3576
- Land Department site inspections
- 4
Schedule
Between July 2025 and June 2026 the site added about 0.8 points a month. At that rate it would finish around July 2035, more than three months after the March 2027 date registered with the Land Department.
Site inspections
18 June 2026
9.0%+1.8 pts
24 February 2026
7.2%+7.0 pts
28 July 2025
0.1%+0.1 pts

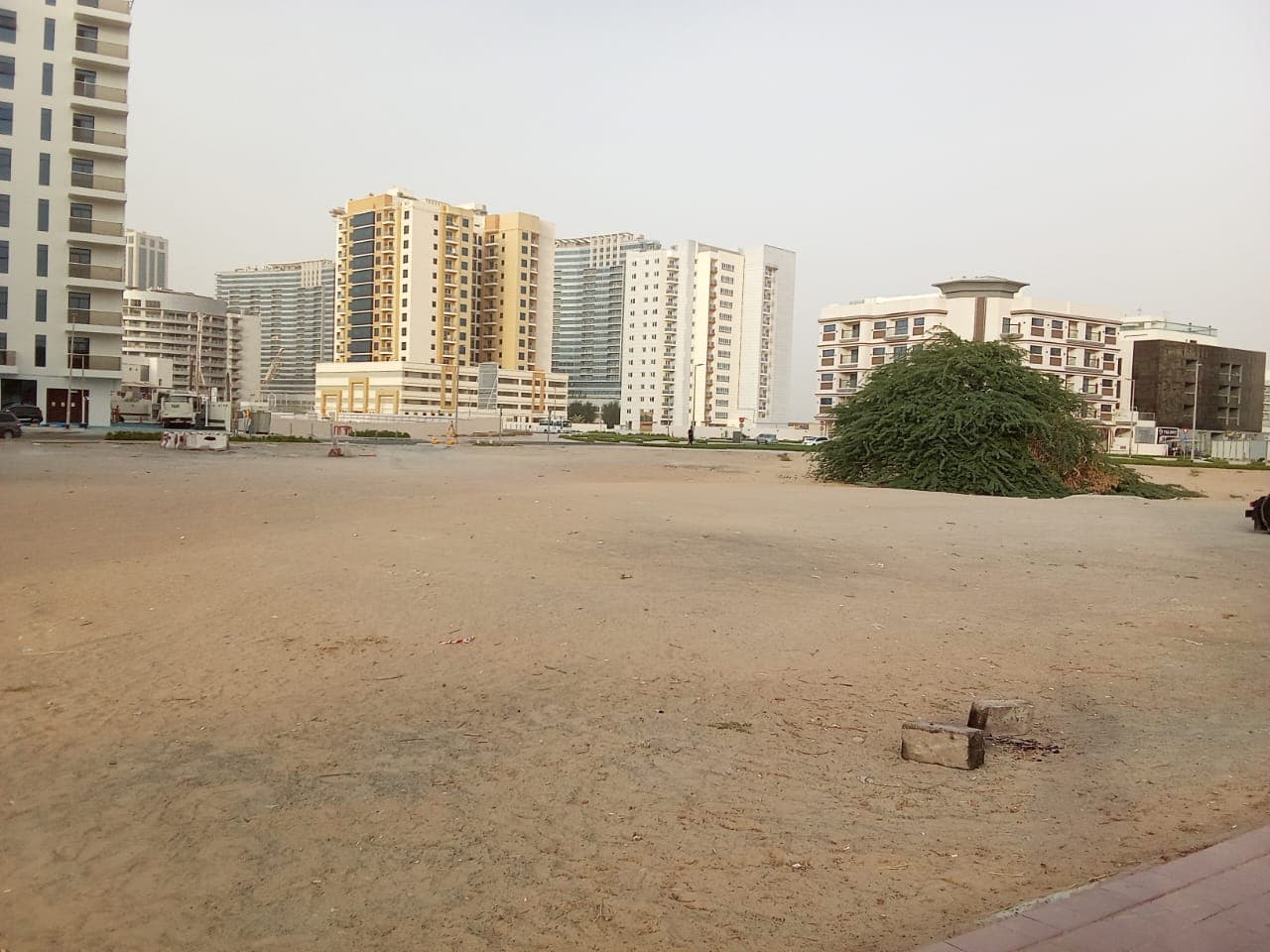

25 February 2025
0%
Context
Dubai Land Residence Complex has 65 projects under construction, 24% built on average.
Obj1 Real Estate Development has 14 projects under construction in Dubai; 1 has passed its registered completion date.
Own a unit in Verdania 2?
Mulki follows this project for you: each new Land Department inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When will Verdania 2 be completed?
- The completion date registered with the Dubai Land Department is March 2027. At the pace of its recent inspections the site would reach 100% around July 2035. Developers can apply to the Land Department to extend the date, so check the register before relying on it.
- How much of Verdania 2 is built?
- 9.0%, measured at the Land Department site inspection on 18 June 2026. The Land Department engineers have inspected the site 4 times since February 2025.
- Is Verdania 2 delayed?
- It is running behind. At the rate of the last year it would finish more than three months after its registered date of March 2027.
- Who is building Verdania 2?
- The registered developer is Obj1 Real Estate Development. It has 13 other projects under construction in Dubai.
- Which bank holds the escrow account for Verdania 2?
- Abu Dhabi Islamic Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- Luminar Tower 1Also by Obj1 Real Estate Development. 33%.
- Evergrin HouseAlso by Obj1 Real Estate Development. 55%, Due June 2026, passed.
- Luminar Tower 2Also by Obj1 Real Estate Development. 31%, Due October 2026.
- Vivid TowerAlso by Obj1 Real Estate Development. 12%, Due November 2026.
- Ag CentralNearby in Dubai Land Residence Complex. 59%, Due October 2026.
- Ag SquareNearby in Dubai Land Residence Complex. 69%.
- Time 2Nearby in Dubai Land Residence Complex. 87%, Due June 2026, passed.
- Ag 7evenNearby in Dubai Land Residence Complex. 94%, Due March 2027.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of Land Department inspections, not a forecast from the developer. Site photos belong to the Dubai Land Department. See how Mulki works with Land Department data.

.jpeg&w=3840&q=75)










.jpeg&w=3840&q=75)
