Skip to content

Reef 998 construction progress

The registered completion date for Reef 998 in Dubai Land Residence Complex is June 2028. At the last site inspection, in August 2026, it was 2.1% built. The developer is Reef Luxury Development.

2.1%

Built, at the site inspection of 27 August 2026

Running behind its date

Registered completion date
June 2028
Finish at recent pace
November 2050
Construction started
June 2025
First registered
May 2025
Units
339
Escrow bank
Abu Dhabi Islamic Bank
Name in Arabic
ريف 998
Project number
3651
Site inspections
4

Schedule

Between March 2026 and August 2026 the site added about 0.3 points a month. At that rate it would finish around November 2050, more than three months after its registered date of June 2028.

0%25%50%75%100%202620272028
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

27 August 2026

2.1%+1.2 pts

  • Reef 998 construction site, inspection photo 1, 27 August 2026
  • Reef 998 construction site, inspection photo 2, 27 August 2026
  • Reef 998 construction site, inspection photo 3, 27 August 2026
  • Reef 998 construction site, inspection photo 4, 27 August 2026

18 June 2026

0.8%+0.6 pts

  • Reef 998 construction site, inspection photo 1, 18 June 2026
  • Reef 998 construction site, inspection photo 2, 18 June 2026
  • Reef 998 construction site, inspection photo 3, 18 June 2026

10 March 2026

0.2%+0.2 pts

  • Reef 998 construction site, inspection photo 1, 10 March 2026
  • Reef 998 construction site, inspection photo 2, 10 March 2026
  • Reef 998 construction site, inspection photo 3, 10 March 2026

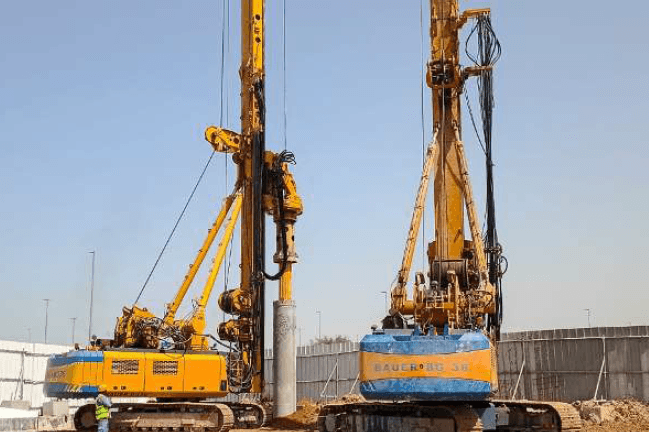

  • Reef 998 construction site, inspection photo 4, 10 March 2026

3 April 2025

0%

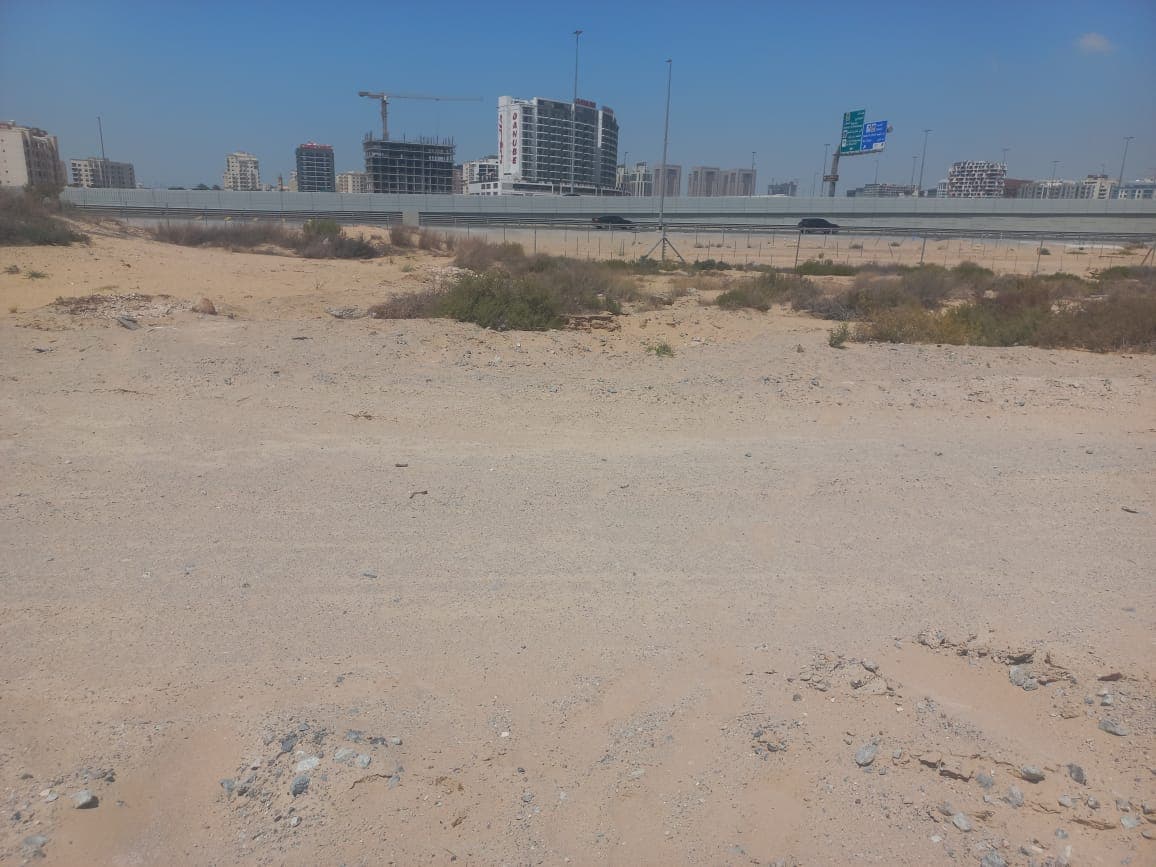

  • Reef 998 construction site, inspection photo 1, 3 April 2025

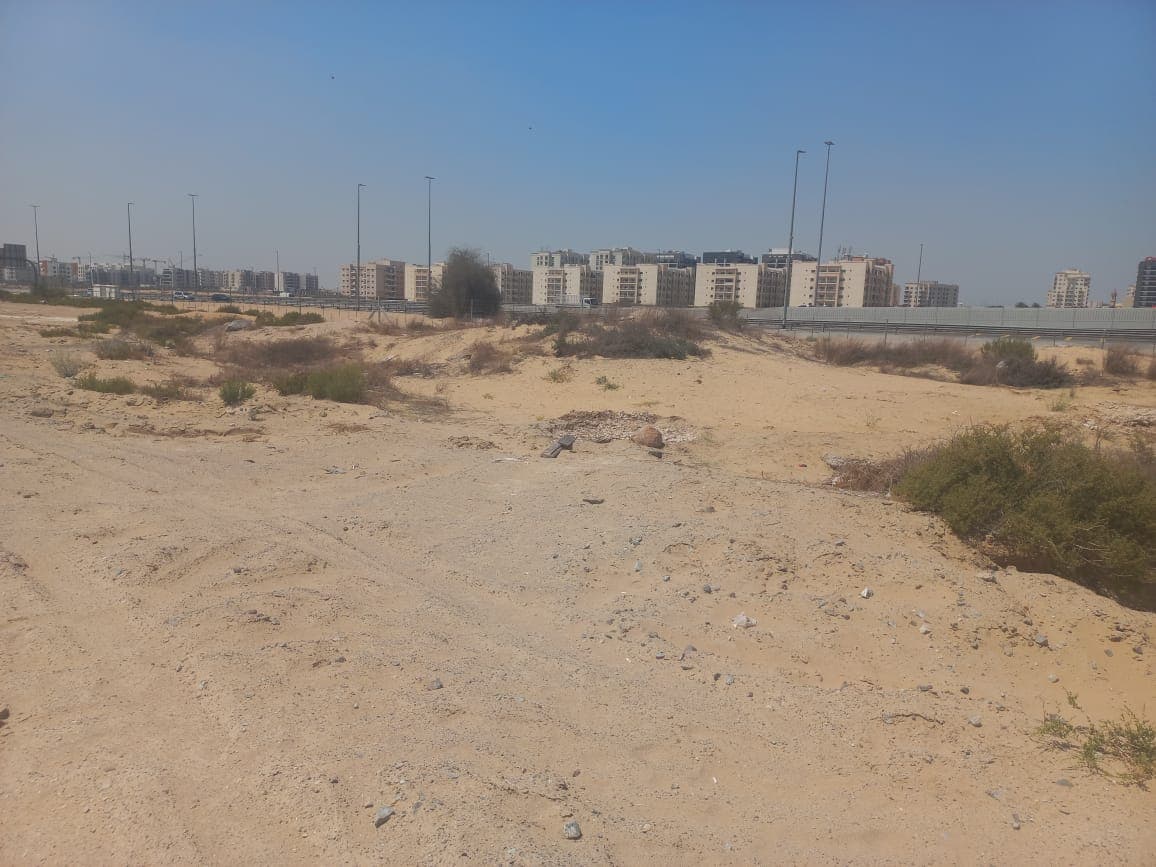

  • Reef 998 construction site, inspection photo 2, 3 April 2025

All 14 site photos, by inspection date

Context

Dubai Land Residence Complex has 63 projects under construction, 28% built on average.

Reef Luxury Development has 6 projects under construction in Dubai, none past their registered completion dates.

Own a unit in Reef 998?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Reef 998 handover date?
The registered completion date is June 2028. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around November 2050. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Reef 998?
Reef 998 was 2.1% built at the site inspection on 27 August 2026. The site has been inspected 4 times since April 2025. The Land Department took 14 site photos at its inspections.
Is Reef 998 delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of June 2028.
Who is building Reef 998?
The registered developer is Reef Luxury Development. It has 5 other projects under construction in Dubai.
Which bank holds the escrow account for Reef 998?
Abu Dhabi Islamic Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
