Elano By Oro24 construction progress

Elano By Oro24 in Arjan was registered to complete in October 2025 and is still under construction. At the last site inspection, in September 2026, it was 70% built. The developer is Oro24 Real Estate Development.

70%

Built, at the site inspection of 11 September 2026

14 months past its registered completion date

Registered completion date
October 2025
Finish at recent pace
June 2027
Construction started
April 2023
First registered
April 2023
Community
Arjan
Units
339
Escrow bank
Mashreq Bank
Name in Arabic
إيلانو من أورو 24
Project number
2620
Site inspections
8

Schedule

Elano By Oro24 was registered to complete in October 2025, 14 months ago, and is still under construction. Over the last year of inspections it has added about 3.4 points a month. Kept at that rate, the site would reach 100% around June 2027.

0%25%50%75%100%202420252026
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

11 September 2026

70%+14 pts

  • Elano By Oro24 construction site, inspection photo 1, 11 September 2026
  • Elano By Oro24 construction site, inspection photo 2, 11 September 2026

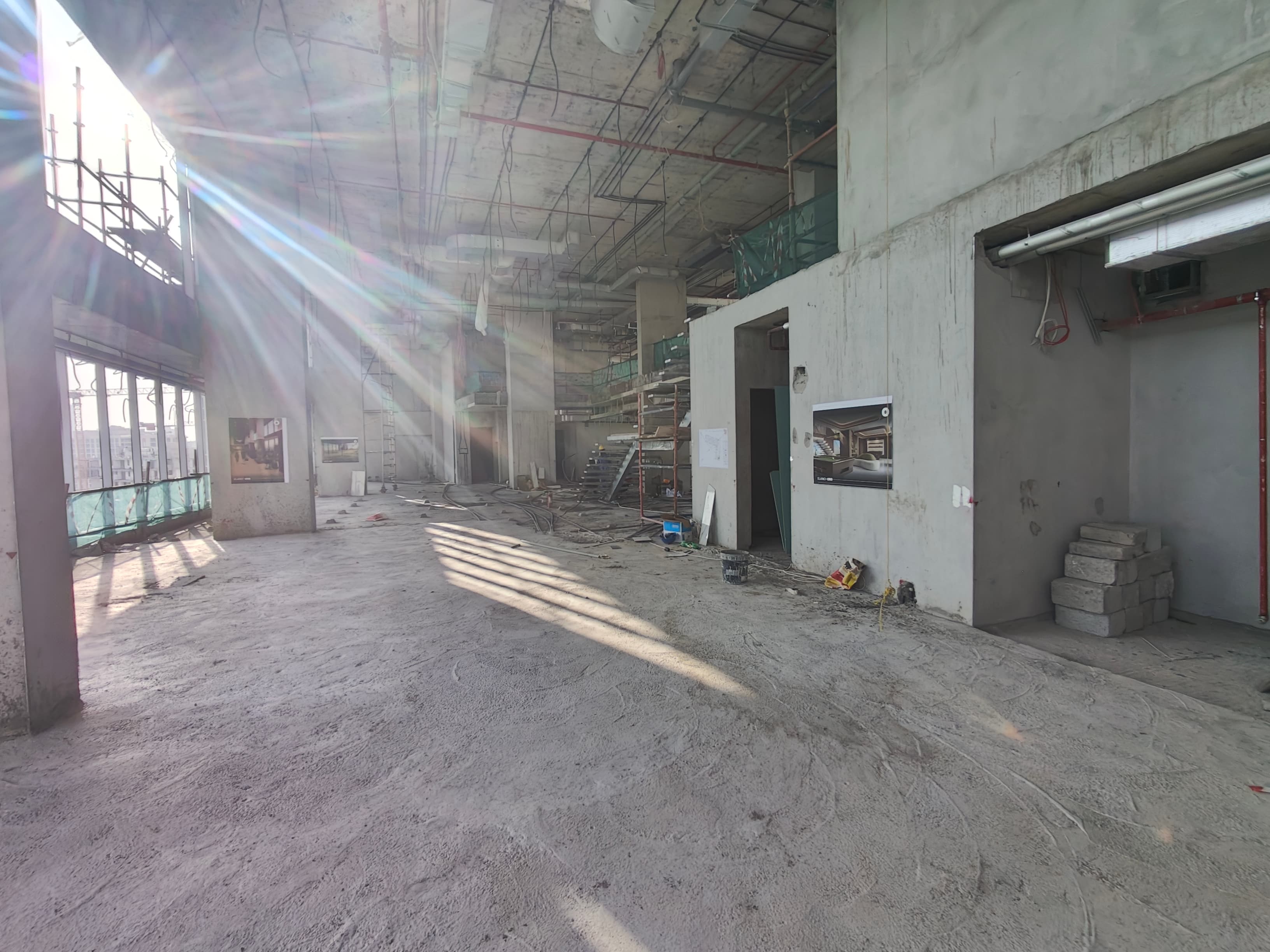

  • Elano By Oro24 construction site, inspection photo 3, 11 September 2026
  • Elano By Oro24 construction site, inspection photo 4, 11 September 2026

24 April 2026

56%+16 pts

  • Elano By Oro24 construction site, inspection photo 1, 24 April 2026
  • Elano By Oro24 construction site, inspection photo 2, 24 April 2026
  • Elano By Oro24 construction site, inspection photo 3, 24 April 2026
  • Elano By Oro24 construction site, inspection photo 4, 24 April 2026

22 January 2026

40%+8.4 pts

  • Elano By Oro24 construction site, inspection photo 1, 22 January 2026
  • Elano By Oro24 construction site, inspection photo 2, 22 January 2026

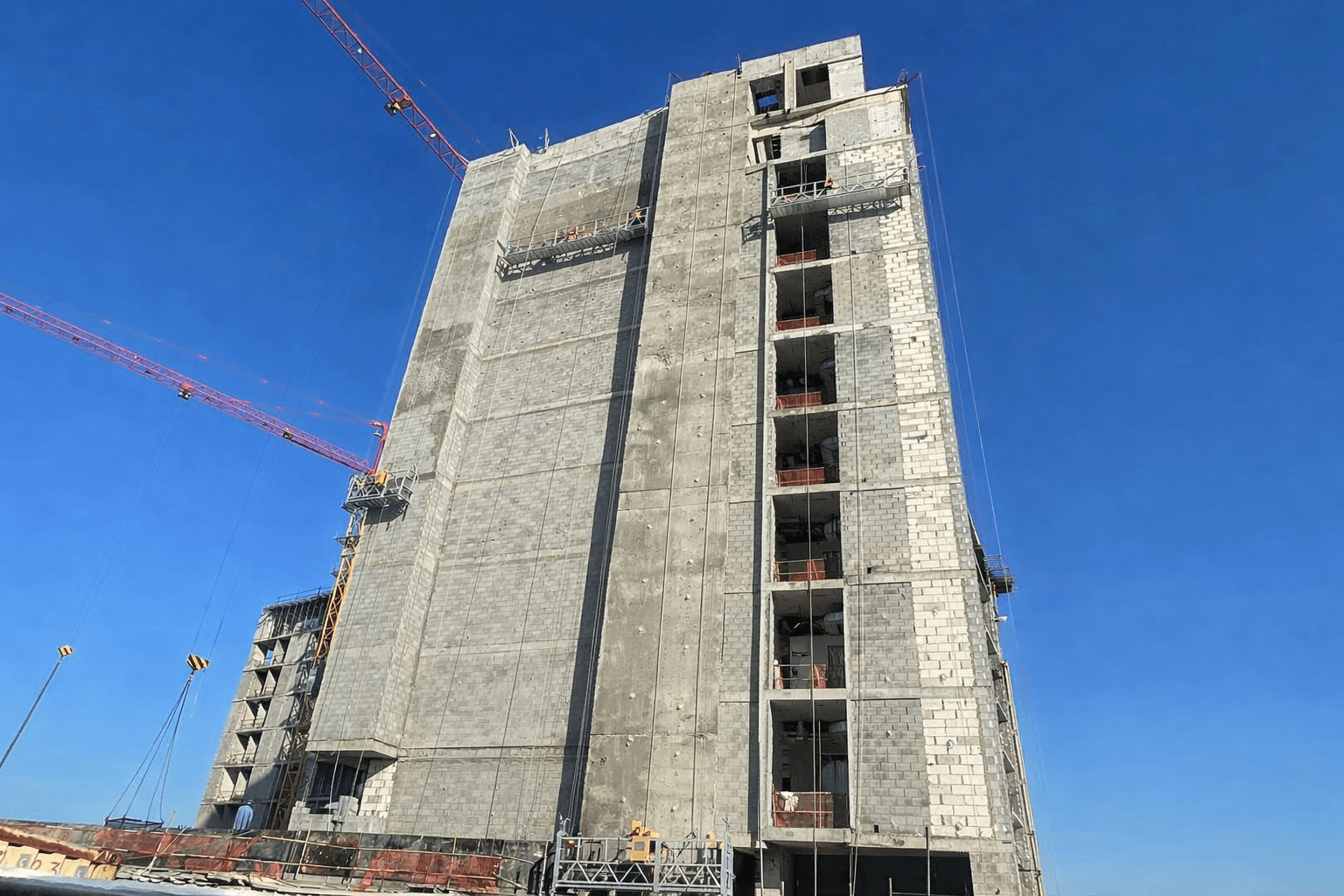

  • Elano By Oro24 construction site, inspection photo 3, 22 January 2026
  • Elano By Oro24 construction site, inspection photo 4, 22 January 2026

6 October 2025

32%+9.9 pts

  • Elano By Oro24 construction site, inspection photo 1, 6 October 2025
  • Elano By Oro24 construction site, inspection photo 2, 6 October 2025
  • Elano By Oro24 construction site, inspection photo 3, 6 October 2025
  • Elano By Oro24 construction site, inspection photo 4, 6 October 2025

27 May 2025

22%+18 pts

  • Elano By Oro24 construction site, inspection photo 1, 27 May 2025
  • Elano By Oro24 construction site, inspection photo 2, 27 May 2025
  • Elano By Oro24 construction site, inspection photo 3, 27 May 2025
  • Elano By Oro24 construction site, inspection photo 4, 27 May 2025

20 March 2024

3.8%+1.1 pts

  • Elano By Oro24 construction site, inspection photo 1, 20 March 2024
  • Elano By Oro24 construction site, inspection photo 2, 20 March 2024
  • Elano By Oro24 construction site, inspection photo 3, 20 March 2024

6 November 2023

2.7%+2.5 pts

  • Elano By Oro24 construction site, inspection photo 1, 6 November 2023
  • Elano By Oro24 construction site, inspection photo 2, 6 November 2023
  • Elano By Oro24 construction site, inspection photo 3, 6 November 2023
  • Elano By Oro24 construction site, inspection photo 4, 6 November 2023

1 August 2023

0.2%

  • Elano By Oro24 construction site, inspection photo 1, 1 August 2023
  • Elano By Oro24 construction site, inspection photo 2, 1 August 2023
  • Elano By Oro24 construction site, inspection photo 3, 1 August 2023
  • Elano By Oro24 construction site, inspection photo 4, 1 August 2023

All 61 site photos, by inspection date

Context

Arjan has 23 projects under construction, 48% built on average.

Oro24 Real Estate Development has 4 projects under construction in Dubai; 3 have passed their registered completion date.

Own a unit in Elano By Oro24?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Elano By Oro24 handover date?
The registered completion date was October 2025, and the register still lists Elano By Oro24 as under construction. At the pace of its recent inspections the site would reach 100% around June 2027. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Elano By Oro24?
Elano By Oro24 was 70% built at the site inspection on 11 September 2026. The site has been inspected 8 times since August 2023. The Land Department took 61 site photos at its inspections.
Is Elano By Oro24 delayed?
Yes. Its registered completion date of October 2025 has passed and the project is still listed as under construction.
Who is building Elano By Oro24?
The registered developer is Oro24 Real Estate Development. It has 3 other projects under construction in Dubai.
Which bank holds the escrow account for Elano By Oro24?
Mashreq Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
