Pristine By Zoya construction progress

The registered completion date for Pristine By Zoya in Al Furjan is January 2027. At the last site inspection, in August 2026, it was 58% built. The developer is Zoya One Real Estate Developments.

58%

Built, at the site inspection of 20 August 2026

Running behind its date

Registered completion date
January 2027
Finish at recent pace
April 2027
Construction started
September 2024
First registered
August 2024
Community
Al Furjan
Units
73
Escrow bank
Emirates Islamic Bank
Name in Arabic
البكر من زويا
Project number
3069
Site inspections
7

Schedule

Between November 2025 and August 2026 the site added about 5.2 points a month. At that rate it would finish around April 2027, more than three months after its registered date of January 2027.

0%25%50%75%100%202520262027
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

20 August 2026

58%+17 pts

  • Pristine By Zoya construction site, inspection photo 1, 20 August 2026
  • Pristine By Zoya construction site, inspection photo 2, 20 August 2026
  • Pristine By Zoya construction site, inspection photo 3, 20 August 2026
  • Pristine By Zoya construction site, inspection photo 4, 20 August 2026

7 May 2026

41%+16 pts

  • Pristine By Zoya construction site, inspection photo 1, 7 May 2026
  • Pristine By Zoya construction site, inspection photo 2, 7 May 2026

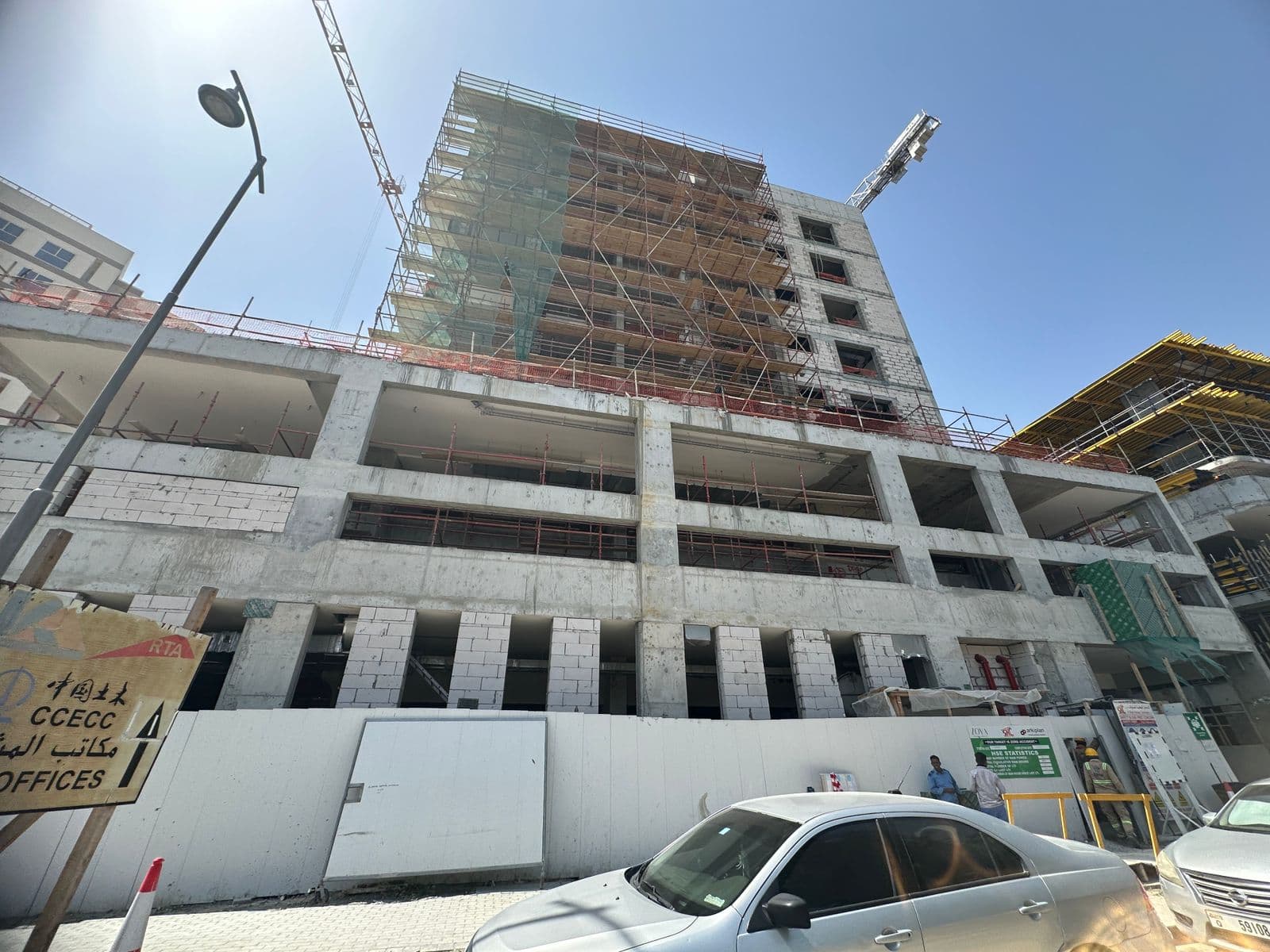

  • Pristine By Zoya construction site, inspection photo 3, 7 May 2026
  • Pristine By Zoya construction site, inspection photo 4, 7 May 2026

15 April 2026

25%+3.6 pts

  • Pristine By Zoya construction site, inspection photo 1, 15 April 2026
  • Pristine By Zoya construction site, inspection photo 2, 15 April 2026
  • Pristine By Zoya construction site, inspection photo 3, 15 April 2026
  • Pristine By Zoya construction site, inspection photo 4, 15 April 2026

22 January 2026

22%+8.6 pts

  • Pristine By Zoya construction site, inspection photo 1, 22 January 2026
  • Pristine By Zoya construction site, inspection photo 2, 22 January 2026
  • Pristine By Zoya construction site, inspection photo 3, 22 January 2026
  • Pristine By Zoya construction site, inspection photo 4, 22 January 2026

26 November 2025

13%+13 pts

  • Pristine By Zoya construction site, inspection photo 1, 26 November 2025
  • Pristine By Zoya construction site, inspection photo 2, 26 November 2025
  • Pristine By Zoya construction site, inspection photo 3, 26 November 2025
  • Pristine By Zoya construction site, inspection photo 4, 26 November 2025

1 July 2025

0%

  • Pristine By Zoya construction site, inspection photo 1, 1 July 2025
  • Pristine By Zoya construction site, inspection photo 2, 1 July 2025

23 May 2024

0%

  • Pristine By Zoya construction site, inspection photo 1, 23 May 2024
  • Pristine By Zoya construction site, inspection photo 2, 23 May 2024

All 42 site photos, by inspection date

Context

Al Furjan has 38 projects under construction, 32% built on average.

Zoya One Real Estate Developments has 10 projects under construction in Dubai, none past their registered completion dates.

Own a unit in Pristine By Zoya?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Pristine By Zoya handover date?
The registered completion date is January 2027. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around April 2027. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Pristine By Zoya?
Pristine By Zoya was 58% built at the site inspection on 20 August 2026. The site has been inspected 7 times since May 2024. The Land Department took 42 site photos at its inspections.
Is Pristine By Zoya delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of January 2027.
Who is building Pristine By Zoya?
The registered developer is Zoya One Real Estate Developments. It has 9 other projects under construction in Dubai.
Which bank holds the escrow account for Pristine By Zoya?
Emirates Islamic Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
