Pristine By Zoya construction photos
42 photos taken by Dubai Land Department engineers at 7 site inspections, newest first. The percentage is how much of Pristine By Zoya was built on the day of each visit.

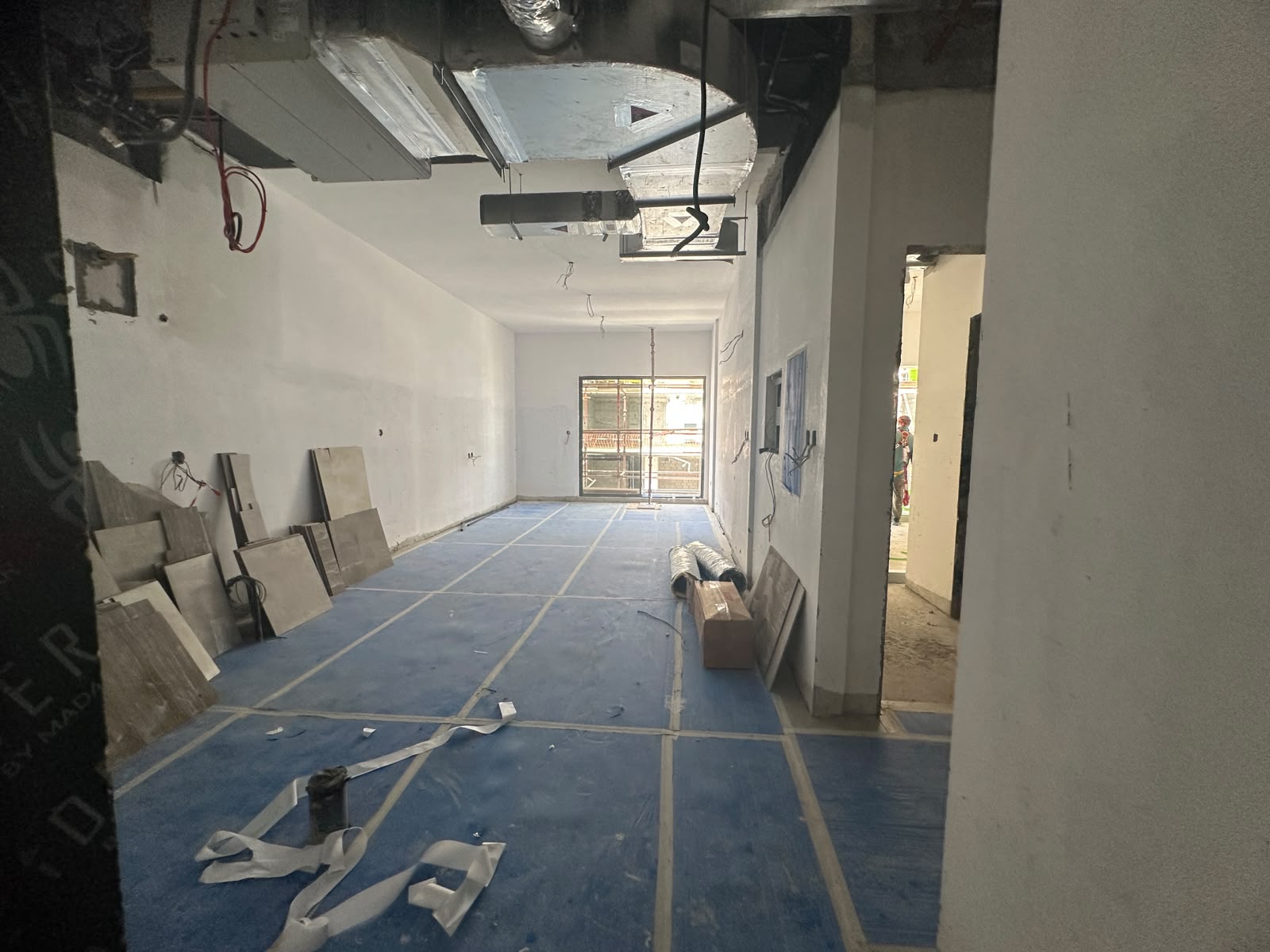

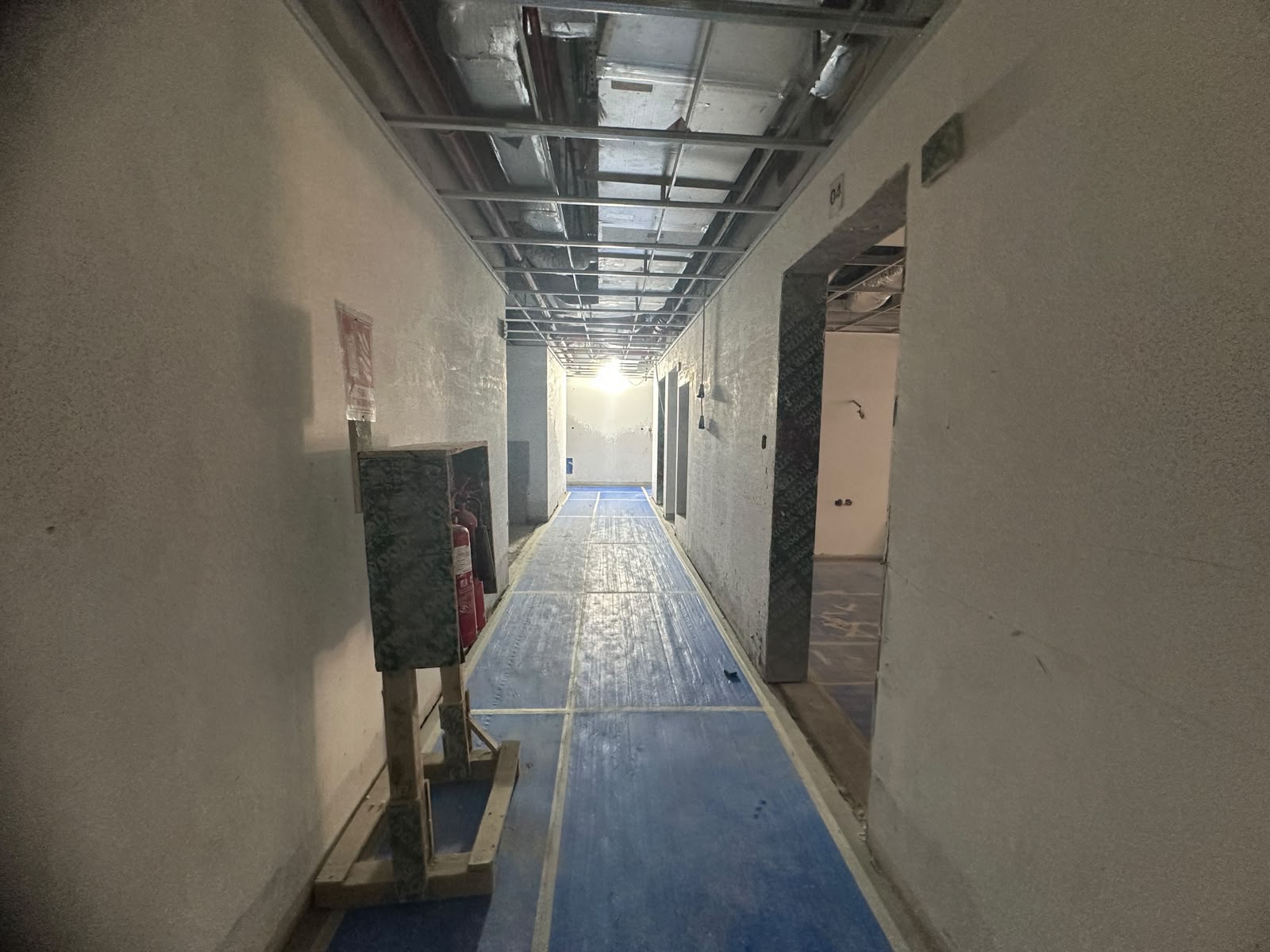

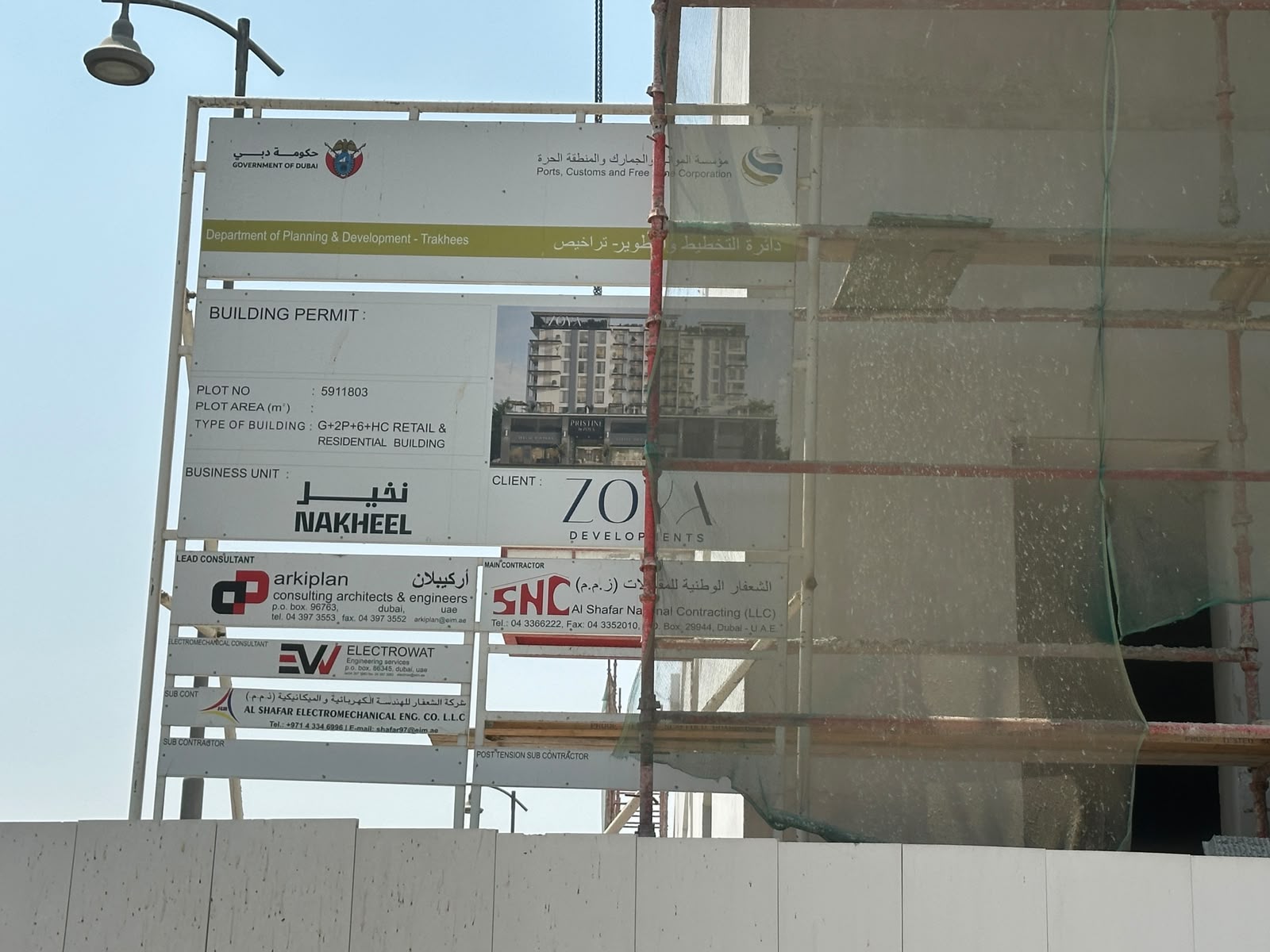

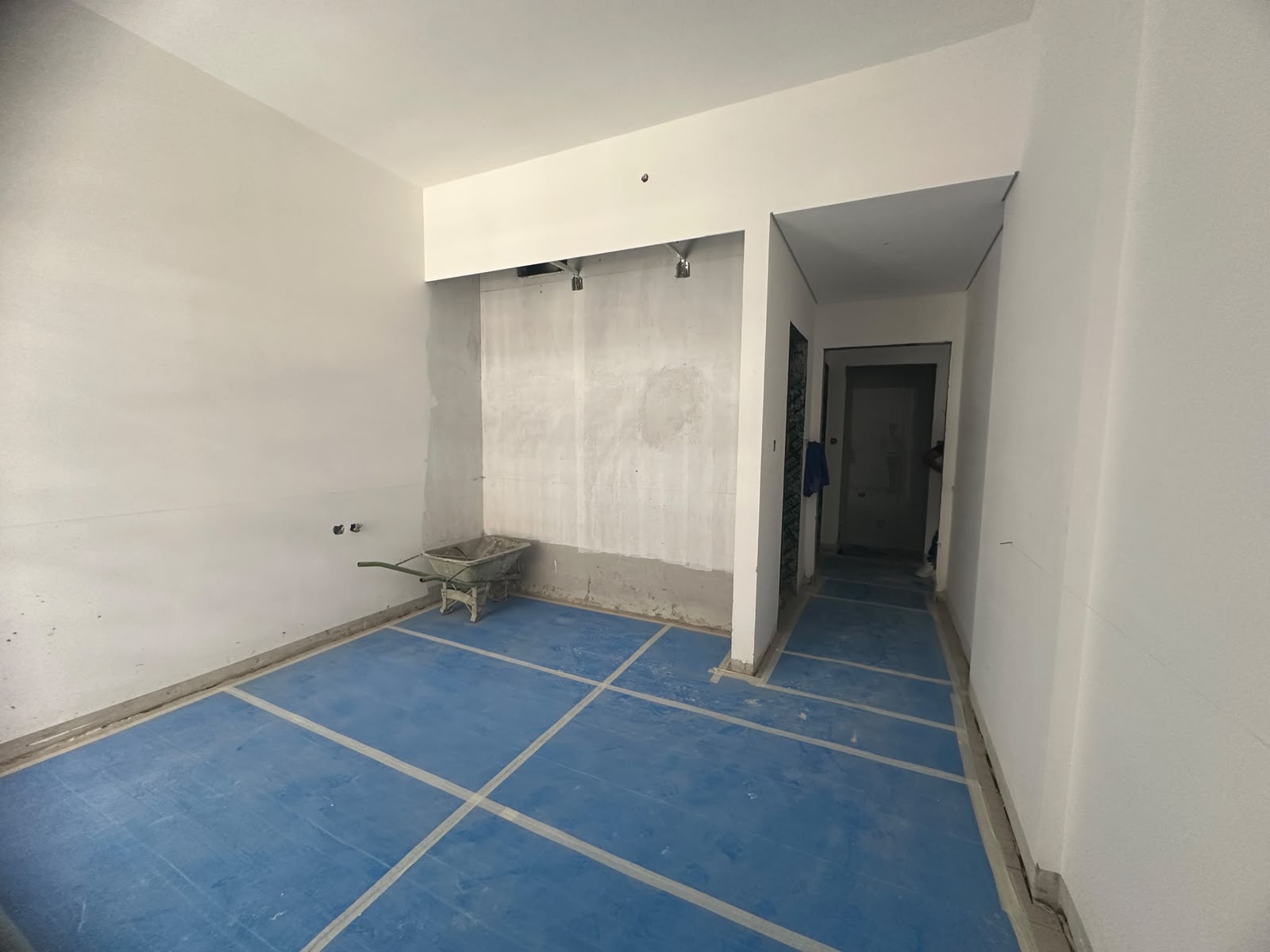

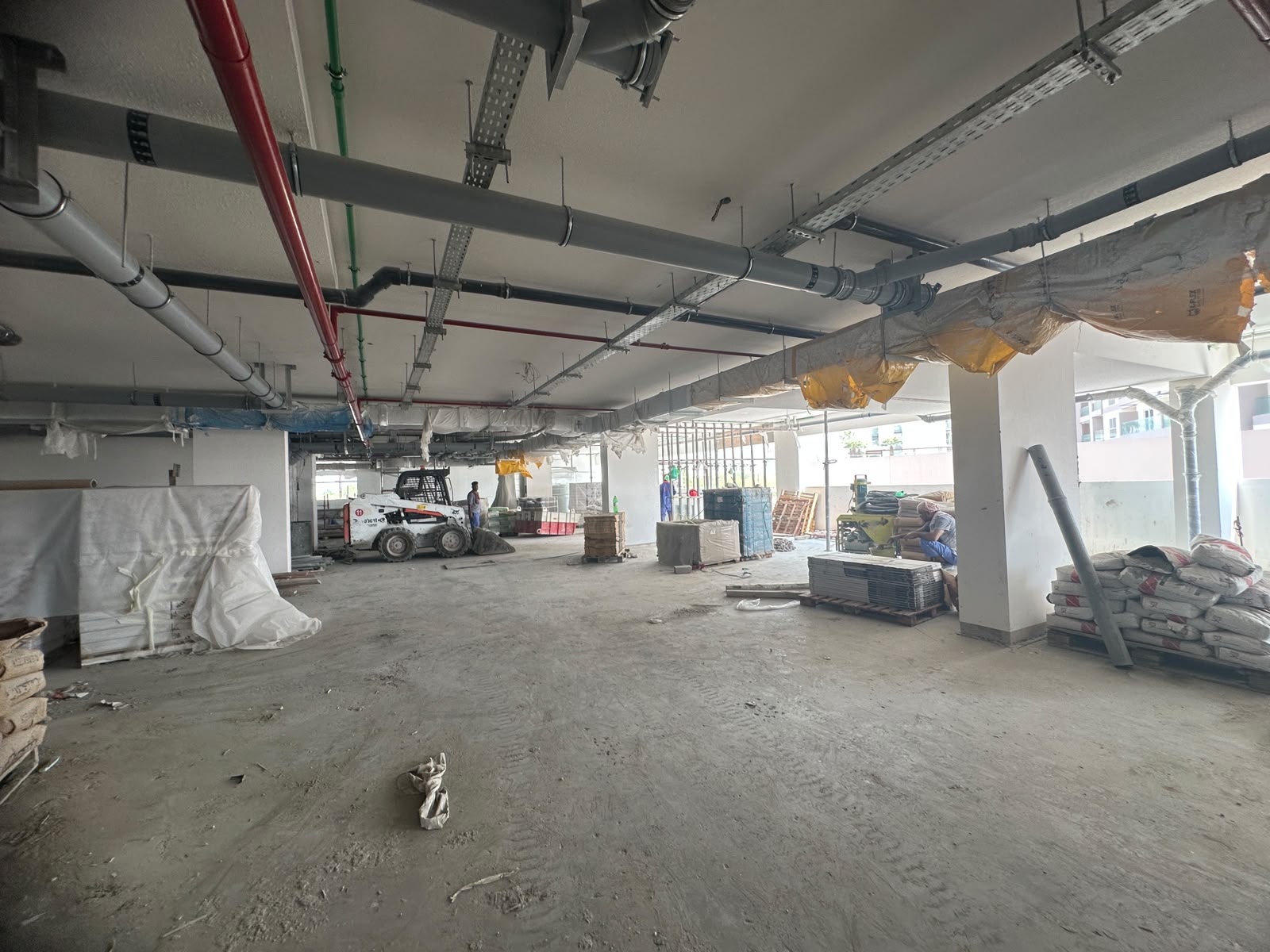

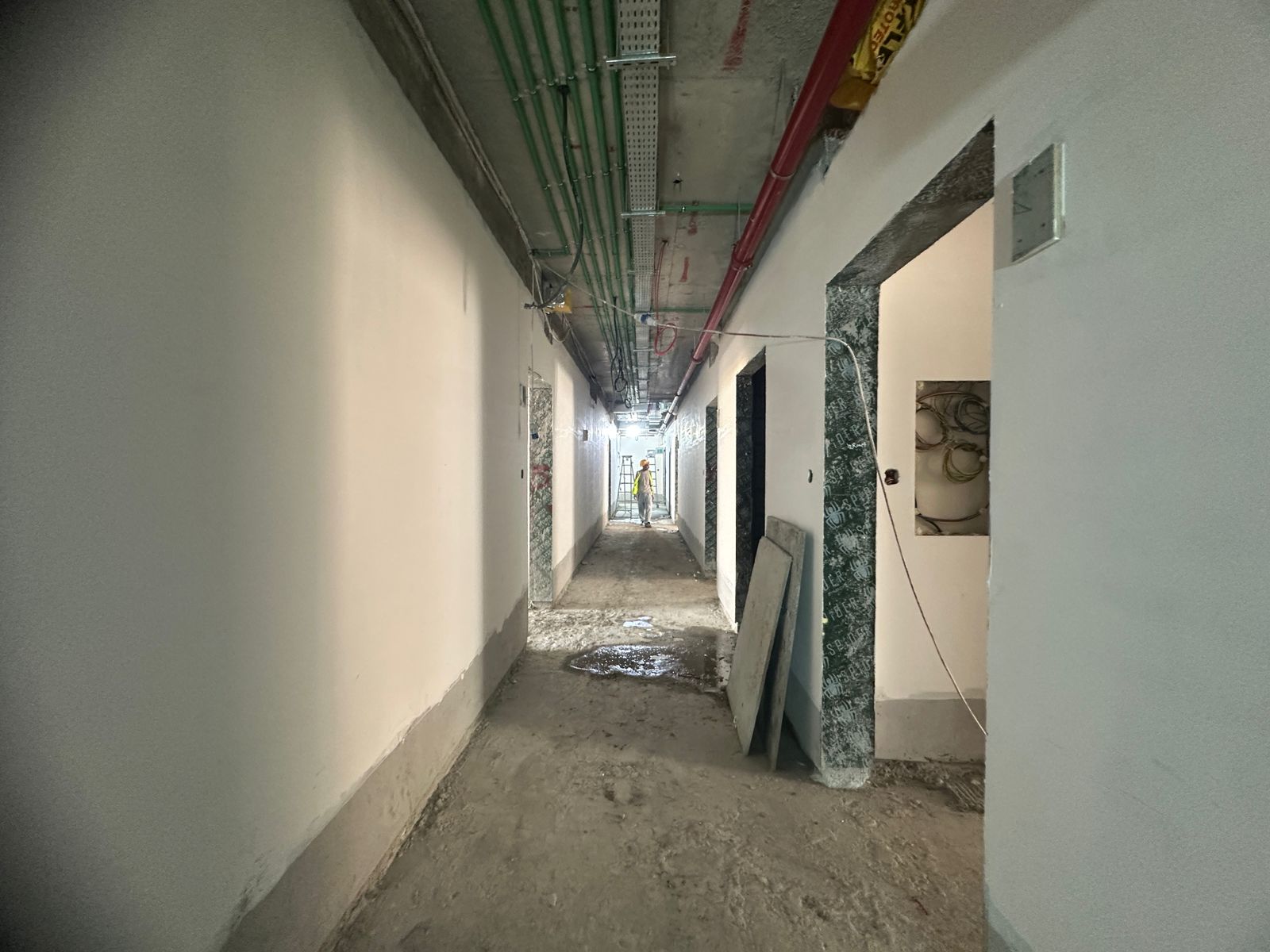

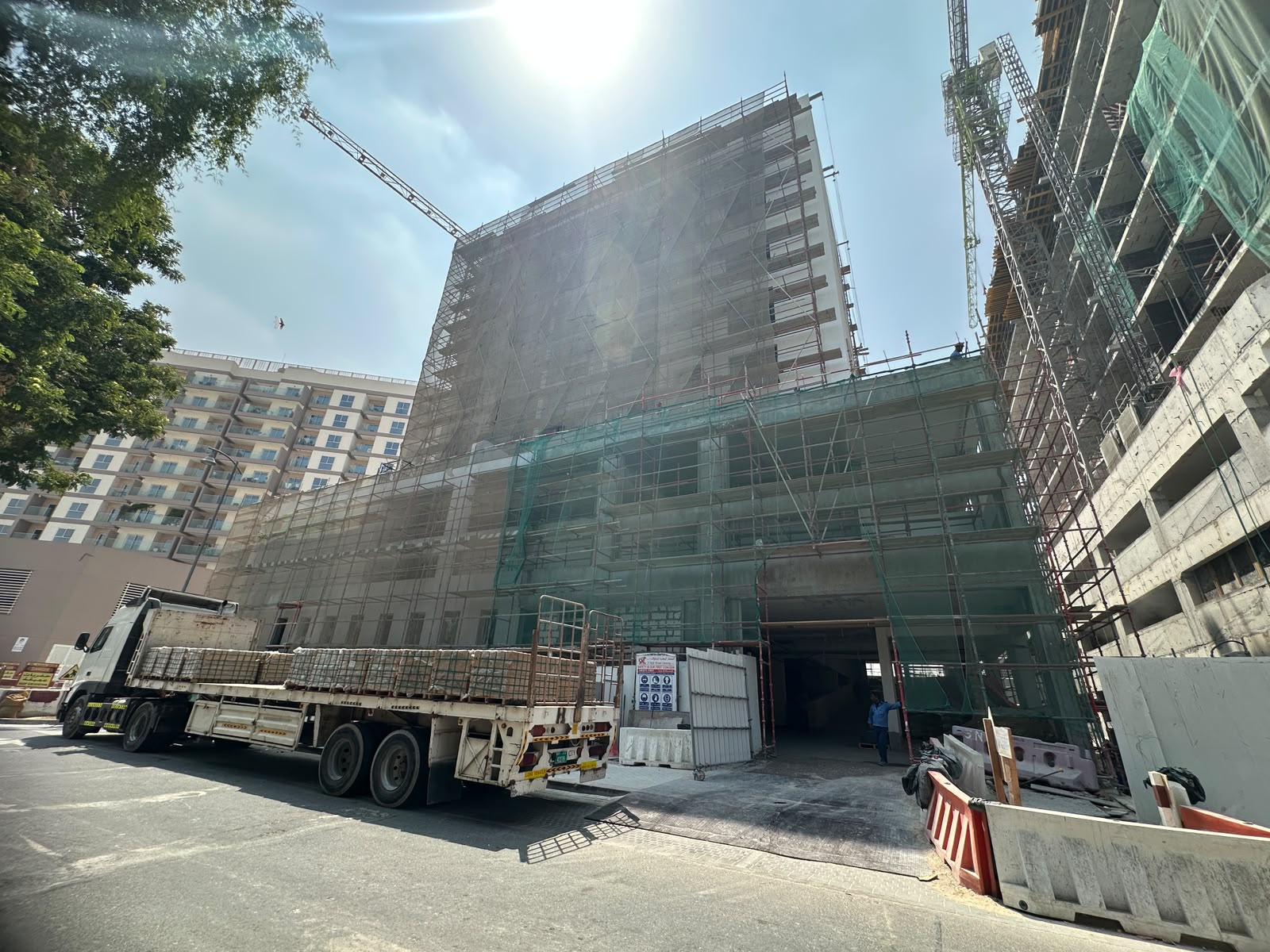

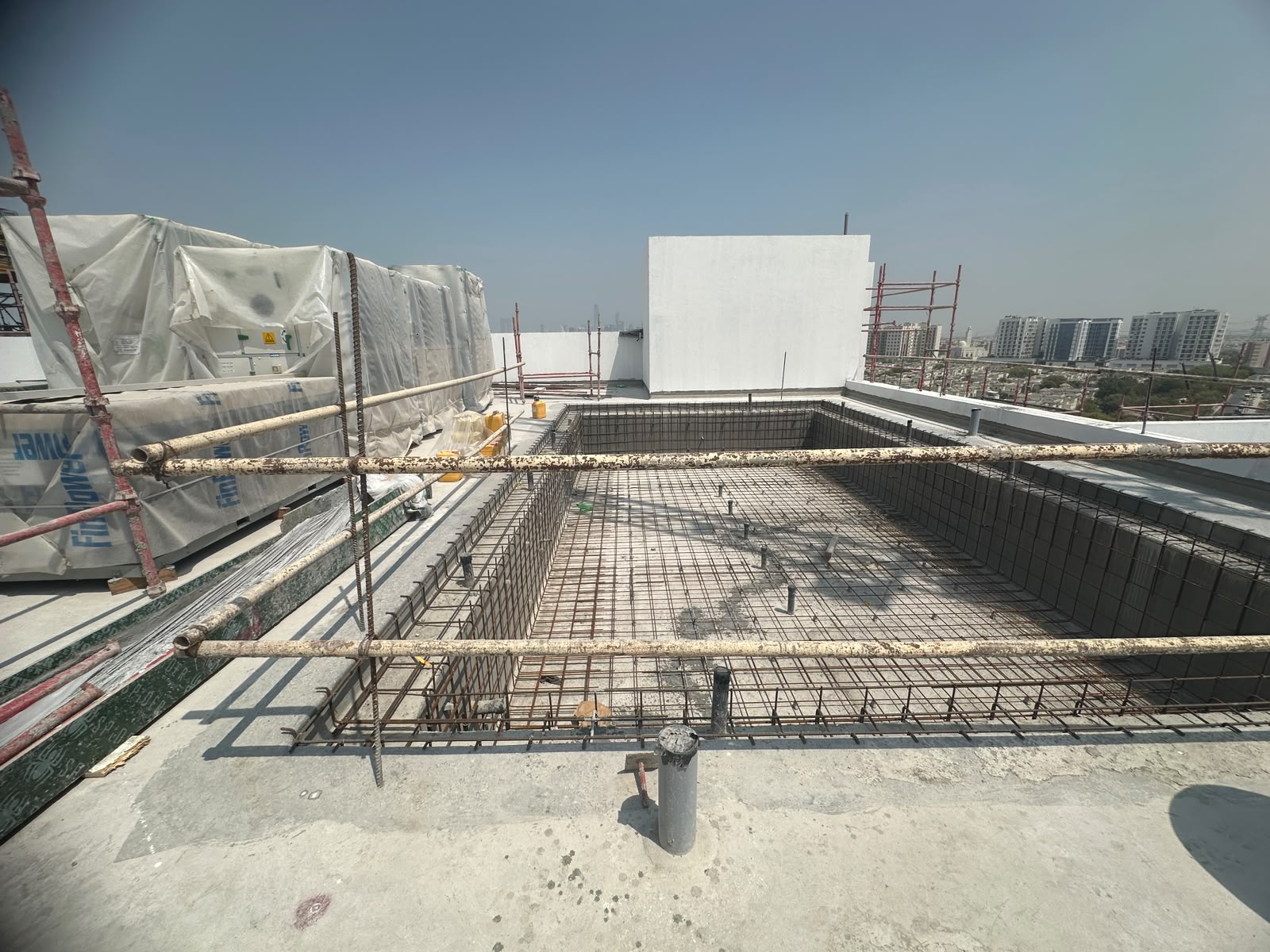

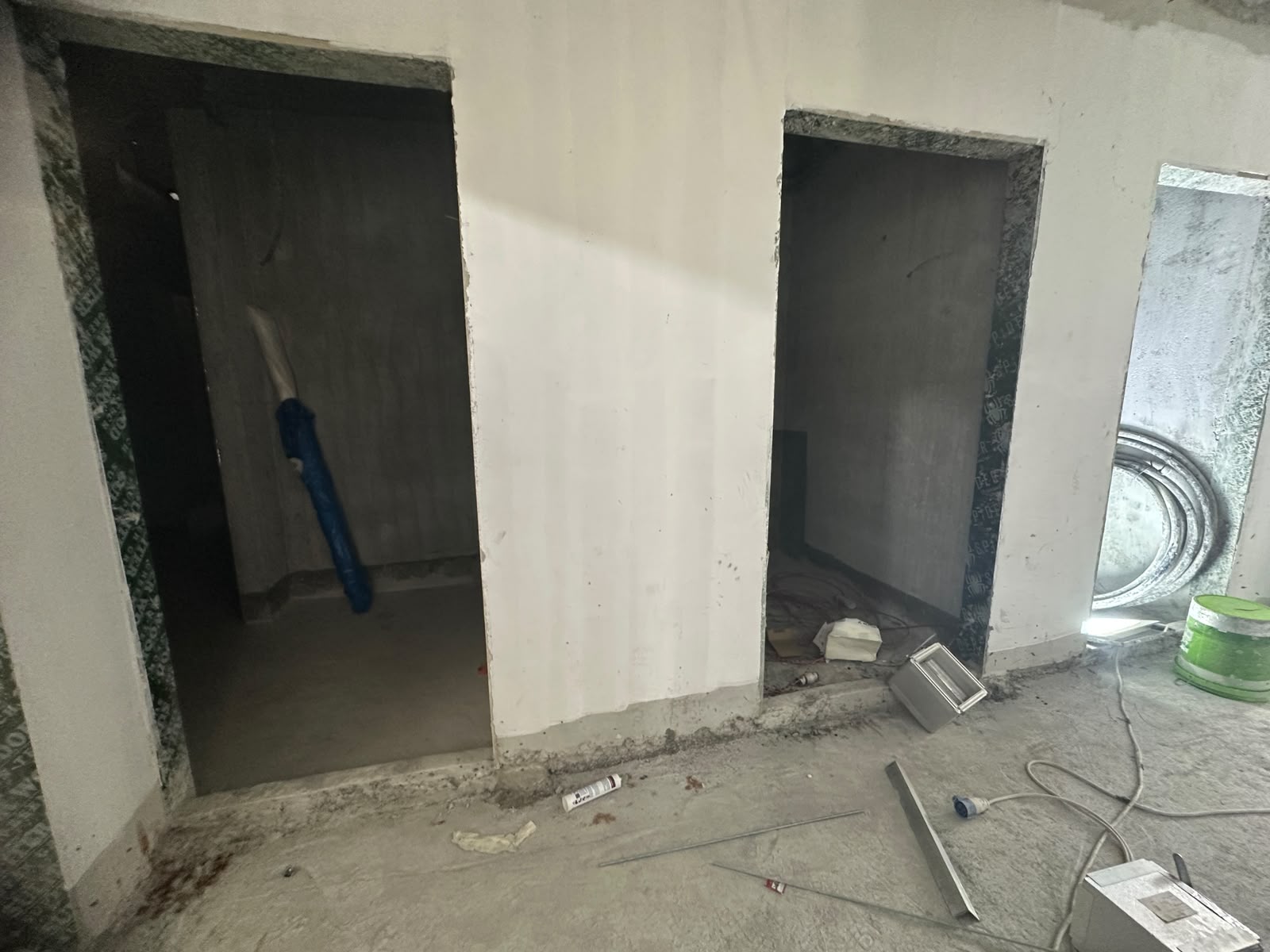

20 August 202658% built

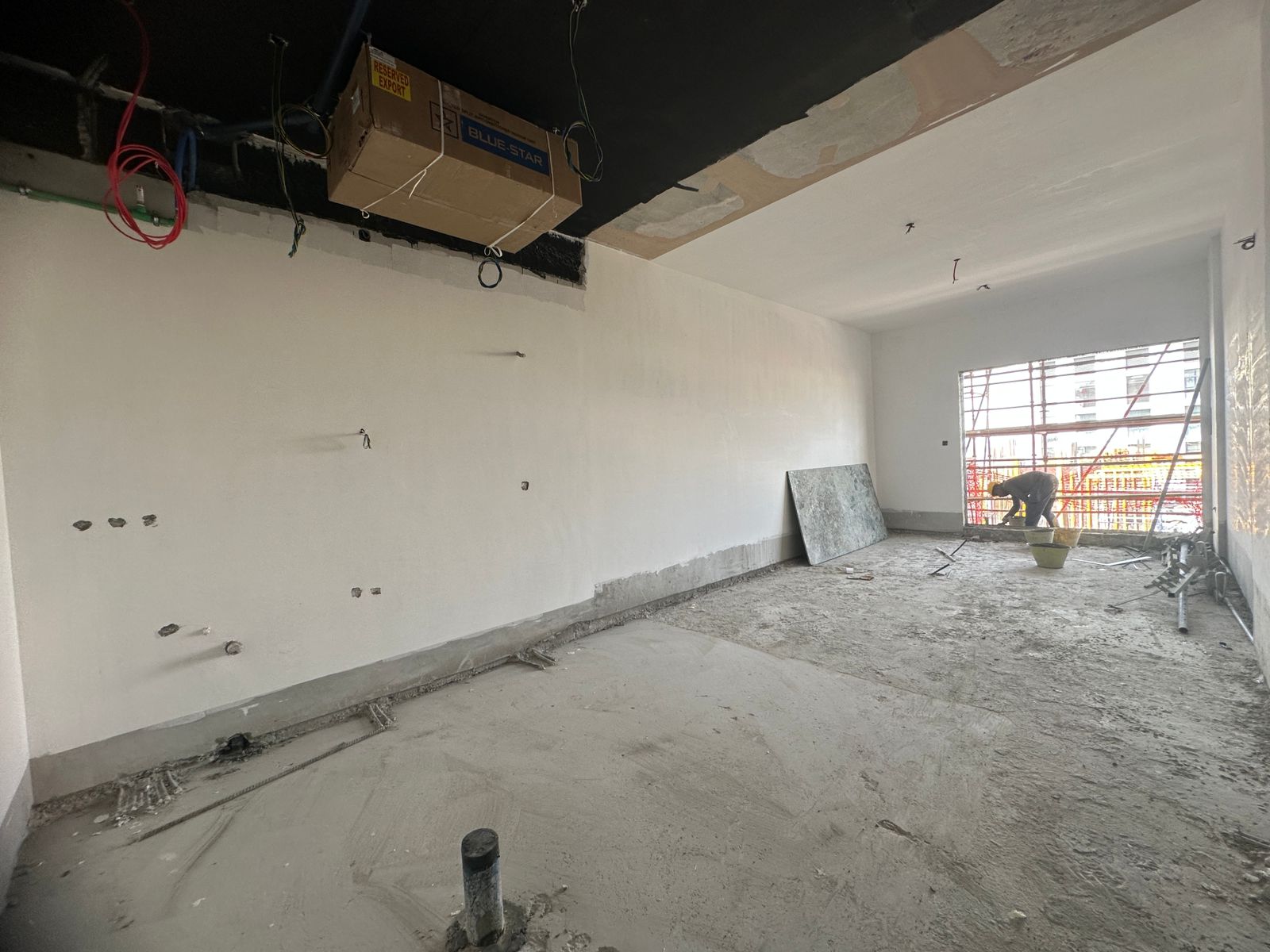

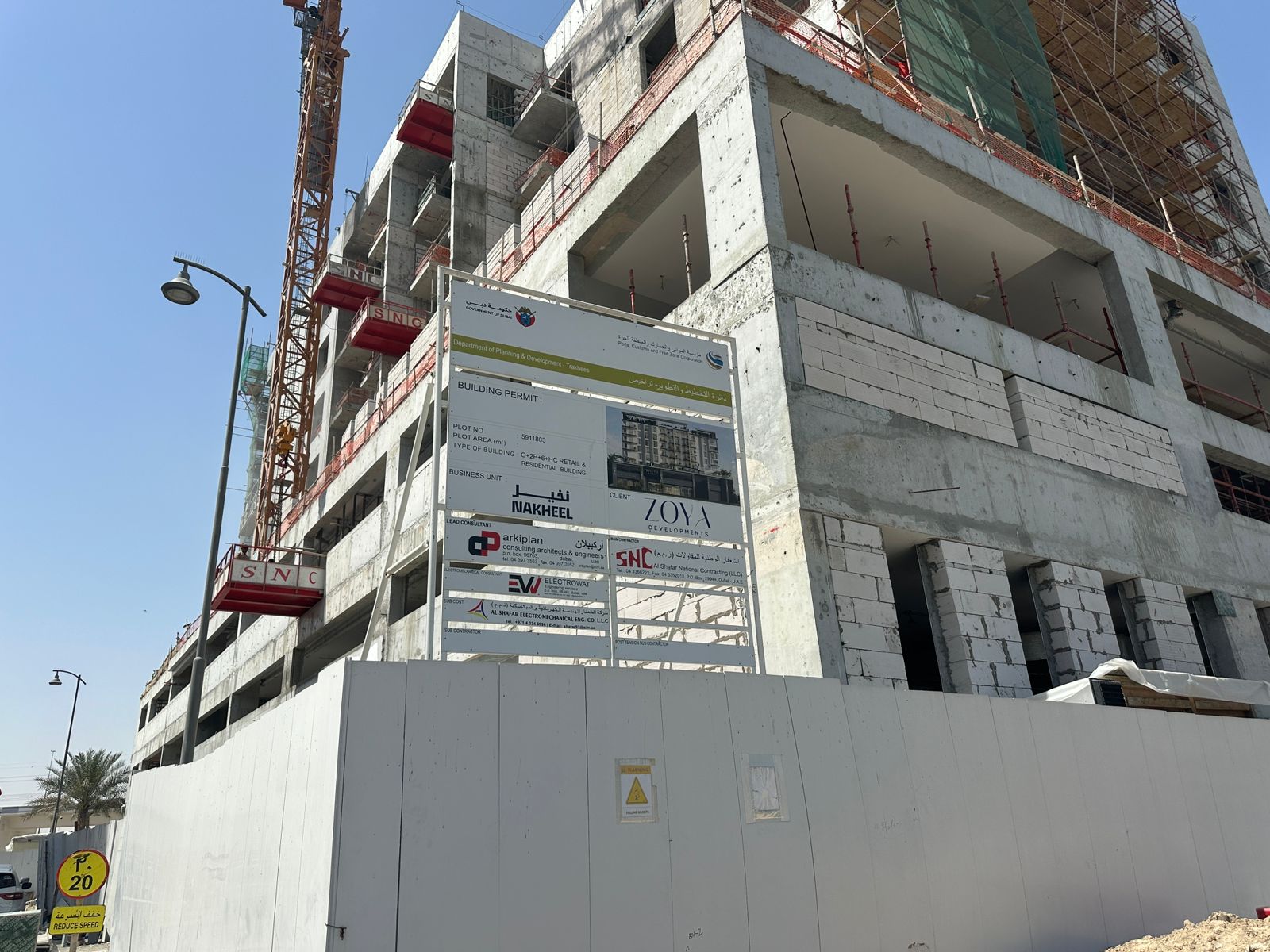

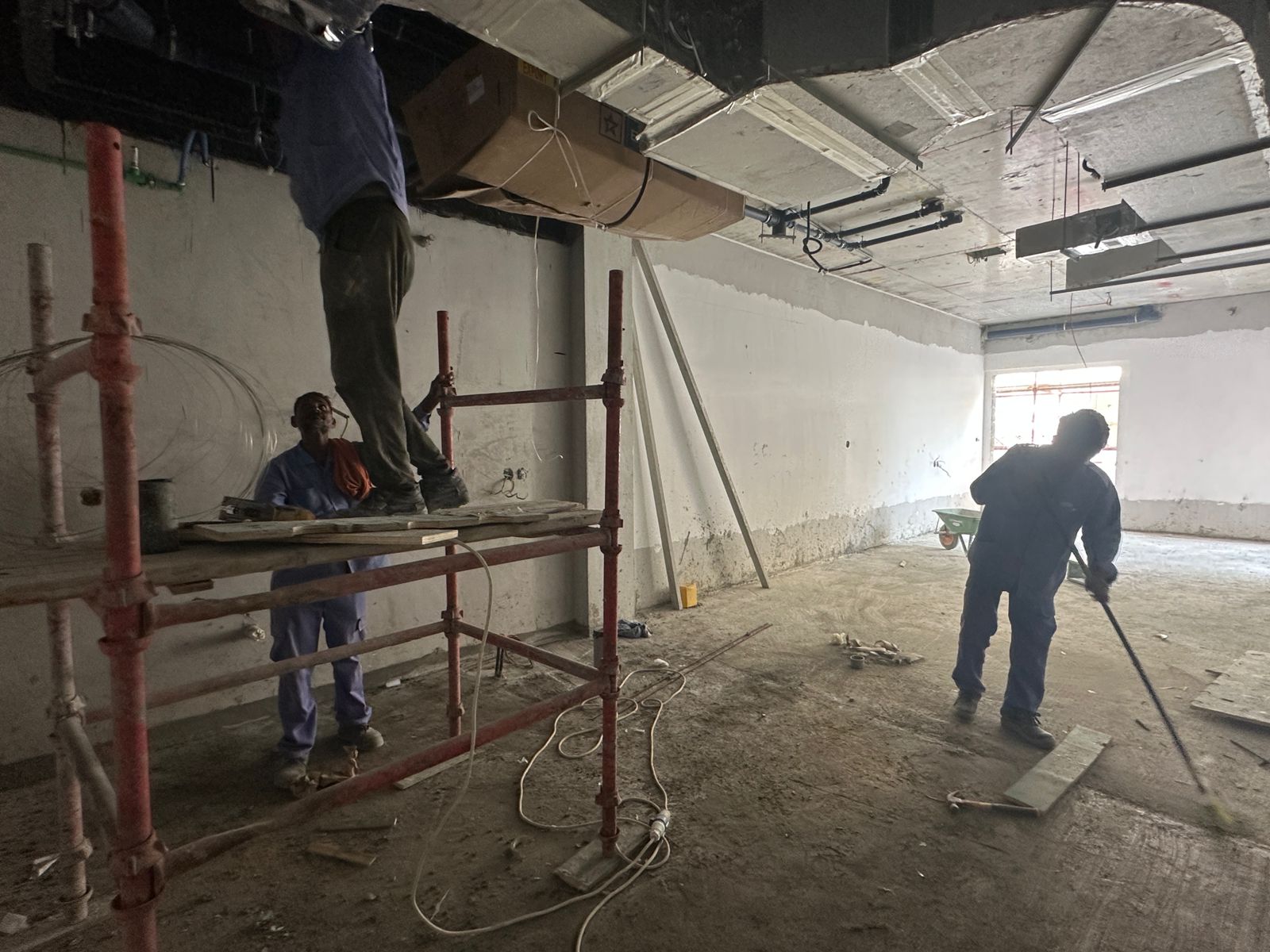

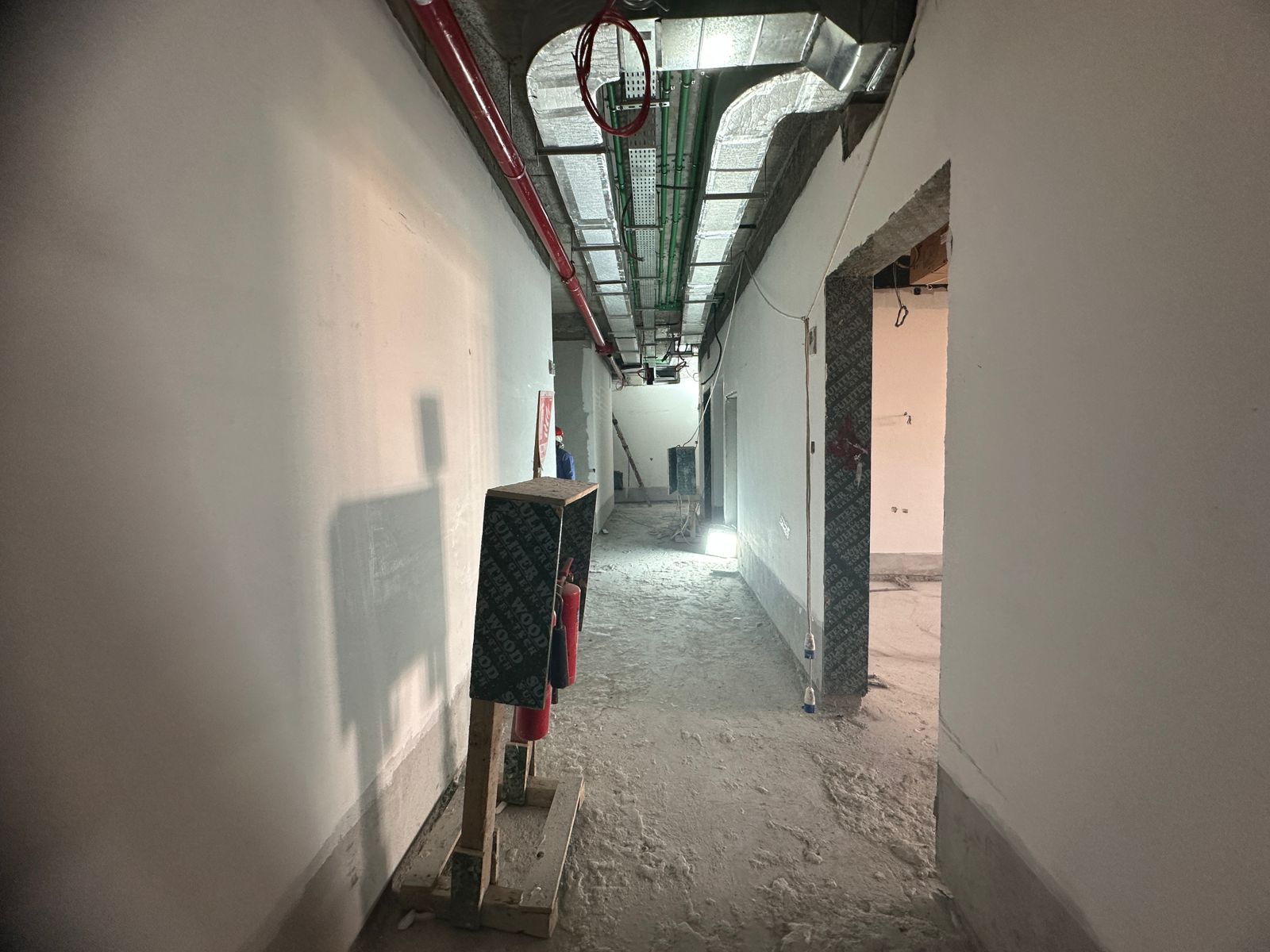

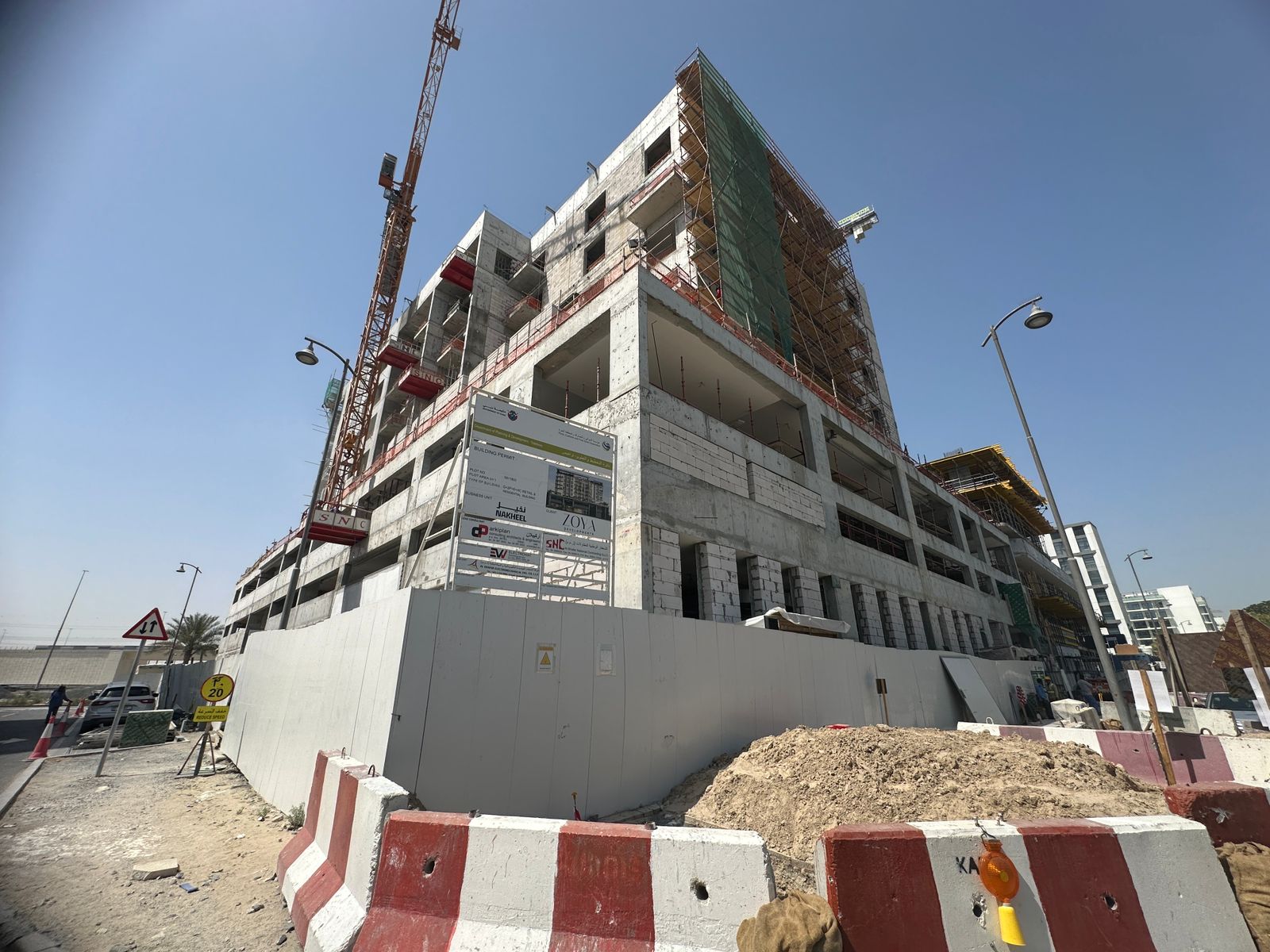

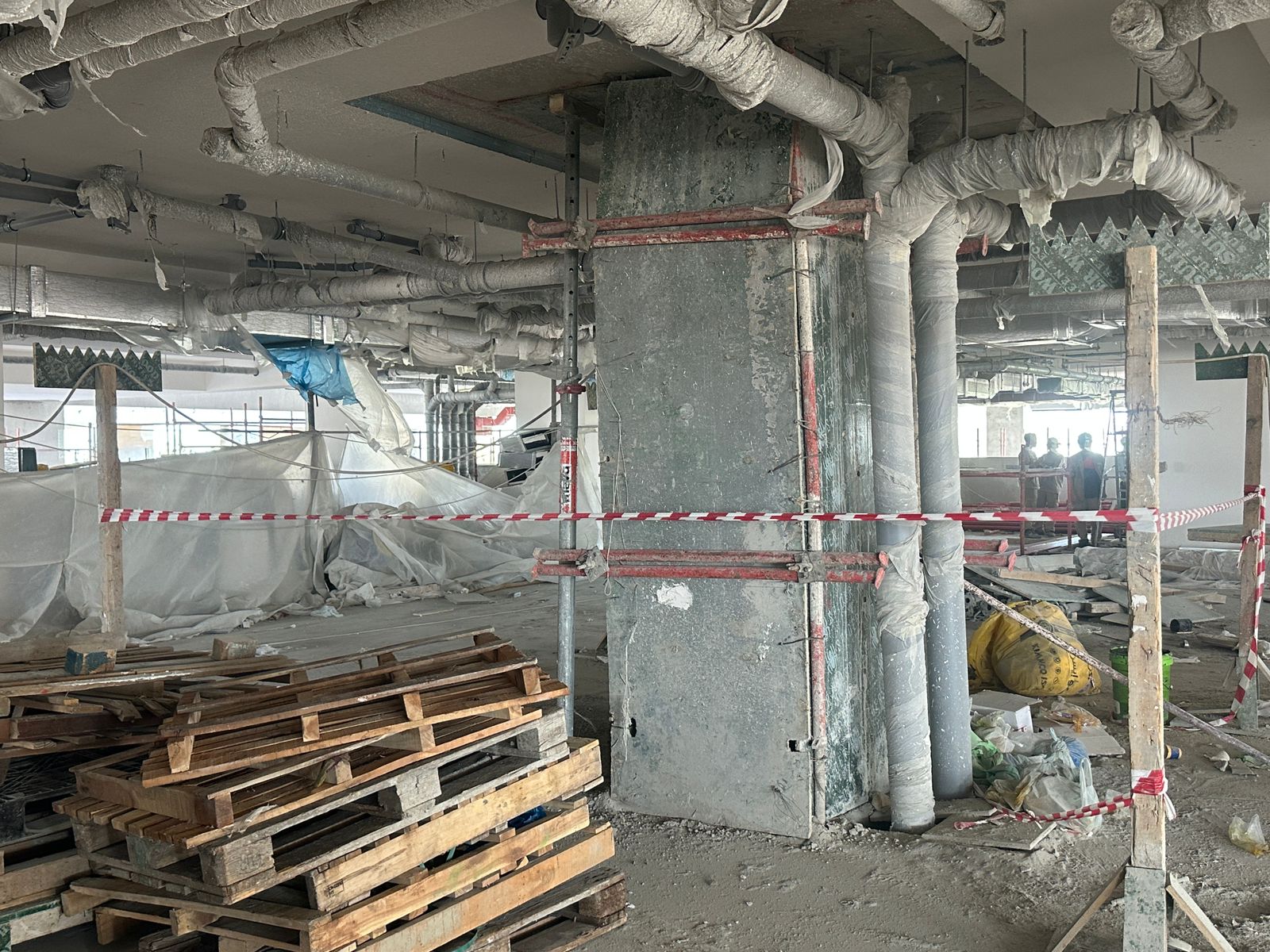

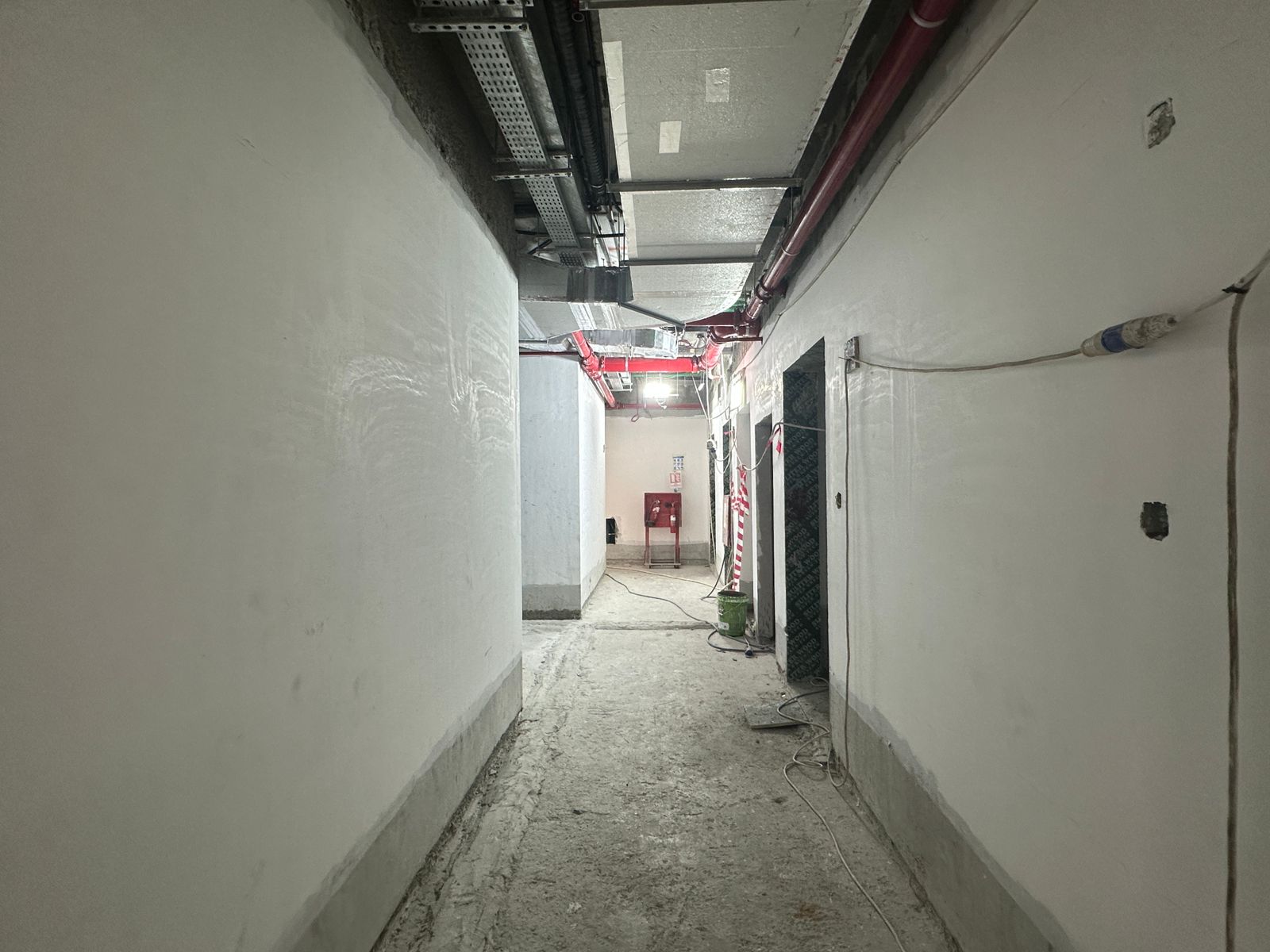

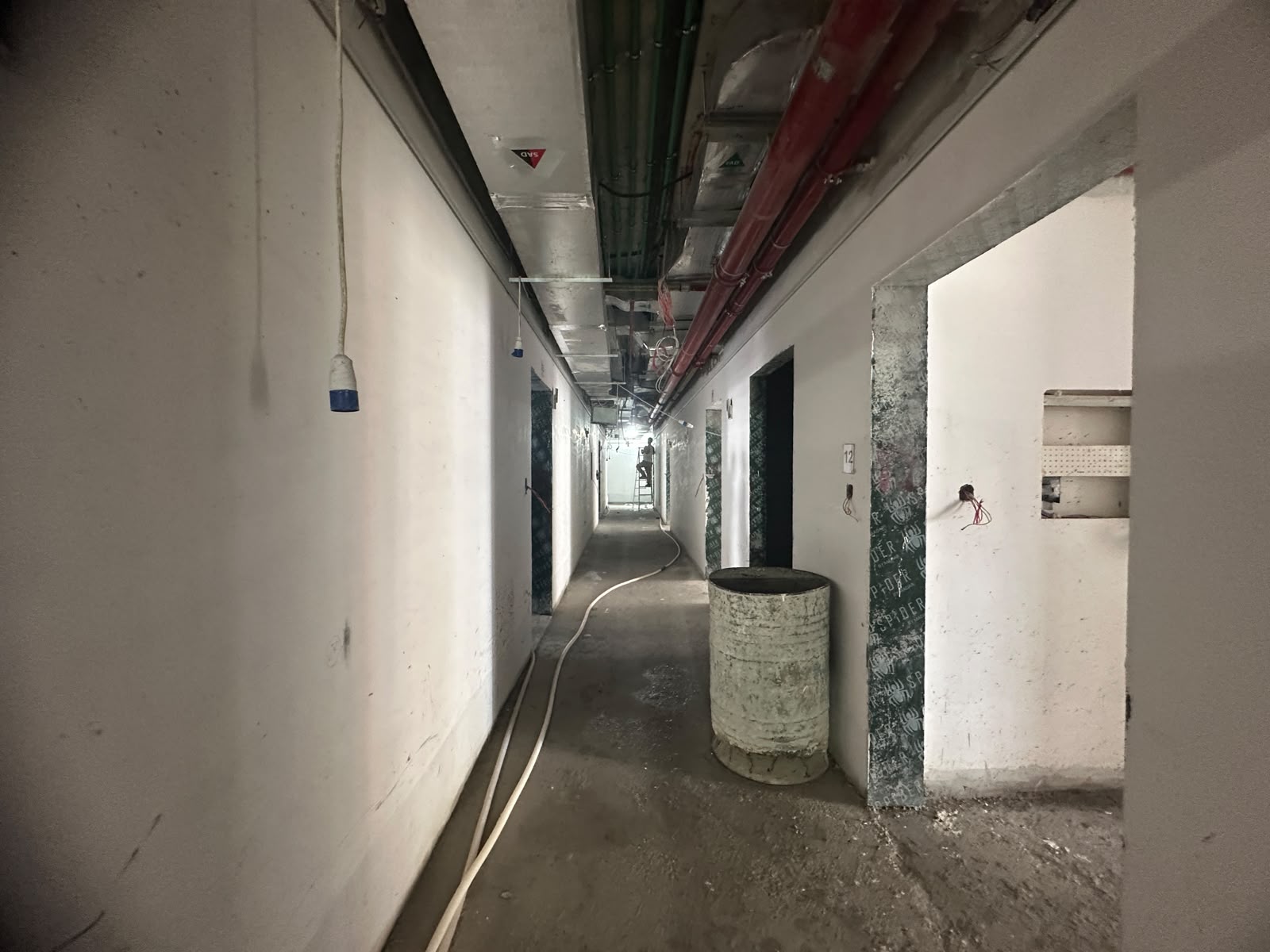

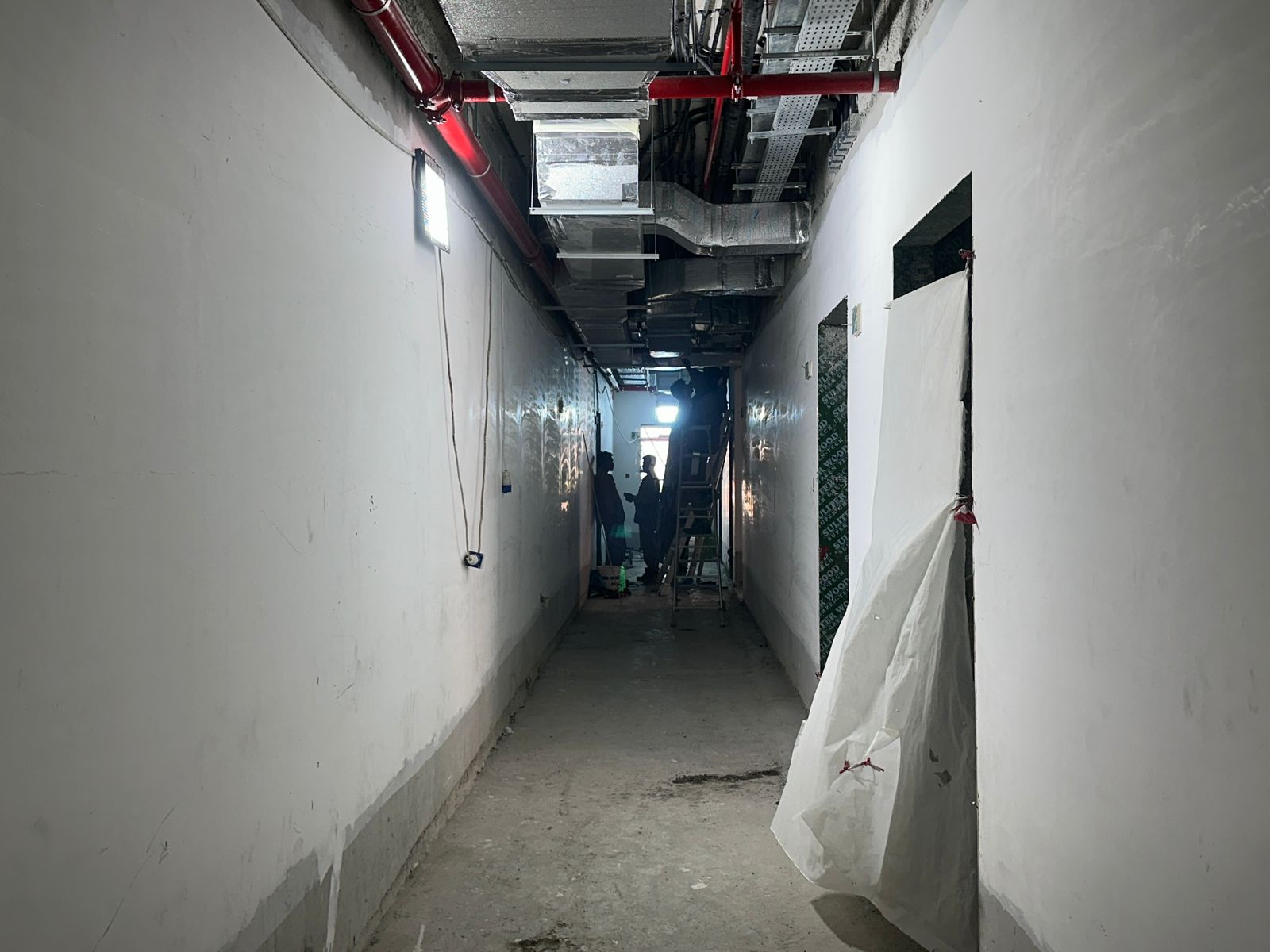

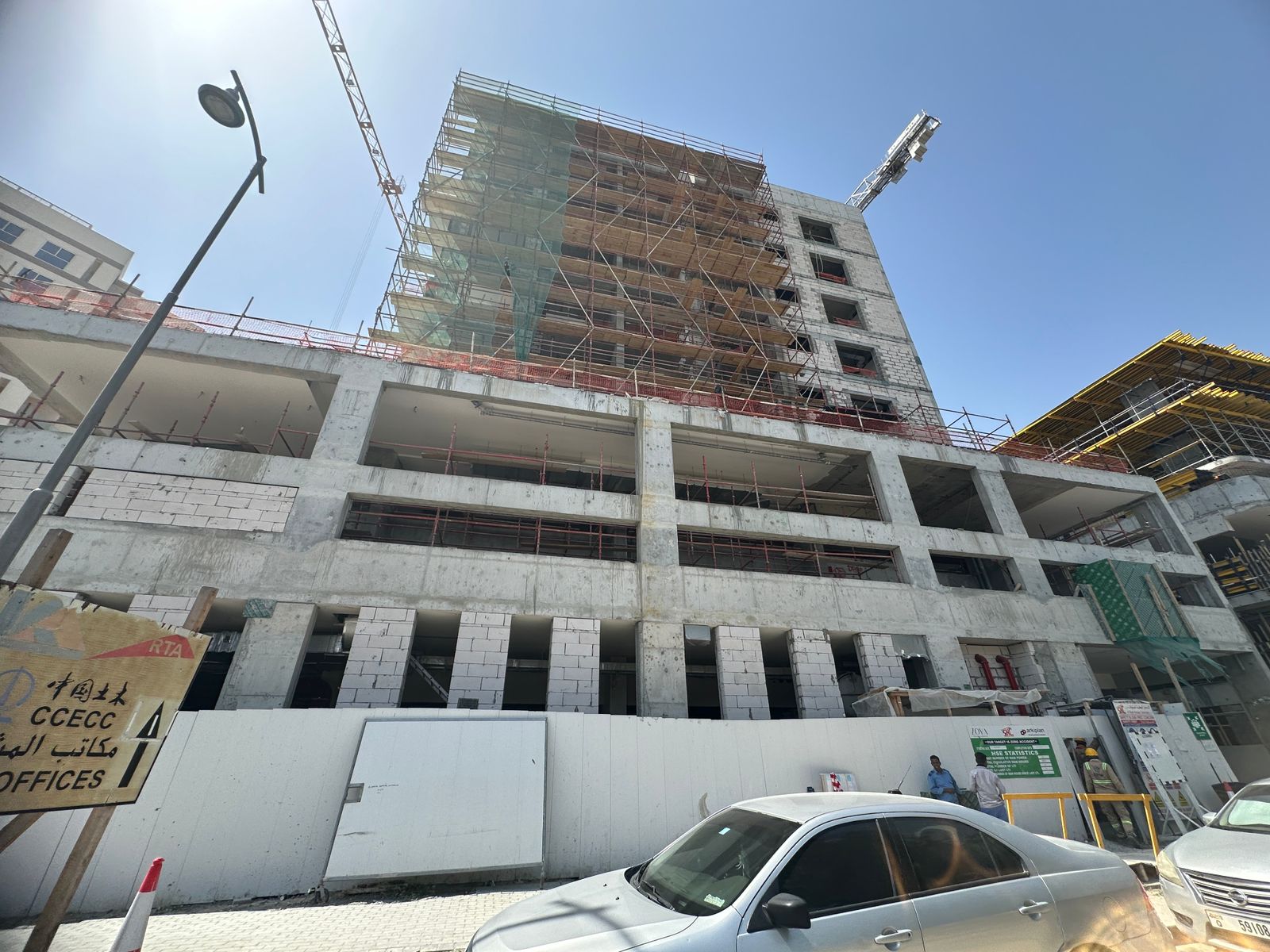

7 May 202641% built

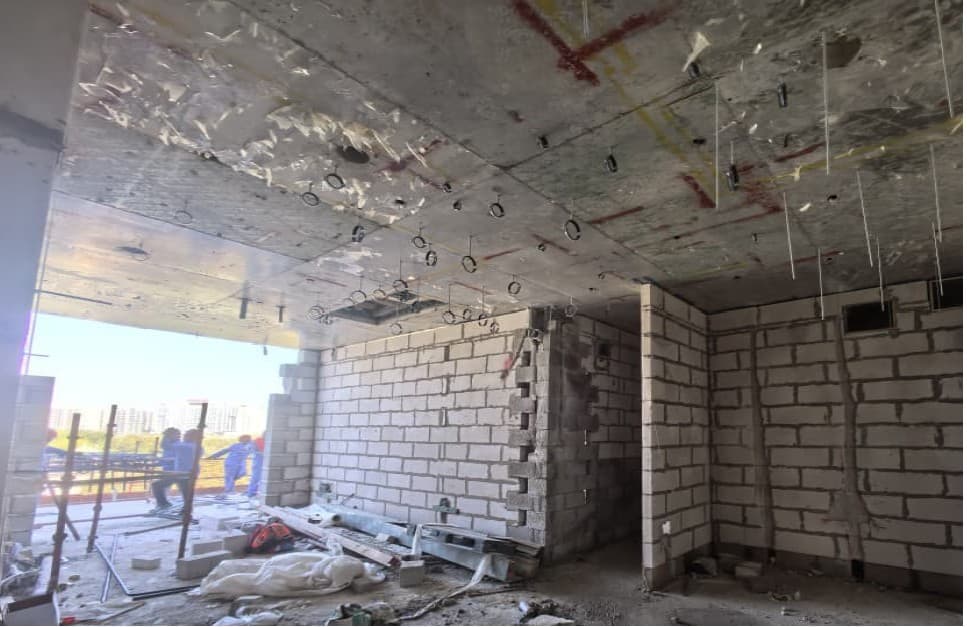

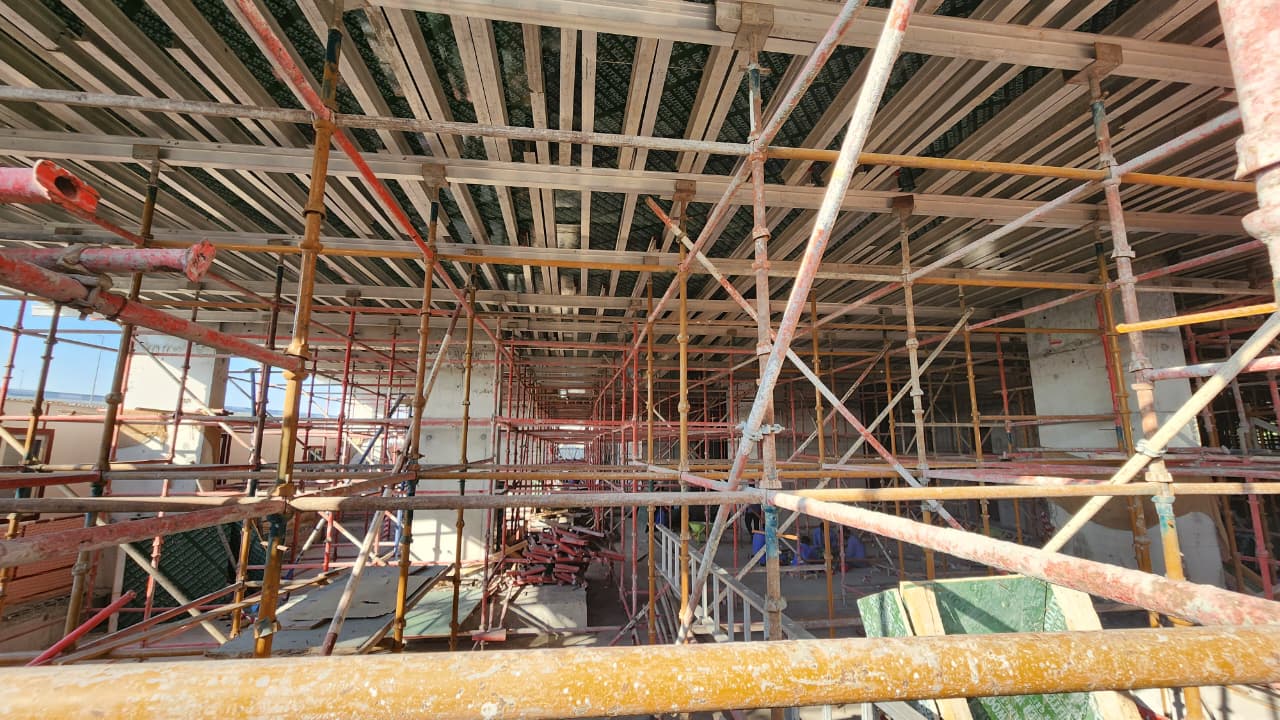

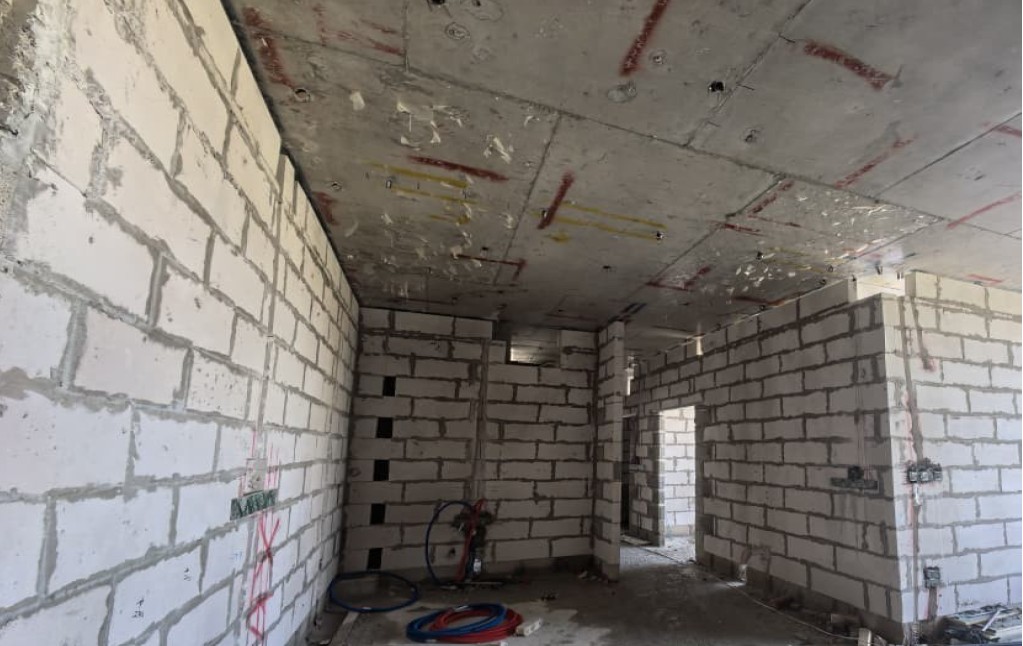

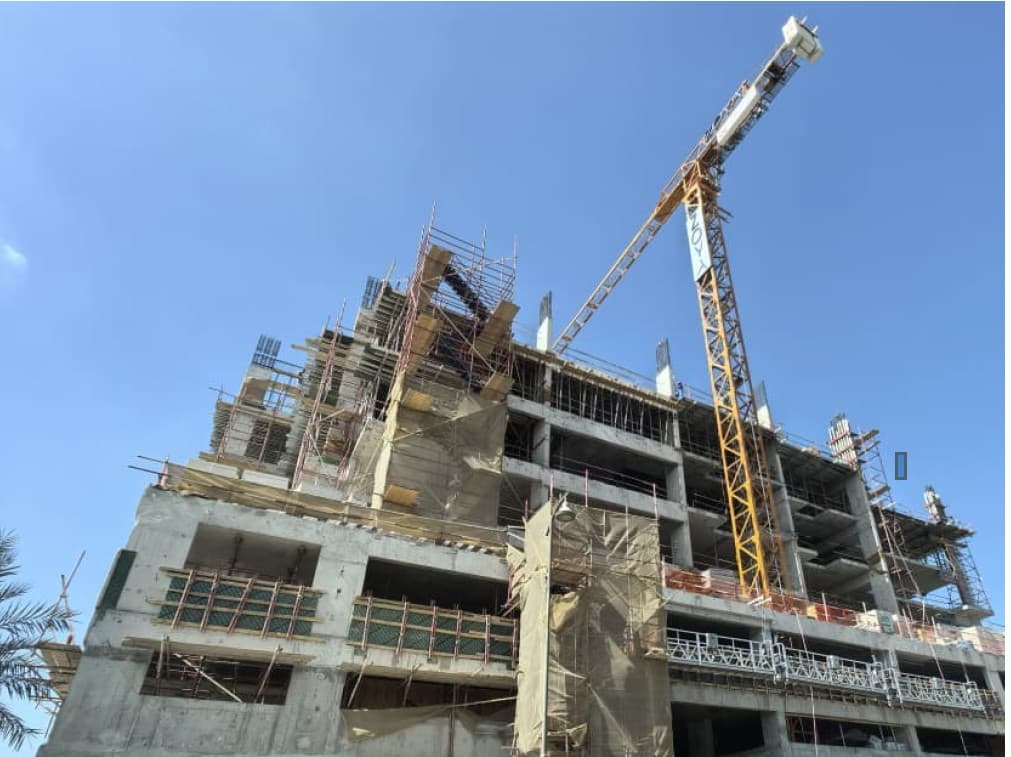

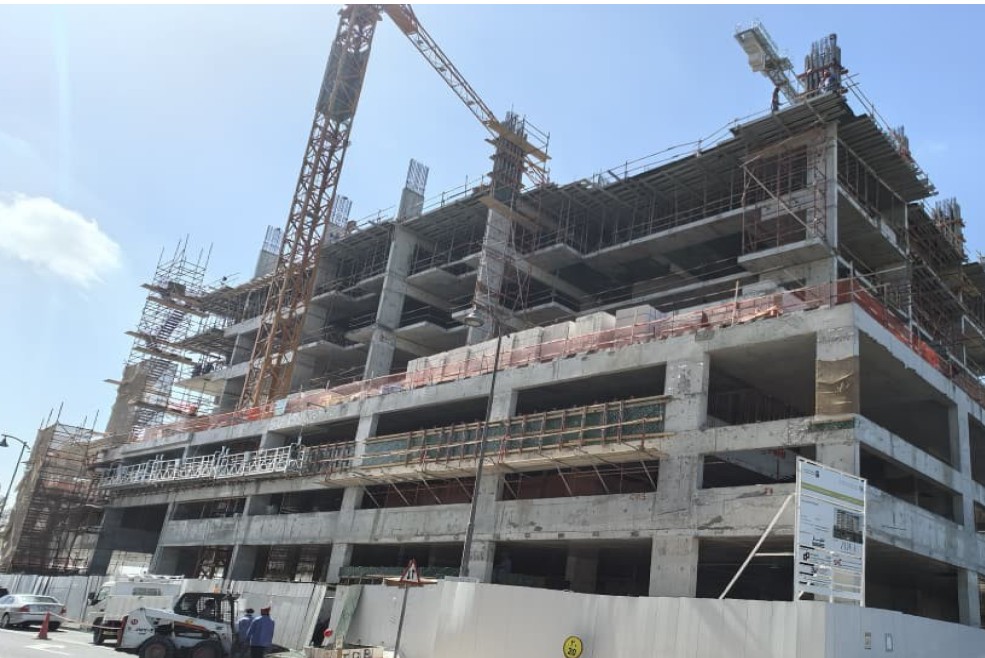

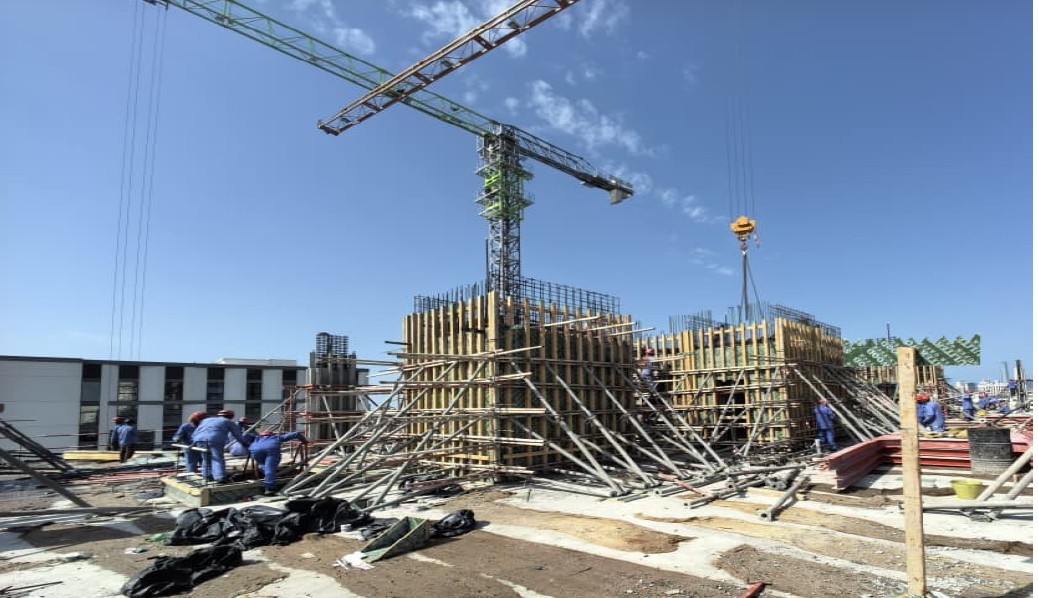

15 April 202625% built

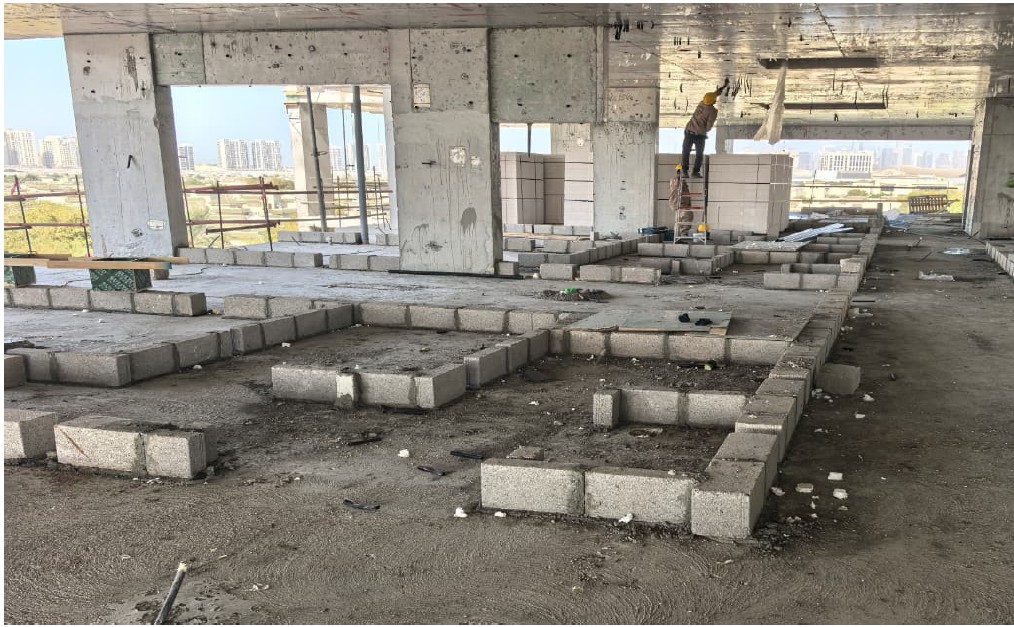

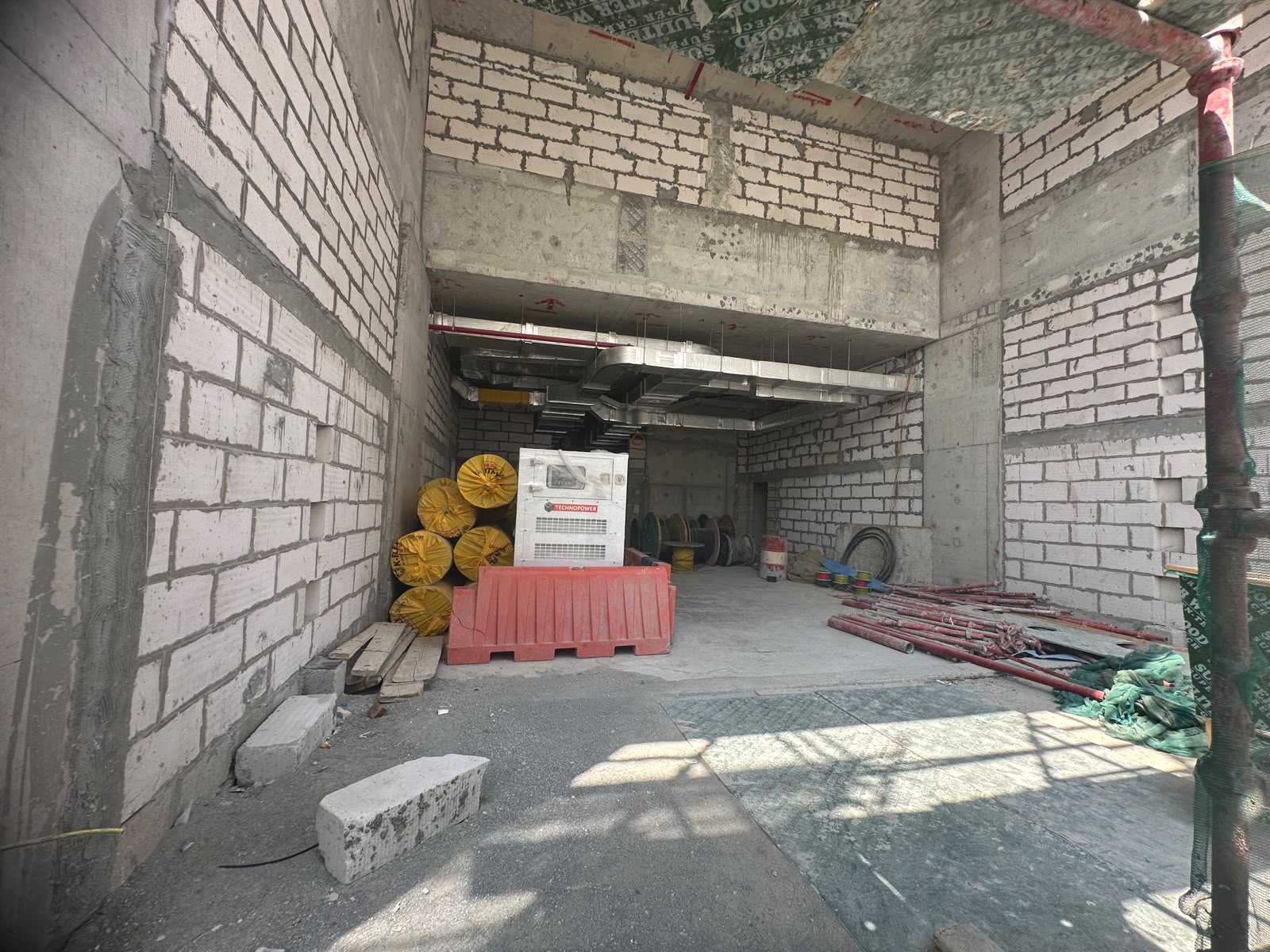

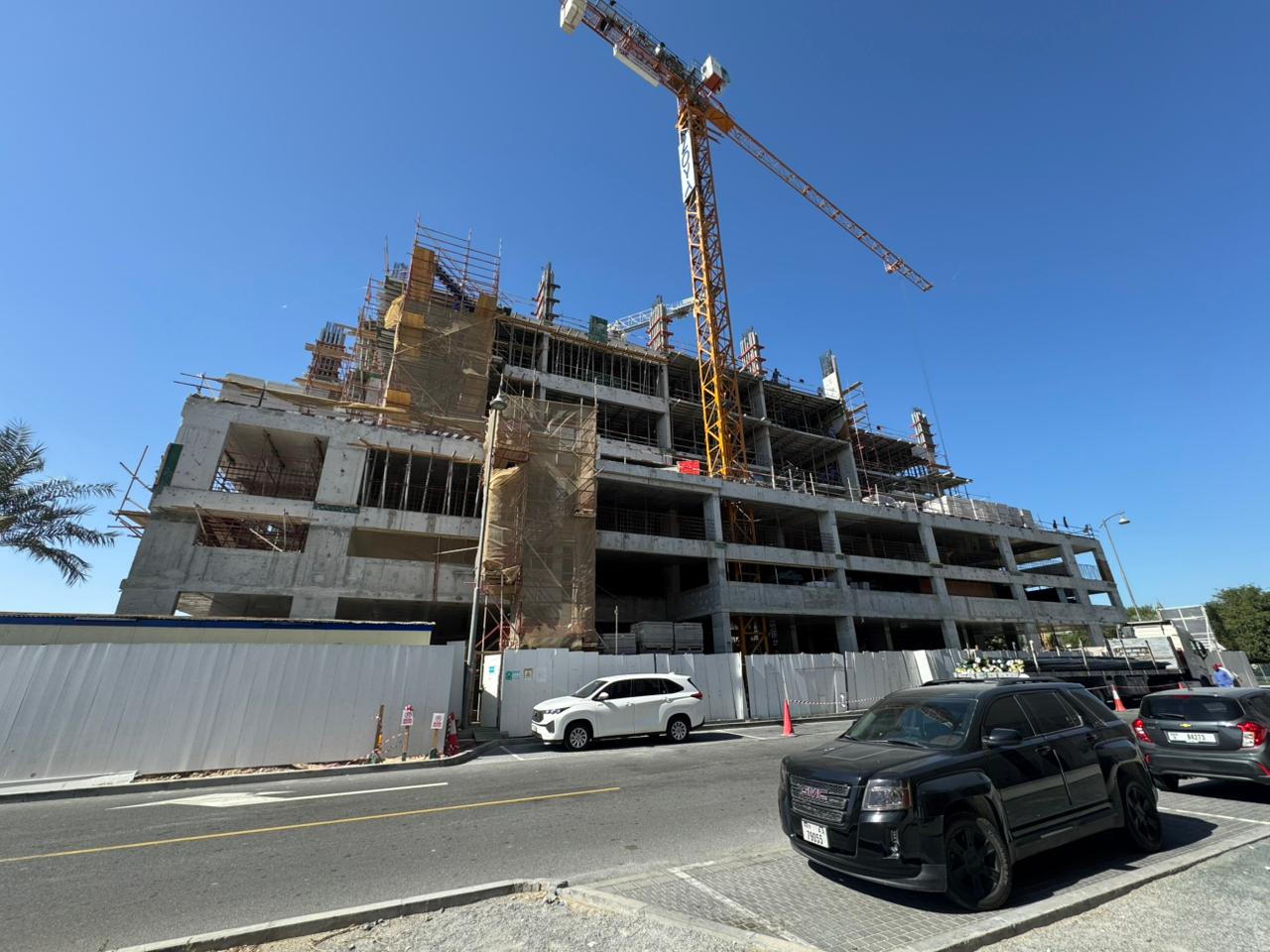

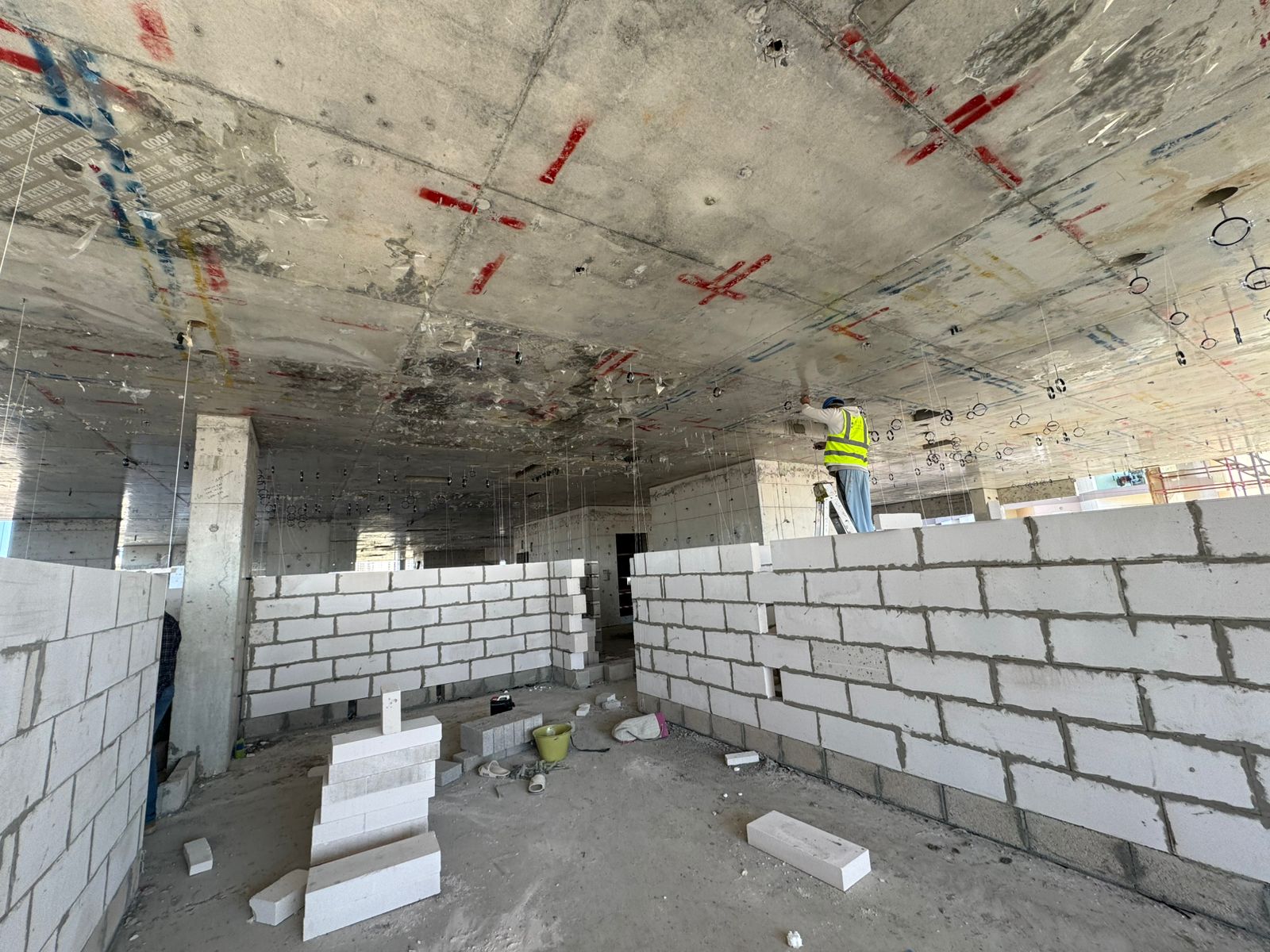

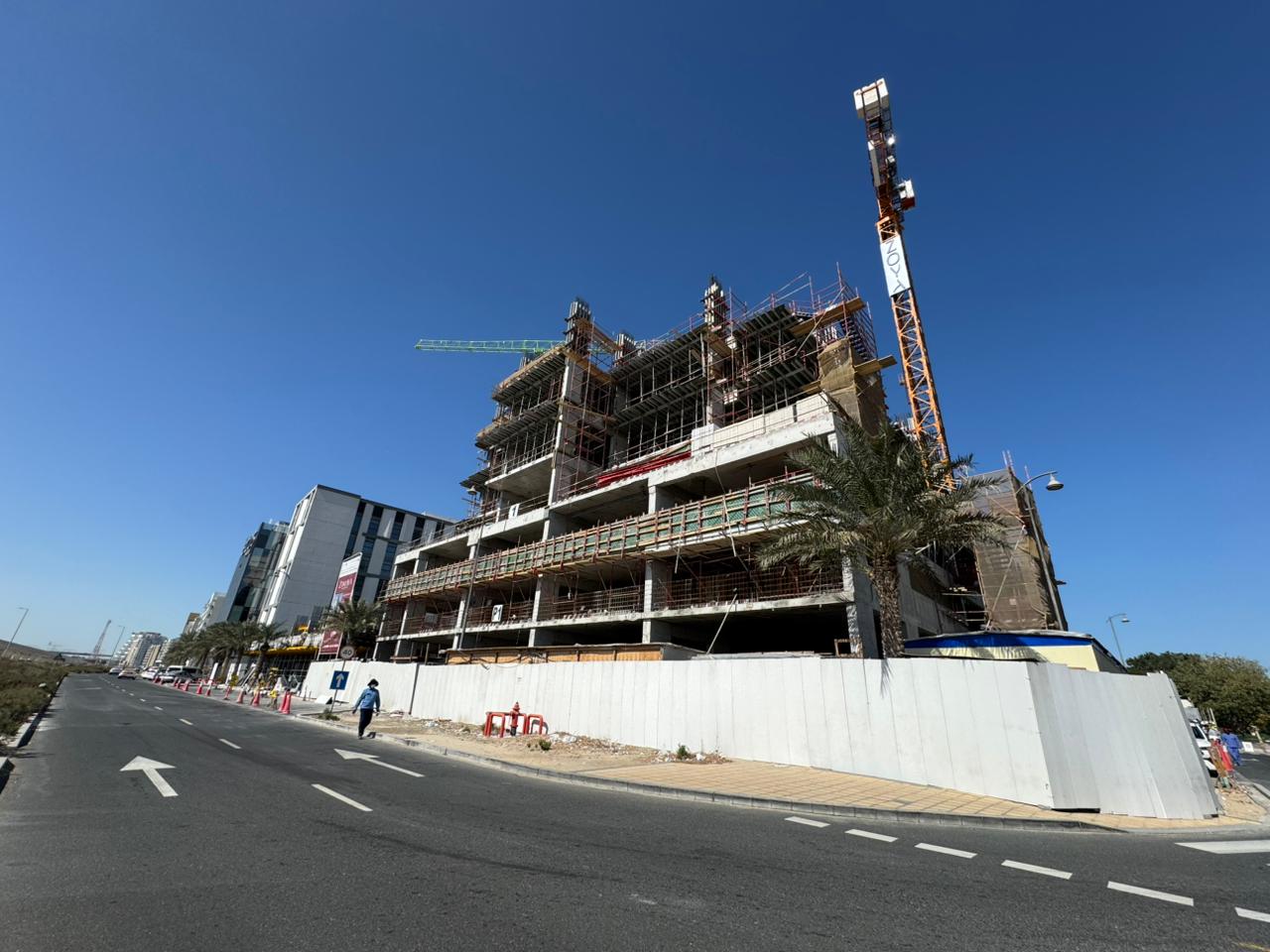

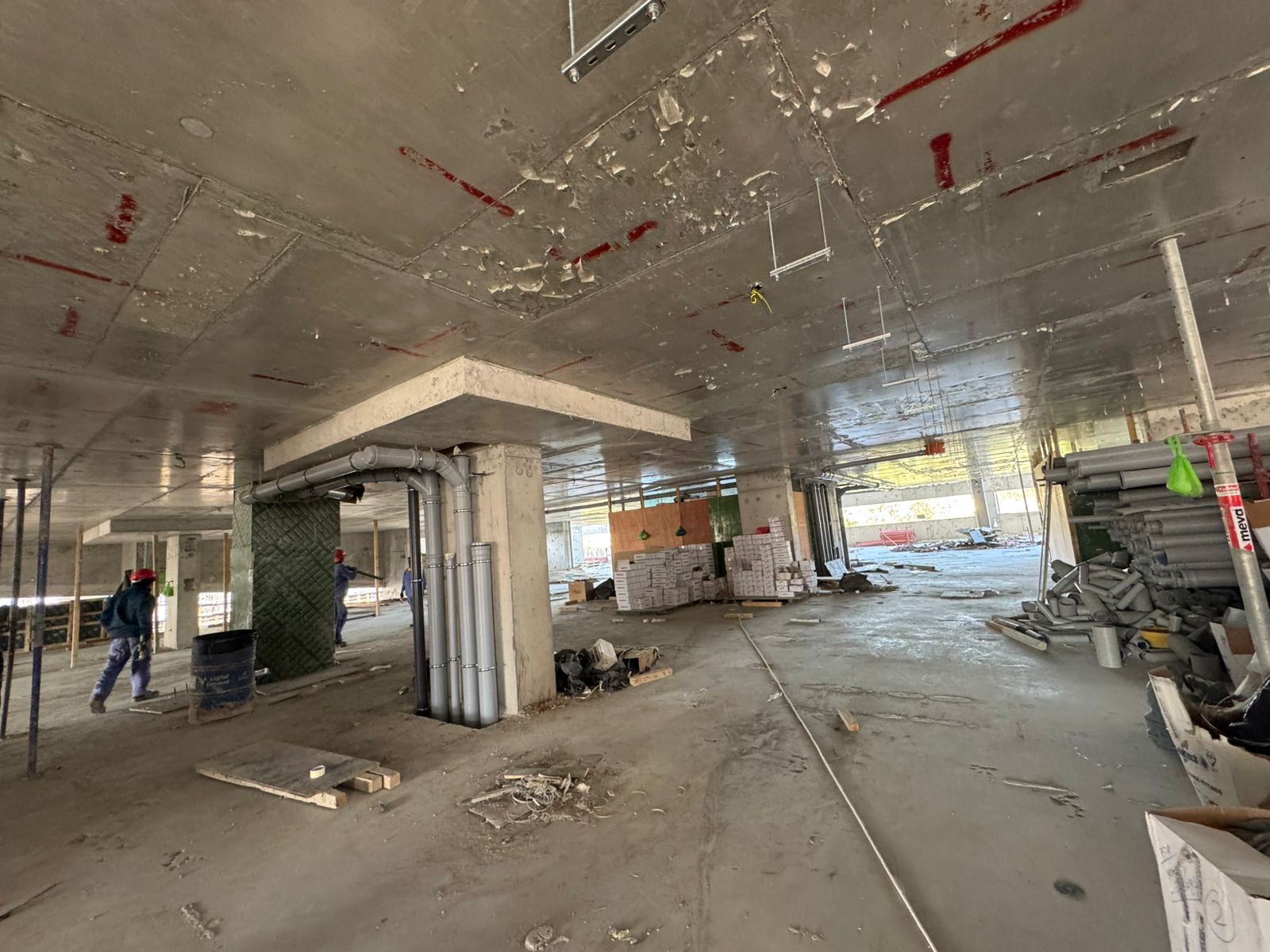

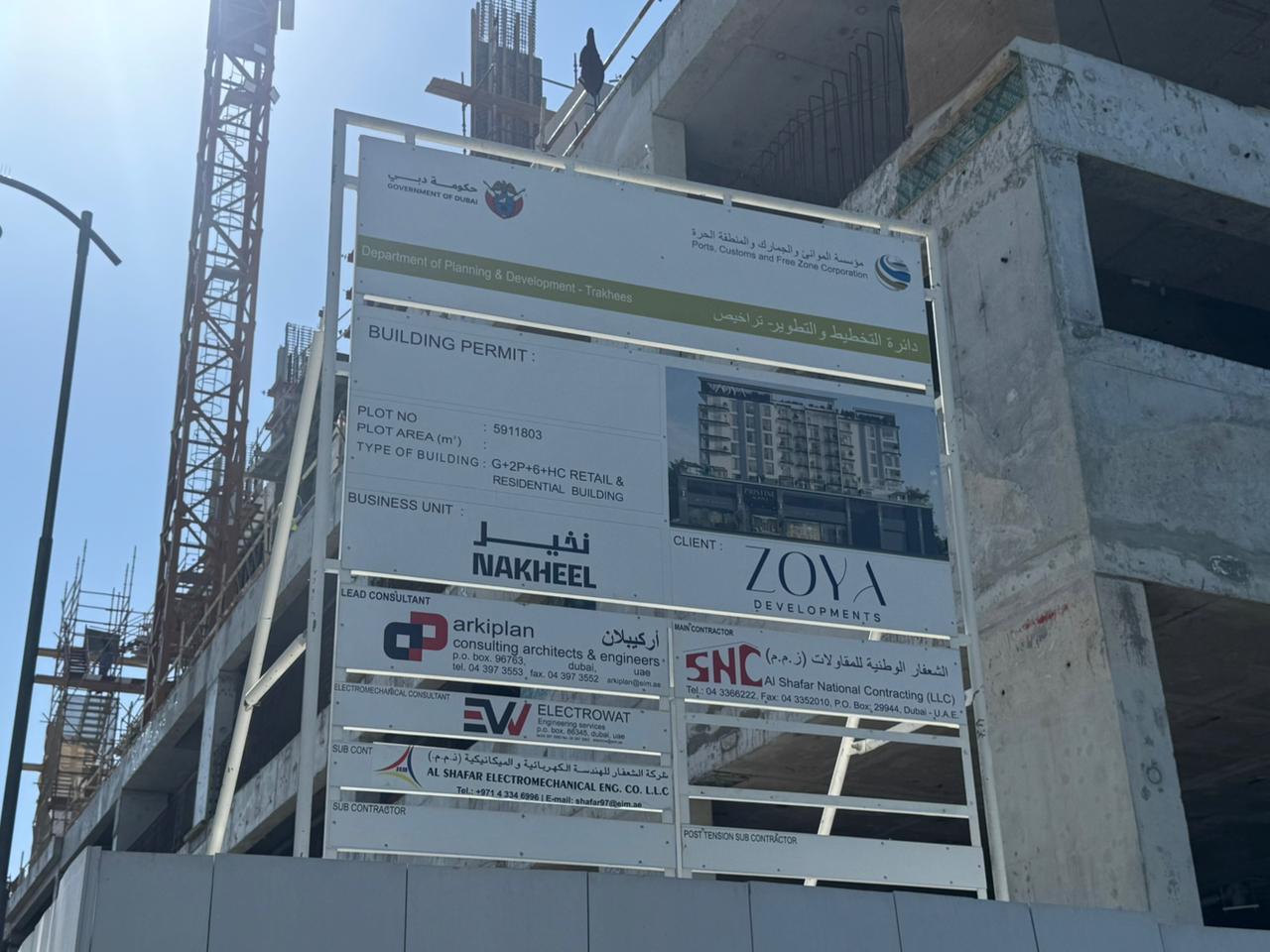

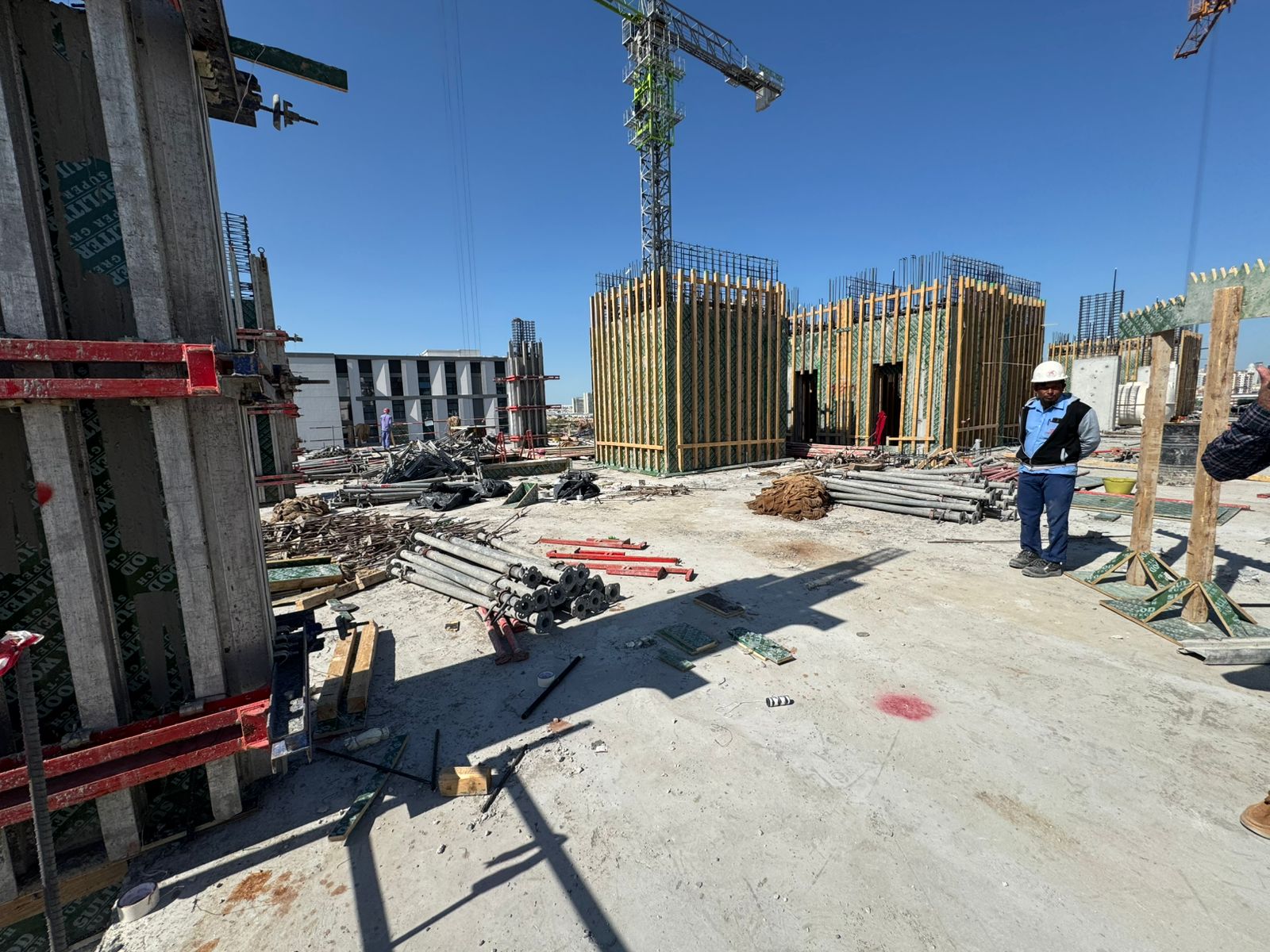

22 January 202622% built

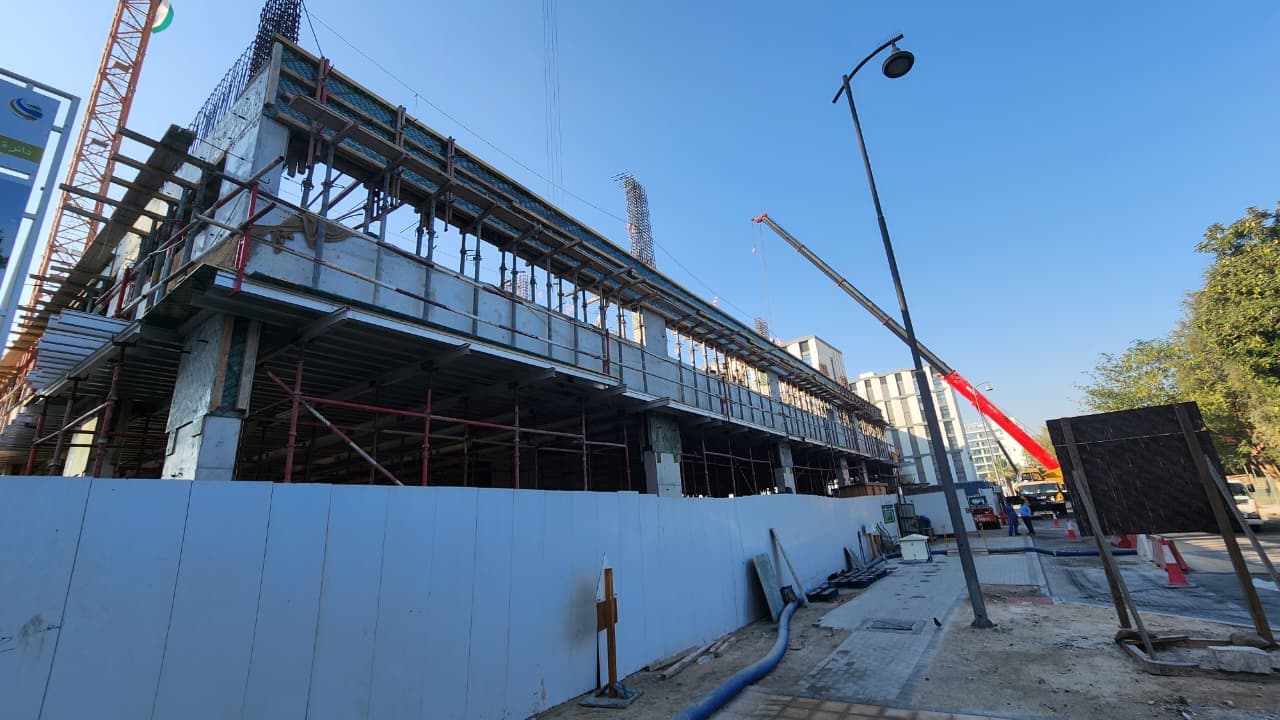

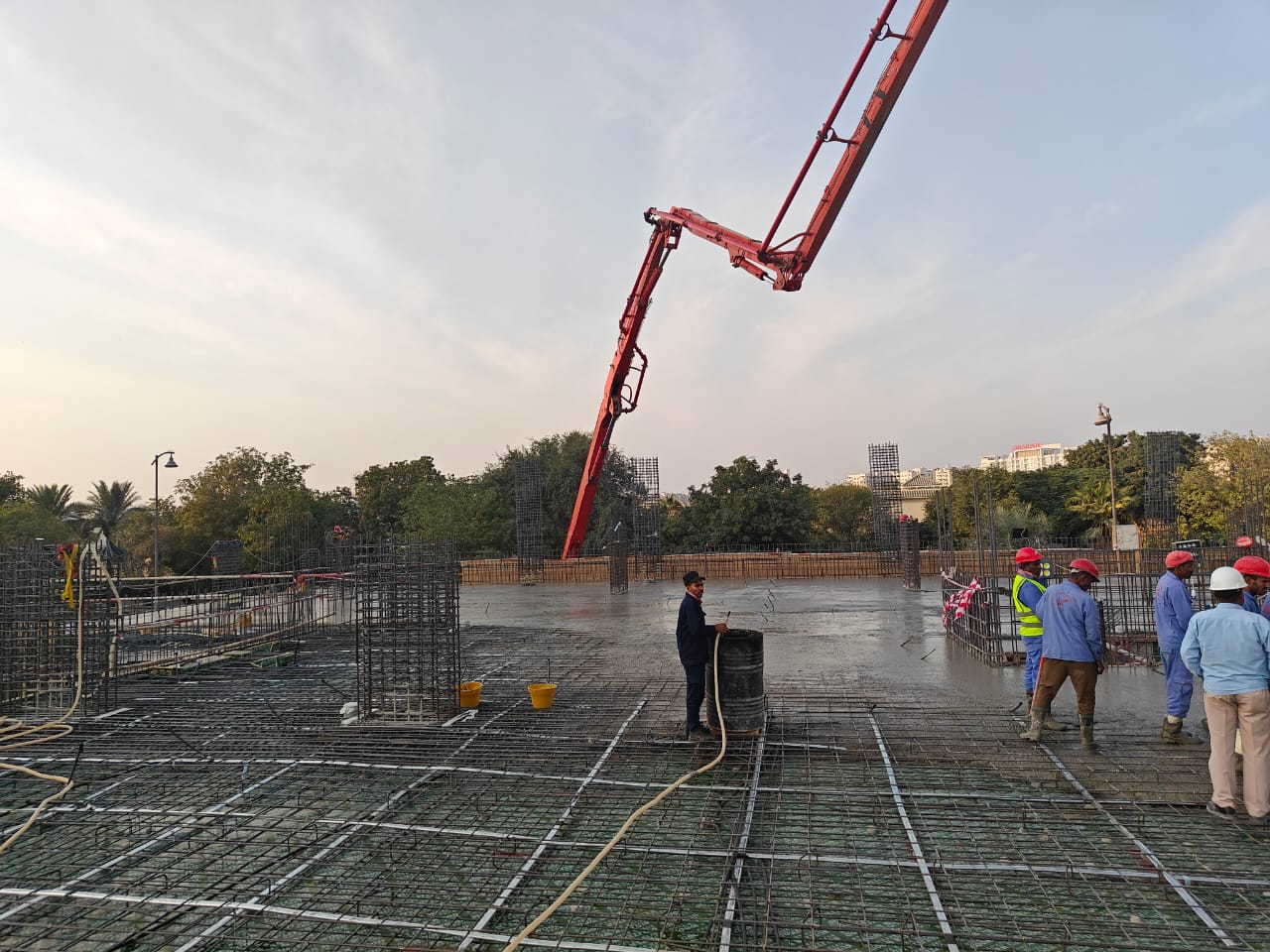

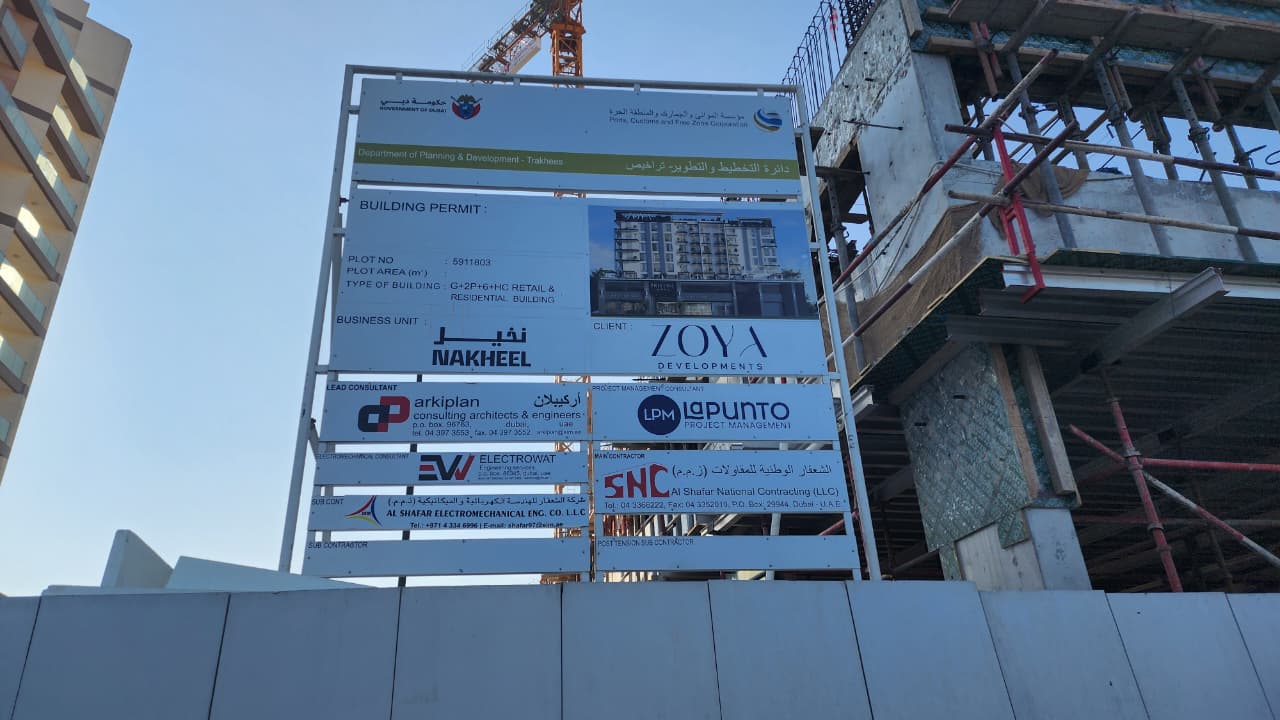

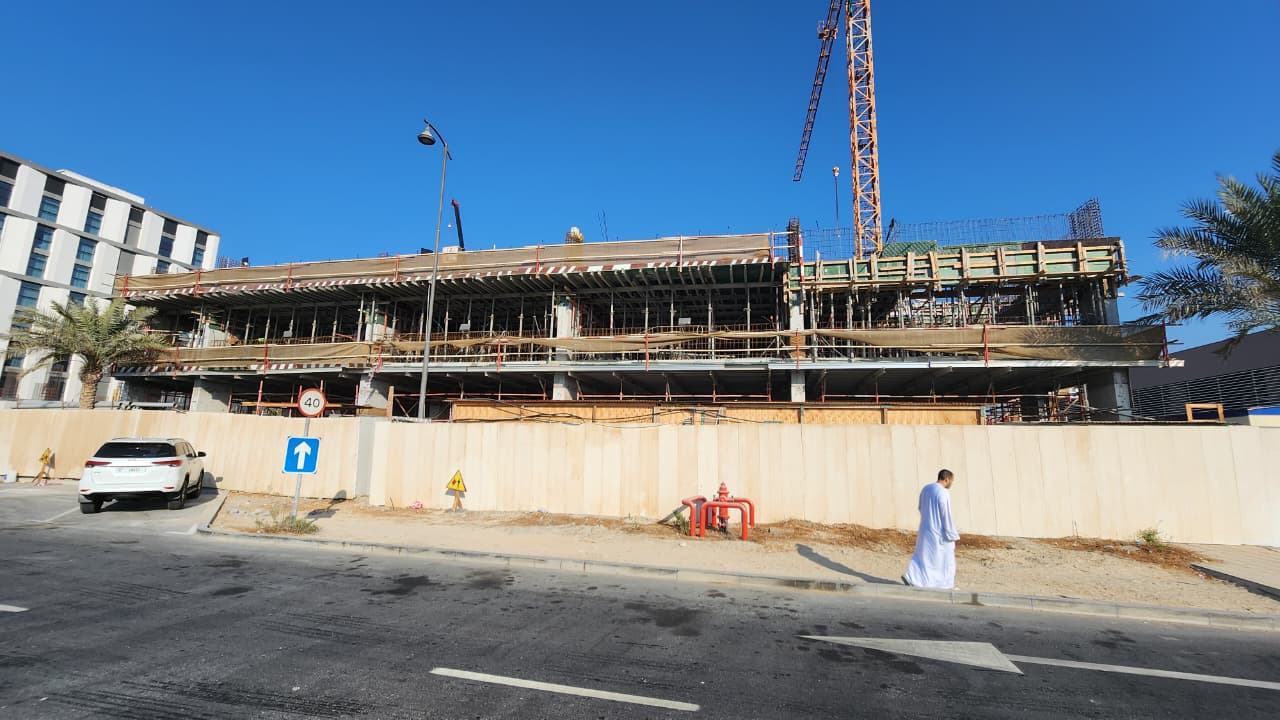

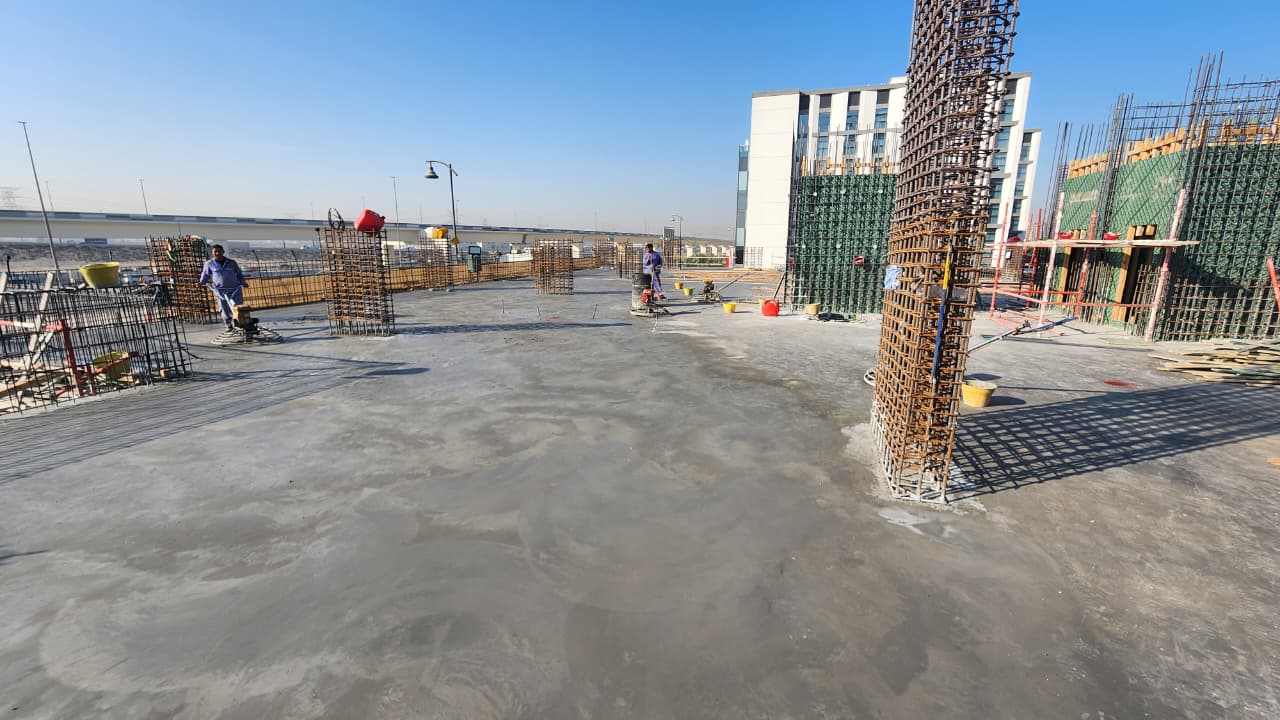

26 November 202513% built

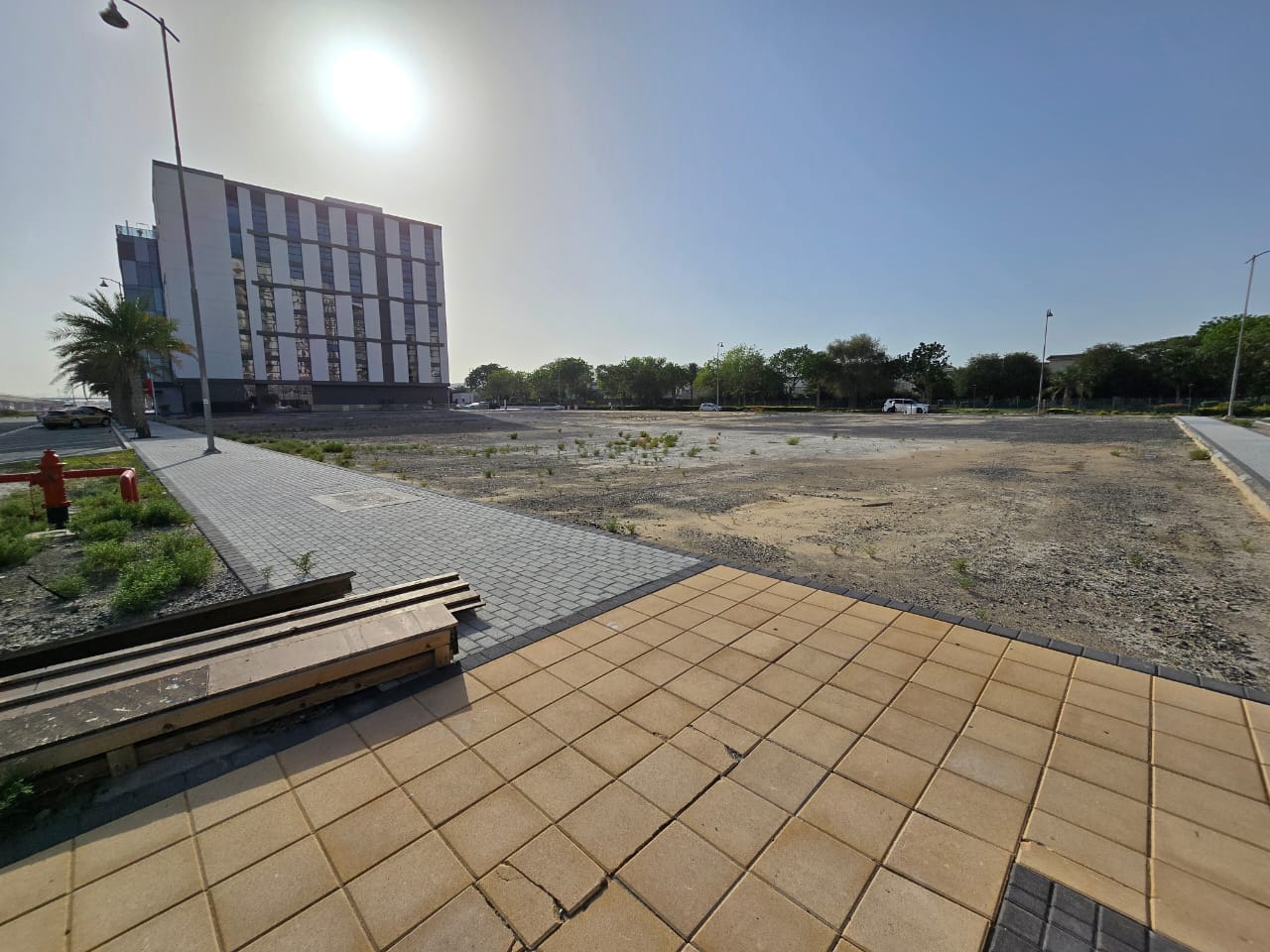

1 July 20250% built

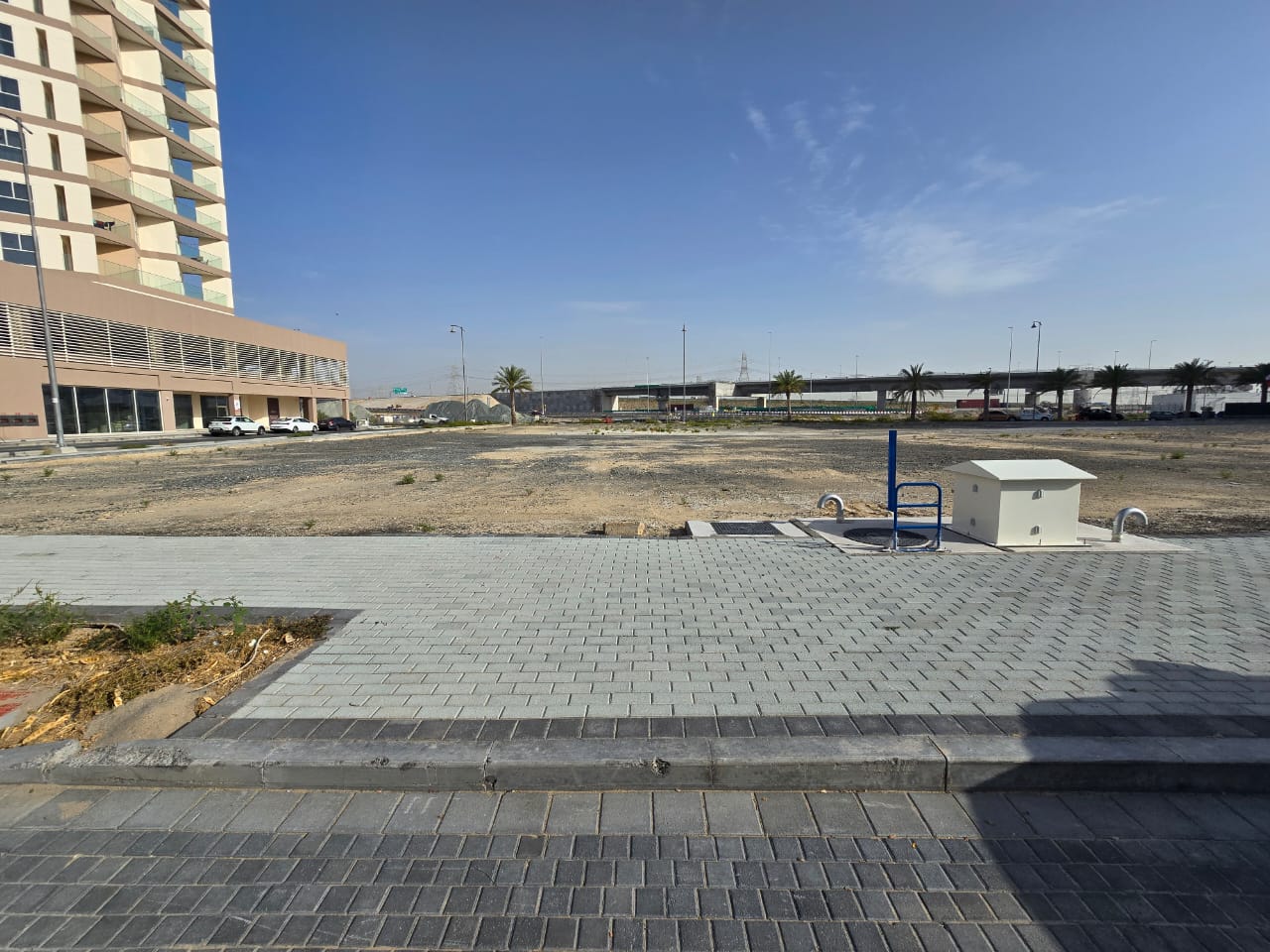

23 May 20240% built
All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
