The Oasis - Palmiera construction photos

69 photos taken by Dubai Land Department engineers at 8 site inspections, newest first. The percentage is how much of The Oasis - Palmiera was built on the day of each visit.

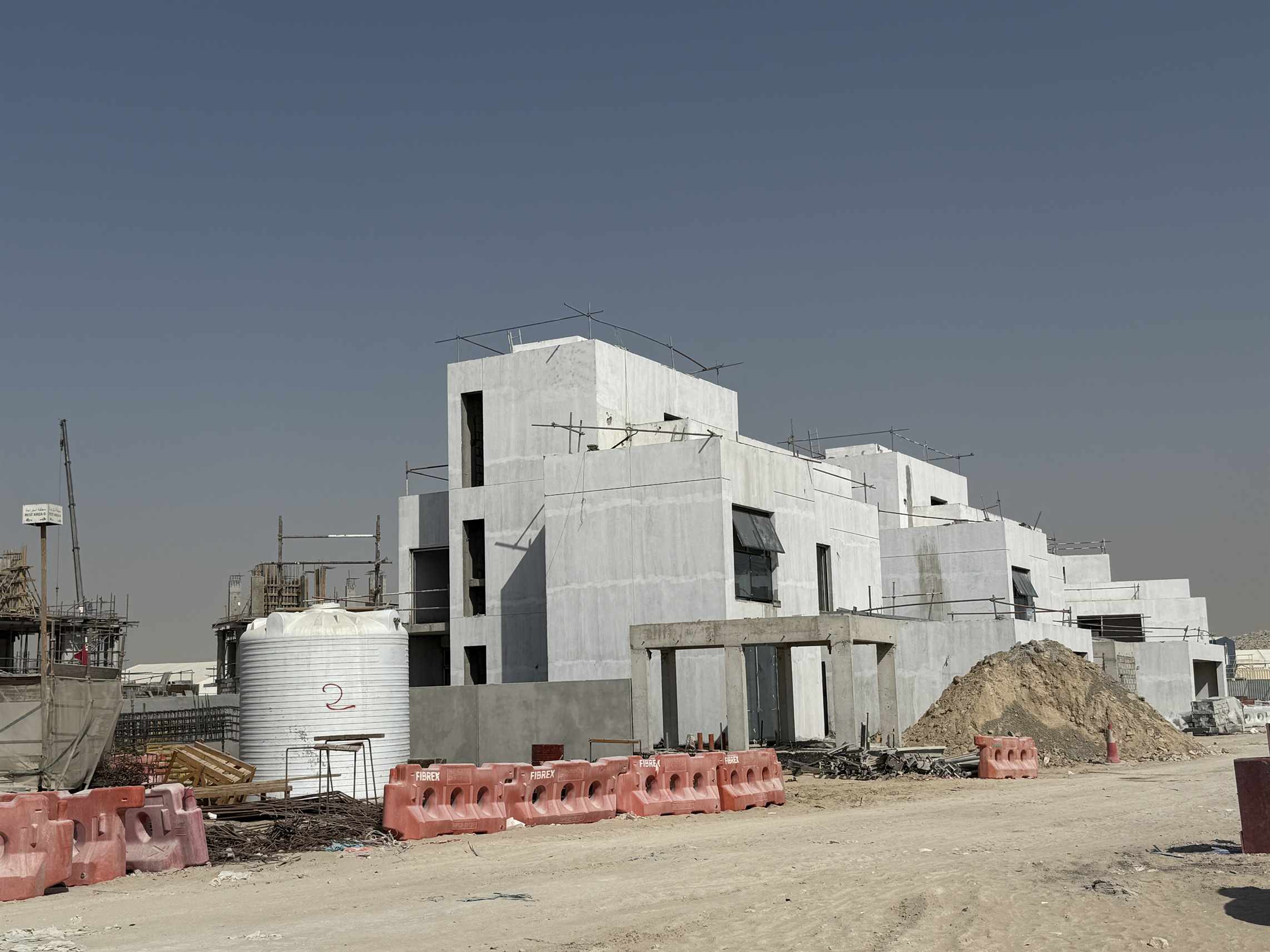

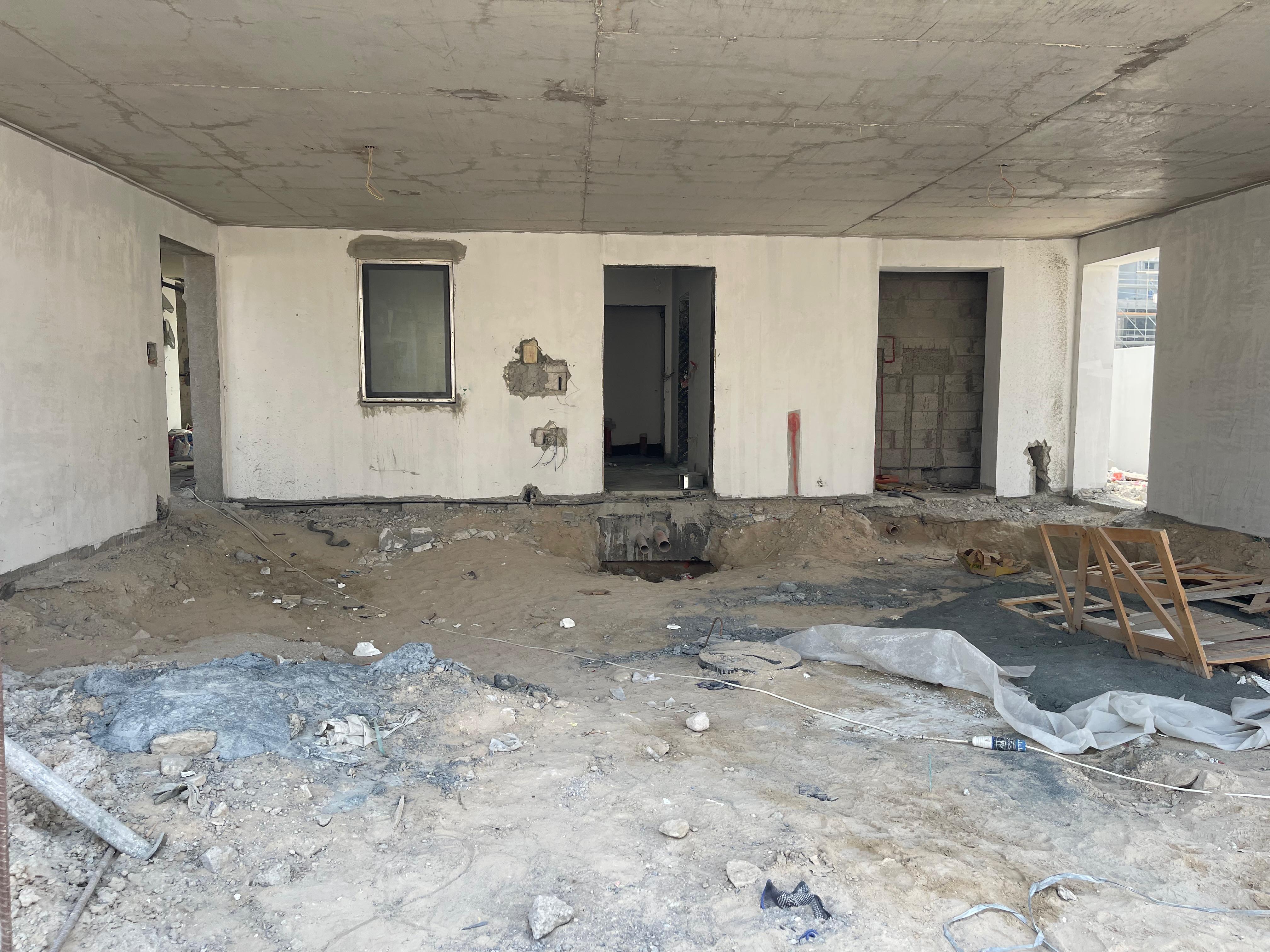

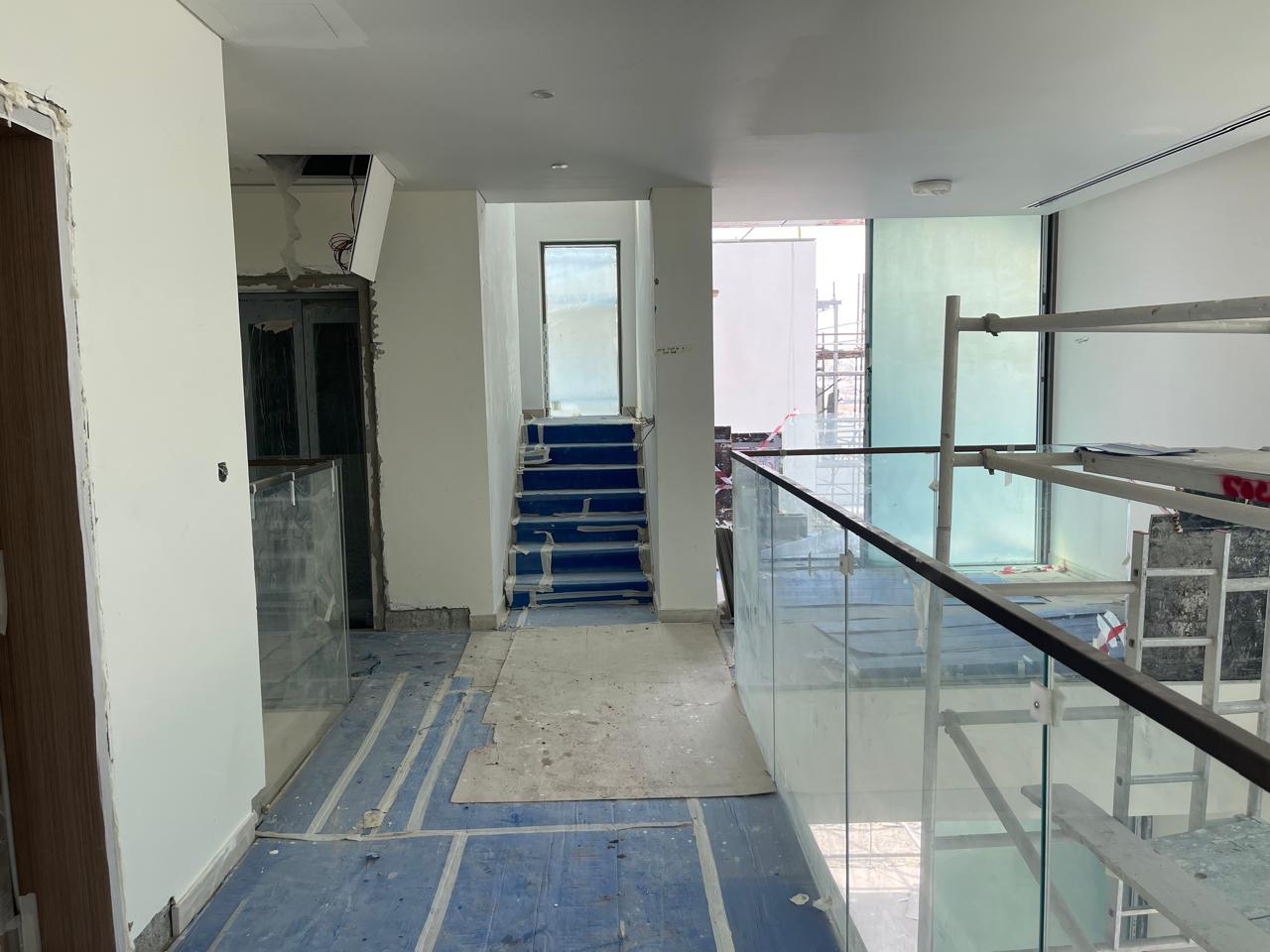

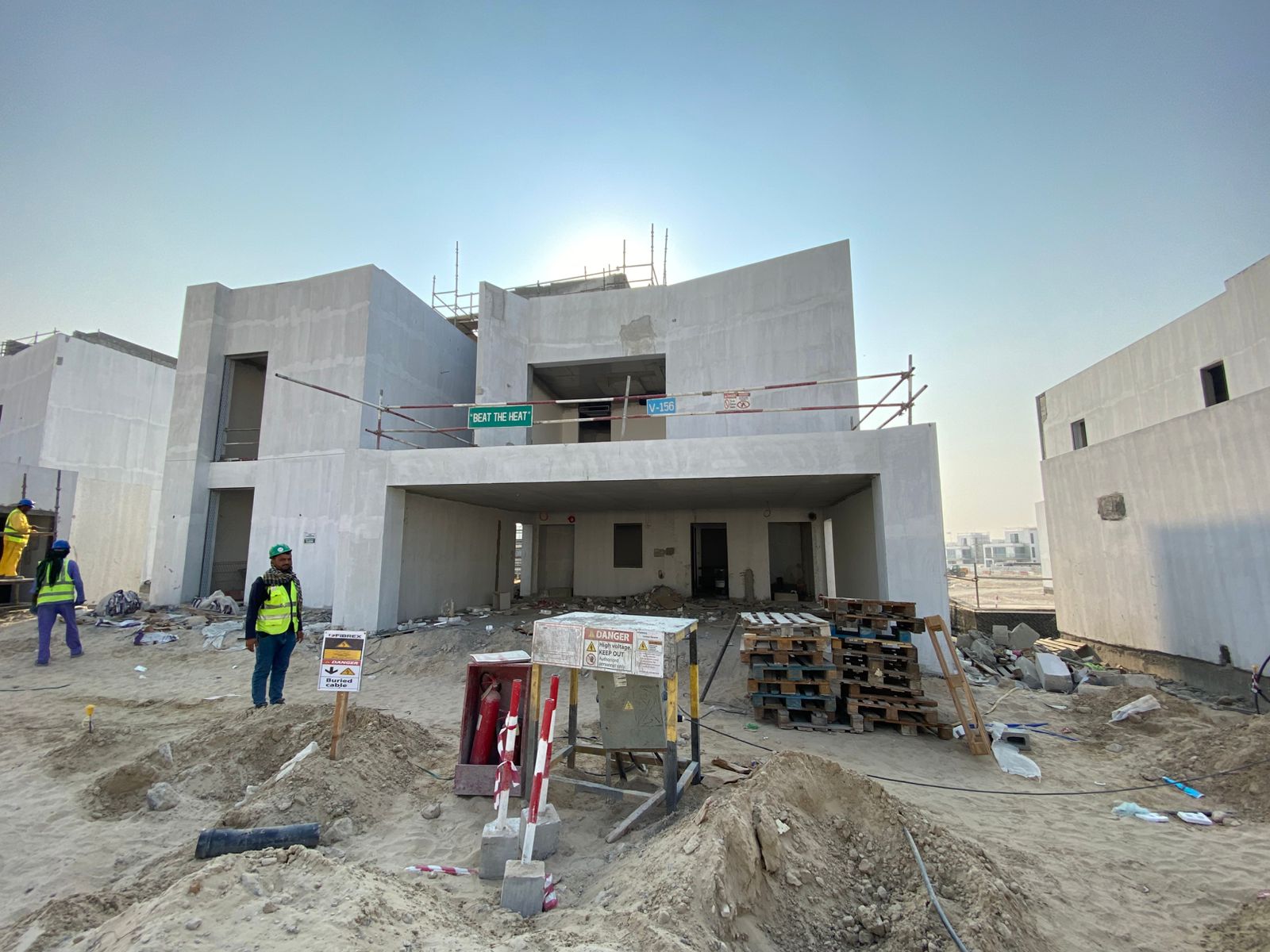

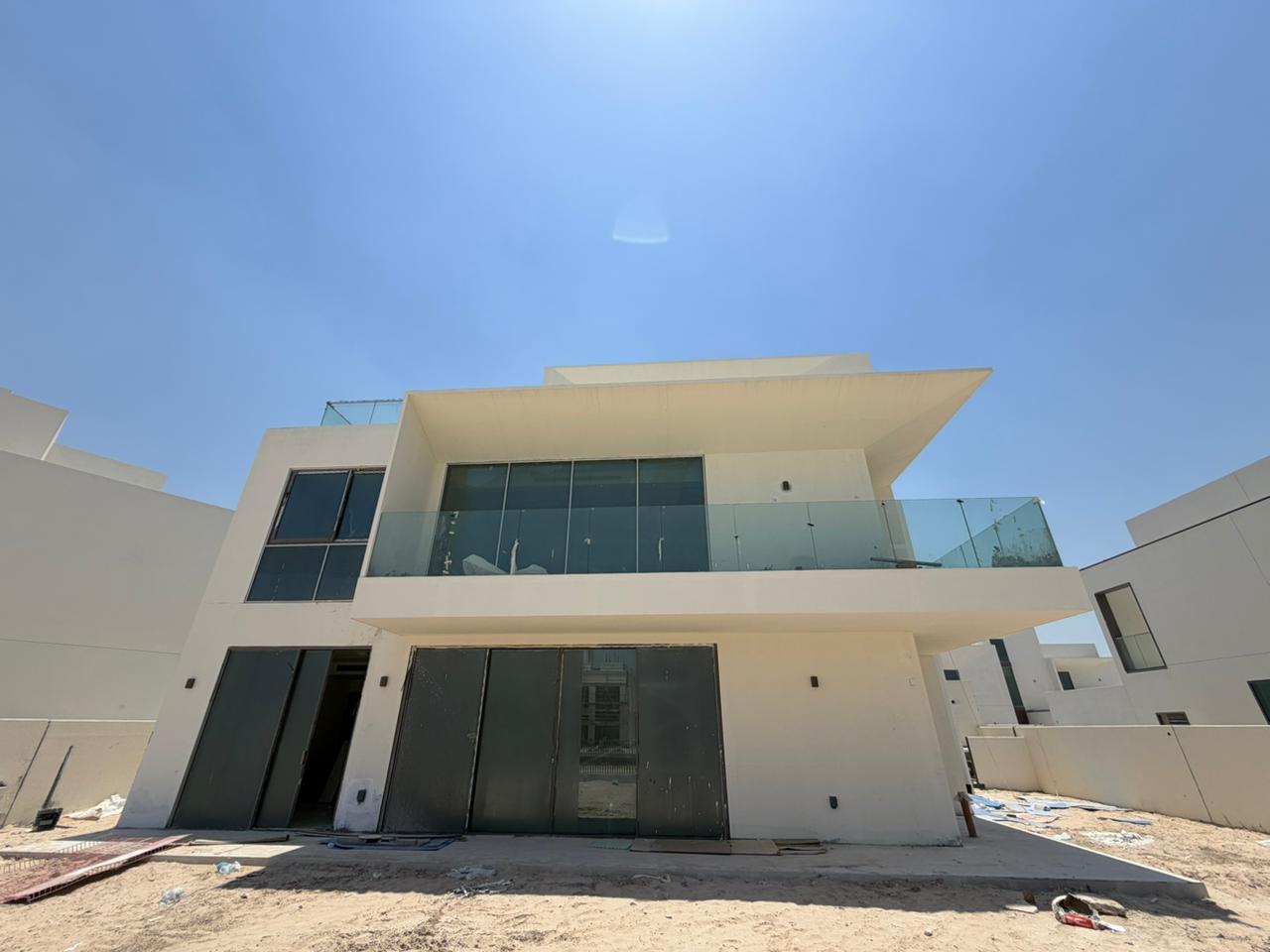

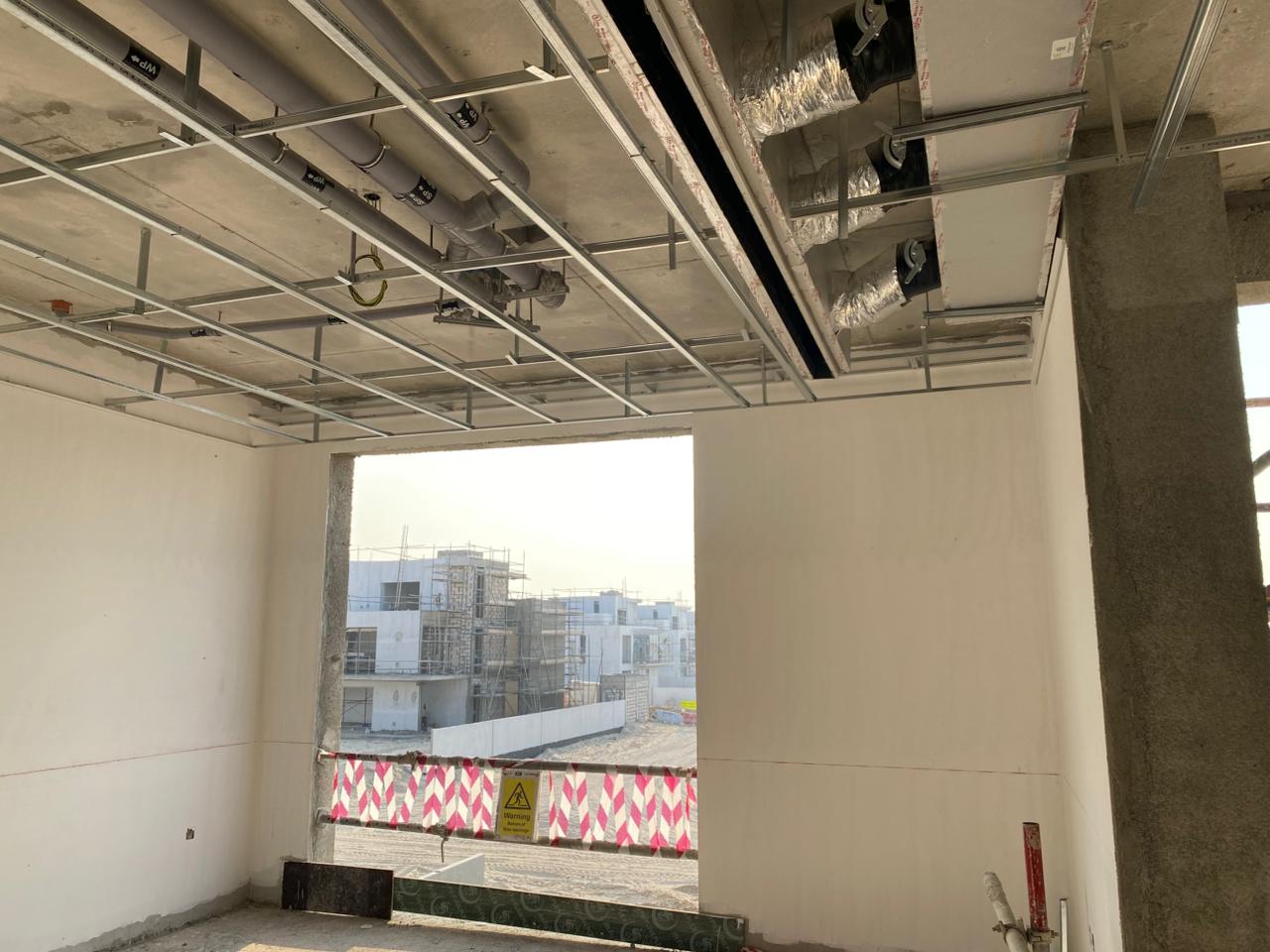

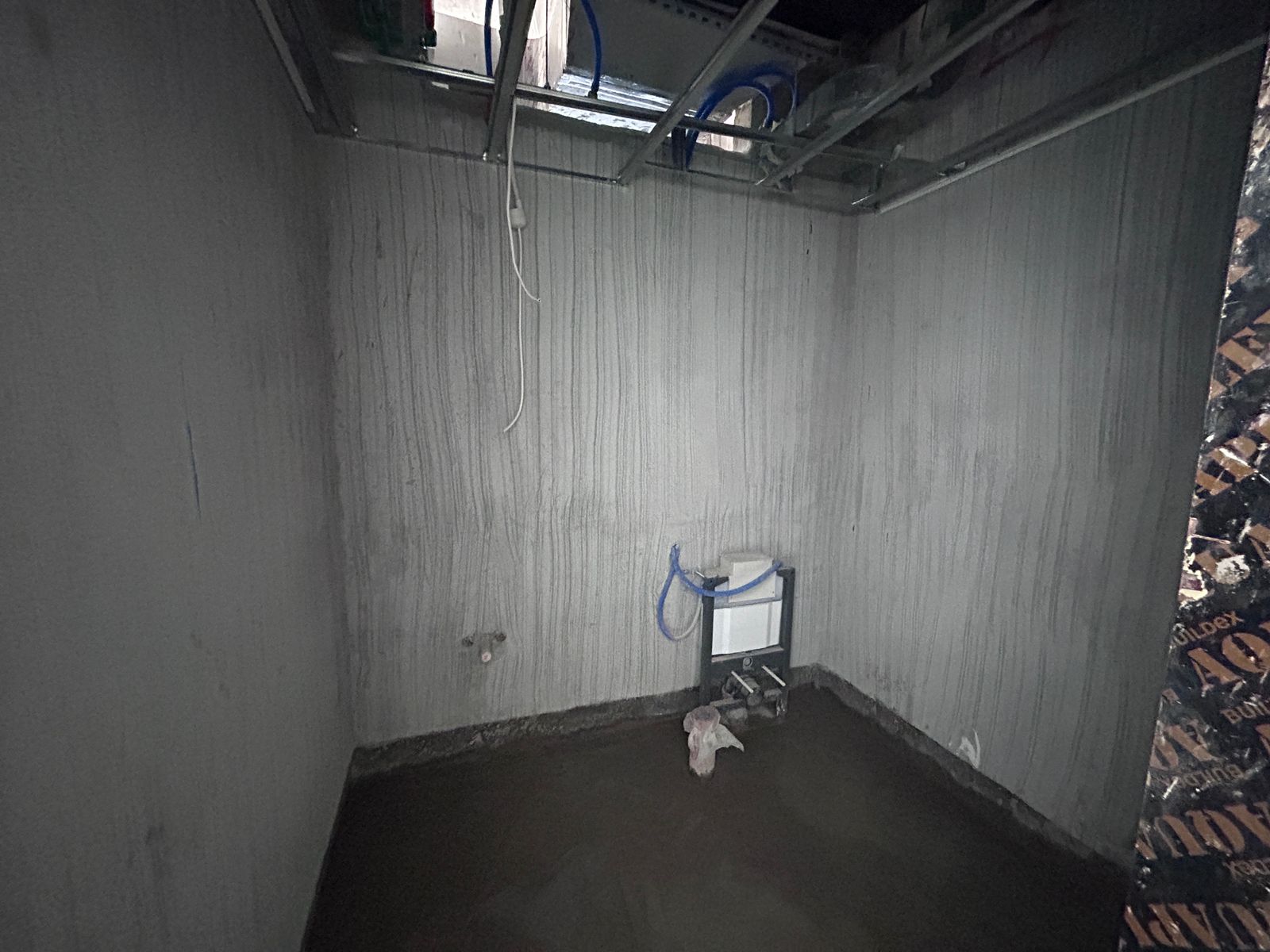

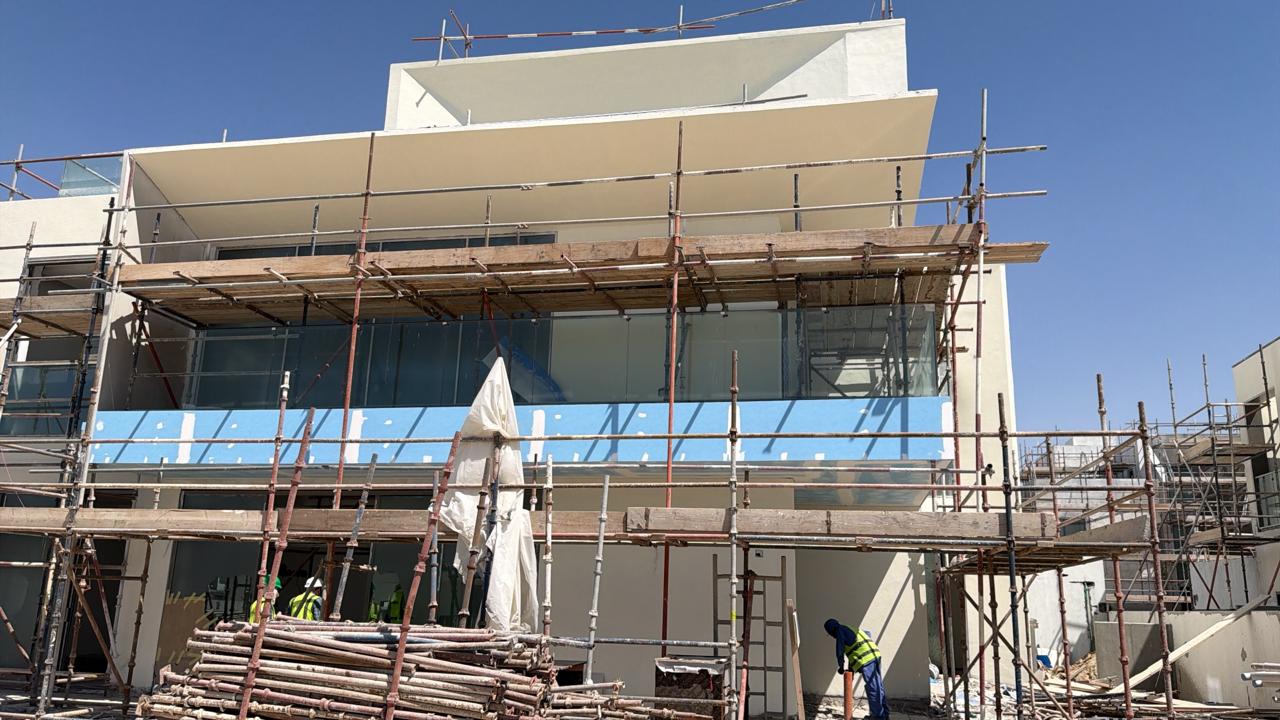

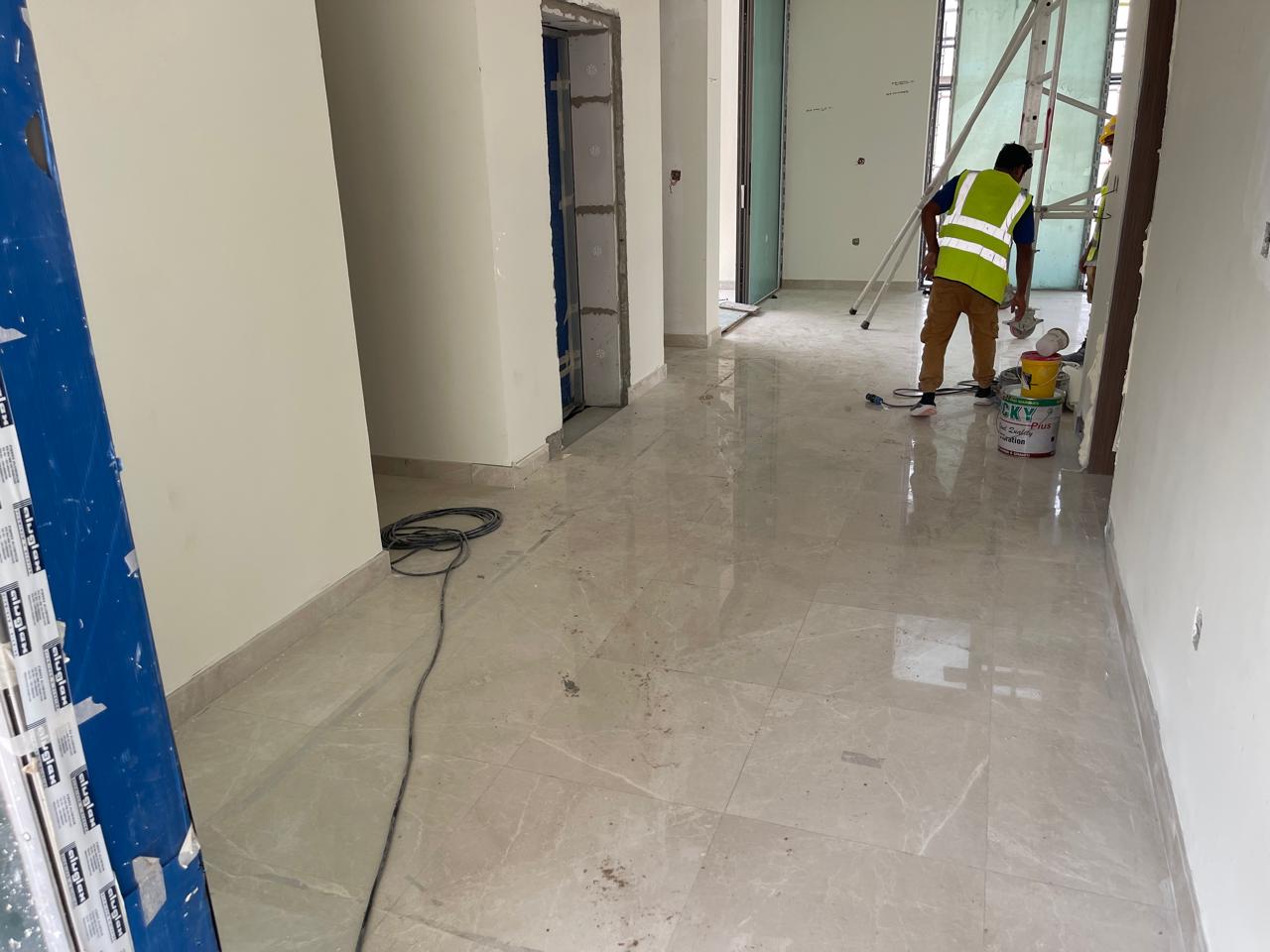

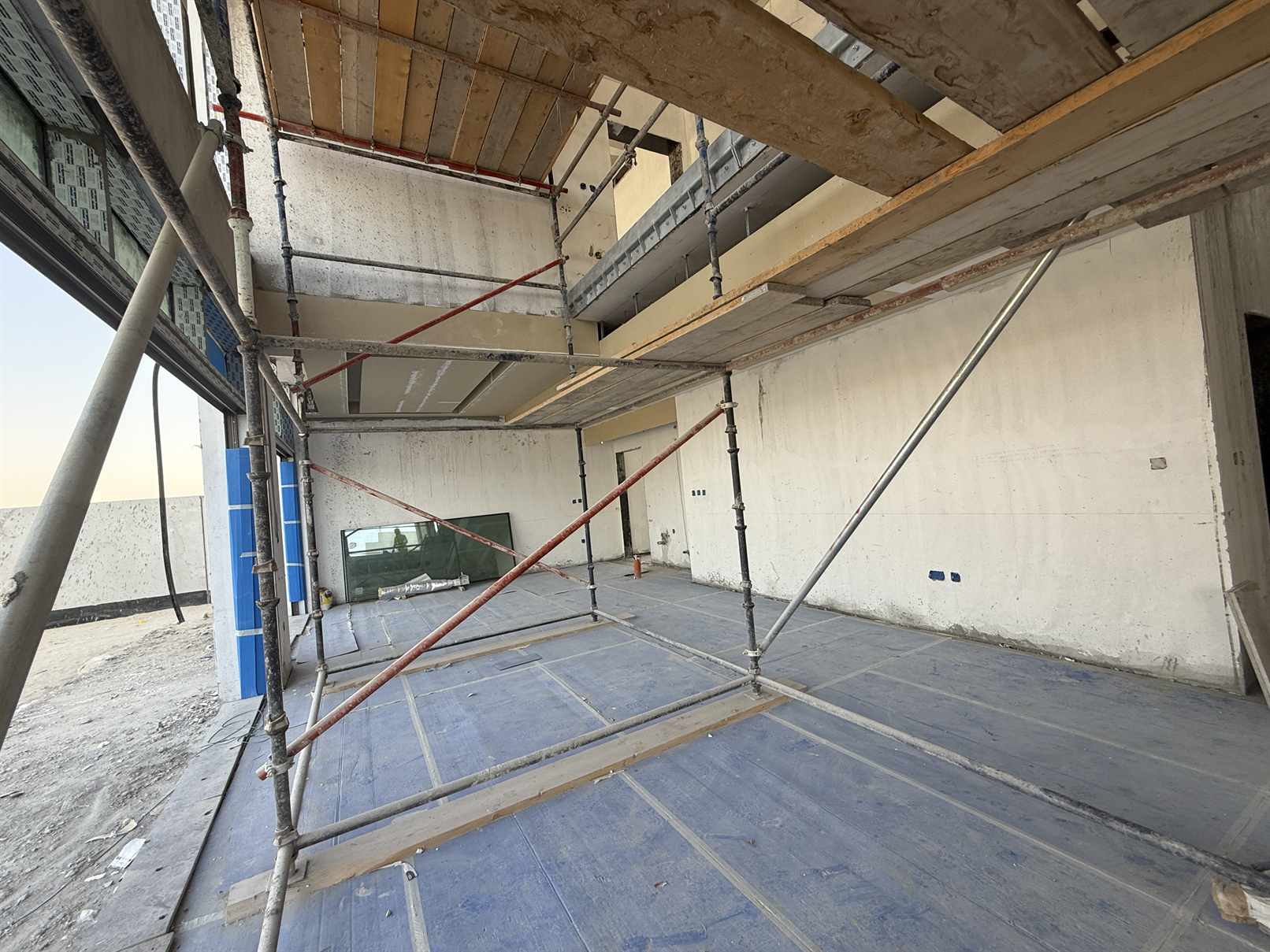

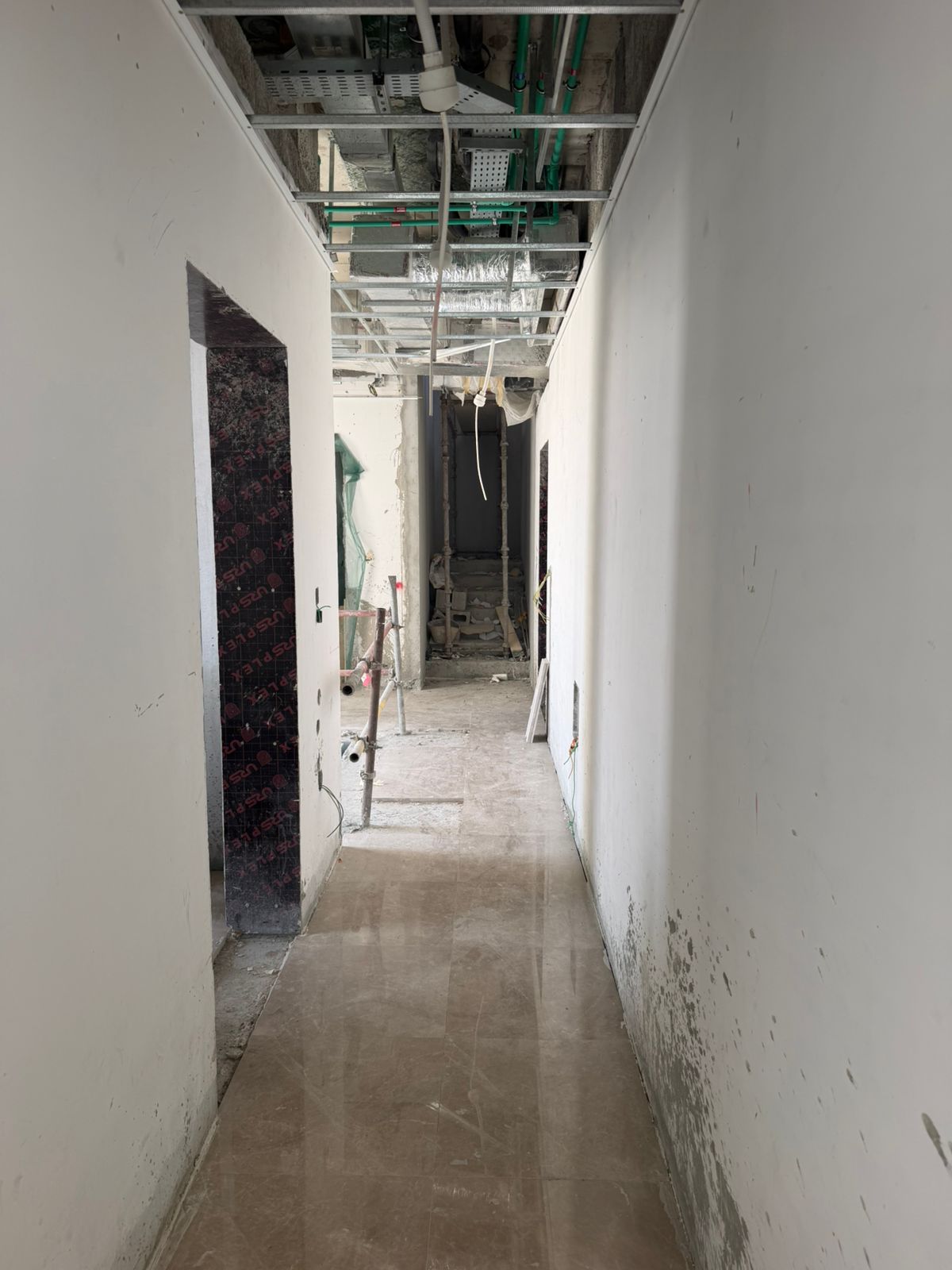

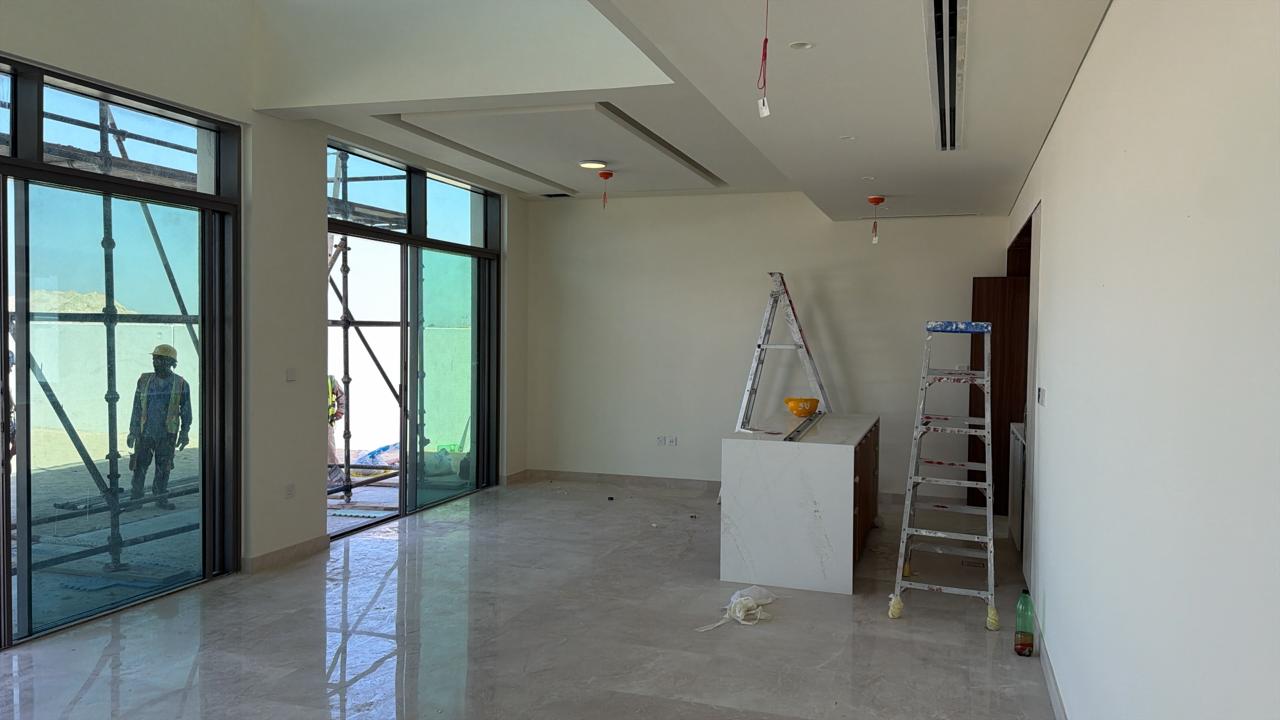

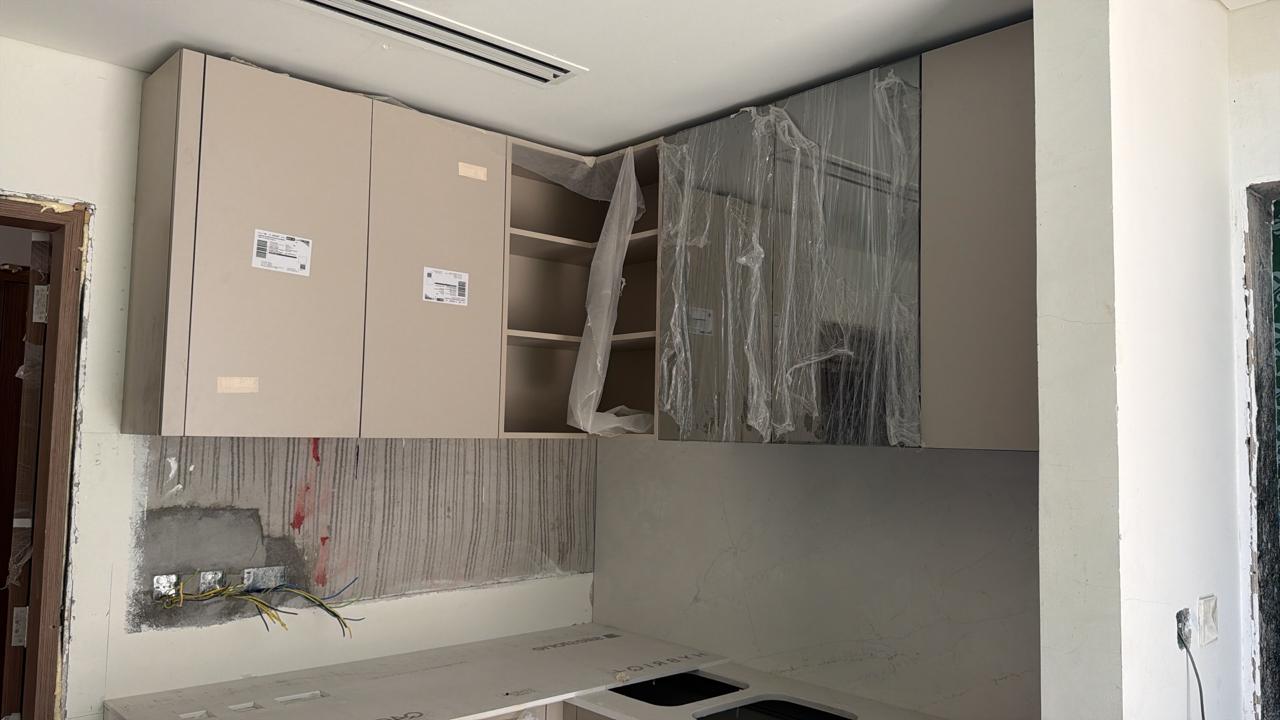

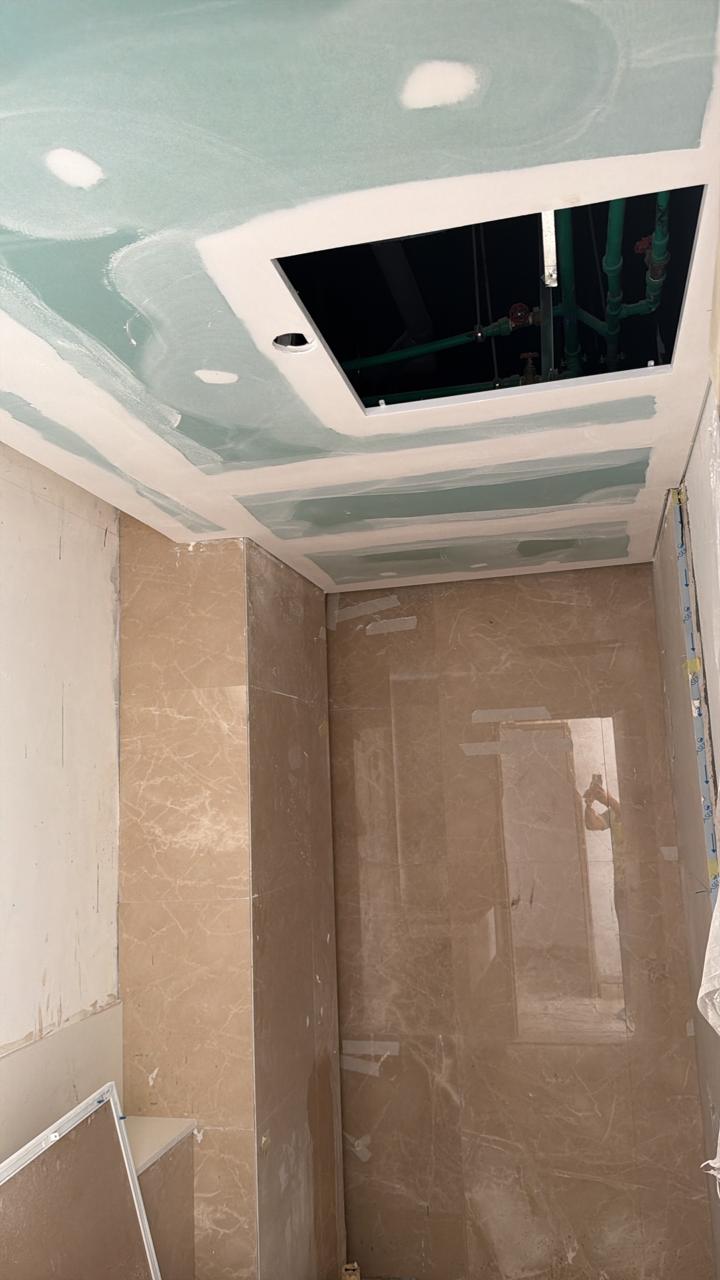

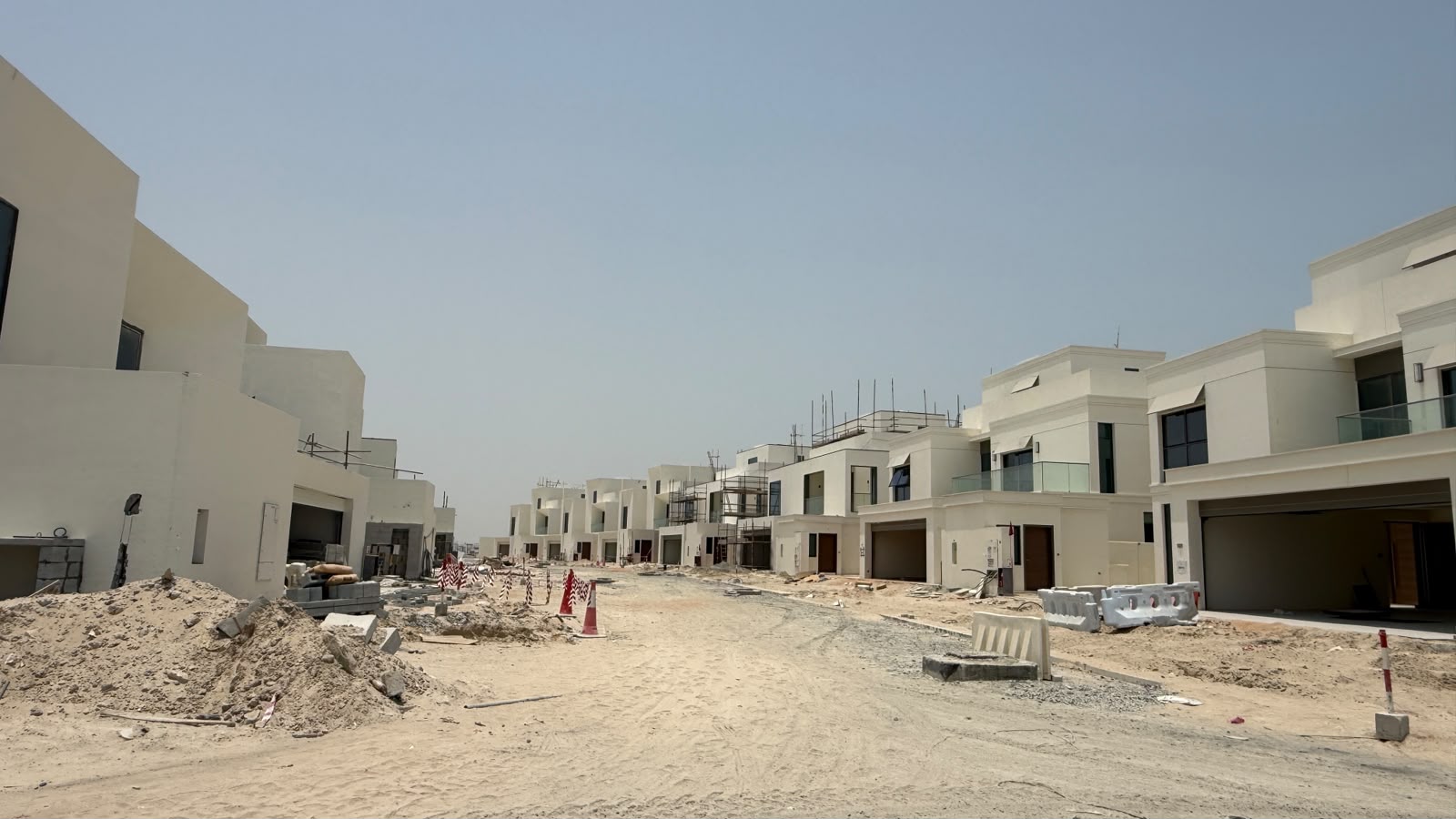

20 July 202682% built

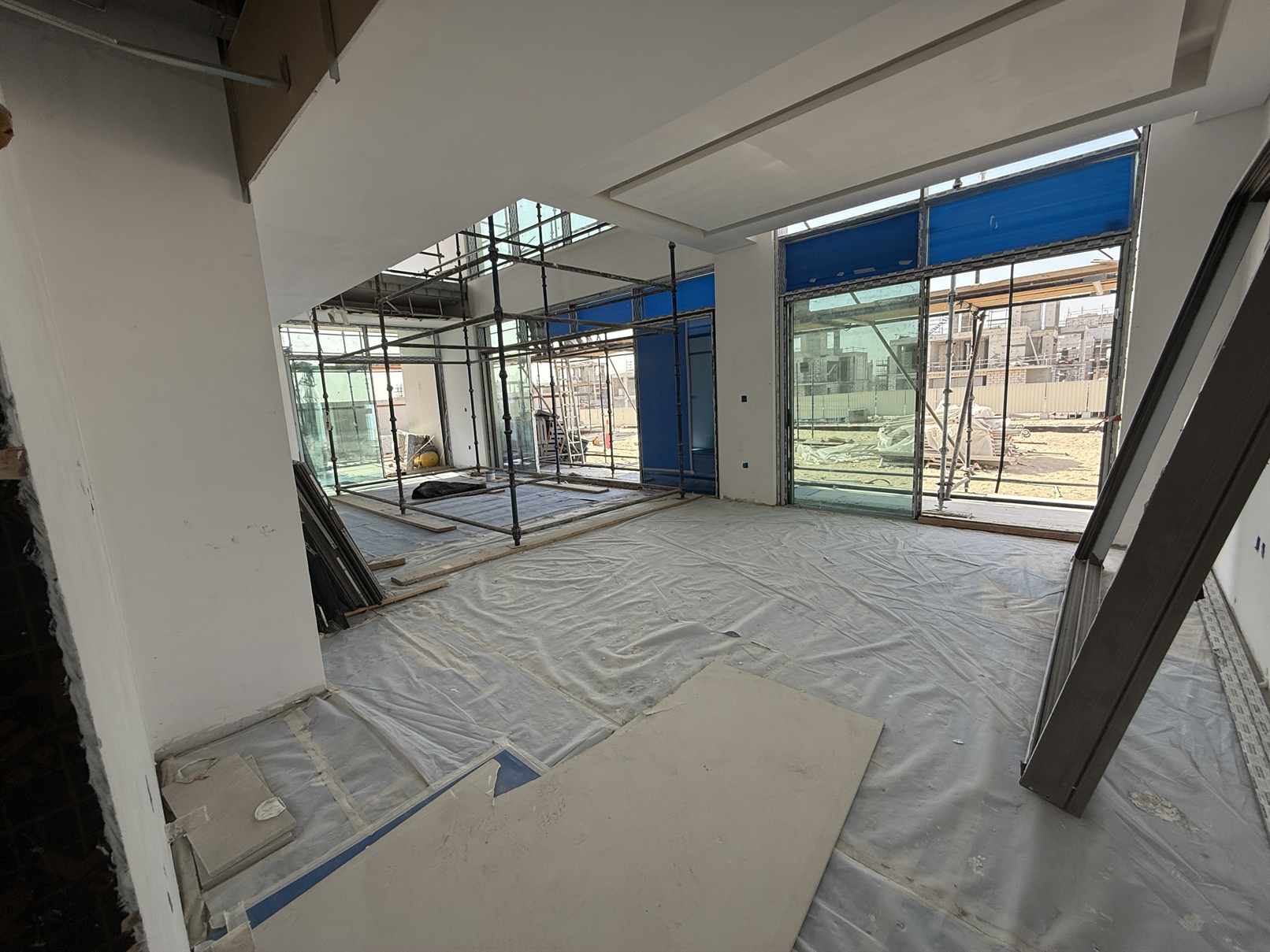

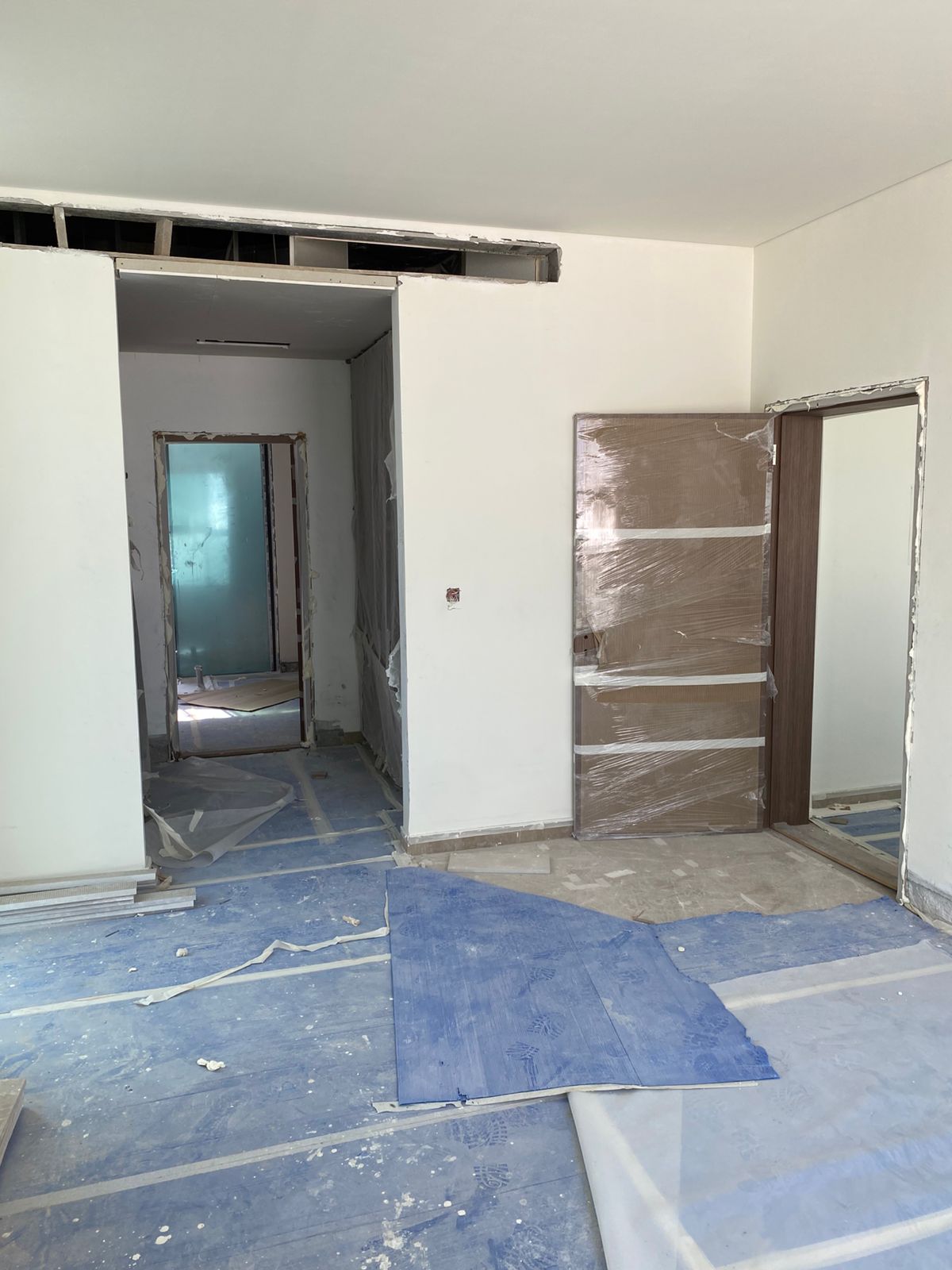

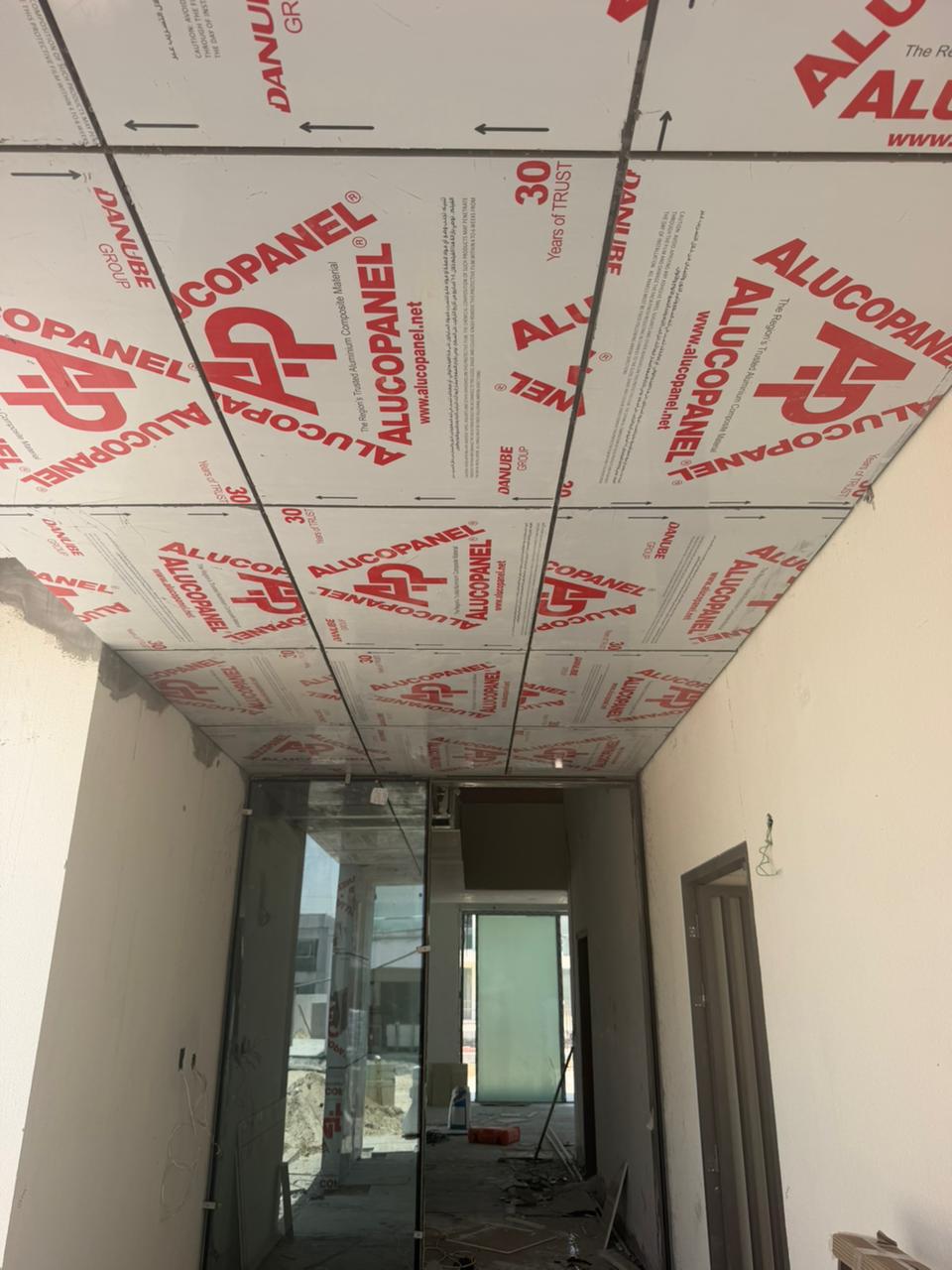

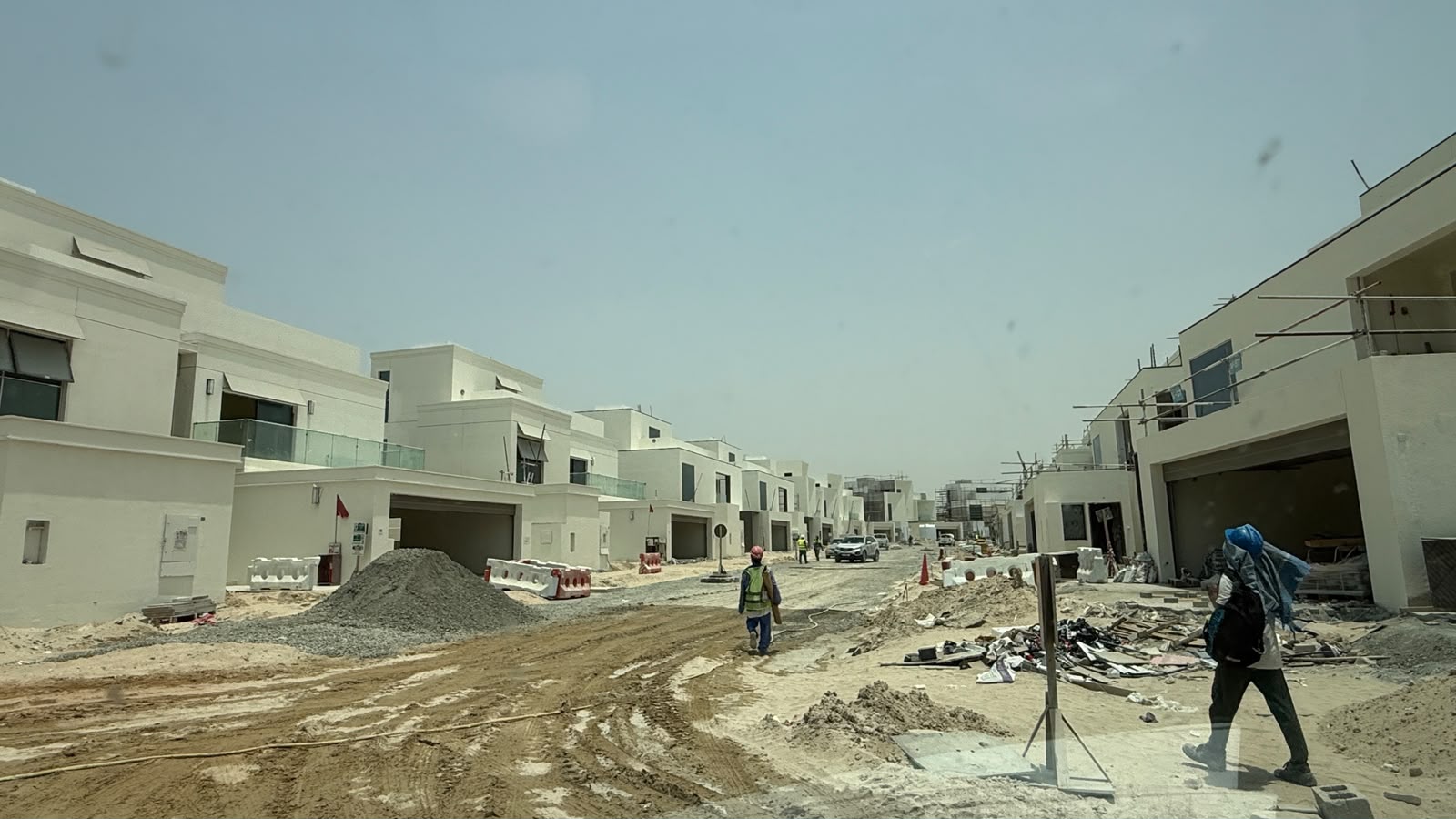

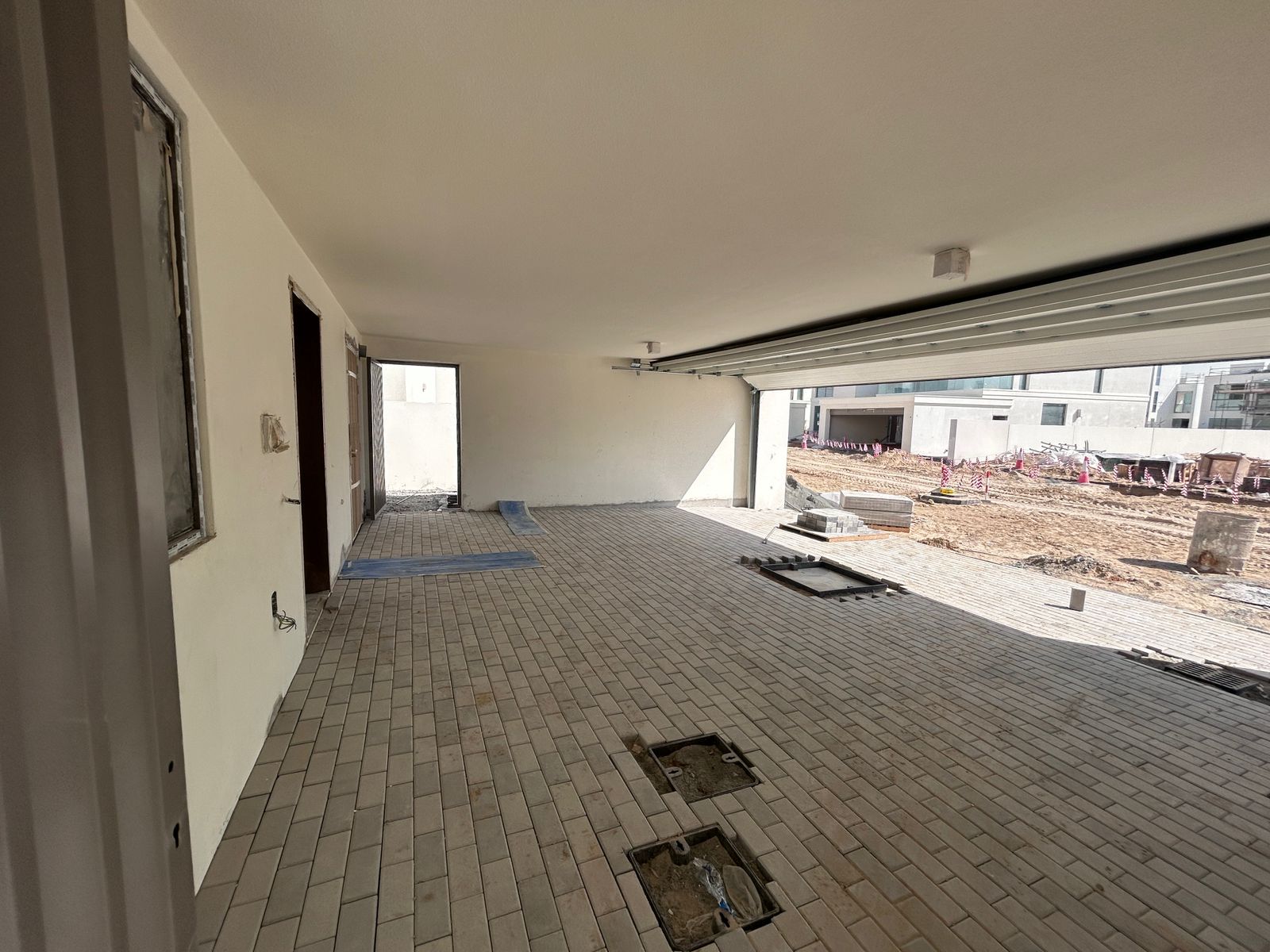

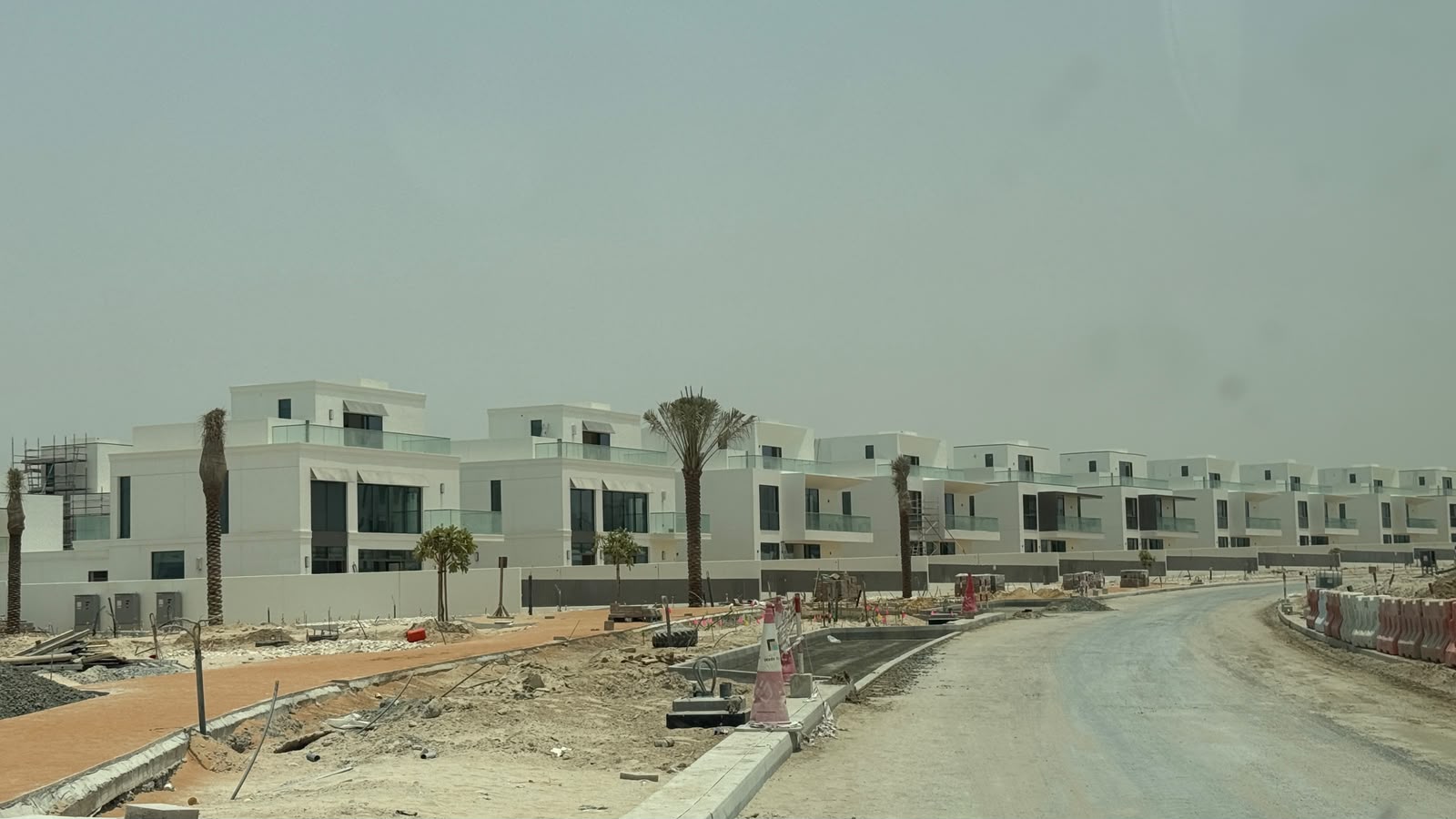

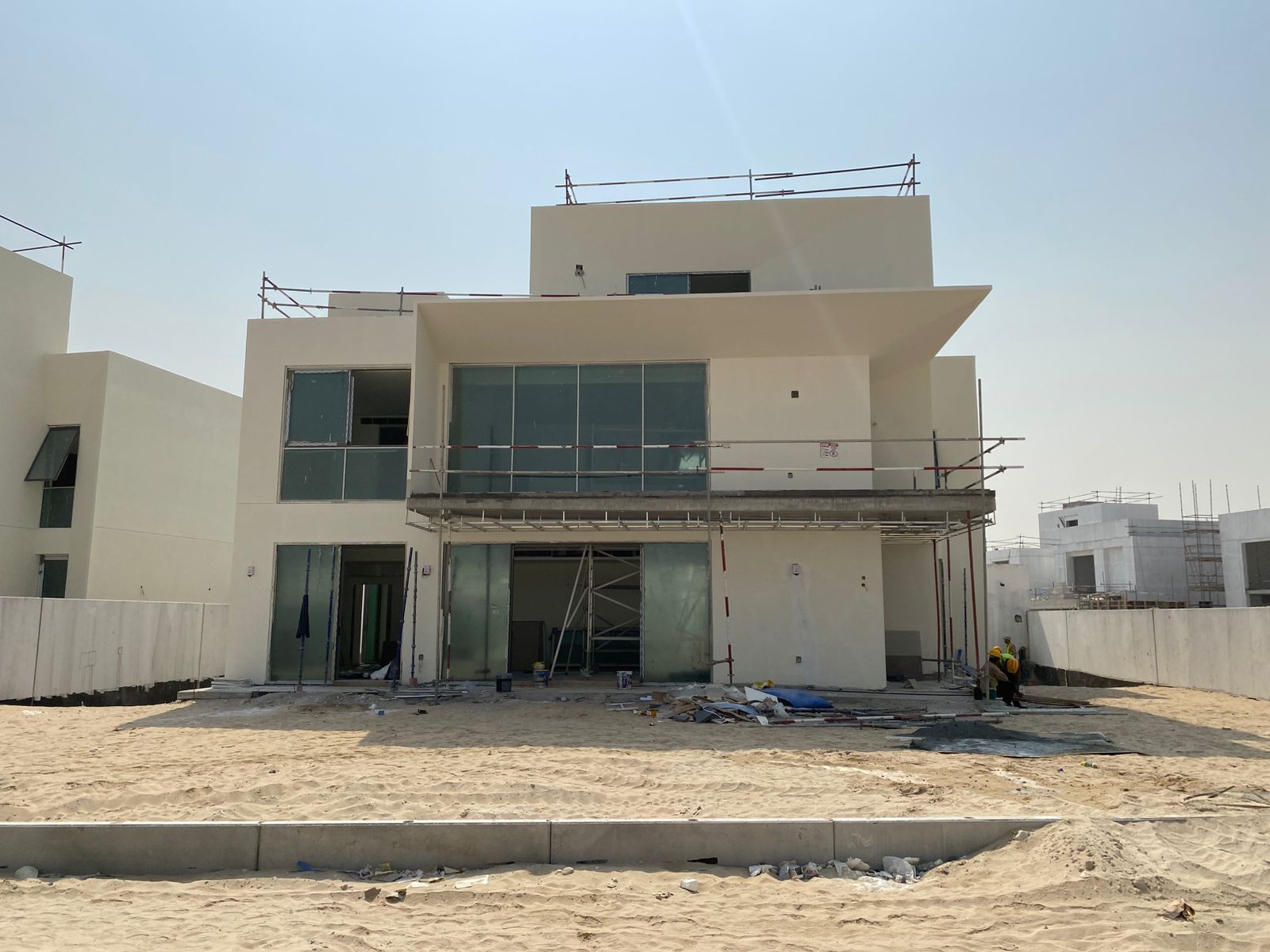

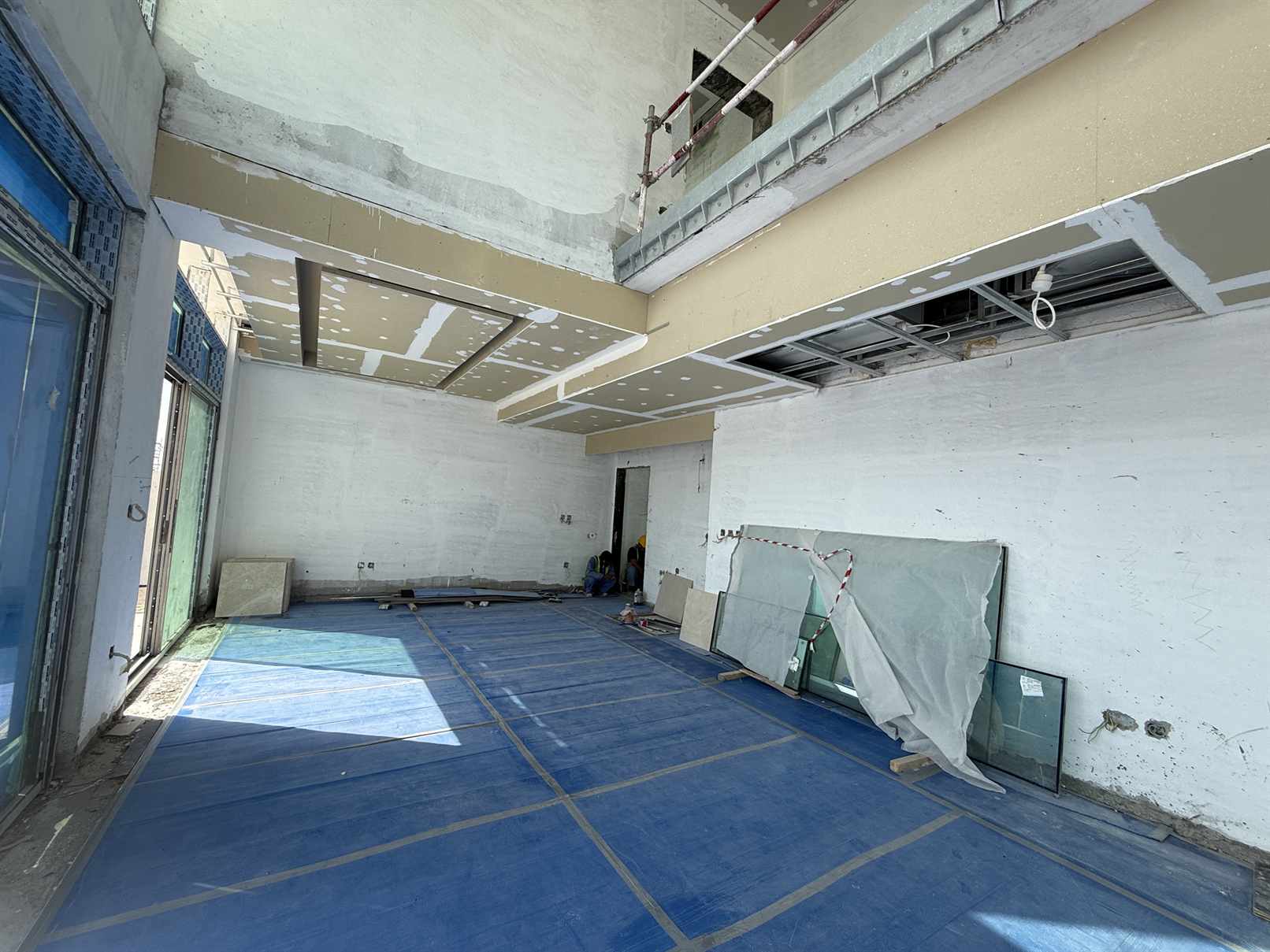

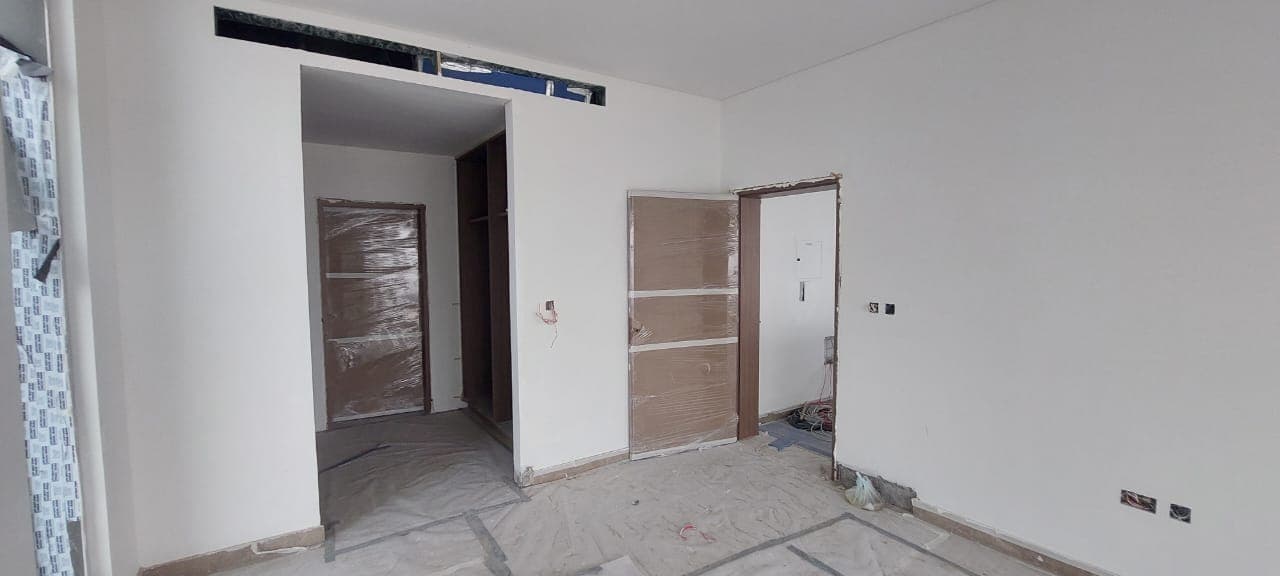

27 March 202673% built

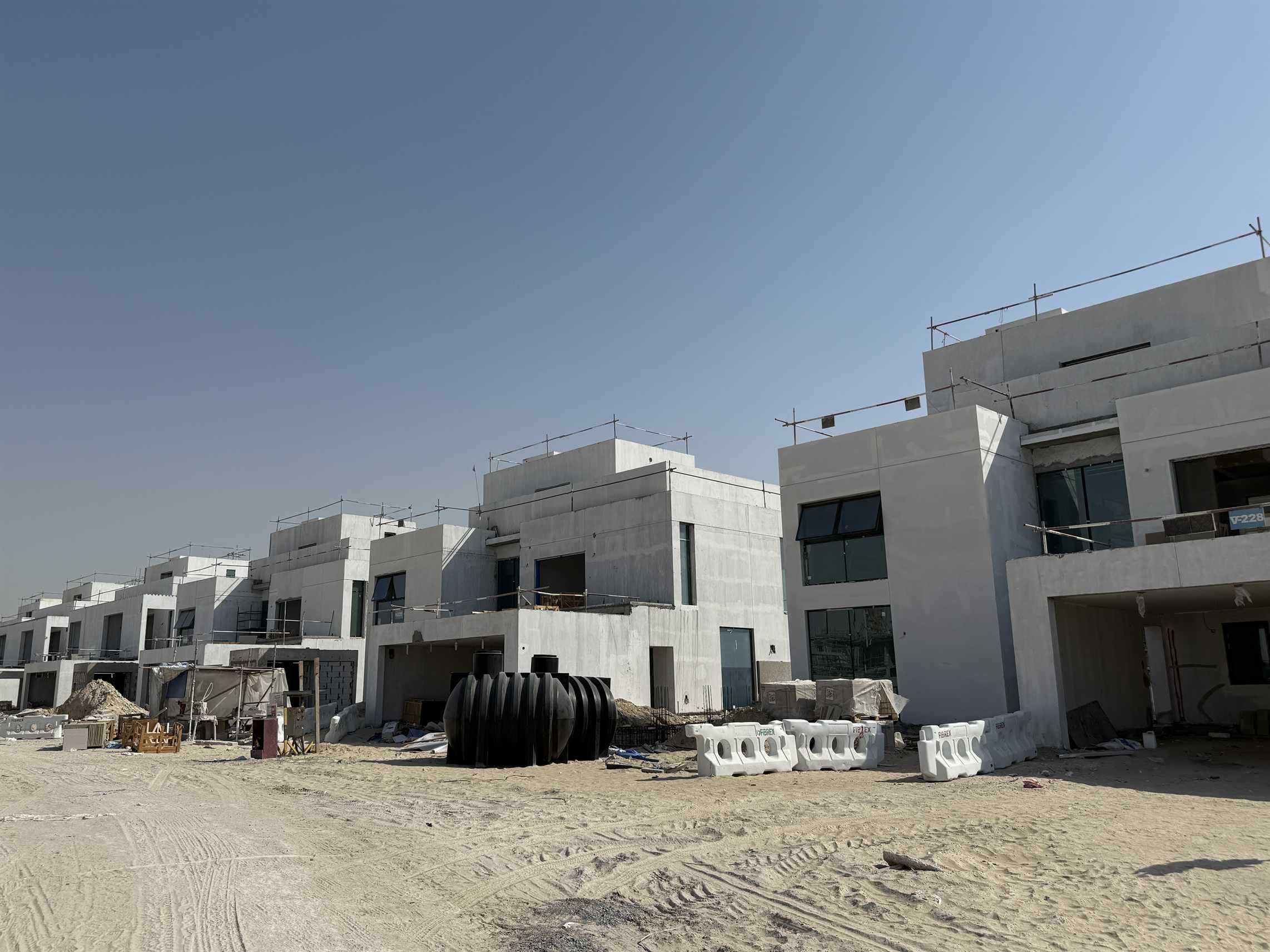

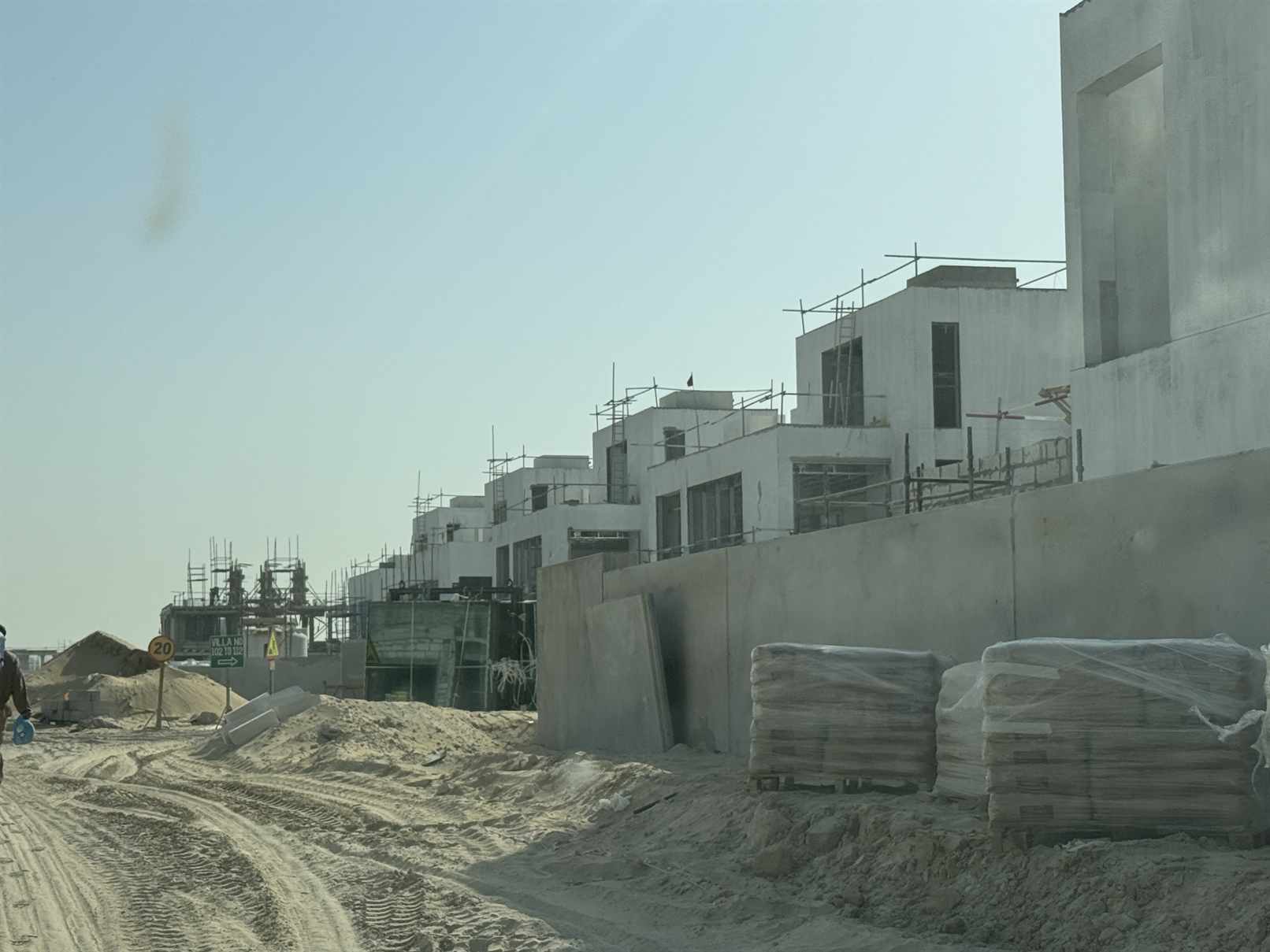

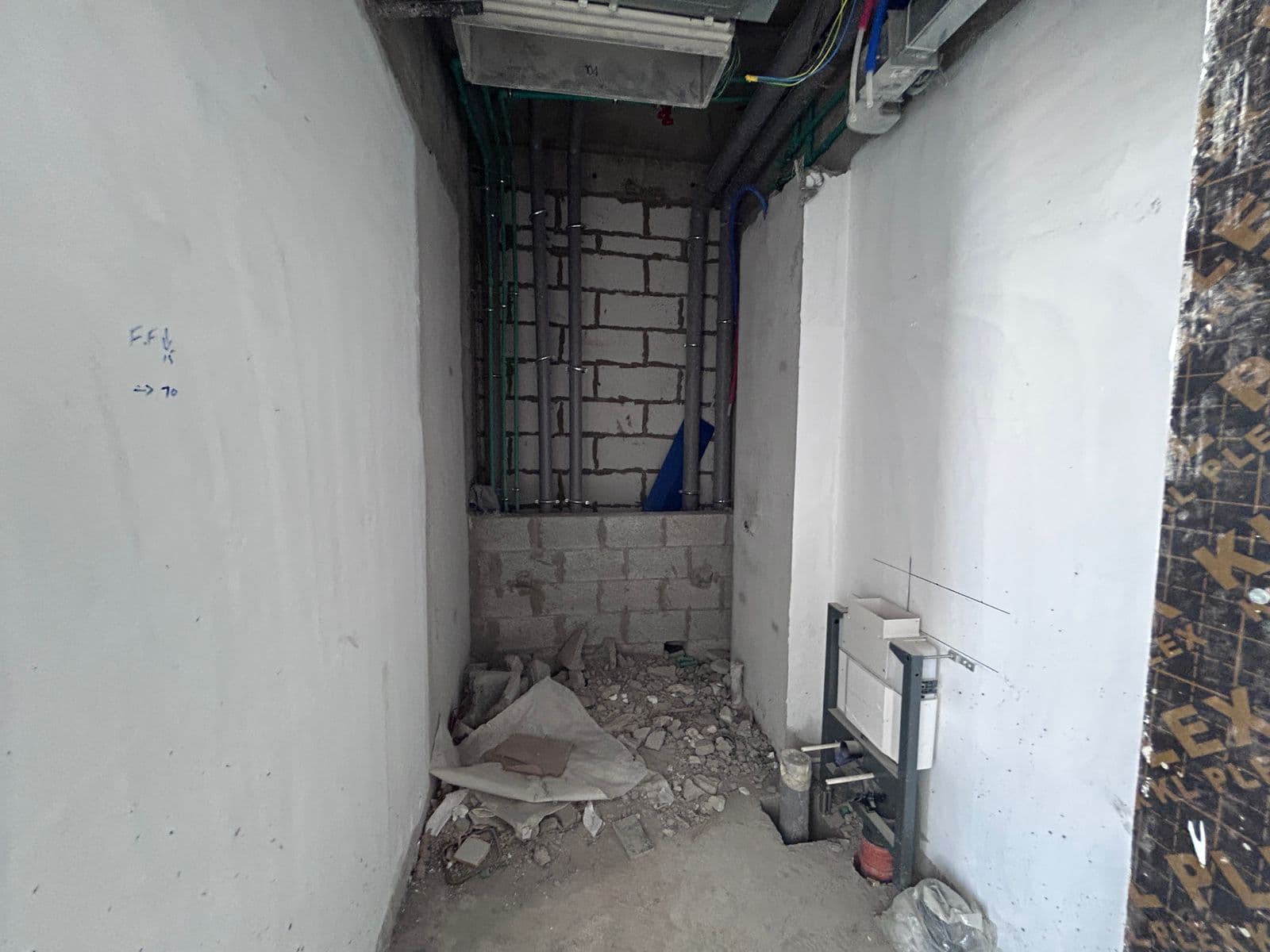

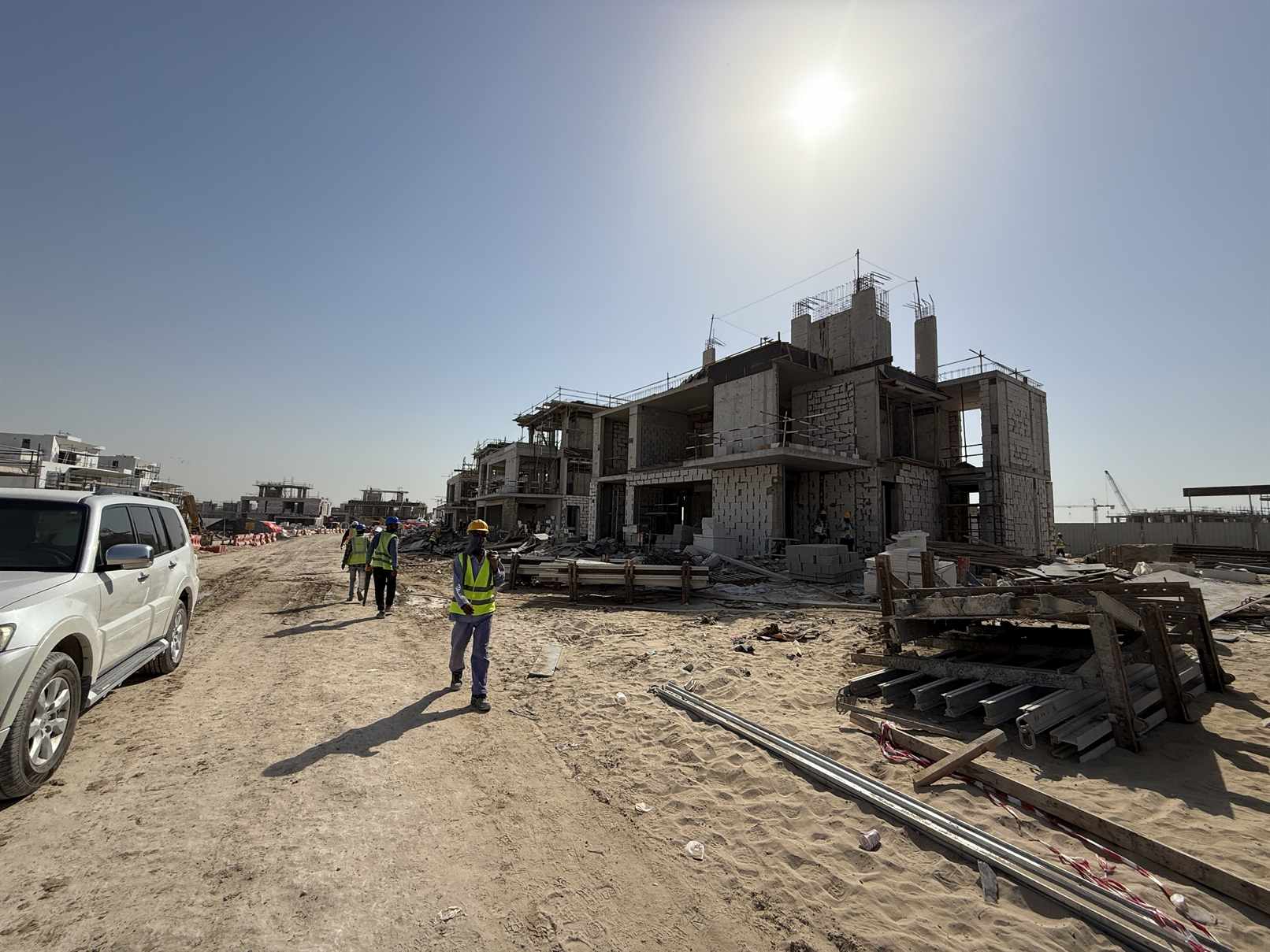

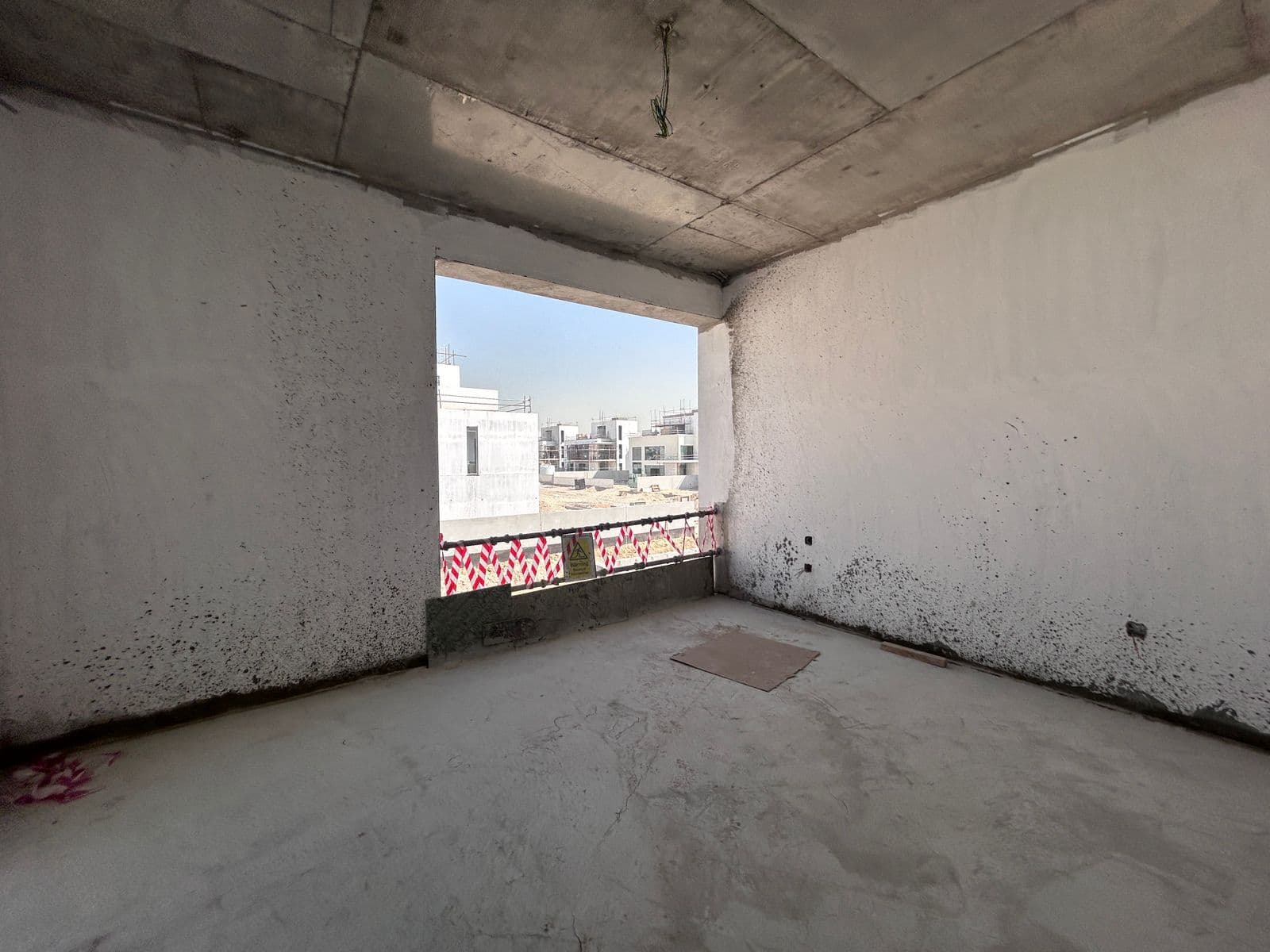

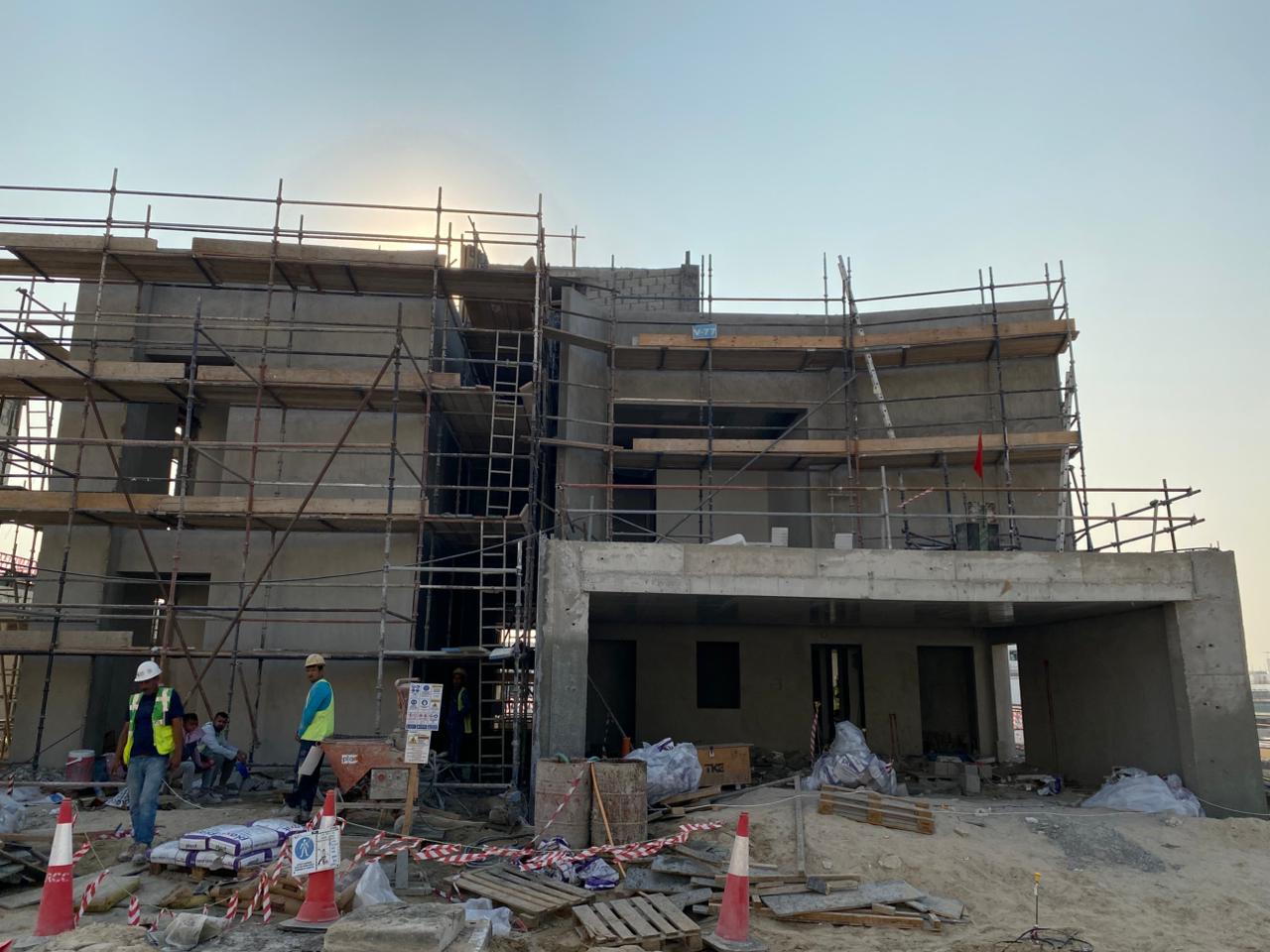

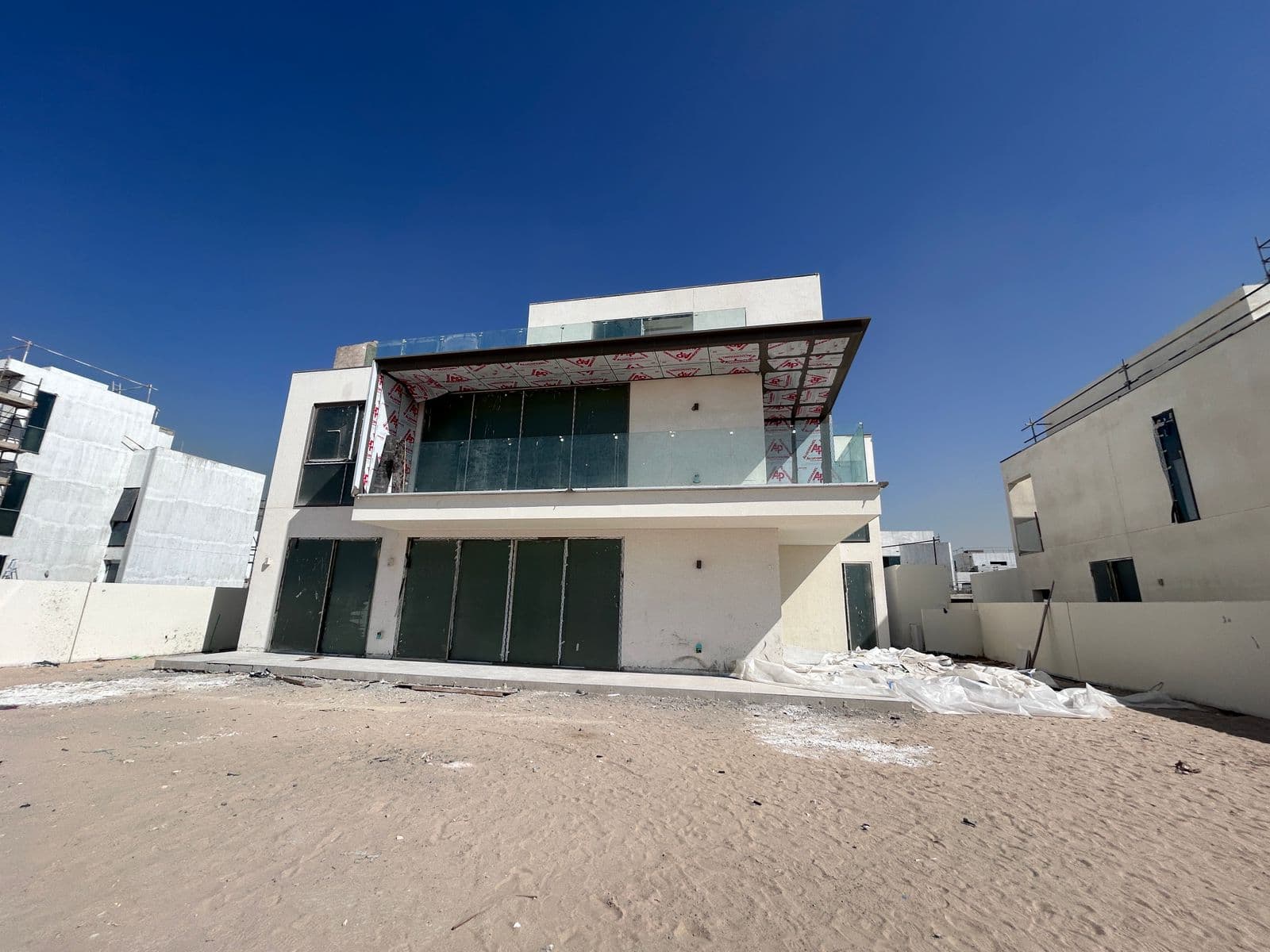

25 November 202561% built

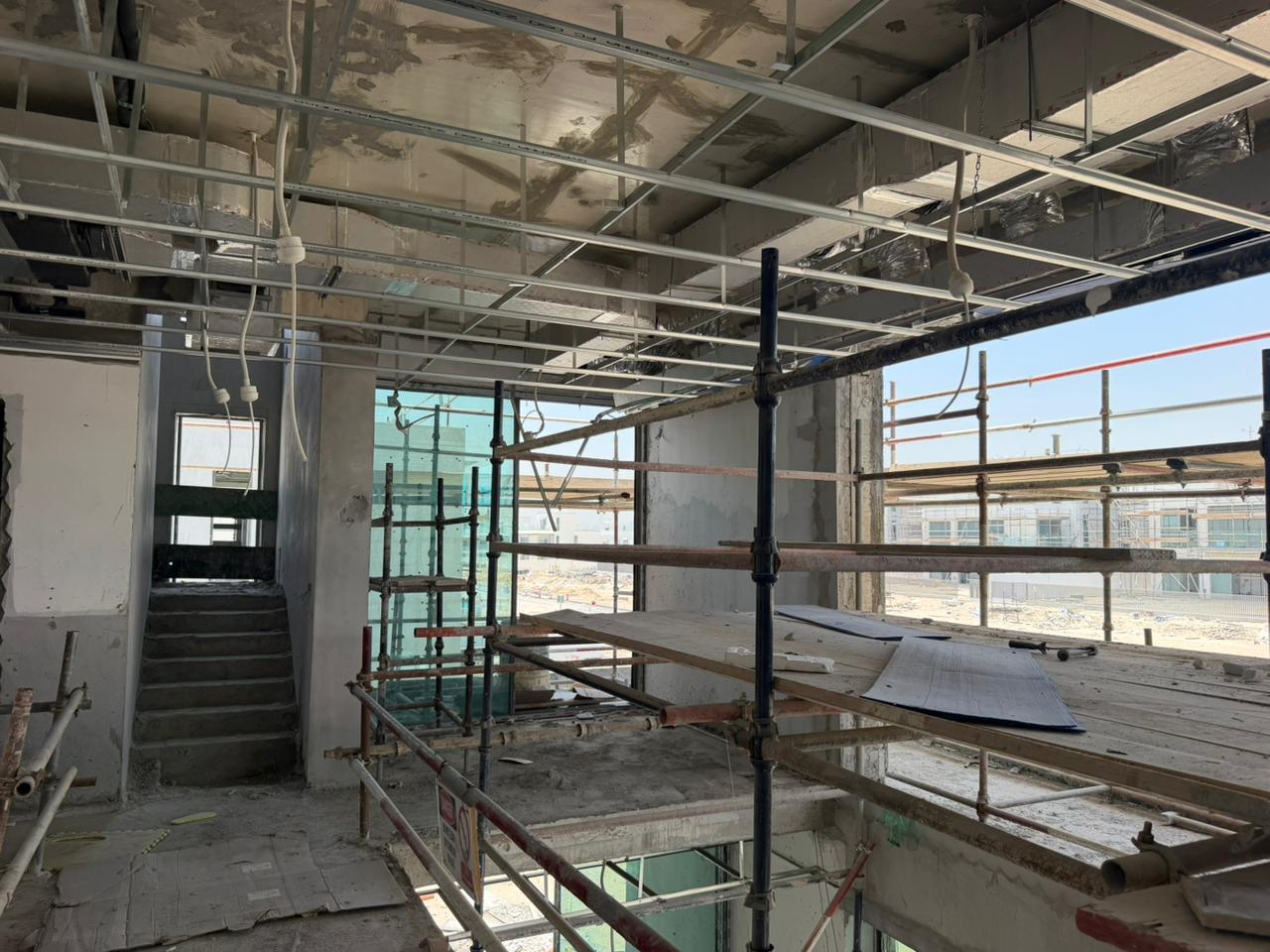

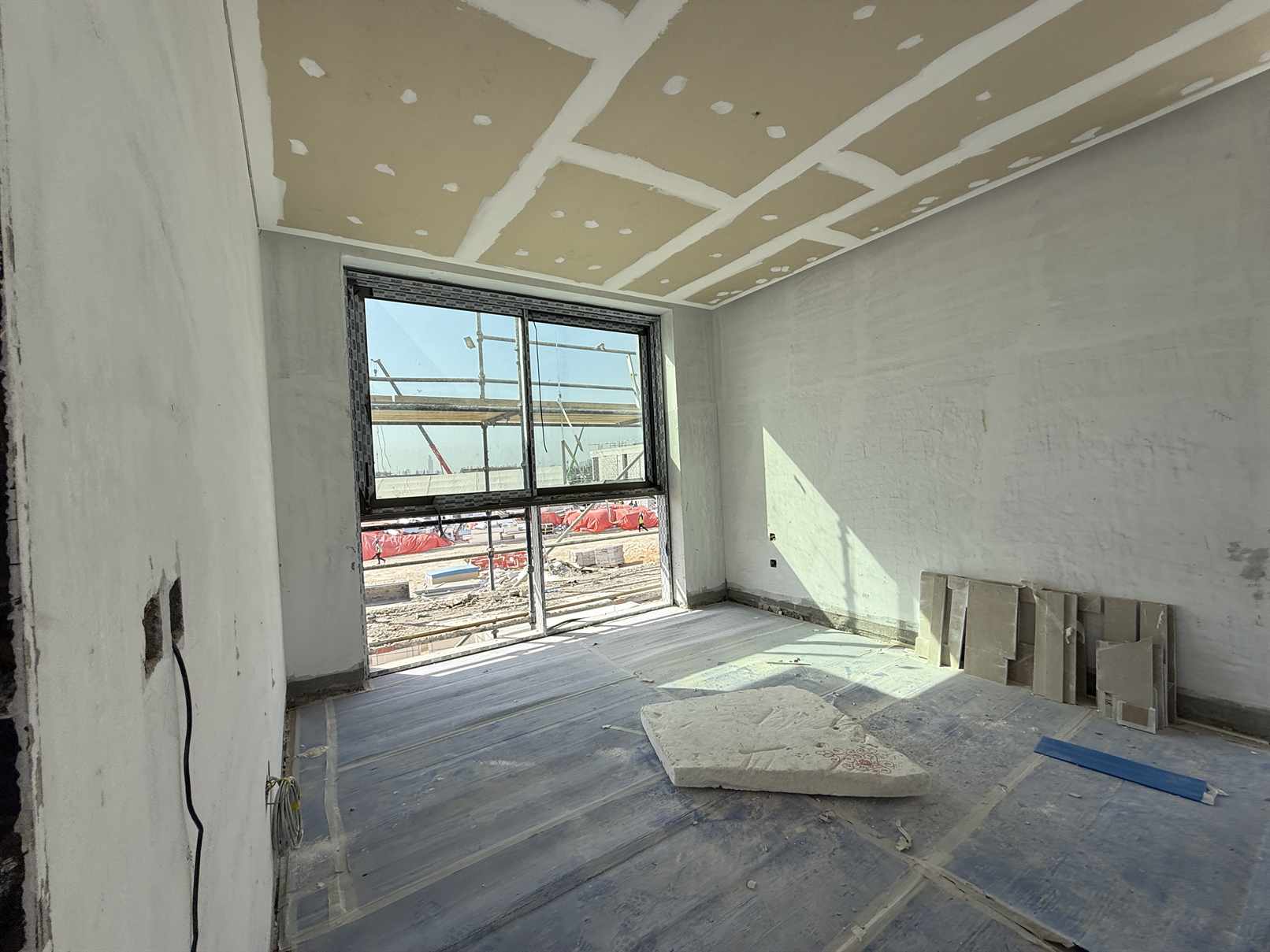

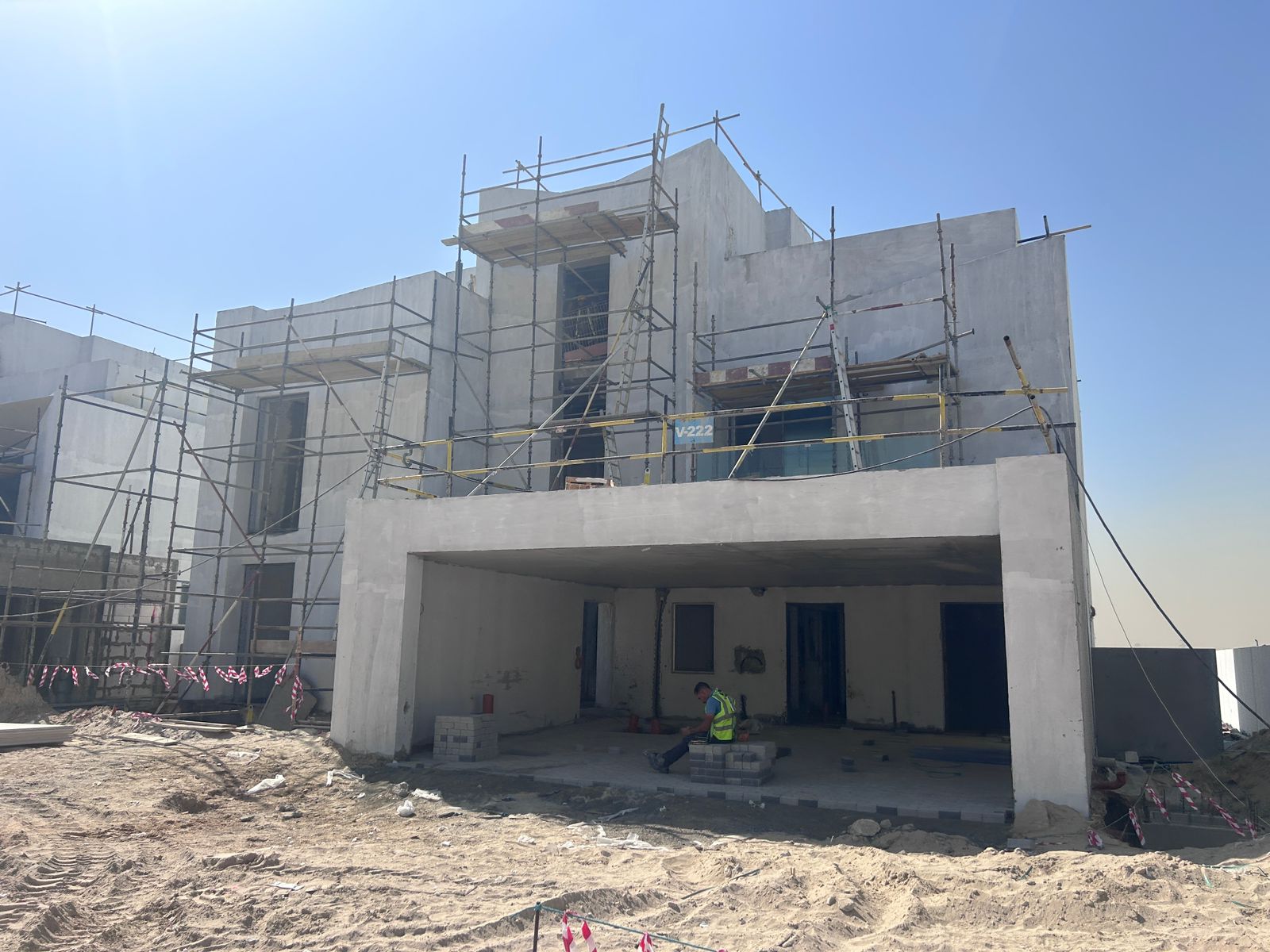

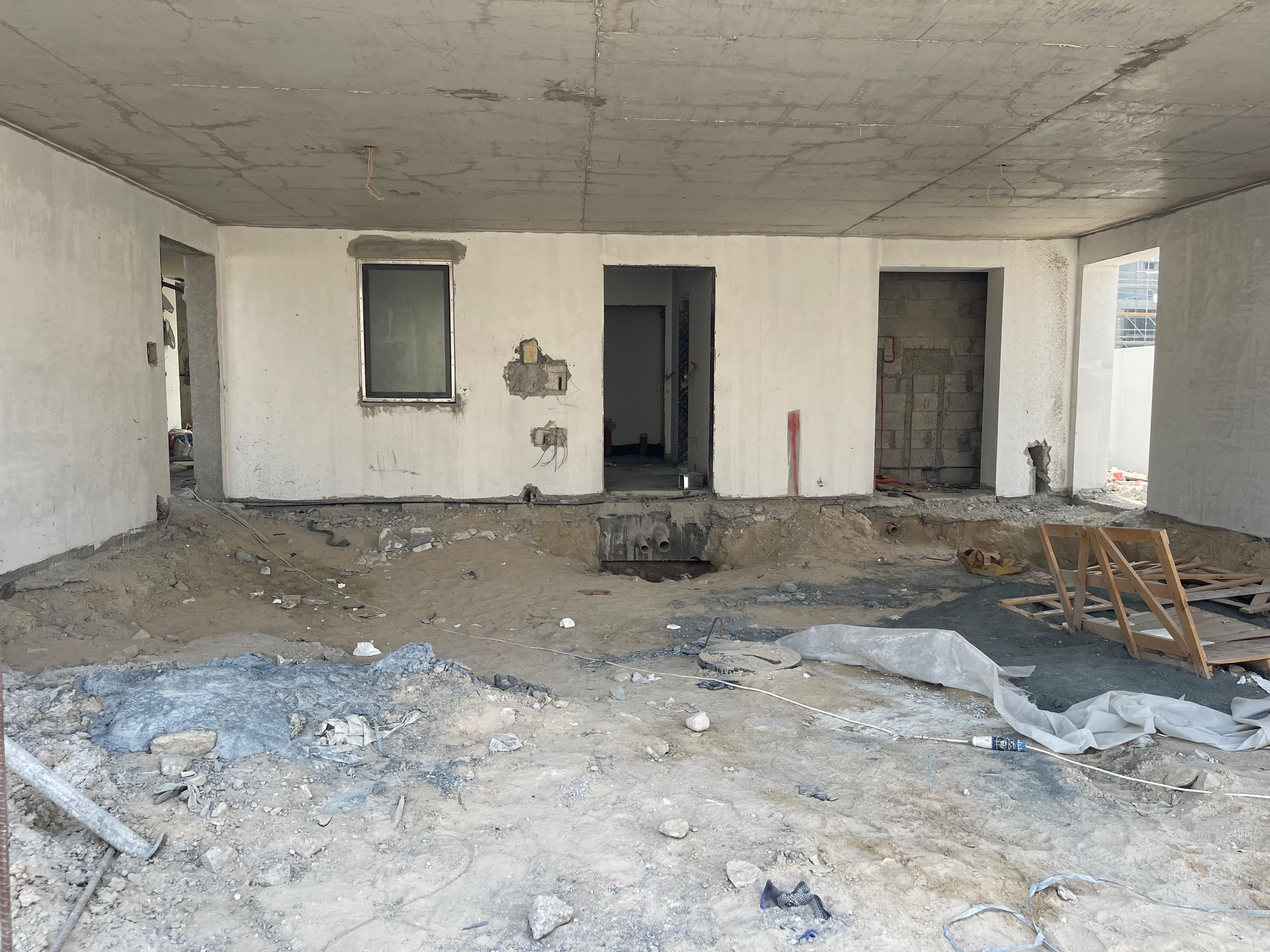

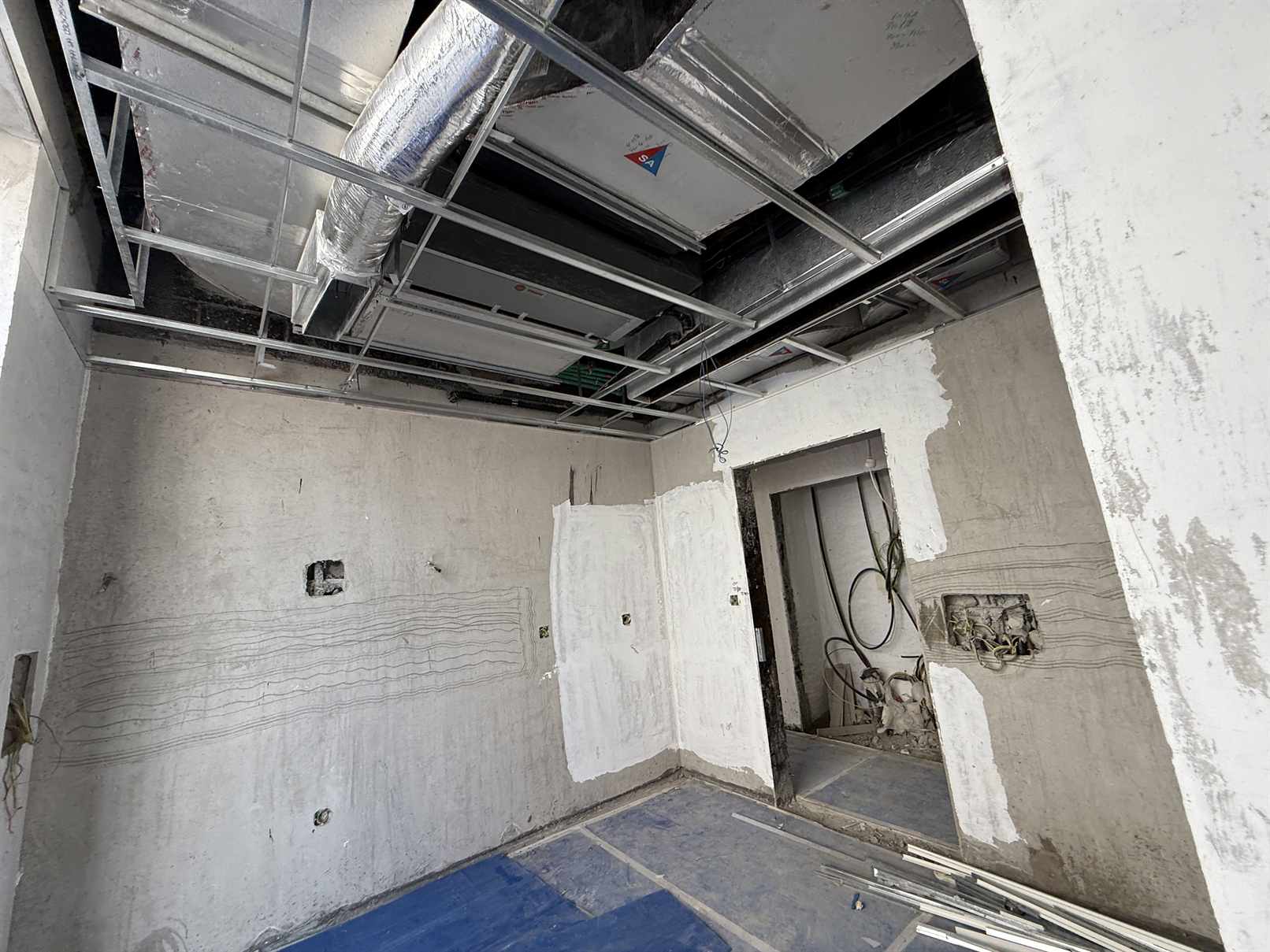

1 October 202542% built

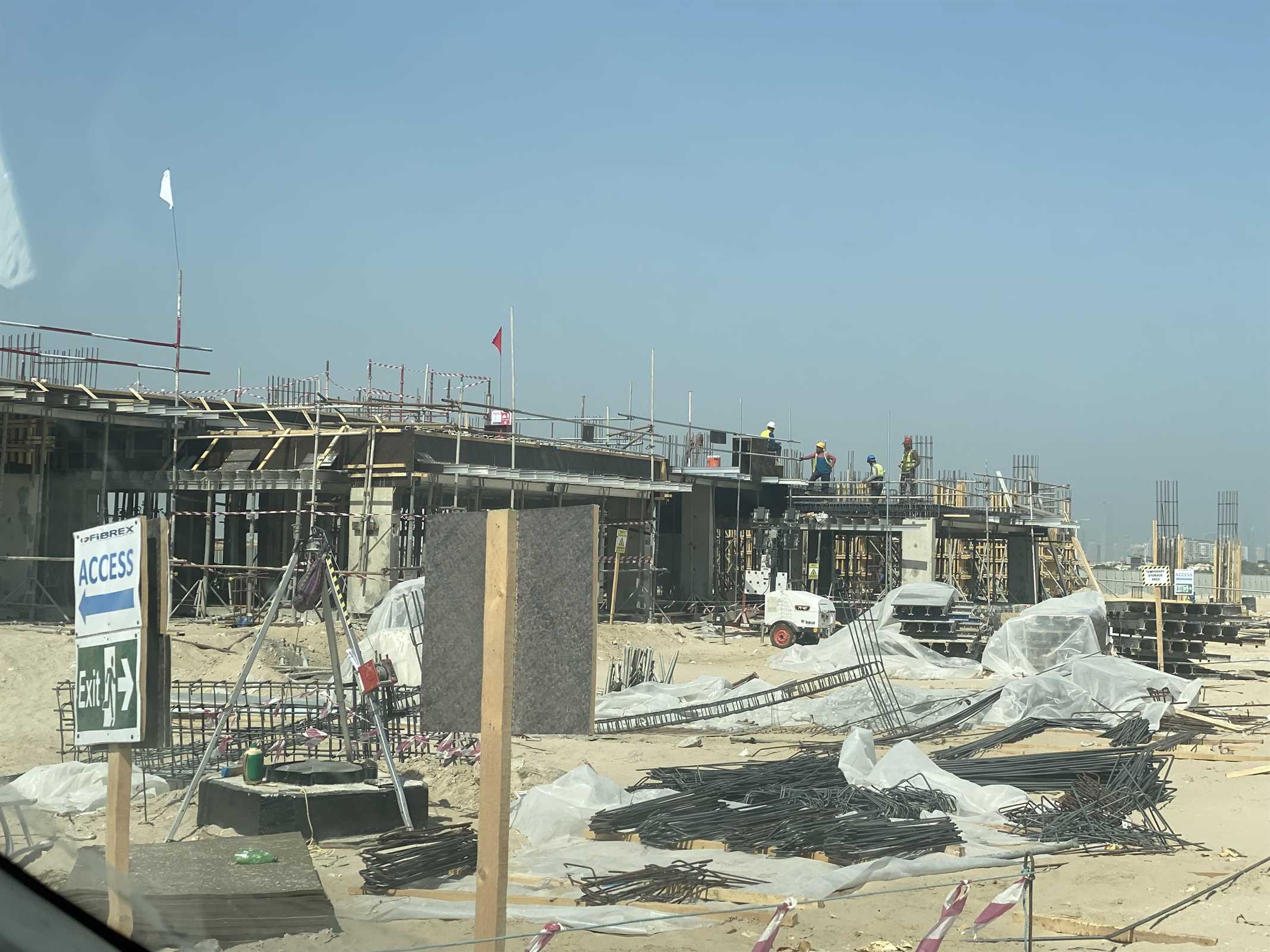

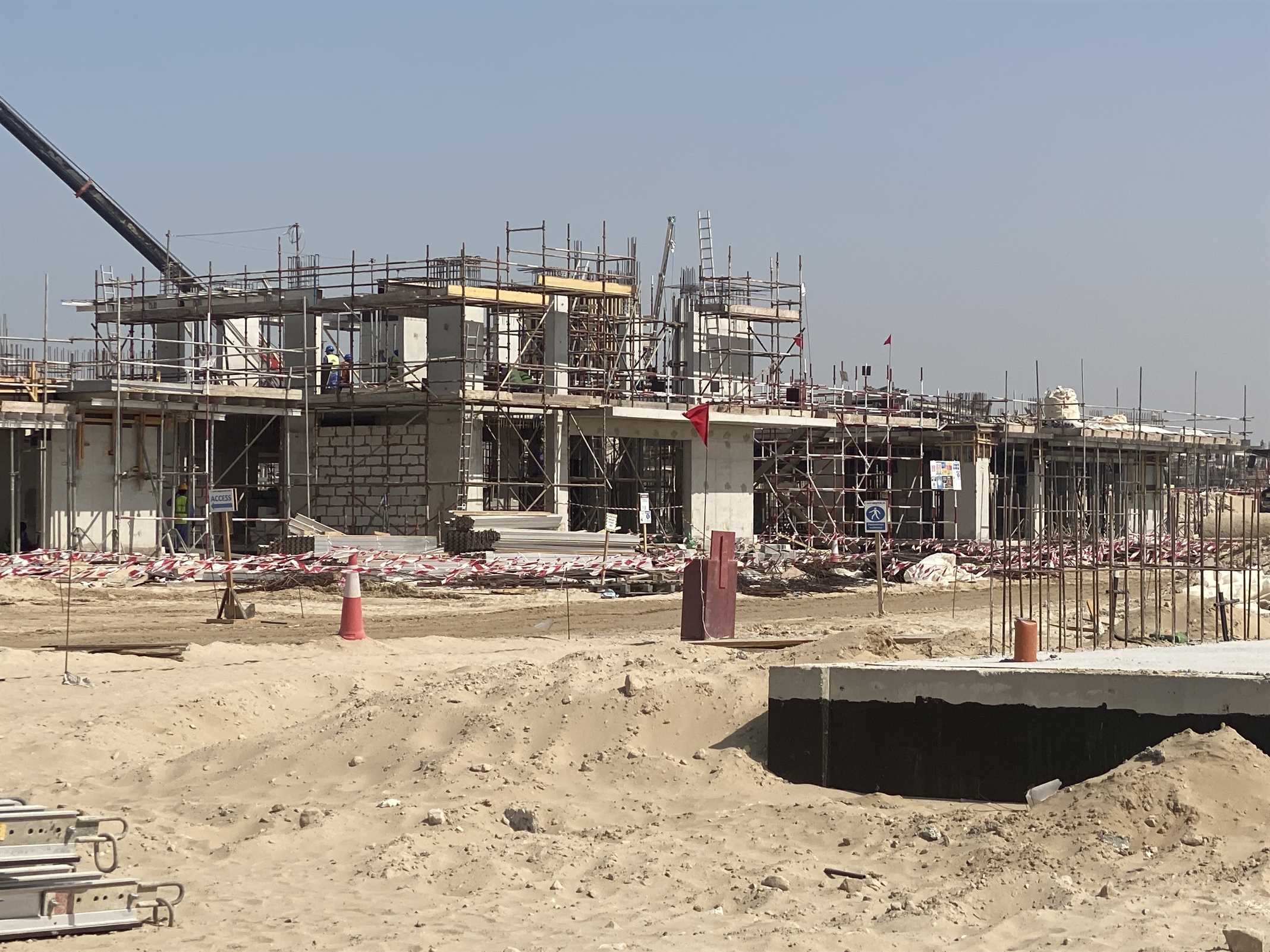

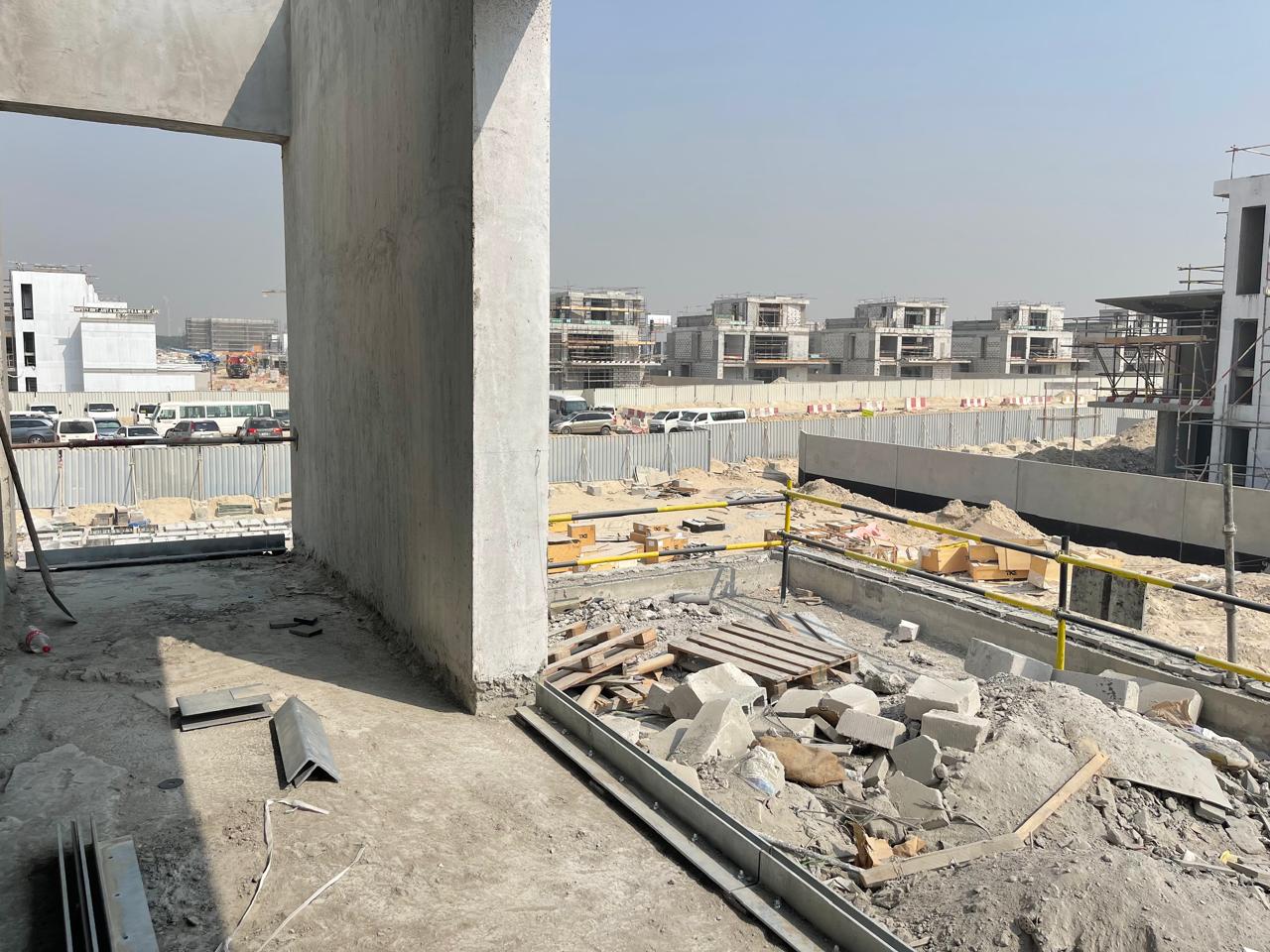

3 June 202534% built

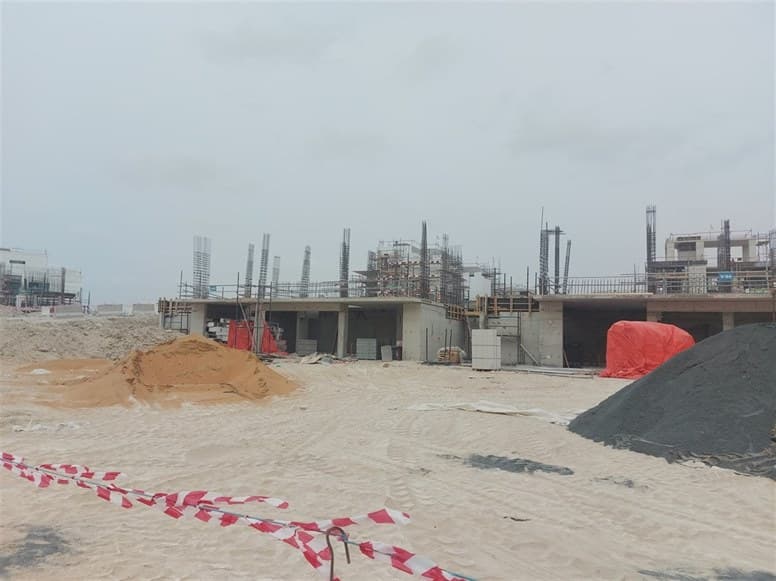

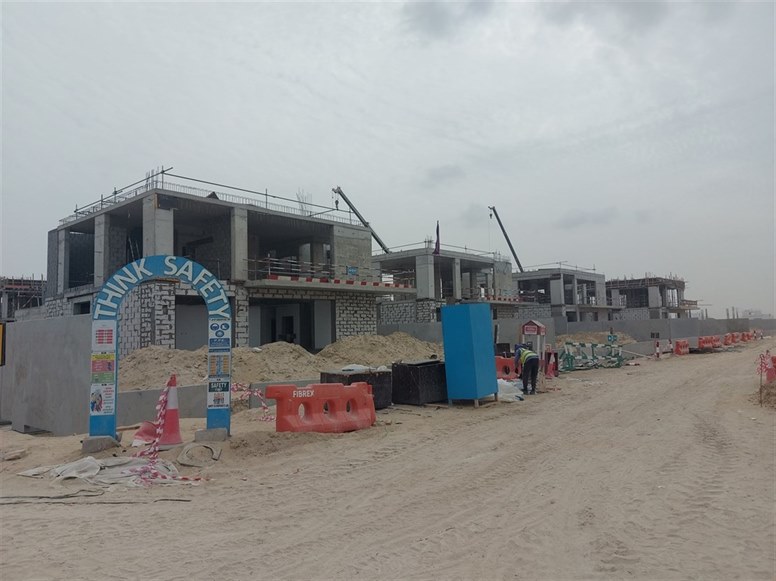

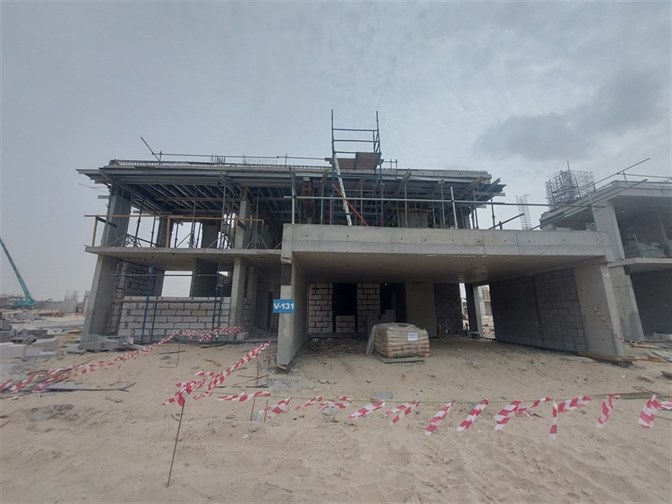

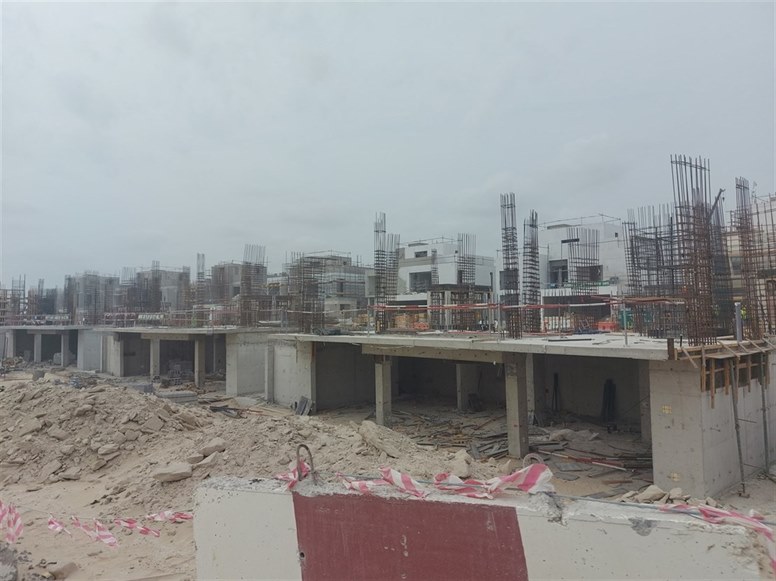

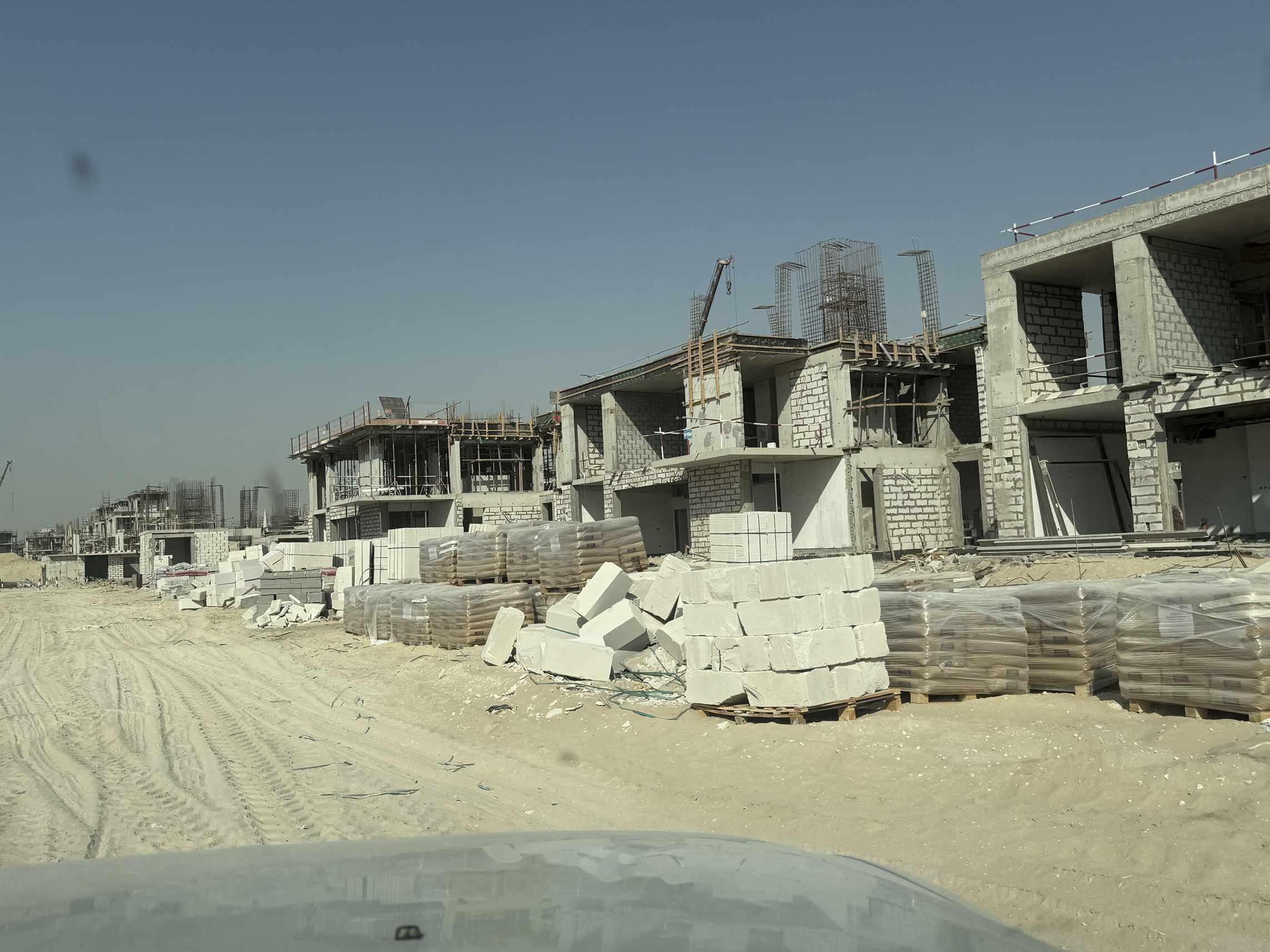

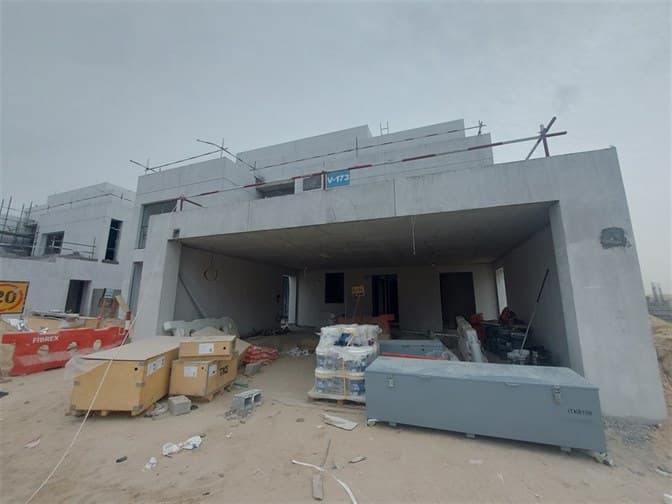

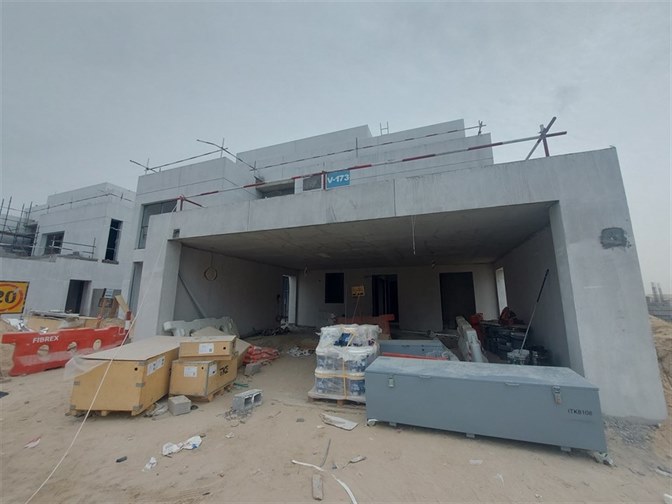

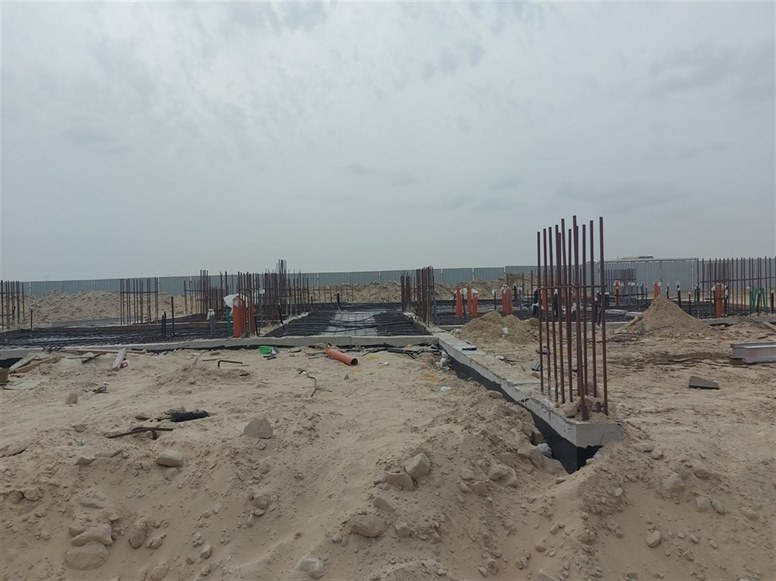

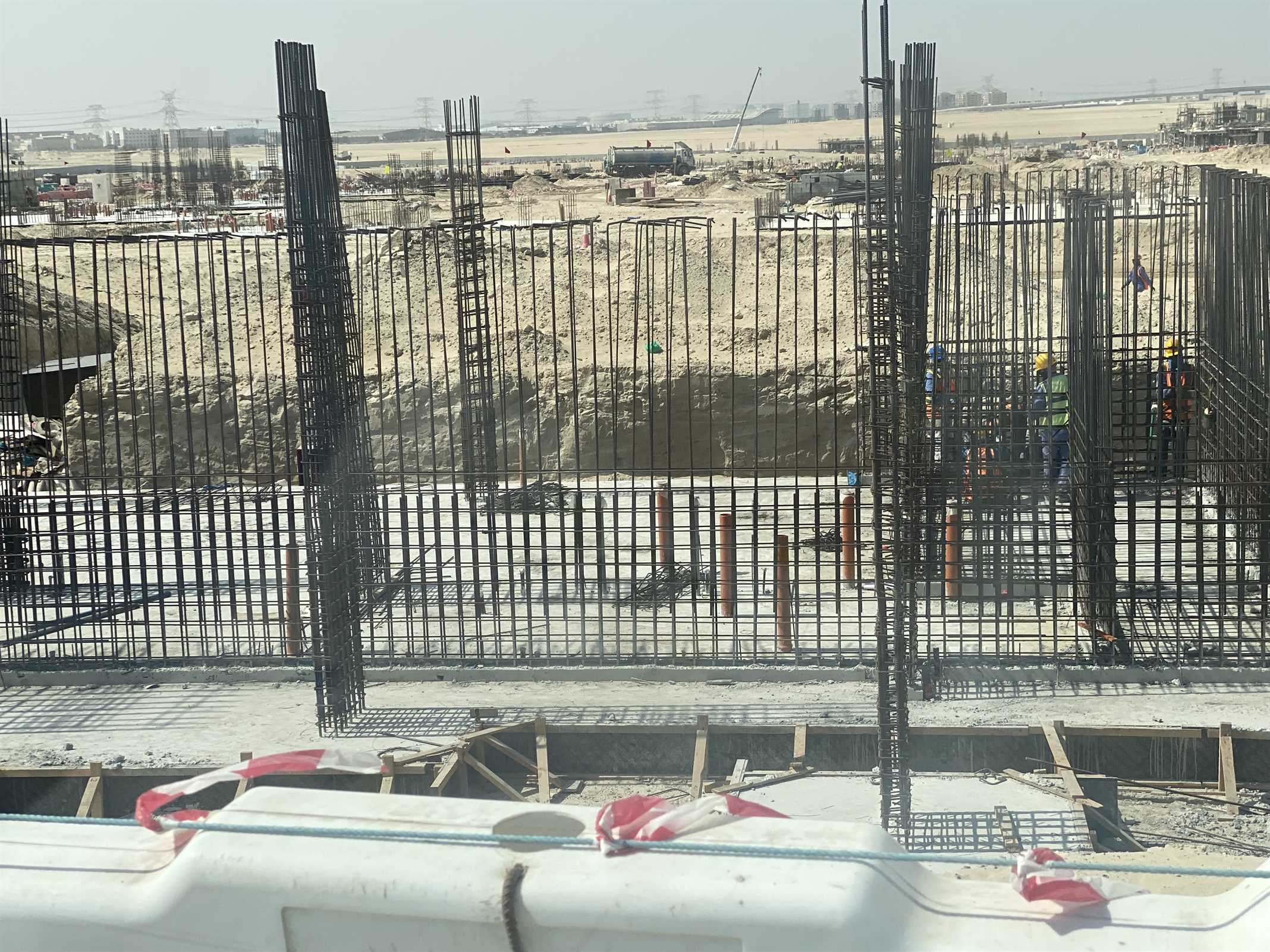

24 February 202522% built

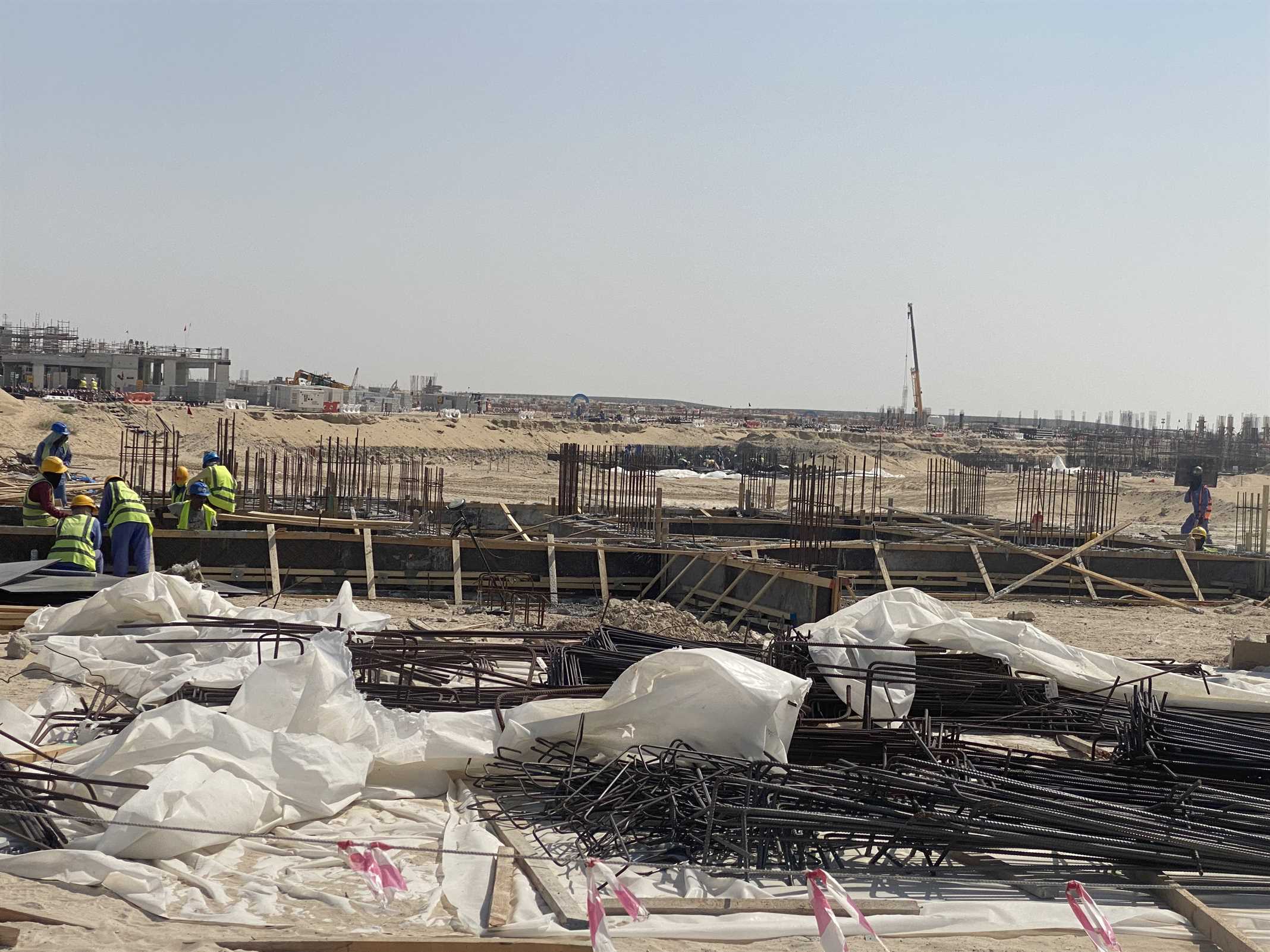

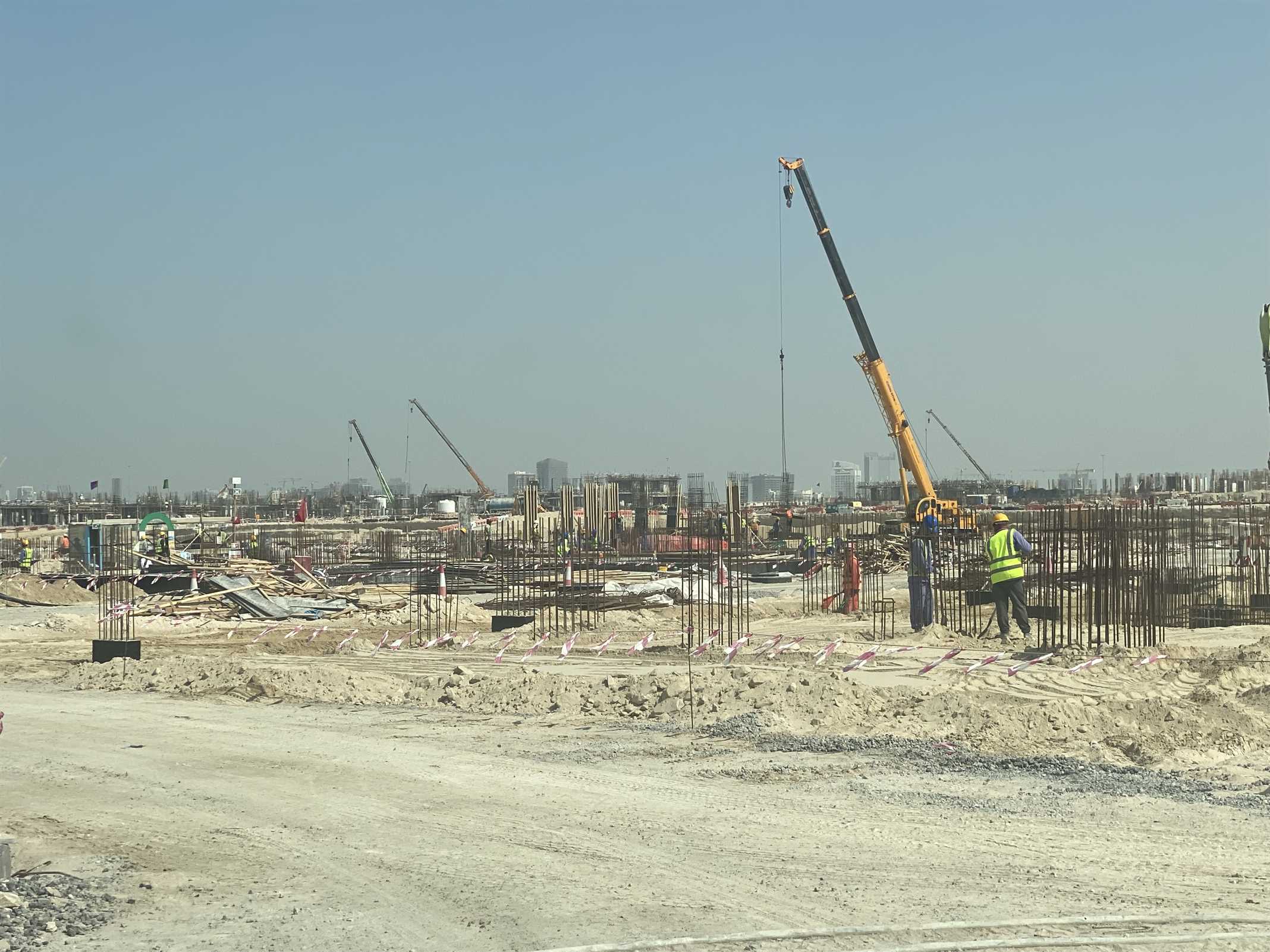

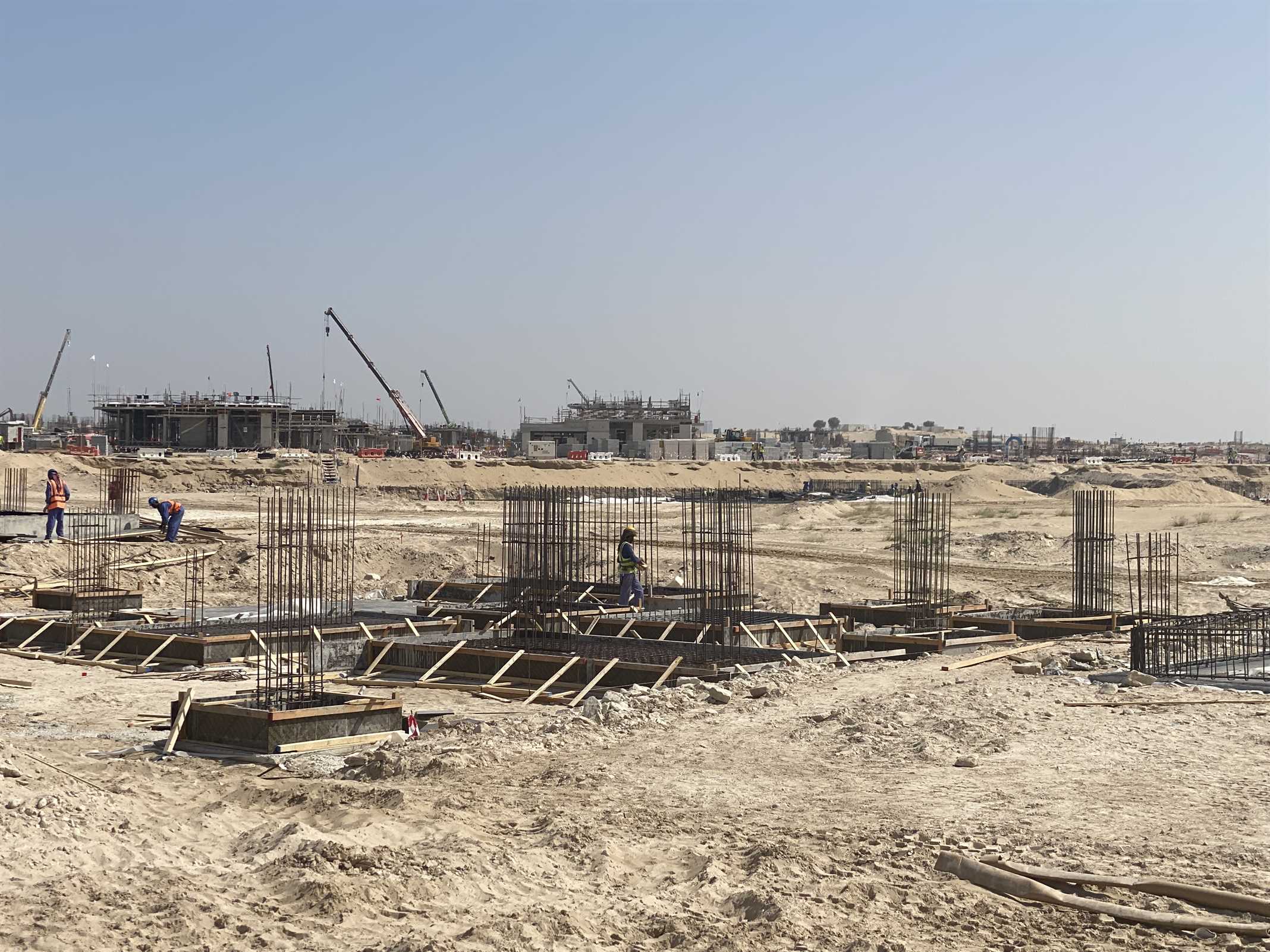

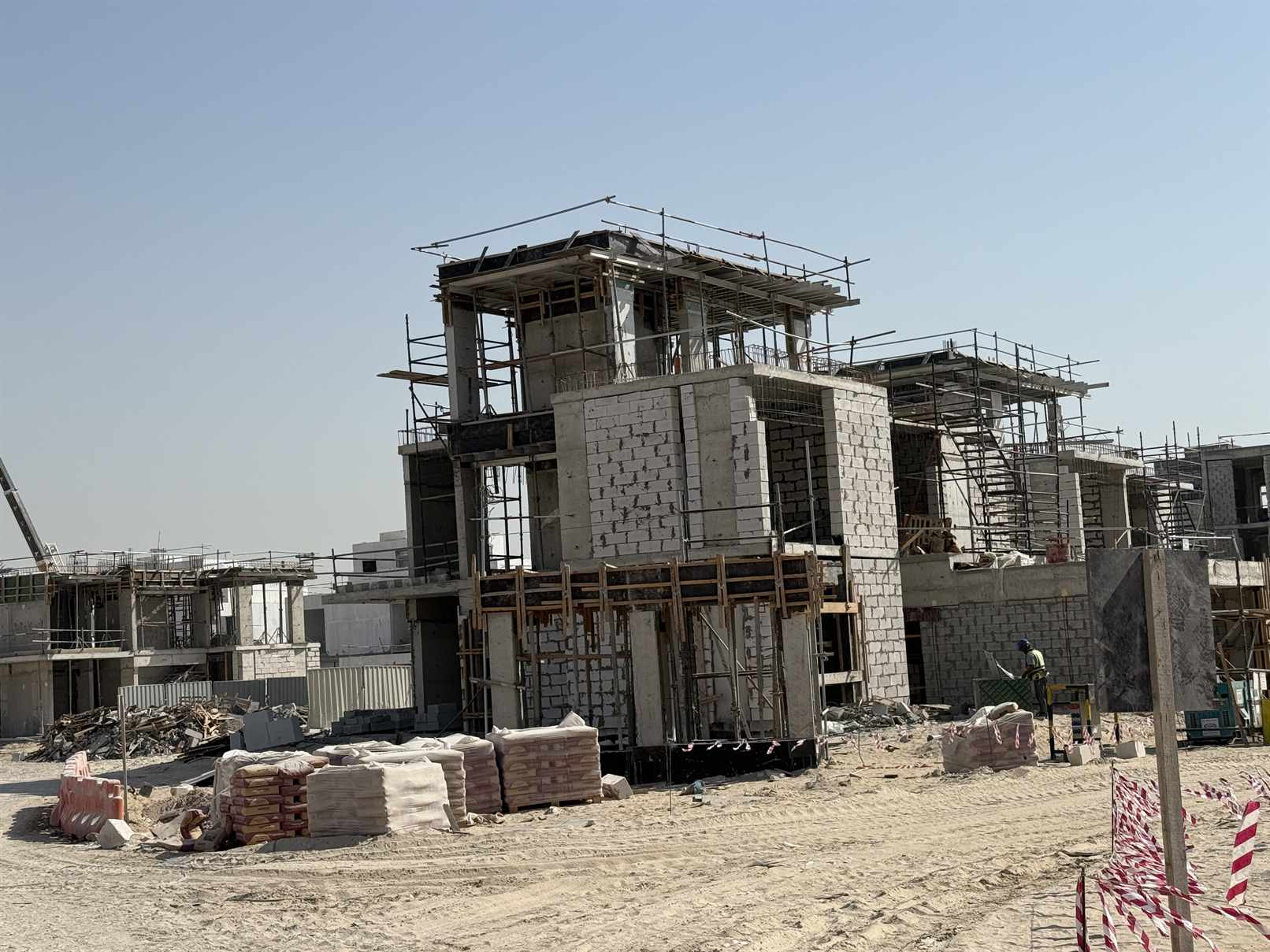

15 October 20246.5% built

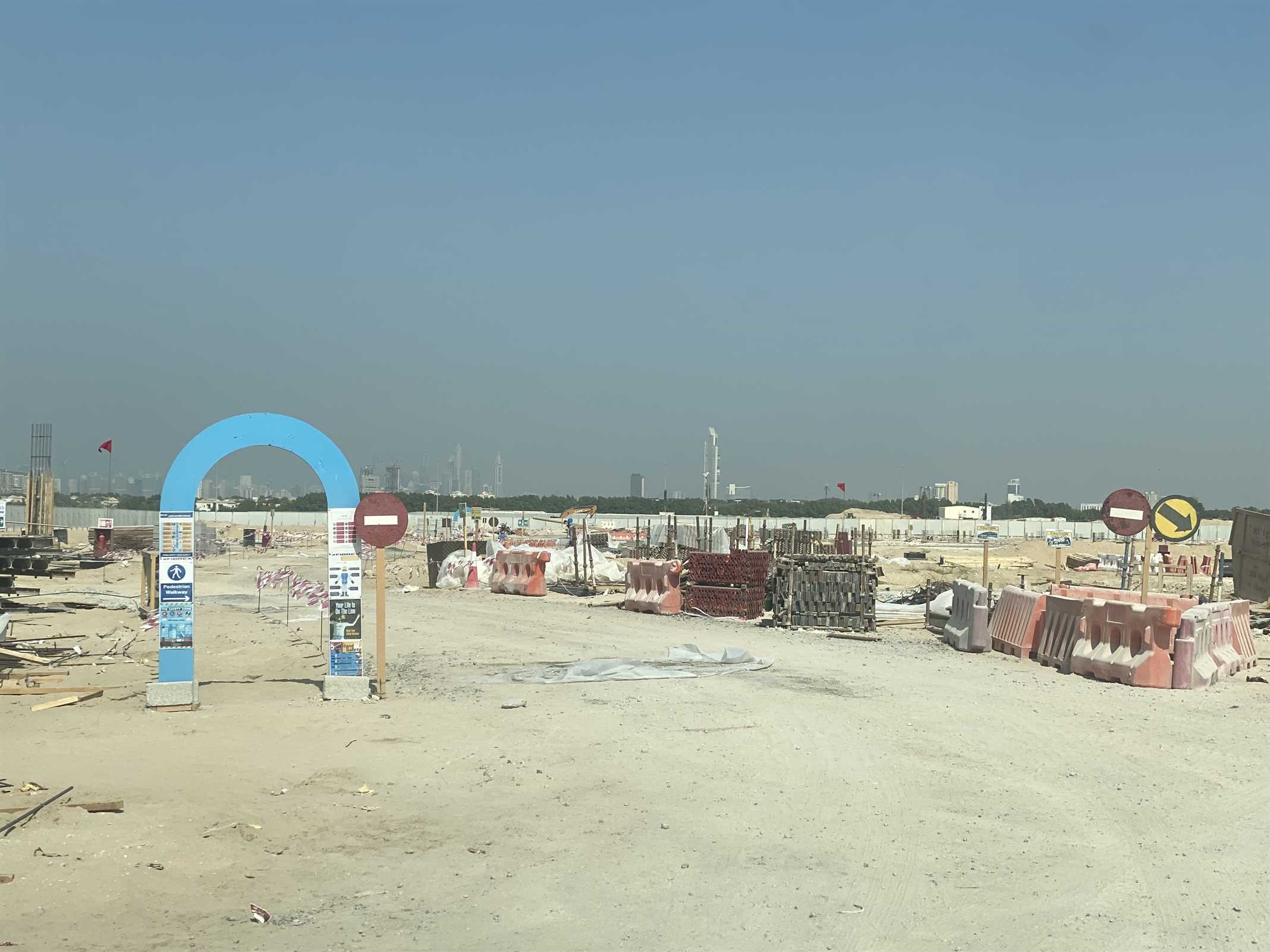

25 July 20230% built

Back to The Oasis - Palmiera construction progress

All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
