Mar Casa construction progress
Mar Casa in Dubai Maritime City was registered to complete in October 2026 and is still under construction. At the last site inspection, in October 2026, it was 67% built. The developer is Deyaar Development.
67%
Built, at the site inspection of 29 October 2026
1 months past its registered completion date
- Registered completion date
- October 2026
- Finish at recent pace
- September 2027
- Construction started
- September 2023
- First registered
- March 2023
- Developer
- Deyaar Development
- Community
- Dubai Maritime City
- Units
- 585
- Escrow bank
- First Abu Dhabi Bank
- Name in Arabic
- ماركاسا
- Project number
- 2589
- Site inspections
- 8
Schedule
Mar Casa was registered to complete in October 2026, 1 month ago, and is still under construction. Over the last year of inspections it has added about 3.2 points a month. Kept at that rate, the site would reach 100% around September 2027.
Site inspections
29 October 2026
67%+10 pts
4 August 2026
56%+8.2 pts
4 May 2026
48%+14 pts
22 December 2025
34%+14 pts
11 June 2025
20%+5.4 pts
2 January 2025
15%+10 pts

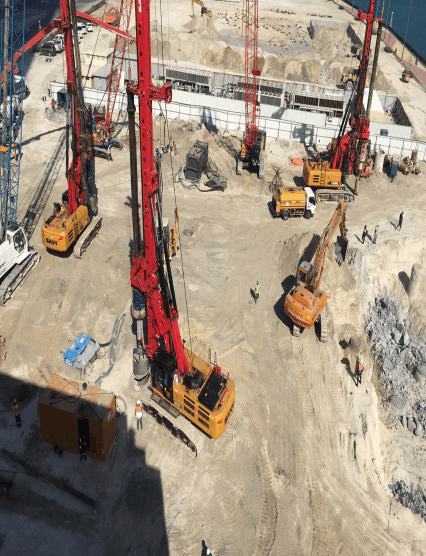

8 March 2024
4.9%+4.9 pts
1 March 2023
0%
Context
Dubai Maritime City has 23 projects under construction, 32% built on average.
Deyaar Development has 9 projects under construction in Dubai; 1 has passed its registered completion date.
Own a unit in Mar Casa?
Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When is the Mar Casa handover date?
- The registered completion date was October 2026, and the register still lists Mar Casa as under construction. At the pace of its recent inspections the site would reach 100% around September 2027. RERA asks developers to update their dates as projects move, so check the register before relying on it.
- What is the latest construction update on Mar Casa?
- Mar Casa was 67% built at the site inspection on 29 October 2026. The site has been inspected 8 times since March 2023. The Land Department took 53 site photos at its inspections.
- Is Mar Casa delayed?
- Yes. Its registered completion date of October 2026 has passed and the project is still listed as under construction.
- Who is building Mar Casa?
- The registered developer is Deyaar Development. It has 8 other projects under construction in Dubai.
- Which bank holds the escrow account for Mar Casa?
- First Abu Dhabi Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- Rosalia ResidencesAlso by Deyaar Development. 93%.
- Eleve By DeyaarAlso by Deyaar Development. 20%.
- Elm At Park FiveAlso by Deyaar Development. 16%, Due June 2027.
- Ember At Park FiveAlso by Deyaar Development. 18%, Due June 2027.
- Harbour LightsNearby in Dubai Maritime City. 72%, Due May 2027.
- Aria By BeyondNearby in Dubai Maritime City. 85%, Due January 2026, passed.
- Coral ReefNearby in Dubai Maritime City. 33%.
- Oceanz 1 By DanubeNearby in Dubai Maritime City. 50%.
- Checking an off-plan project's progressHow to read the completion percentage and what escrow allows when a payment runs ahead.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.








.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)












.jpg&w=3840&q=75)
.jpg&w=3840&q=75)
