Aria By Beyond construction progress
Aria By Beyond in Dubai Maritime City was registered to complete in January 2026 and is still under construction. At the last site inspection, in September 2026, it was 85% built. The developer is Blue Star Real Estate Development.
85%
Built, at the site inspection of 30 September 2026
10 months past its registered completion date
- Registered completion date
- January 2026
- Finish at recent pace
- February 2027
- Construction started
- August 2023
- First registered
- September 2024
- Developer
- Blue Star Real Estate Development
- Community
- Dubai Maritime City
- Units
- 192
- Escrow bank
- Abu Dhabi Commercial Bank
- Name in Arabic
- آريا من بيوند
- Project number
- 2726
- Site inspections
- 8
Schedule
Aria By Beyond was registered to complete in January 2026, 10 months ago, and is still under construction. Over the last year of inspections it has added about 3.6 points a month. Kept at that rate, the site would reach 100% around February 2027.
Site inspections
30 September 2026
85%+11 pts

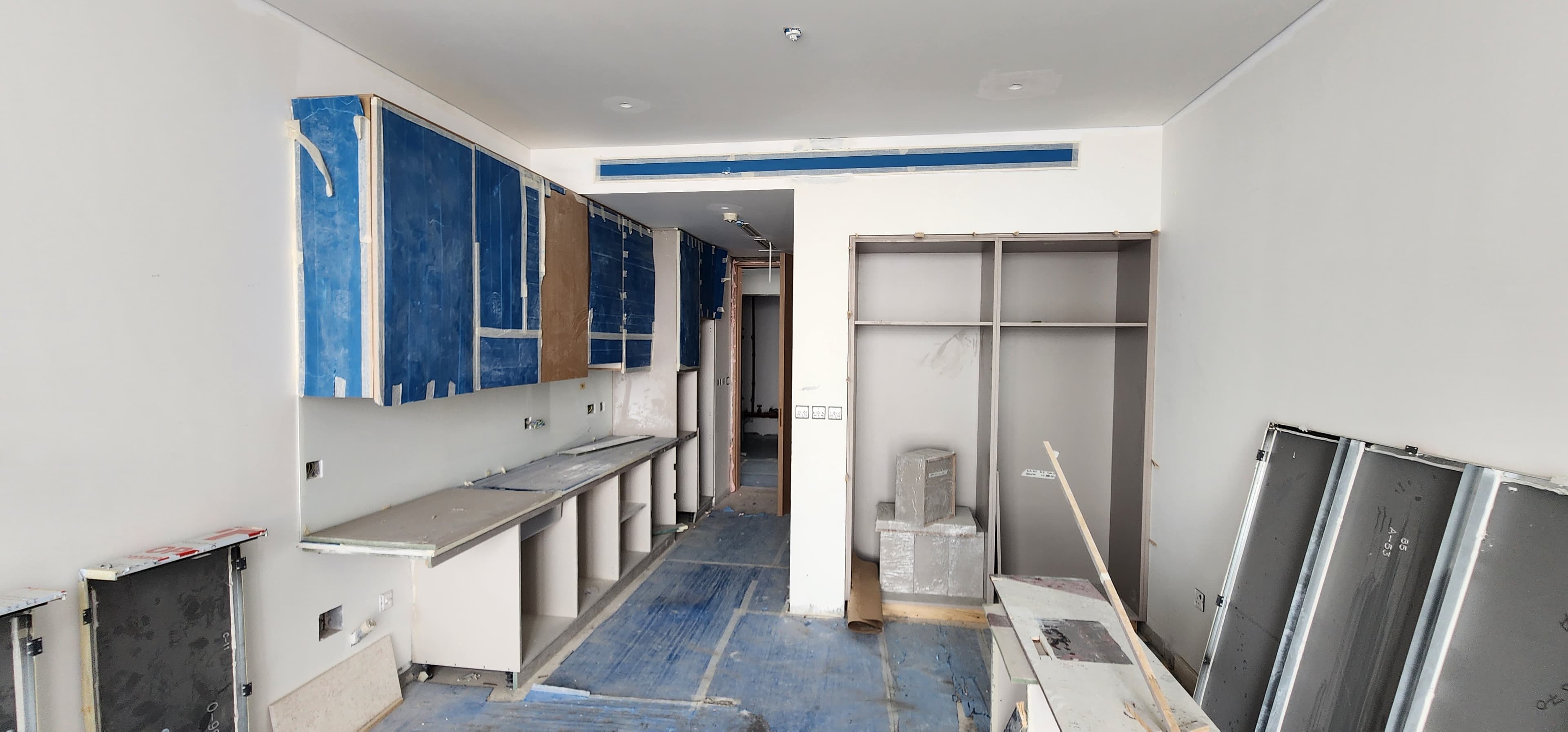

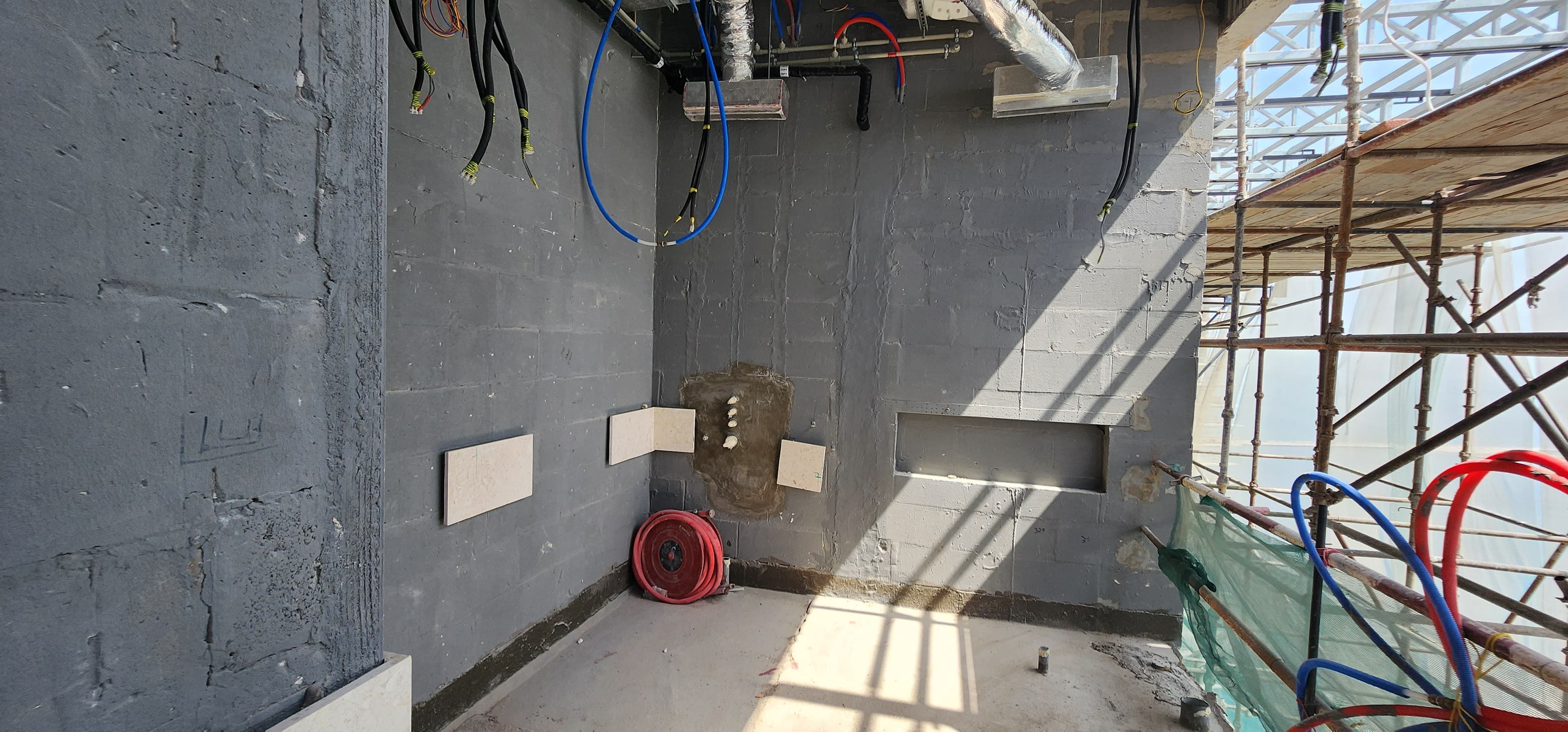

3 July 2026
74%+9.0 pts

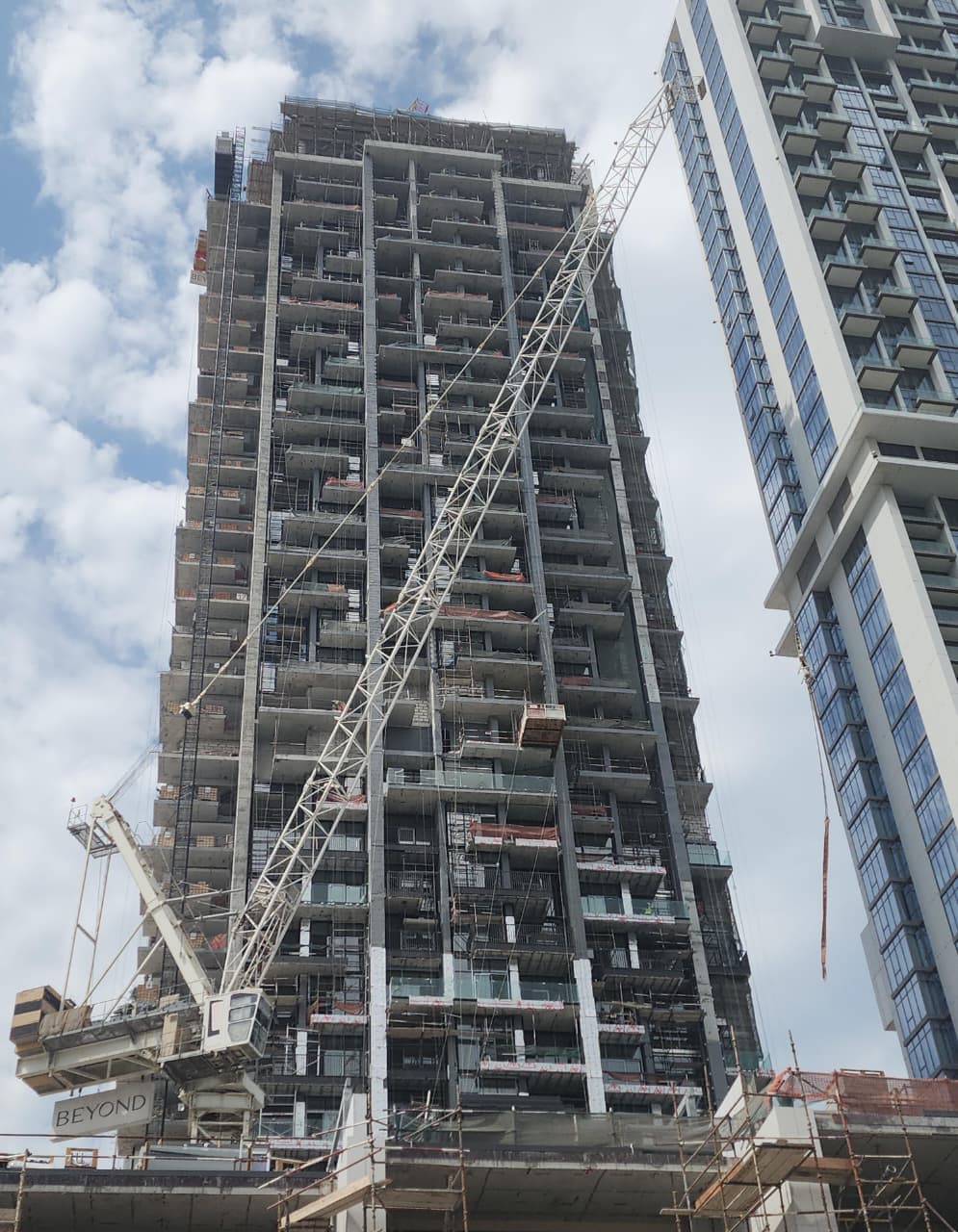

25 March 2026
65%+13 pts
23 December 2025
52%+11 pts
30 August 2025
40%+9.8 pts
28 May 2025
30%+15 pts

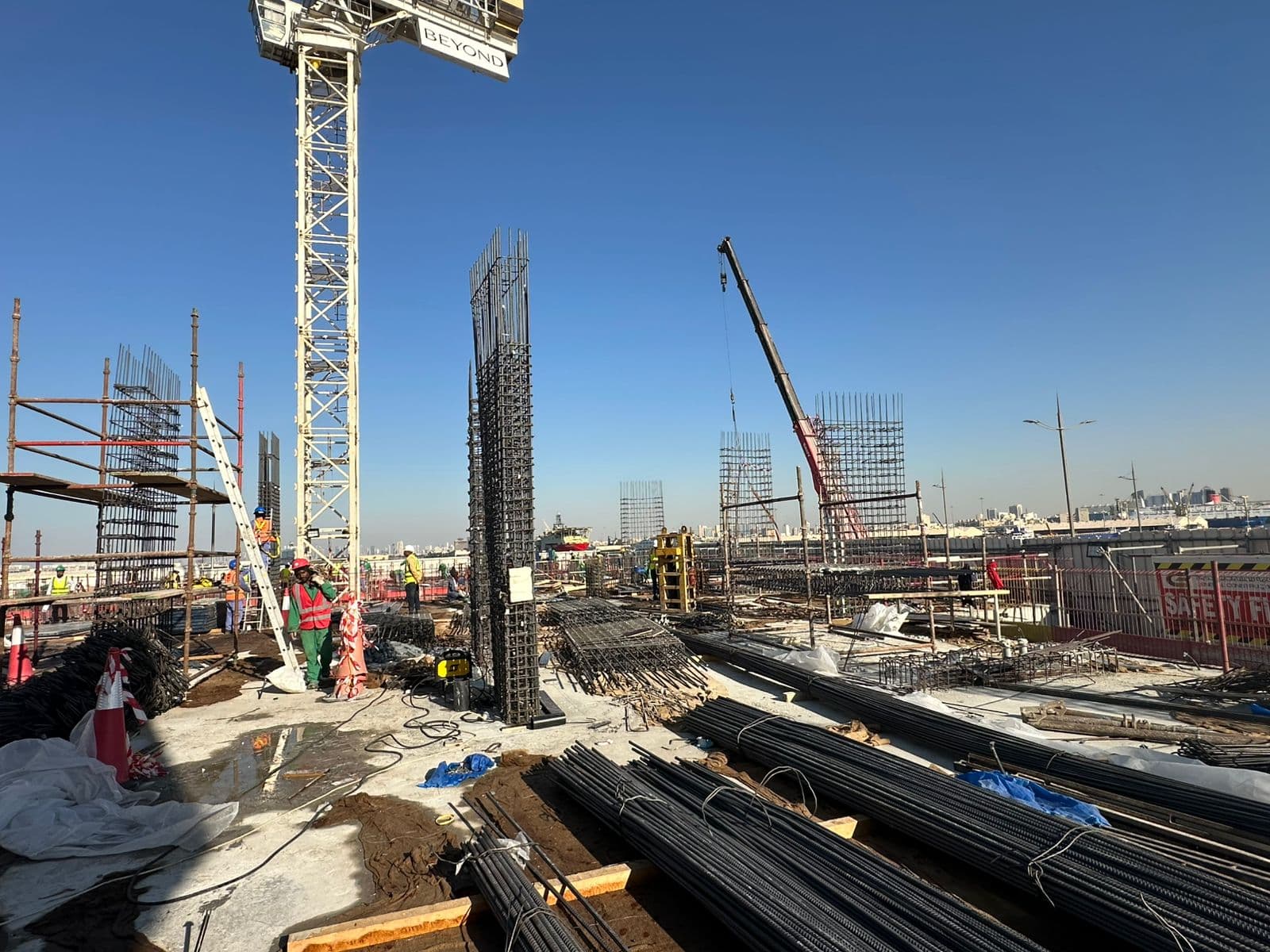

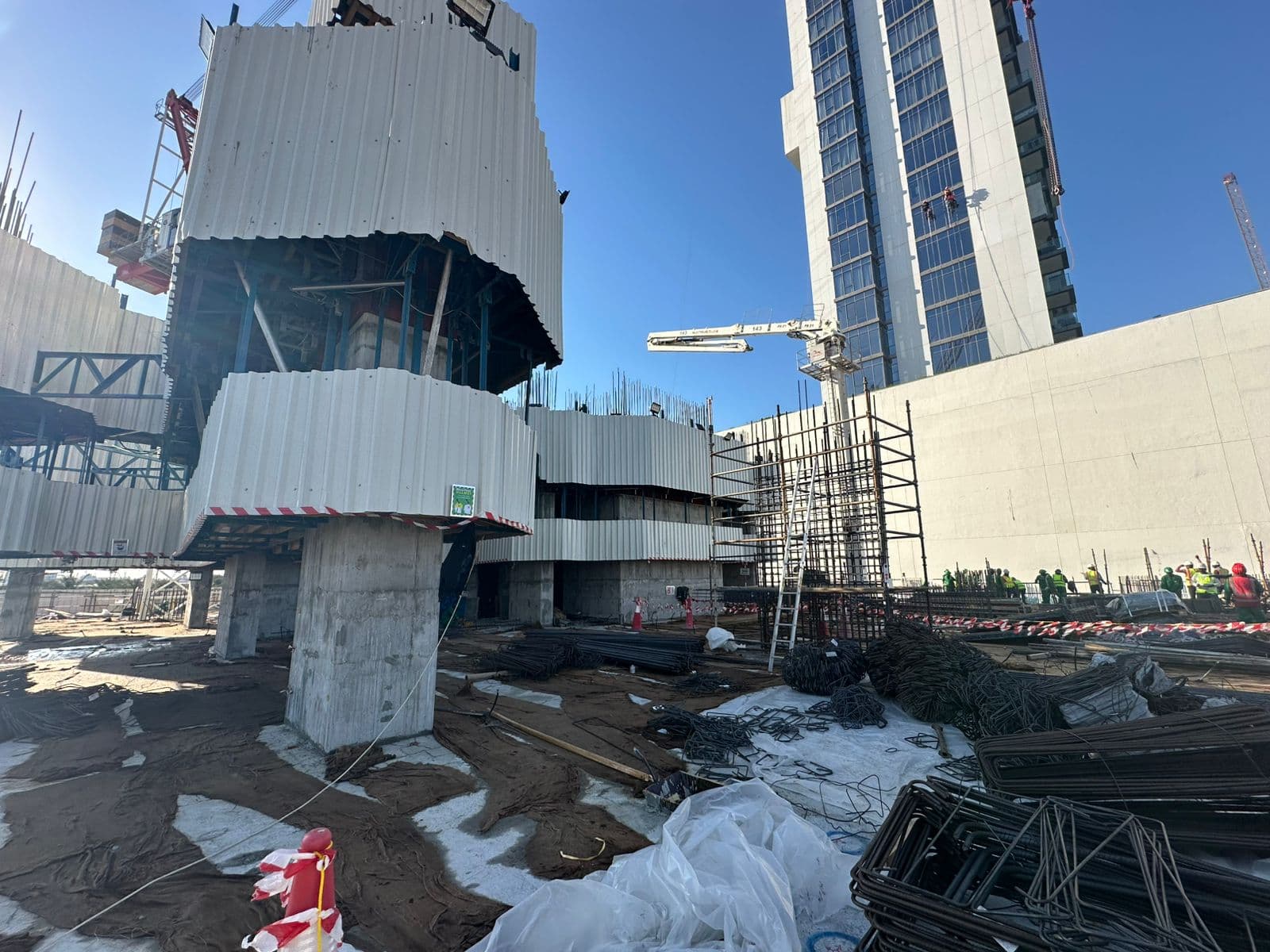

7 January 2025
16%+16 pts
25 July 2024
0%
Context
Dubai Maritime City has 23 projects under construction, 32% built on average.
Own a unit in Aria By Beyond?
Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When is the Aria By Beyond handover date?
- The registered completion date was January 2026, and the register still lists Aria By Beyond as under construction. At the pace of its recent inspections the site would reach 100% around February 2027. RERA asks developers to update their dates as projects move, so check the register before relying on it.
- What is the latest construction update on Aria By Beyond?
- Aria By Beyond was 85% built at the site inspection on 30 September 2026. The site has been inspected 8 times since July 2024. The Land Department took 66 site photos at its inspections.
- Is Aria By Beyond delayed?
- Yes. Its registered completion date of January 2026 has passed and the project is still listed as under construction.
- Who is building Aria By Beyond?
- The registered developer is Blue Star Real Estate Development.
- Which bank holds the escrow account for Aria By Beyond?
- Abu Dhabi Commercial Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- Harbour LightsNearby in Dubai Maritime City. 72%, Due May 2027.
- Mar CasaNearby in Dubai Maritime City. 67%, Due October 2026, passed.
- Coral ReefNearby in Dubai Maritime City. 33%.
- Oceanz 1 By DanubeNearby in Dubai Maritime City. 50%.
- Checking an off-plan project's progressHow to read the completion percentage and what escrow allows when a payment runs ahead.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
