Weybridge Gardens 3 construction progress

Weybridge Gardens 3 in Dubai Land Residence Complex was registered to complete in August 2026 and is still under construction. At the last site inspection, in August 2026, it was 24% built. The developer is Leos Development.

24%

Built, at the site inspection of 5 August 2026

3 months past its registered completion date

Registered completion date
August 2026
Finish at recent pace
August 2029
Construction started
December 2024
First registered
September 2024
Units
208
Escrow bank
Emirates Islamic Bank
Name in Arabic
ويبريدج غاردنز 3
Project number
3164
Site inspections
5

Schedule

Weybridge Gardens 3 was registered to complete in August 2026, 3 months ago, and is still under construction. Over the last year of inspections it has added about 2.1 points a month. Kept at that rate, the site would reach 100% around August 2029.

0%25%50%75%100%20252026
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

5 August 2026

24%+5.2 pts

  • Weybridge Gardens 3 construction site, inspection photo 1, 5 August 2026
  • Weybridge Gardens 3 construction site, inspection photo 2, 5 August 2026
  • Weybridge Gardens 3 construction site, inspection photo 3, 5 August 2026
  • Weybridge Gardens 3 construction site, inspection photo 4, 5 August 2026

1 June 2026

19%+3.2 pts

  • Weybridge Gardens 3 construction site, inspection photo 1, 1 June 2026
  • Weybridge Gardens 3 construction site, inspection photo 2, 1 June 2026
  • Weybridge Gardens 3 construction site, inspection photo 3, 1 June 2026
  • Weybridge Gardens 3 construction site, inspection photo 4, 1 June 2026

31 March 2026

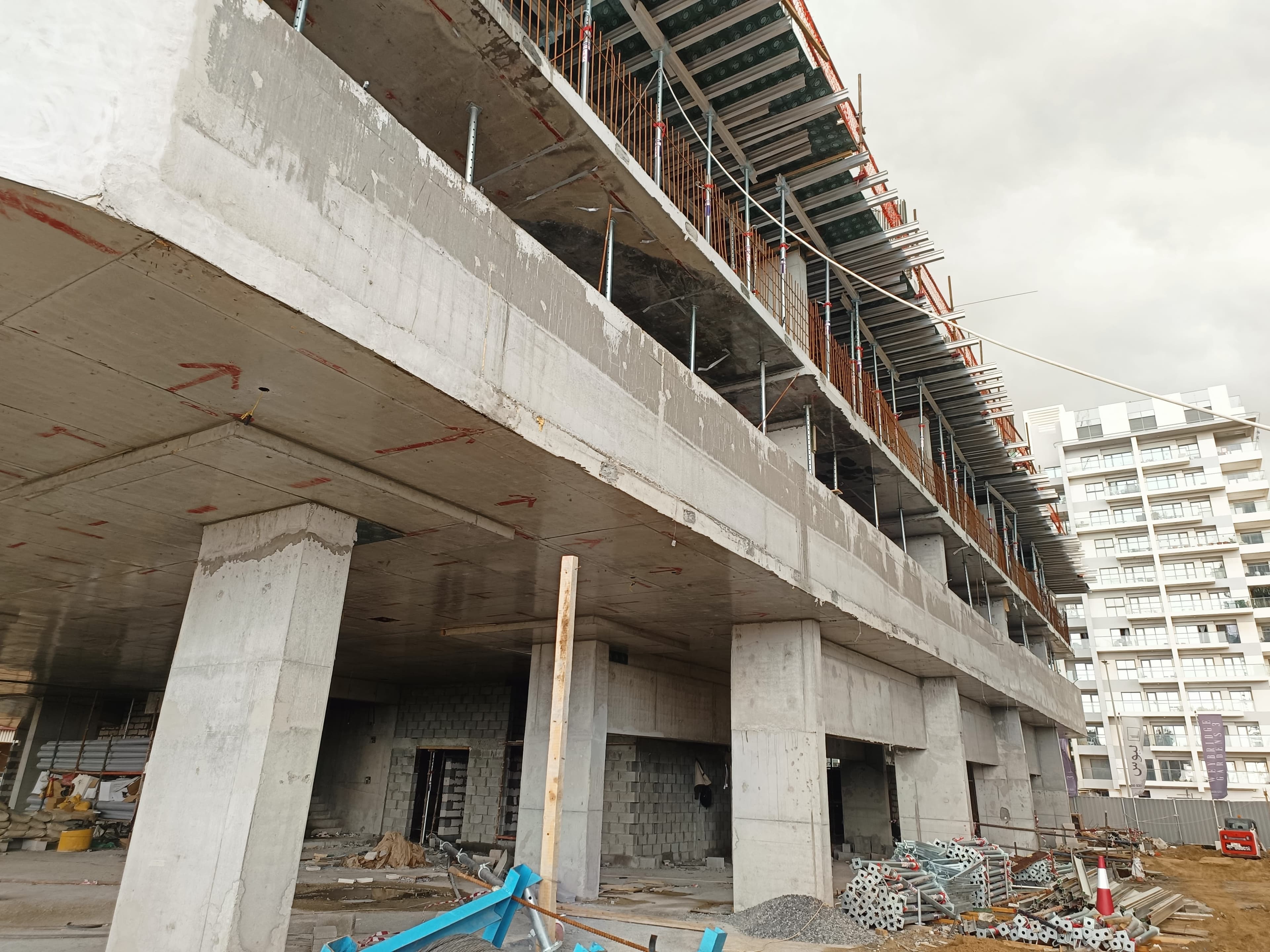

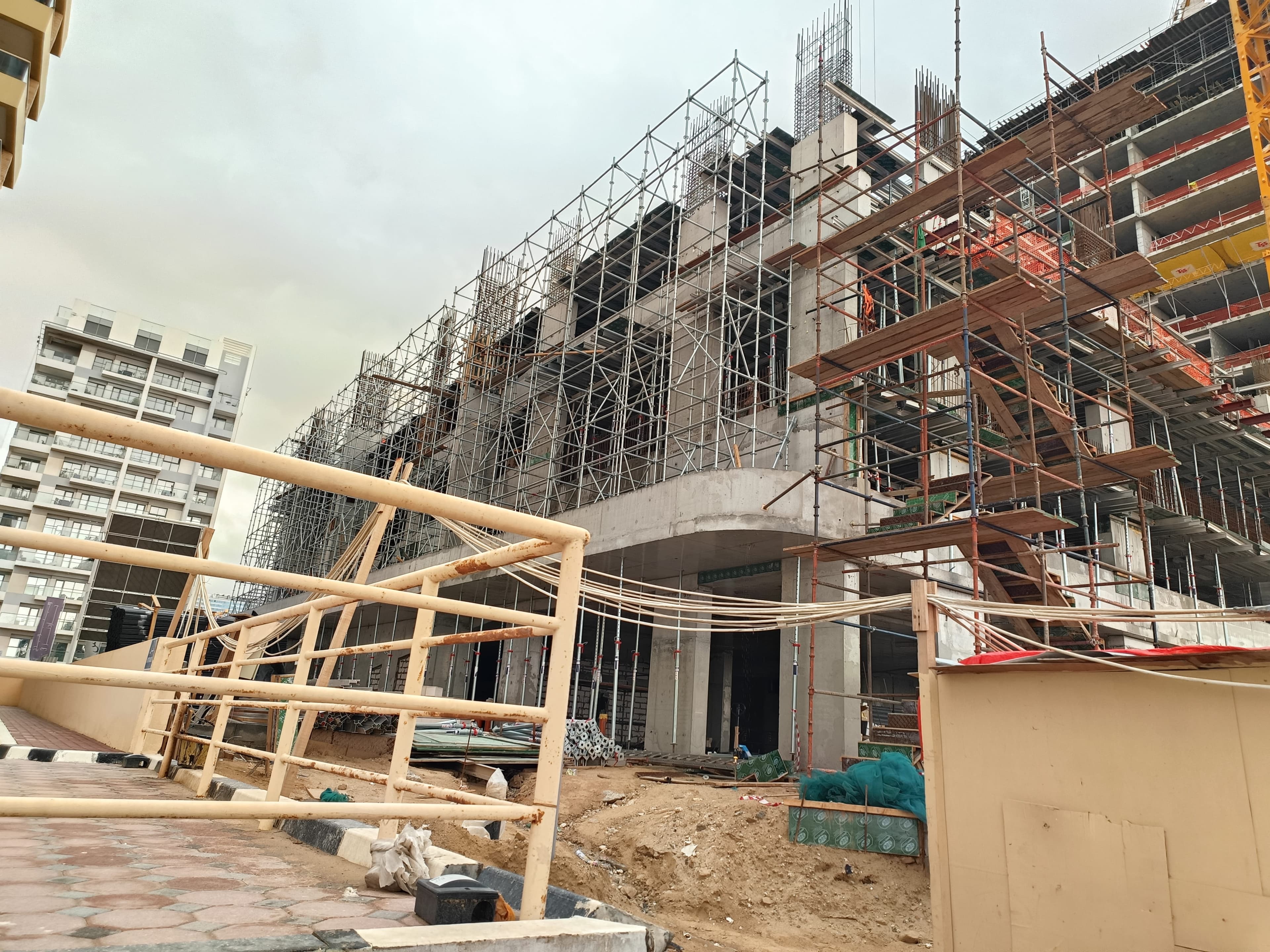

15%+9.6 pts

  • Weybridge Gardens 3 construction site, inspection photo 1, 31 March 2026
  • Weybridge Gardens 3 construction site, inspection photo 2, 31 March 2026
  • Weybridge Gardens 3 construction site, inspection photo 3, 31 March 2026
  • Weybridge Gardens 3 construction site, inspection photo 4, 31 March 2026

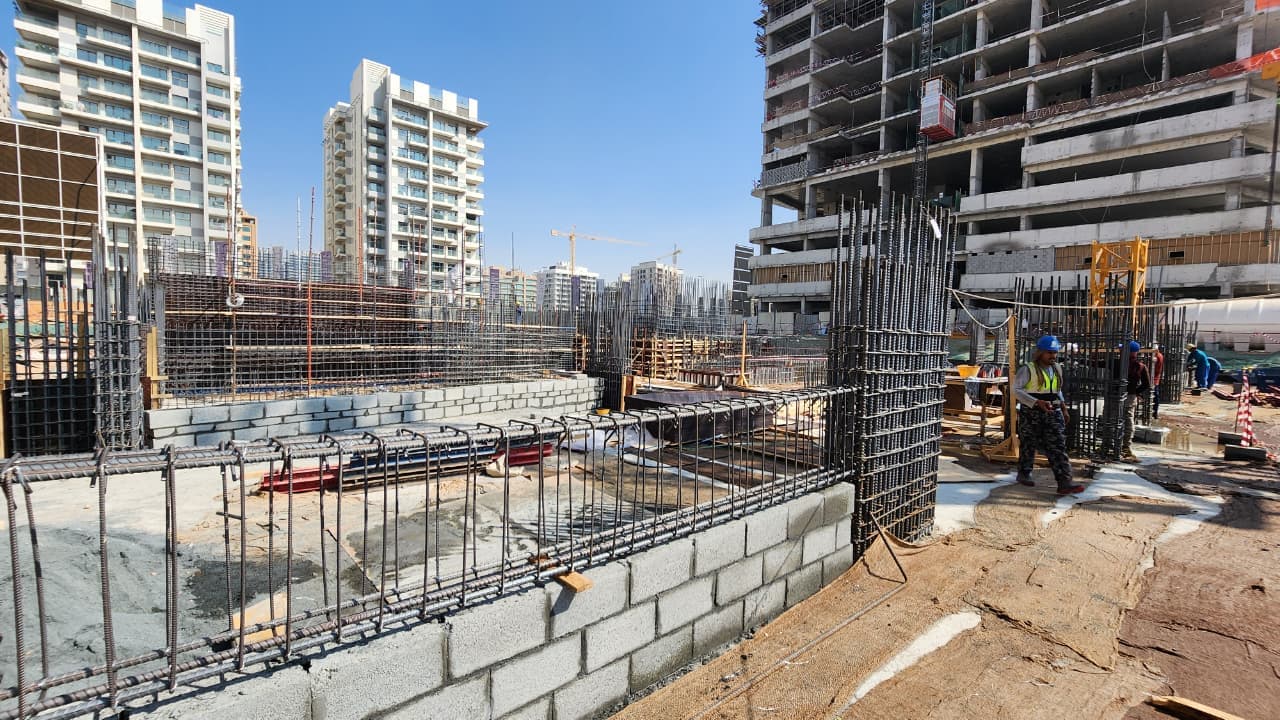

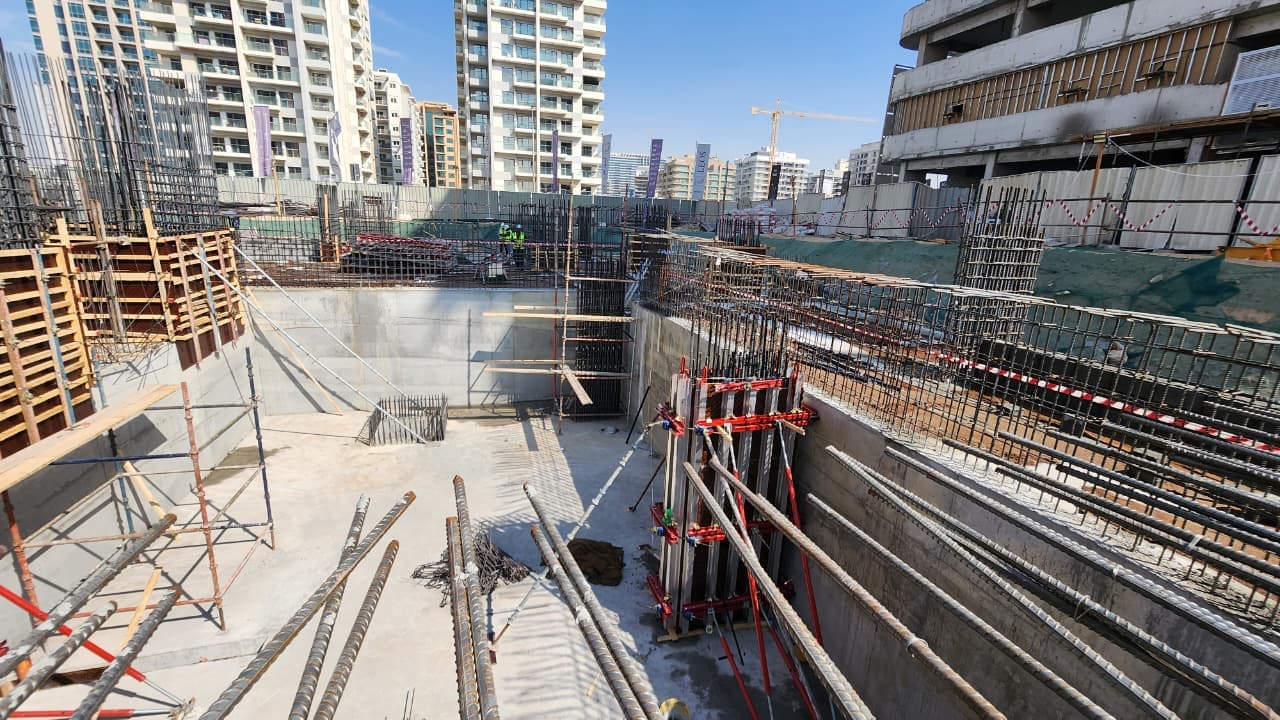

18 November 2025

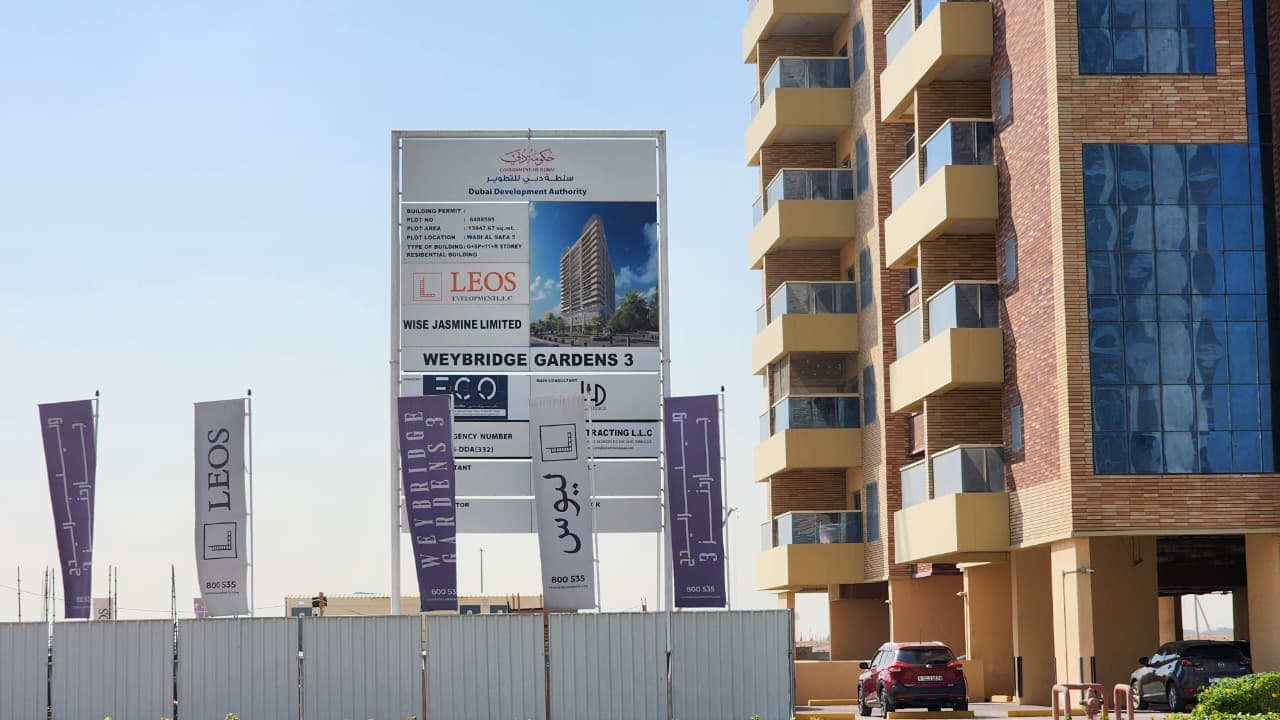

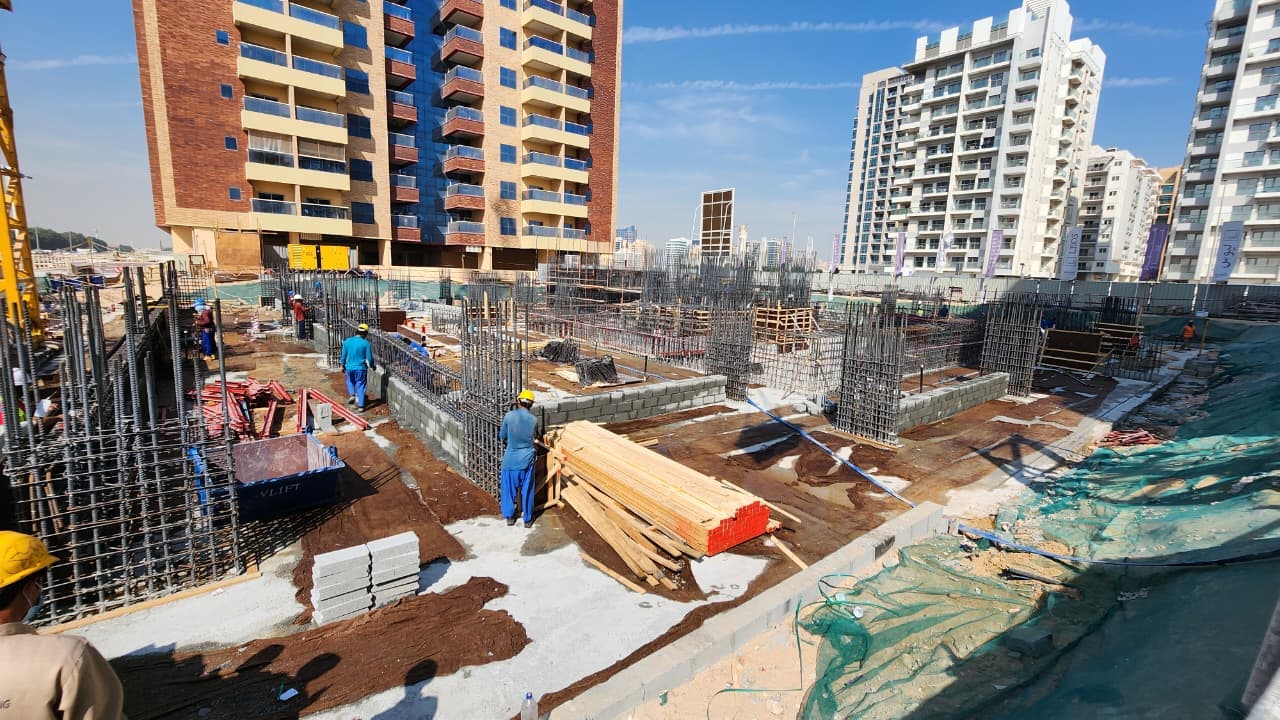

5.9%+5.9 pts

  • Weybridge Gardens 3 construction site, inspection photo 1, 18 November 2025
  • Weybridge Gardens 3 construction site, inspection photo 2, 18 November 2025
  • Weybridge Gardens 3 construction site, inspection photo 3, 18 November 2025
  • Weybridge Gardens 3 construction site, inspection photo 4, 18 November 2025

2 July 2024

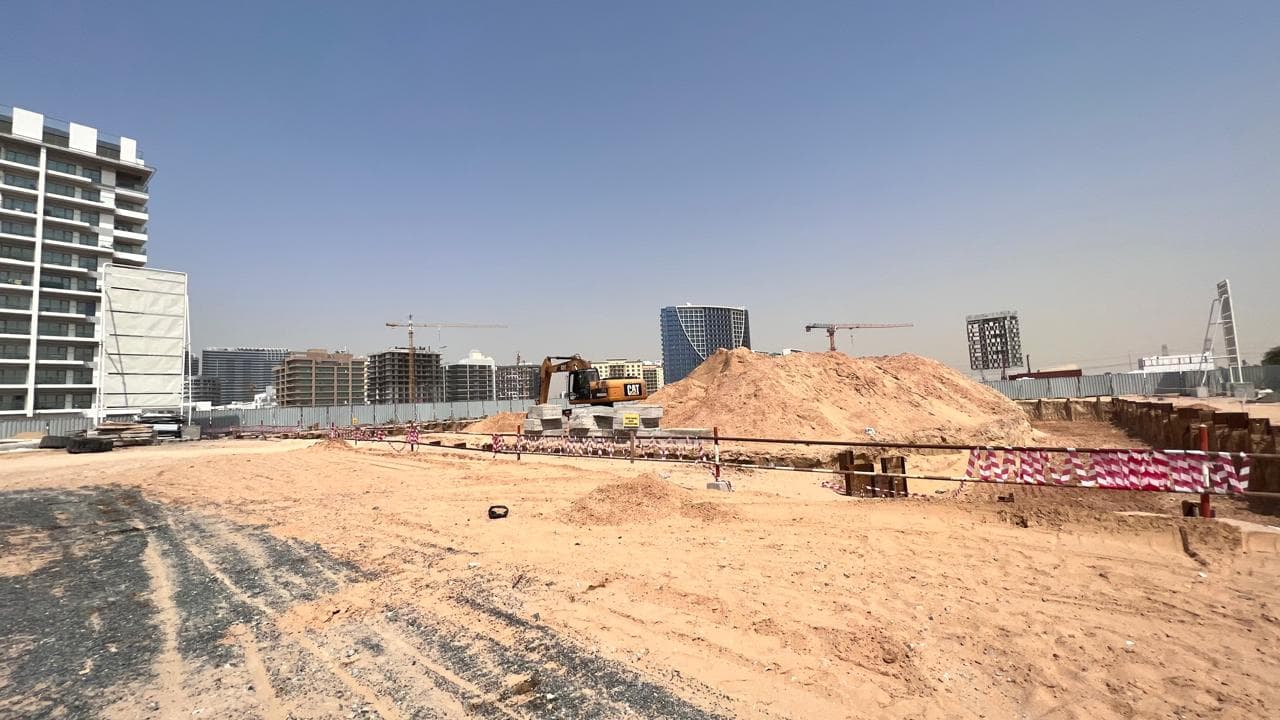

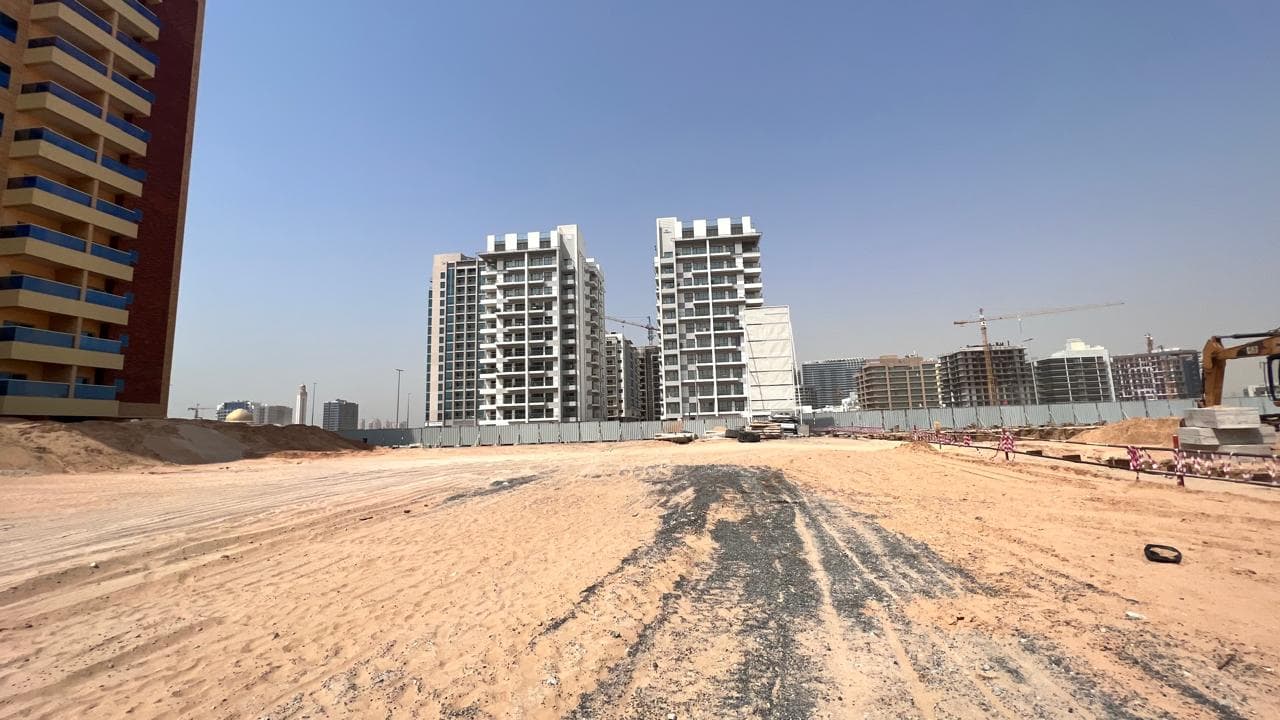

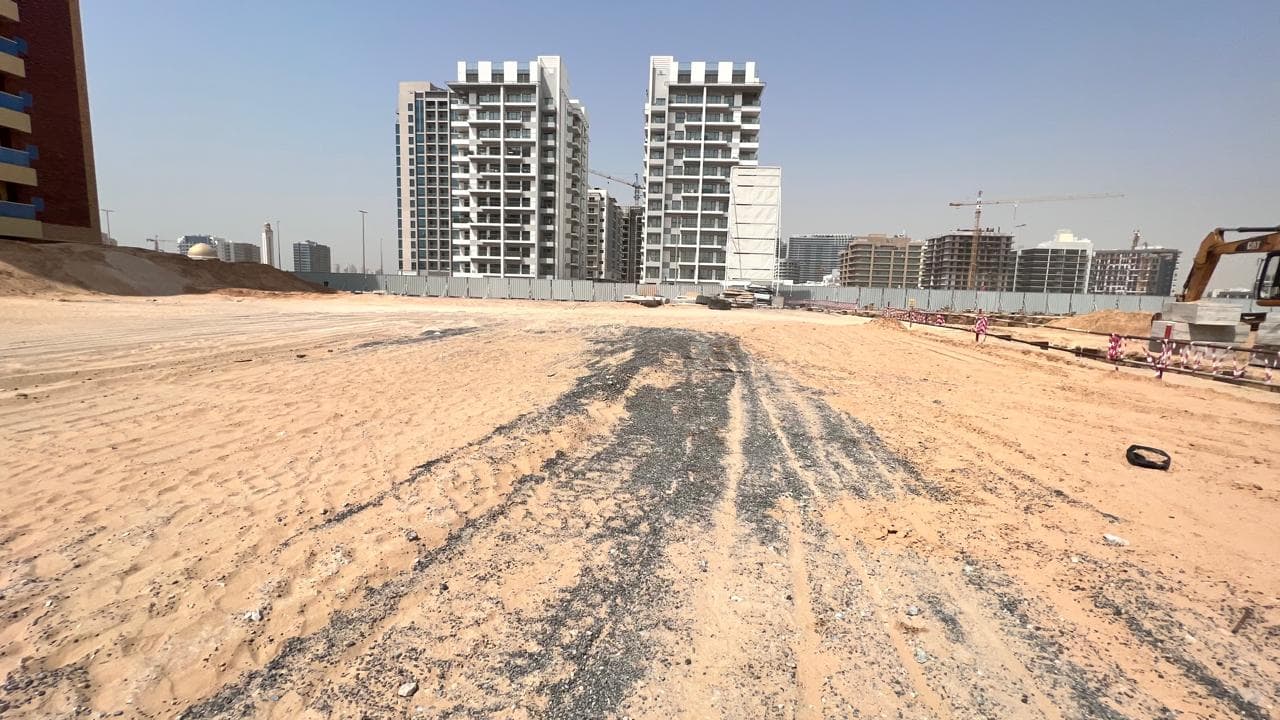

0%

  • Weybridge Gardens 3 construction site, inspection photo 1, 2 July 2024
  • Weybridge Gardens 3 construction site, inspection photo 2, 2 July 2024
  • Weybridge Gardens 3 construction site, inspection photo 3, 2 July 2024

All 33 site photos, by inspection date

Context

Dubai Land Residence Complex has 63 projects under construction, 28% built on average.

Leos Development has 6 projects under construction in Dubai; 1 has passed its registered completion date.

Own a unit in Weybridge Gardens 3?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Weybridge Gardens 3 handover date?
The registered completion date was August 2026, and the register still lists Weybridge Gardens 3 as under construction. At the pace of its recent inspections the site would reach 100% around August 2029. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Weybridge Gardens 3?
Weybridge Gardens 3 was 24% built at the site inspection on 5 August 2026. The site has been inspected 5 times since July 2024. The Land Department took 33 site photos at its inspections.
Is Weybridge Gardens 3 delayed?
Yes. Its registered completion date of August 2026 has passed and the project is still listed as under construction.
Who is building Weybridge Gardens 3?
The registered developer is Leos Development. It has 5 other projects under construction in Dubai.
Which bank holds the escrow account for Weybridge Gardens 3?
Emirates Islamic Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
