Verdana Residence construction progress

Verdana Residence in Dubai Investment Park First was registered to complete in December 2025 and is still under construction. At the last site inspection, in June 2026, it was 96% built. The developer is Reportage Prime Properties.

96%

Built, at the site inspection of 3 June 2026

11 months past its registered completion date

Registered completion date
December 2025
Finish at recent pace
July 2026
Construction started
December 2022
First registered
March 2023
Units
224
Escrow bank
Al Masraf
Name in Arabic
فيردانا ريزيدنس
Project number
2470
Site inspections
9

Schedule

Verdana Residence was registered to complete in December 2025, 11 months ago, and is still under construction. Over the last year of inspections it has added about 3.8 points a month. Kept at that rate, the site would reach 100% around July 2026.

0%25%50%75%100%2023202420252026
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

3 June 2026

96%+1.8 pts

  • Verdana Residence construction site, inspection photo 1, 3 June 2026
  • Verdana Residence construction site, inspection photo 2, 3 June 2026
  • Verdana Residence construction site, inspection photo 3, 3 June 2026
  • Verdana Residence construction site, inspection photo 4, 3 June 2026

6 February 2026

94%+26 pts

  • Verdana Residence construction site, inspection photo 1, 6 February 2026
  • Verdana Residence construction site, inspection photo 2, 6 February 2026
  • Verdana Residence construction site, inspection photo 3, 6 February 2026
  • Verdana Residence construction site, inspection photo 4, 6 February 2026

20 October 2025

68%+25 pts

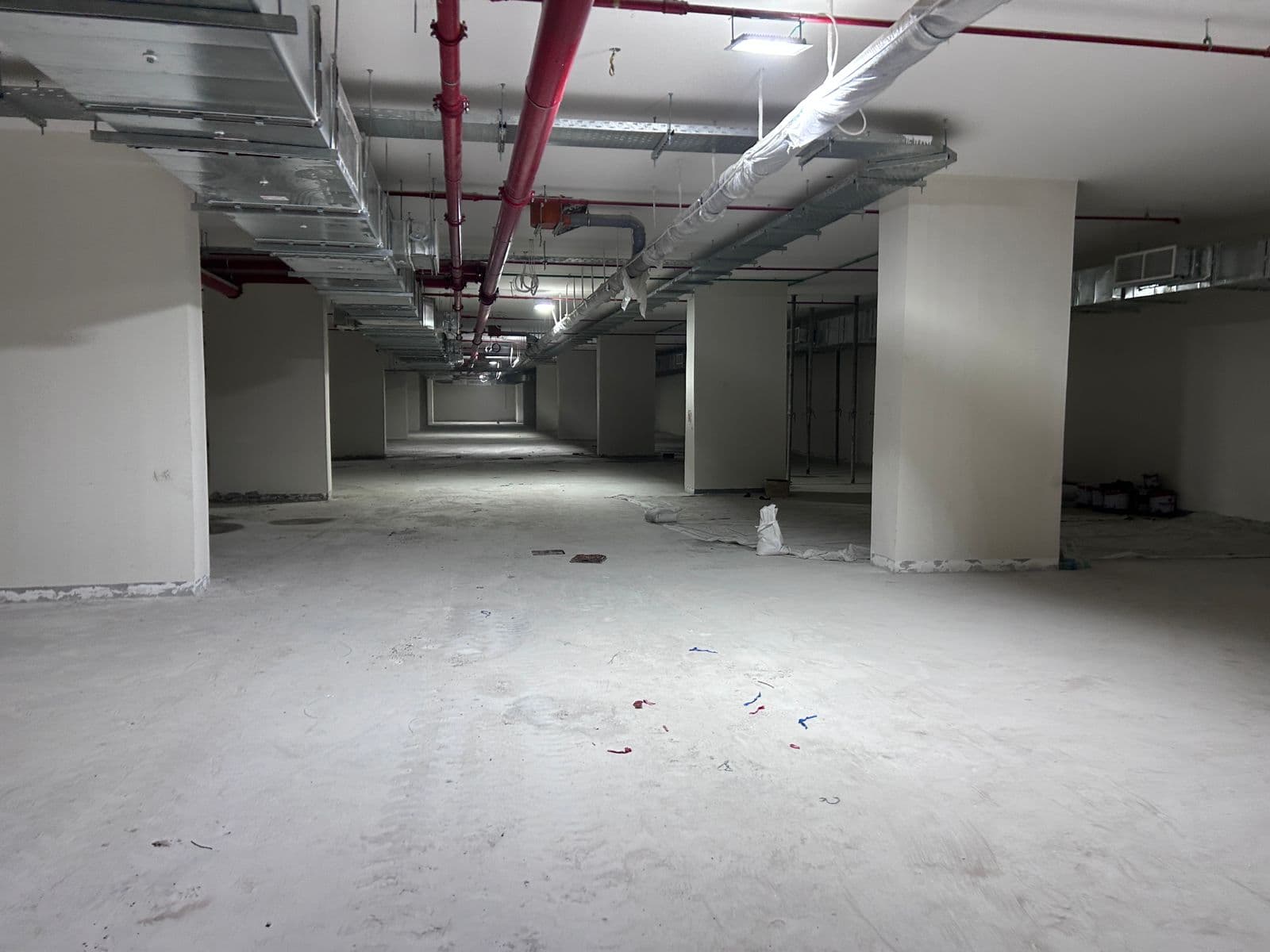

  • Verdana Residence construction site, inspection photo 1, 20 October 2025
  • Verdana Residence construction site, inspection photo 2, 20 October 2025
  • Verdana Residence construction site, inspection photo 3, 20 October 2025
  • Verdana Residence construction site, inspection photo 4, 20 October 2025

17 March 2025

43%+24 pts

  • Verdana Residence construction site, inspection photo 1, 17 March 2025
  • Verdana Residence construction site, inspection photo 2, 17 March 2025
  • Verdana Residence construction site, inspection photo 3, 17 March 2025
  • Verdana Residence construction site, inspection photo 4, 17 March 2025

18 September 2024

19%+13 pts

  • Verdana Residence construction site, inspection photo 1, 18 September 2024
  • Verdana Residence construction site, inspection photo 2, 18 September 2024
  • Verdana Residence construction site, inspection photo 3, 18 September 2024
  • Verdana Residence construction site, inspection photo 4, 18 September 2024

26 March 2024

6.5%+4.5 pts

  • Verdana Residence construction site, inspection photo 1, 26 March 2024

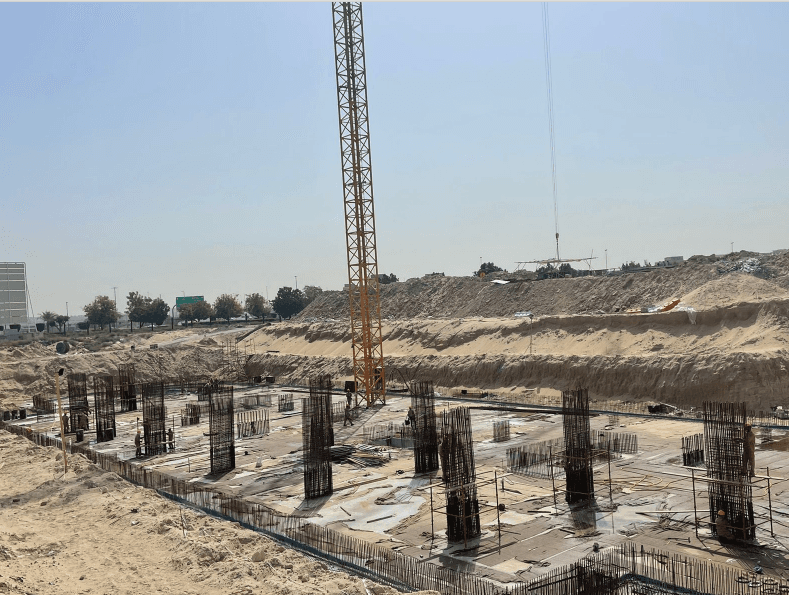

  • Verdana Residence construction site, inspection photo 2, 26 March 2024
  • Verdana Residence construction site, inspection photo 3, 26 March 2024

6 December 2023

2.0%+1.9 pts

  • Verdana Residence construction site, inspection photo 1, 6 December 2023
  • Verdana Residence construction site, inspection photo 2, 6 December 2023
  • Verdana Residence construction site, inspection photo 3, 6 December 2023

26 July 2023

0.1%+0.1 pts

  • Verdana Residence construction site, inspection photo 1, 26 July 2023
  • Verdana Residence construction site, inspection photo 2, 26 July 2023
  • Verdana Residence construction site, inspection photo 3, 26 July 2023

27 October 2022

0%

  • Verdana Residence construction site, inspection photo 1, 27 October 2022
  • Verdana Residence construction site, inspection photo 2, 27 October 2022
  • Verdana Residence construction site, inspection photo 3, 27 October 2022

All 54 site photos, by inspection date

Context

Dubai Investment Park First has 9 projects under construction, 44% built on average.

Reportage Prime Properties has 9 projects under construction in Dubai; 4 have passed their registered completion date.

Own a unit in Verdana Residence?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Verdana Residence handover date?
The registered completion date was December 2025, and the register still lists Verdana Residence as under construction. At the pace of its recent inspections the site would reach 100% around July 2026. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Verdana Residence?
Verdana Residence was 96% built at the site inspection on 3 June 2026. The site has been inspected 9 times since October 2022. The Land Department took 54 site photos at its inspections.
Is Verdana Residence delayed?
Yes. Its registered completion date of December 2025 has passed and the project is still listed as under construction.
Who is building Verdana Residence?
The registered developer is Reportage Prime Properties. It has 8 other projects under construction in Dubai.
Which bank holds the escrow account for Verdana Residence?
Al Masraf. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
