Verdana Residence construction photos

54 photos taken by Dubai Land Department engineers at 9 site inspections, newest first. The percentage is how much of Verdana Residence was built on the day of each visit.

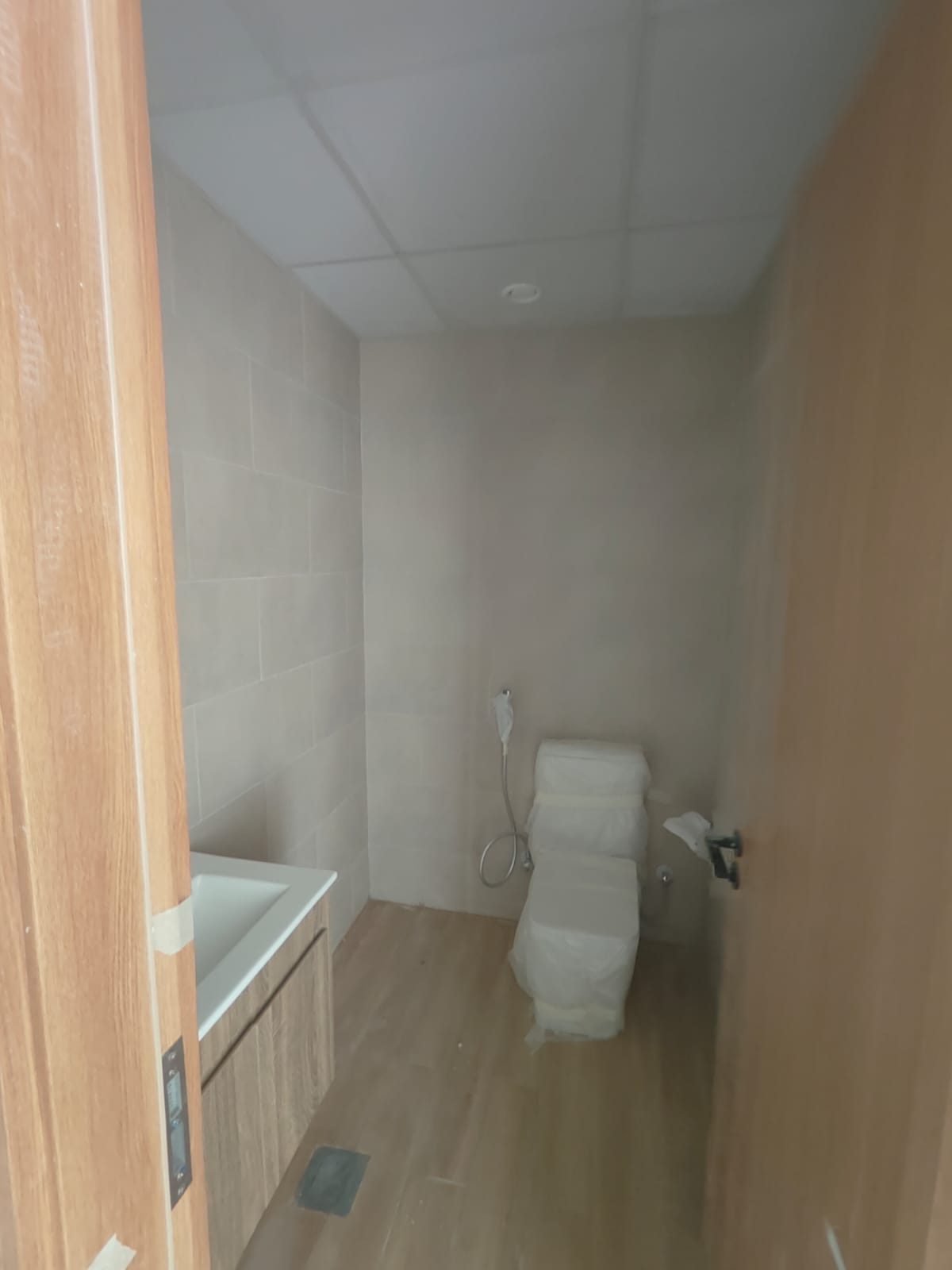

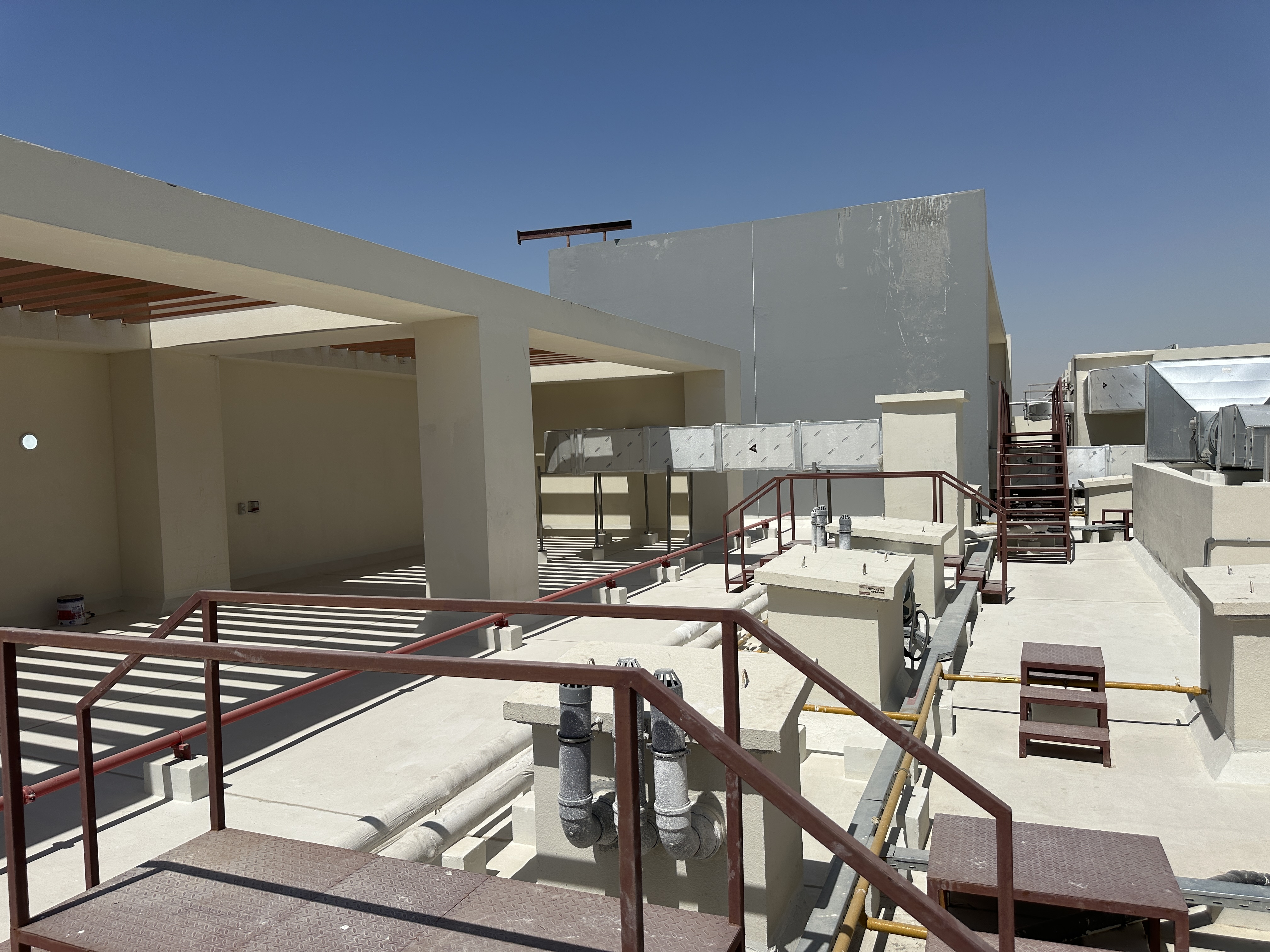

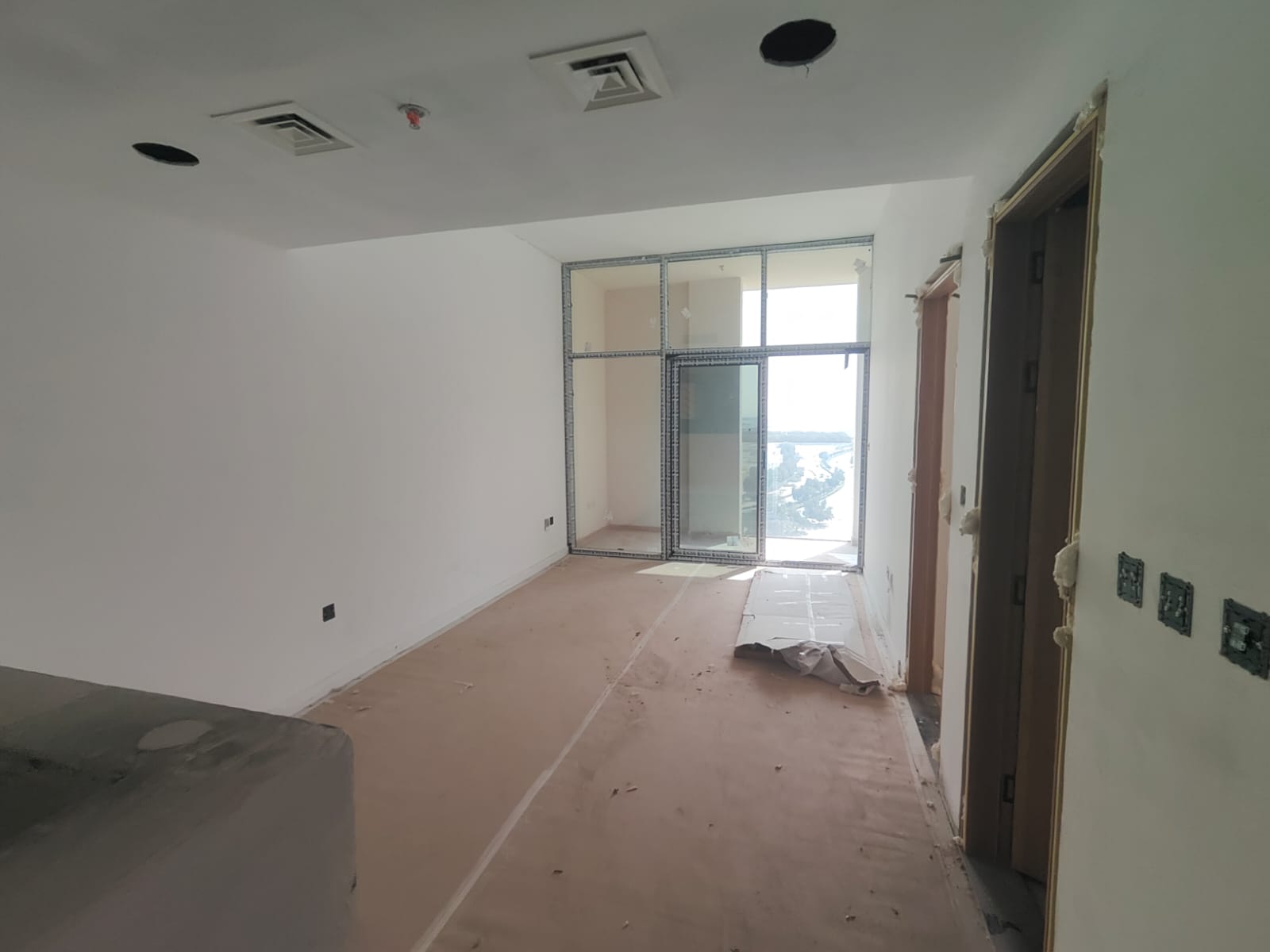

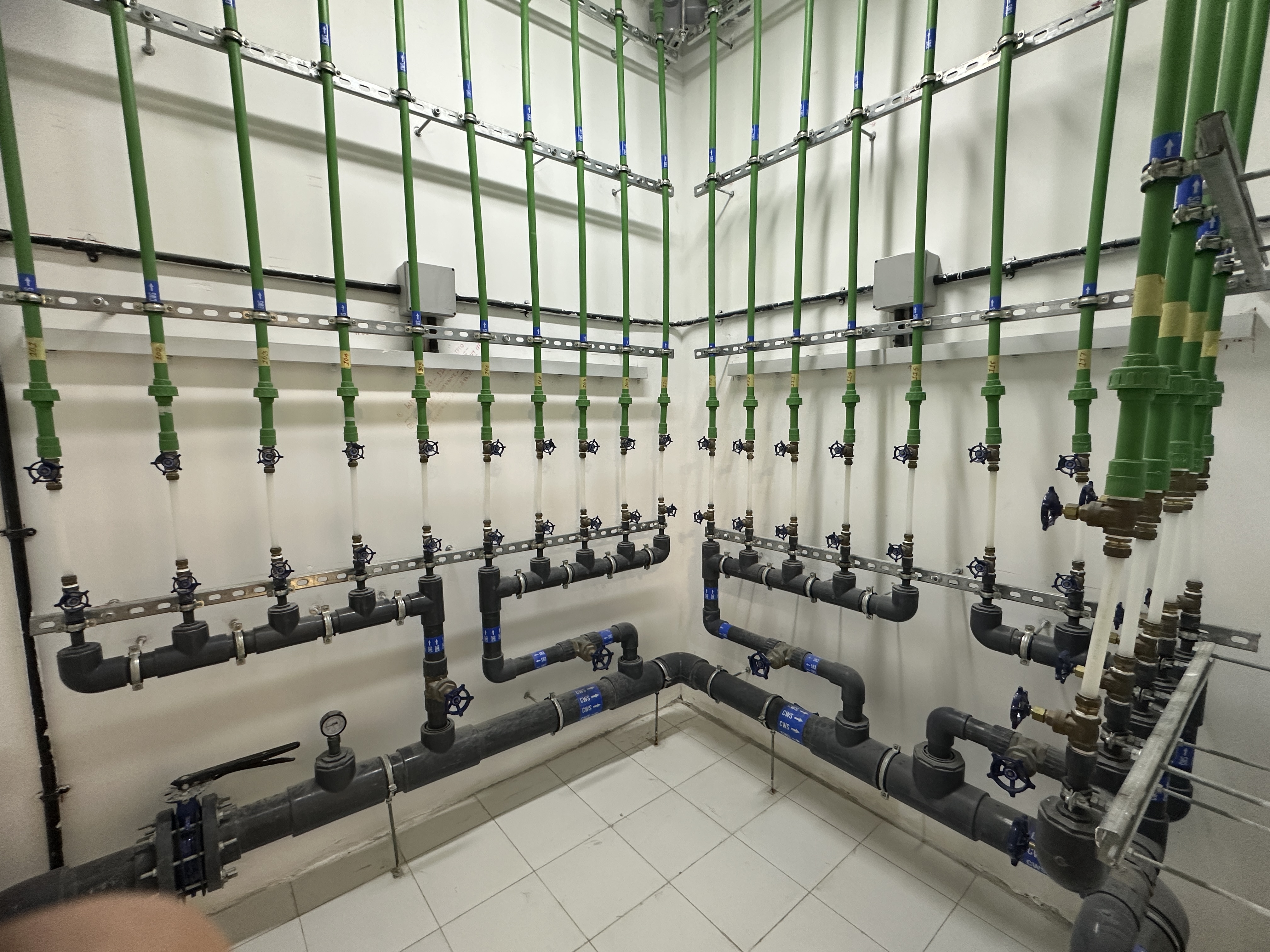

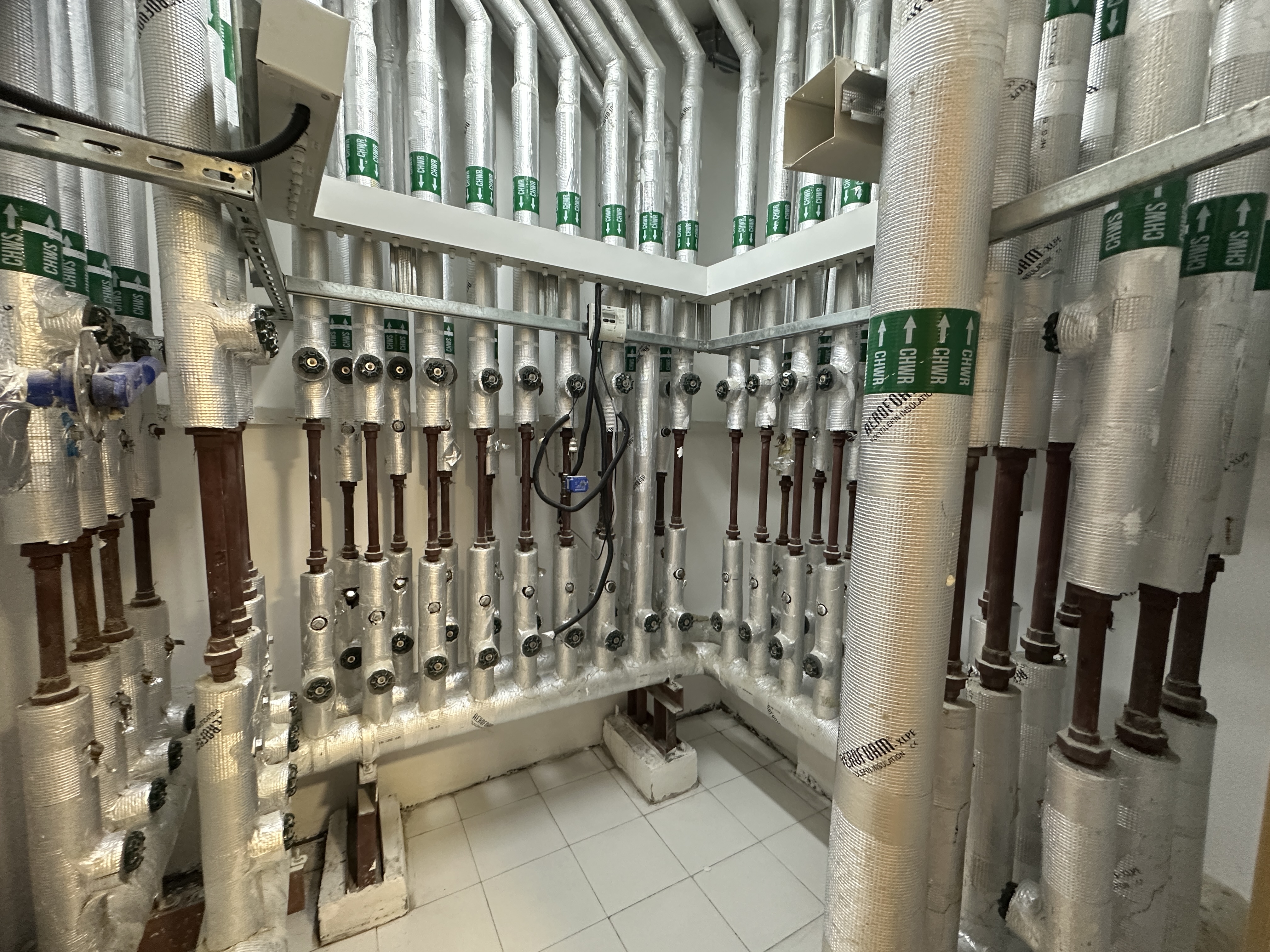

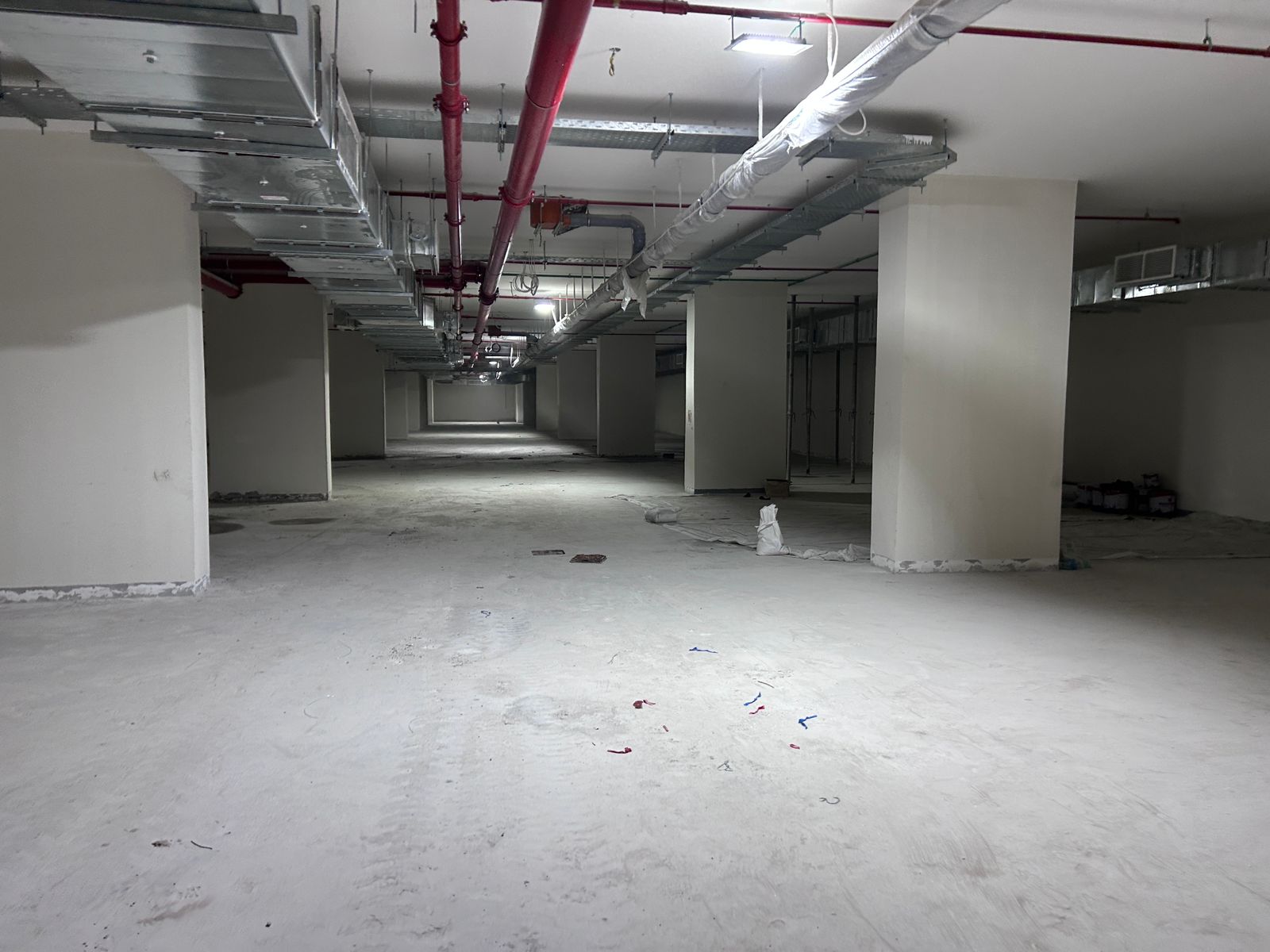

3 June 202696% built

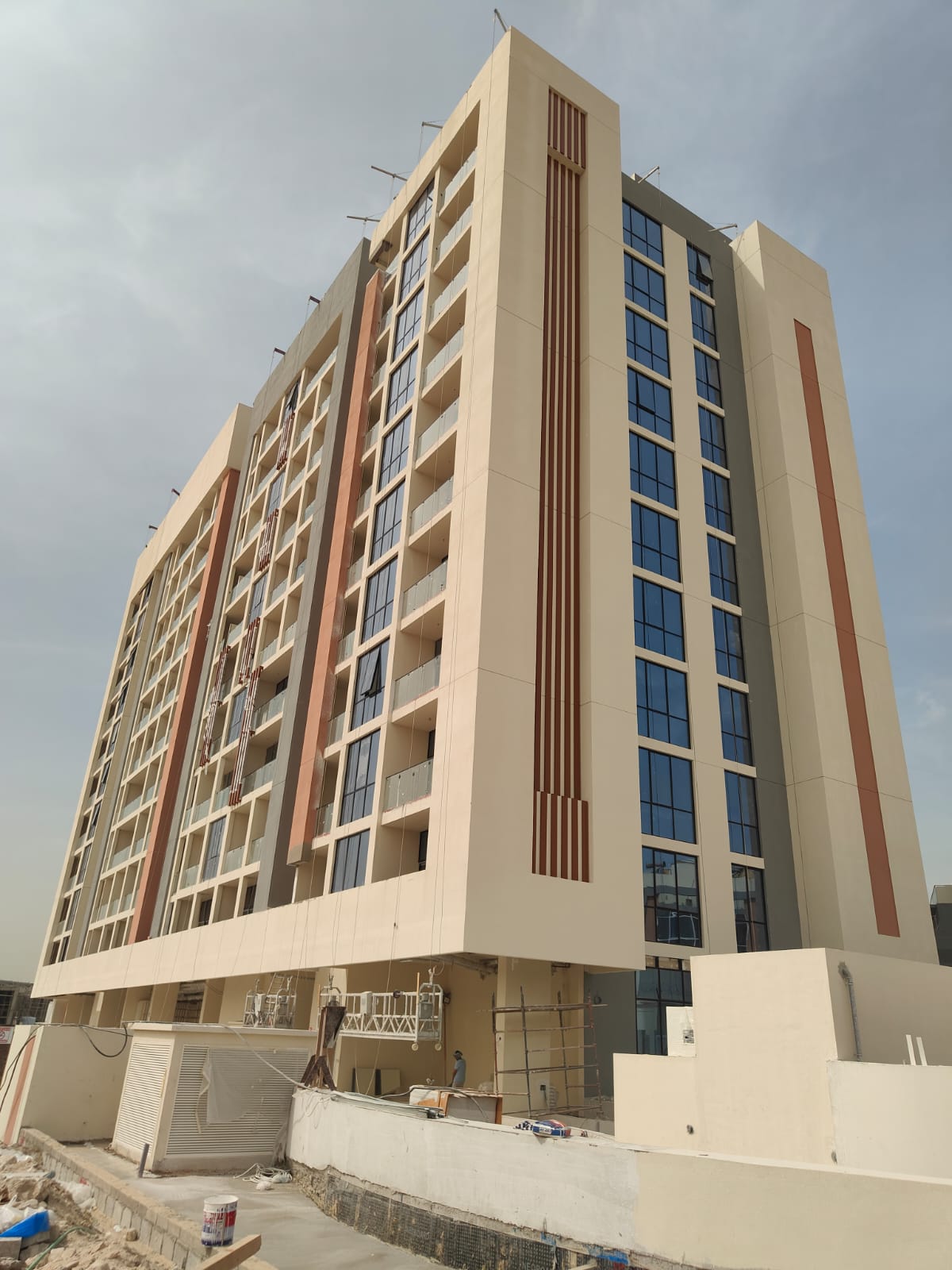

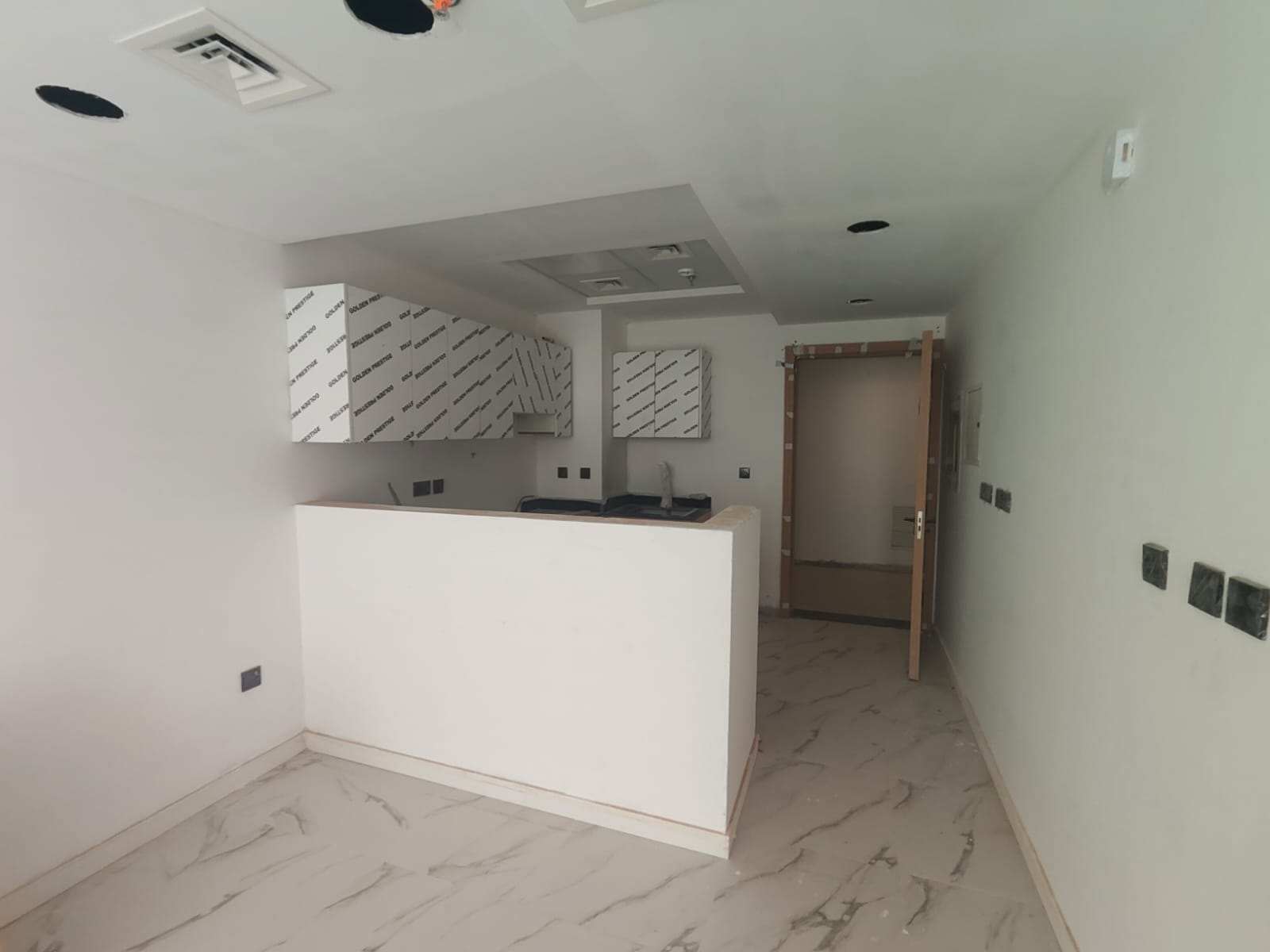

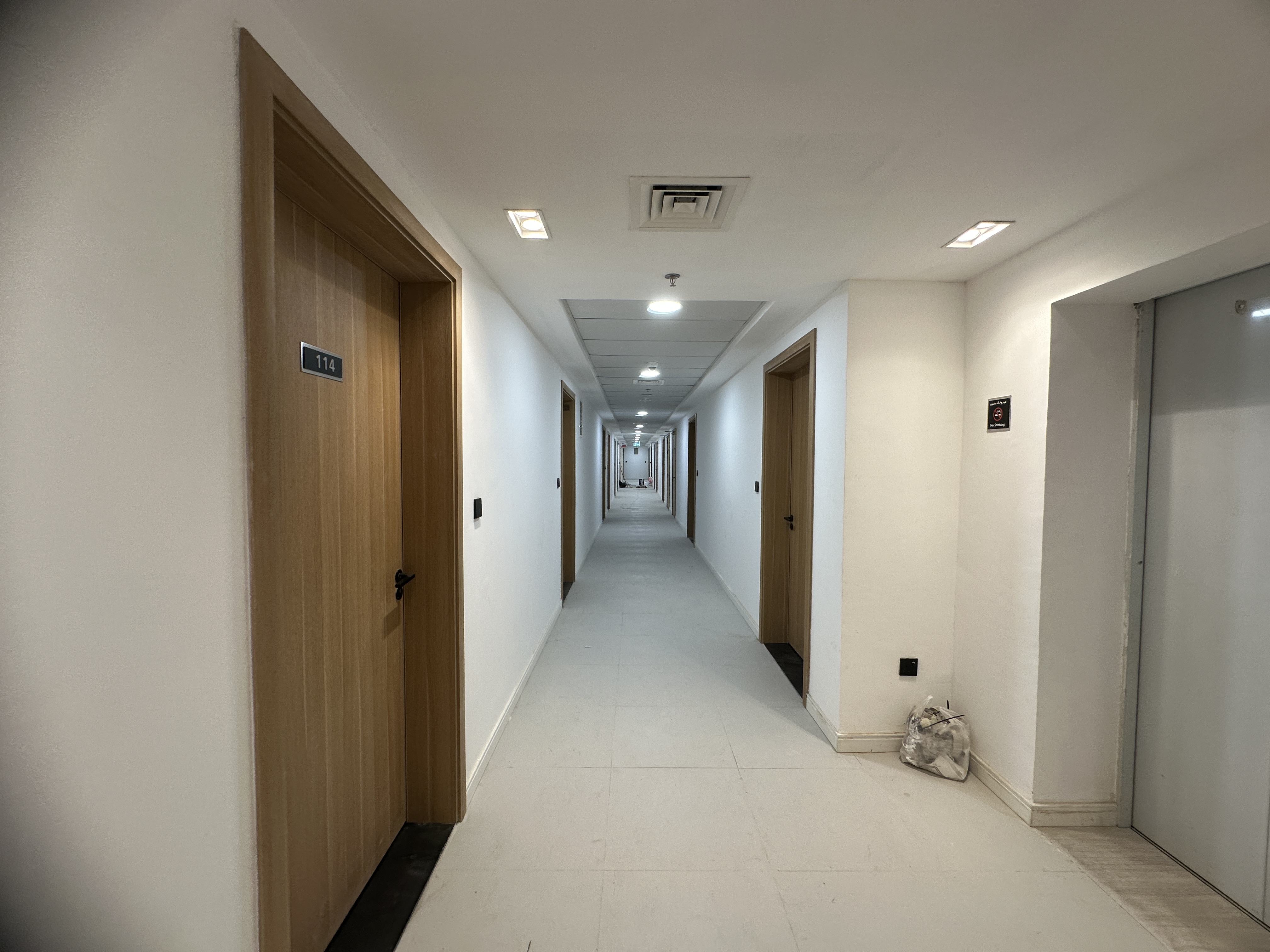

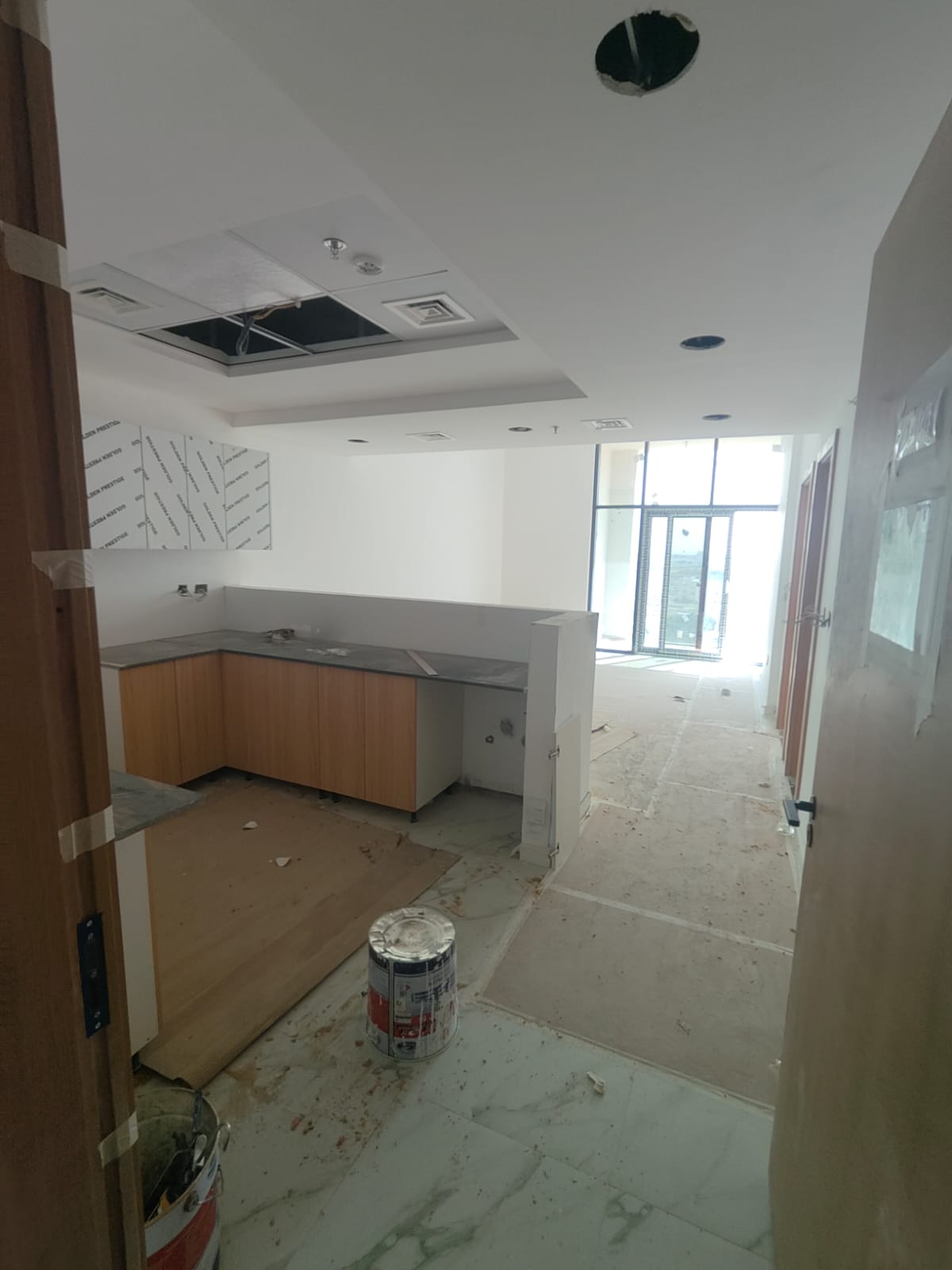

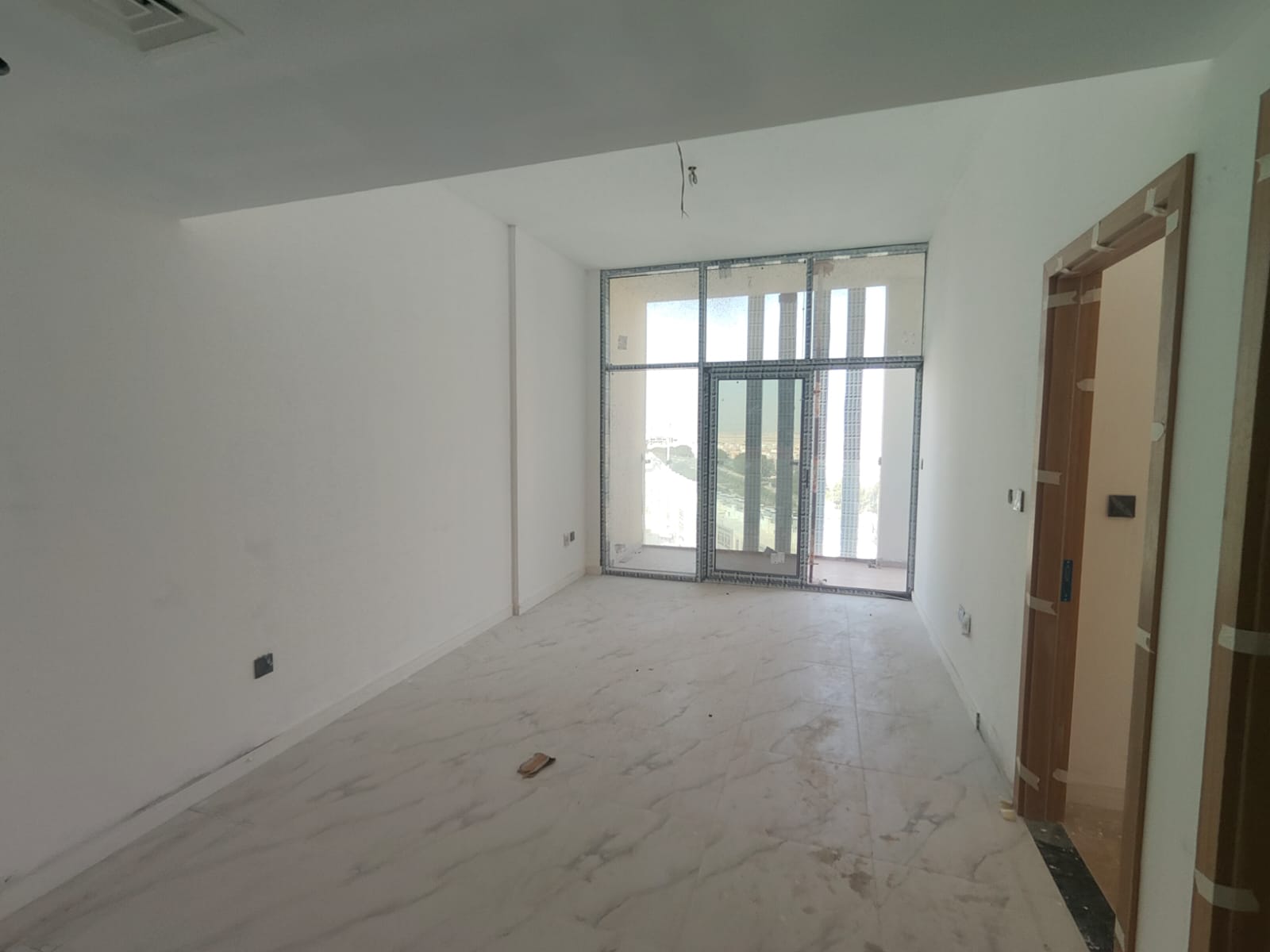

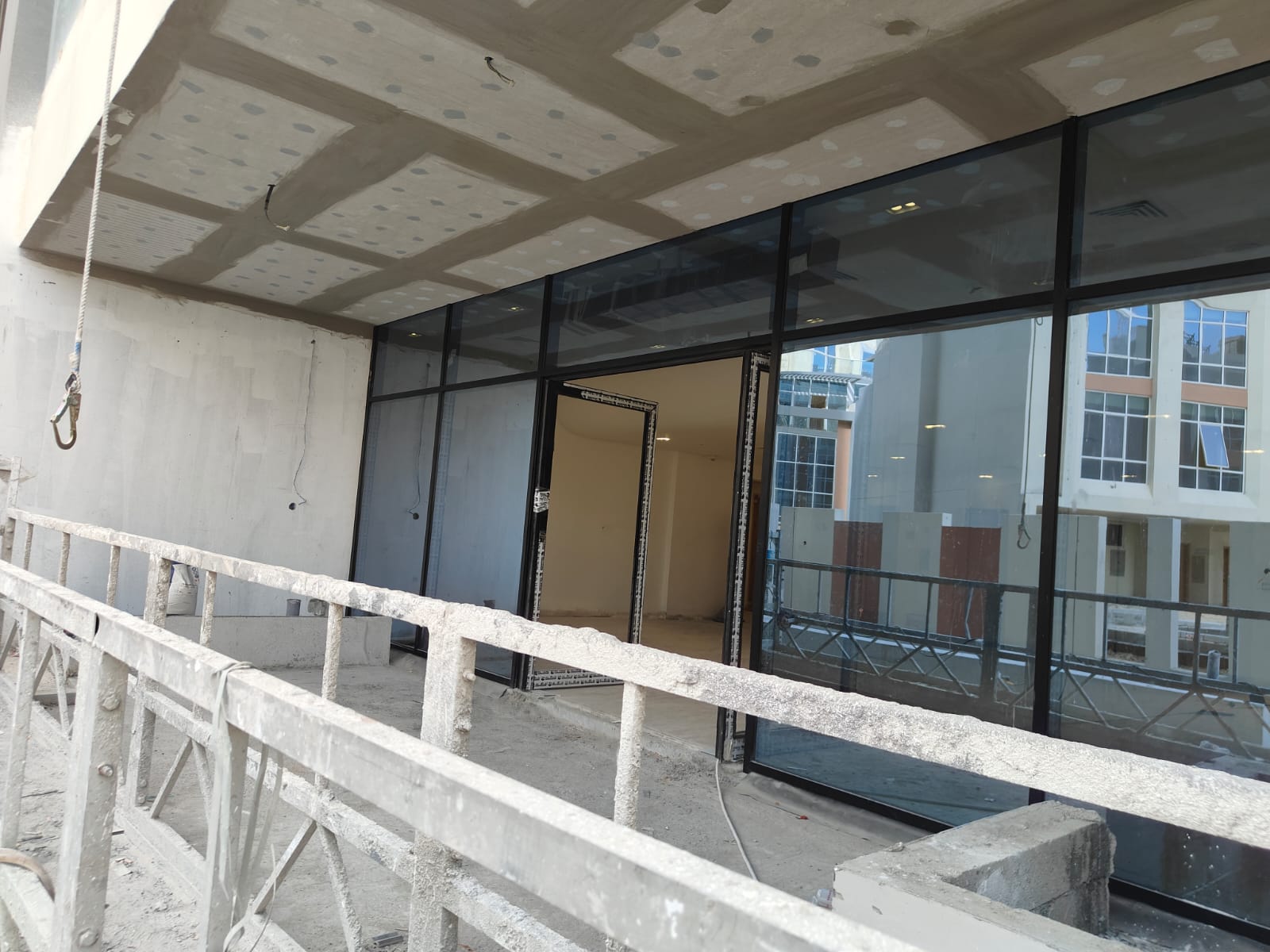

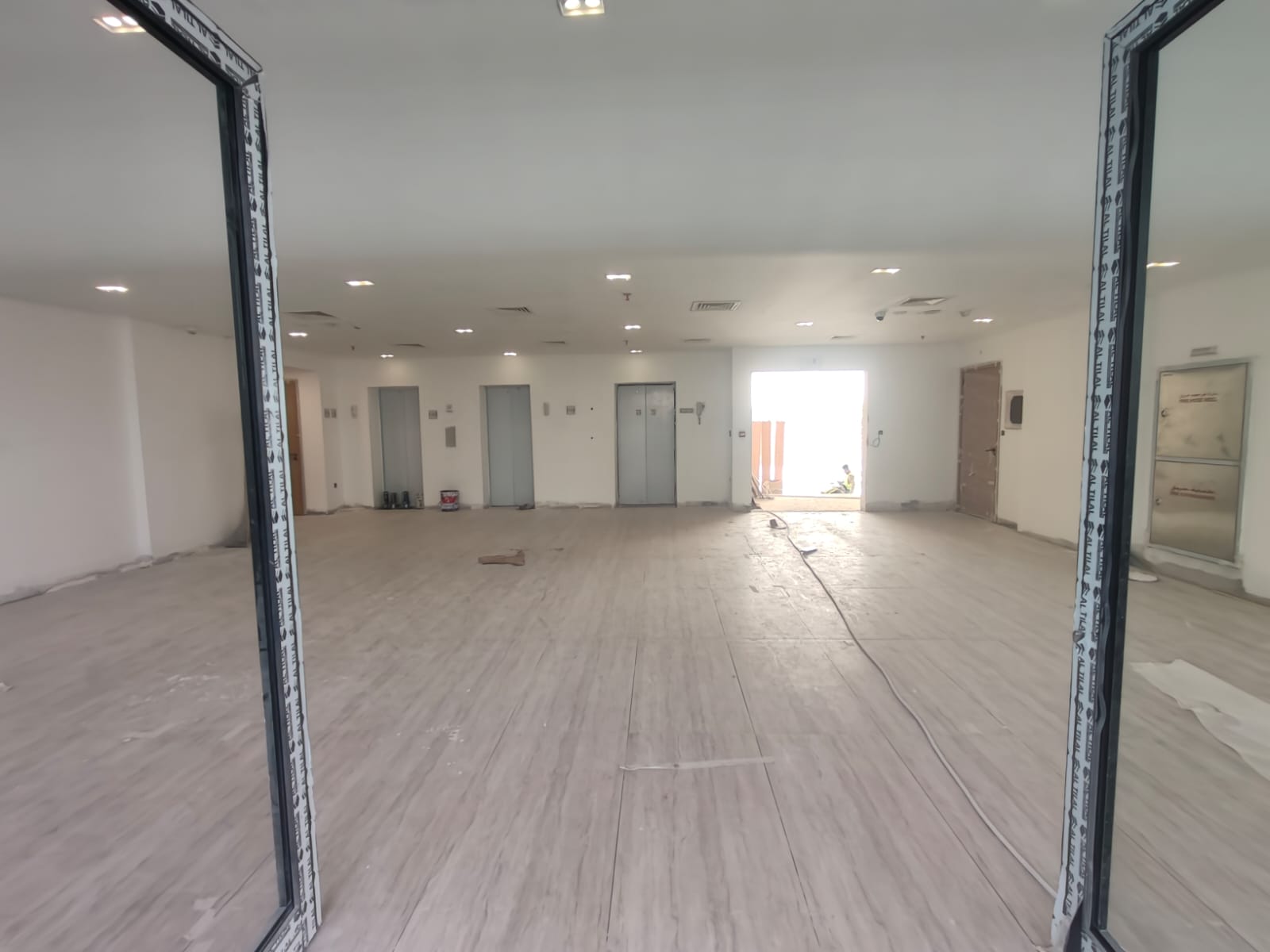

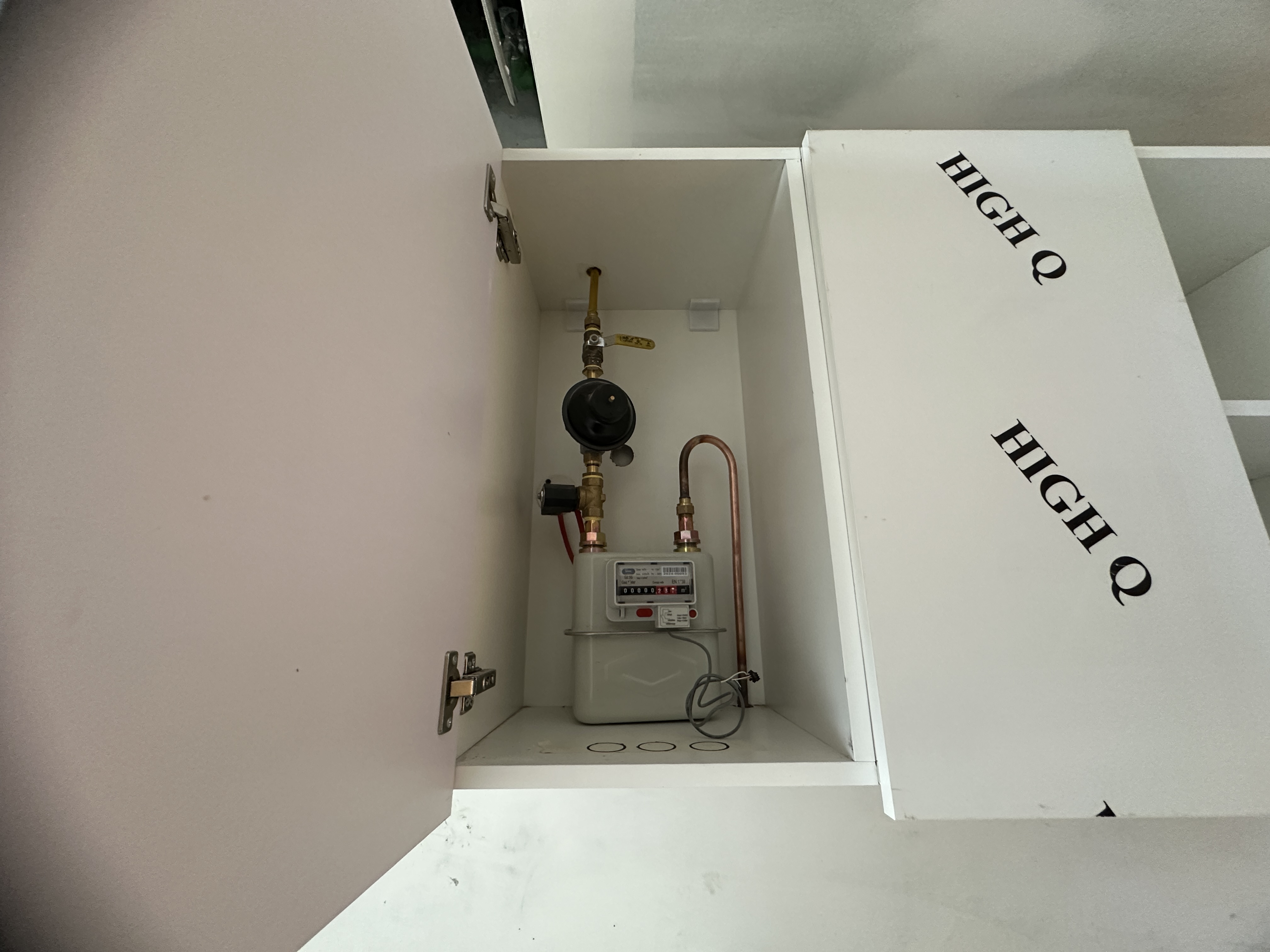

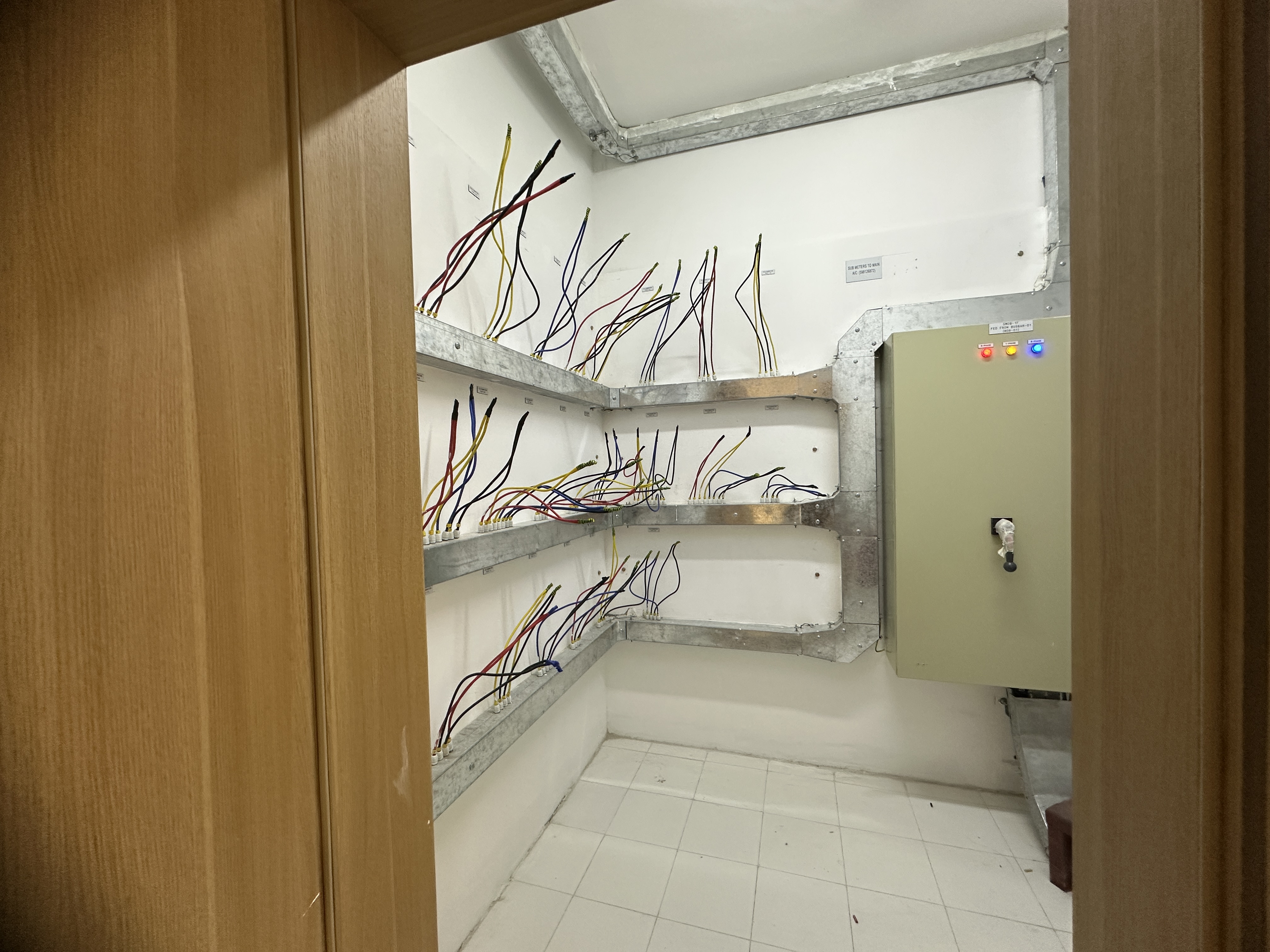

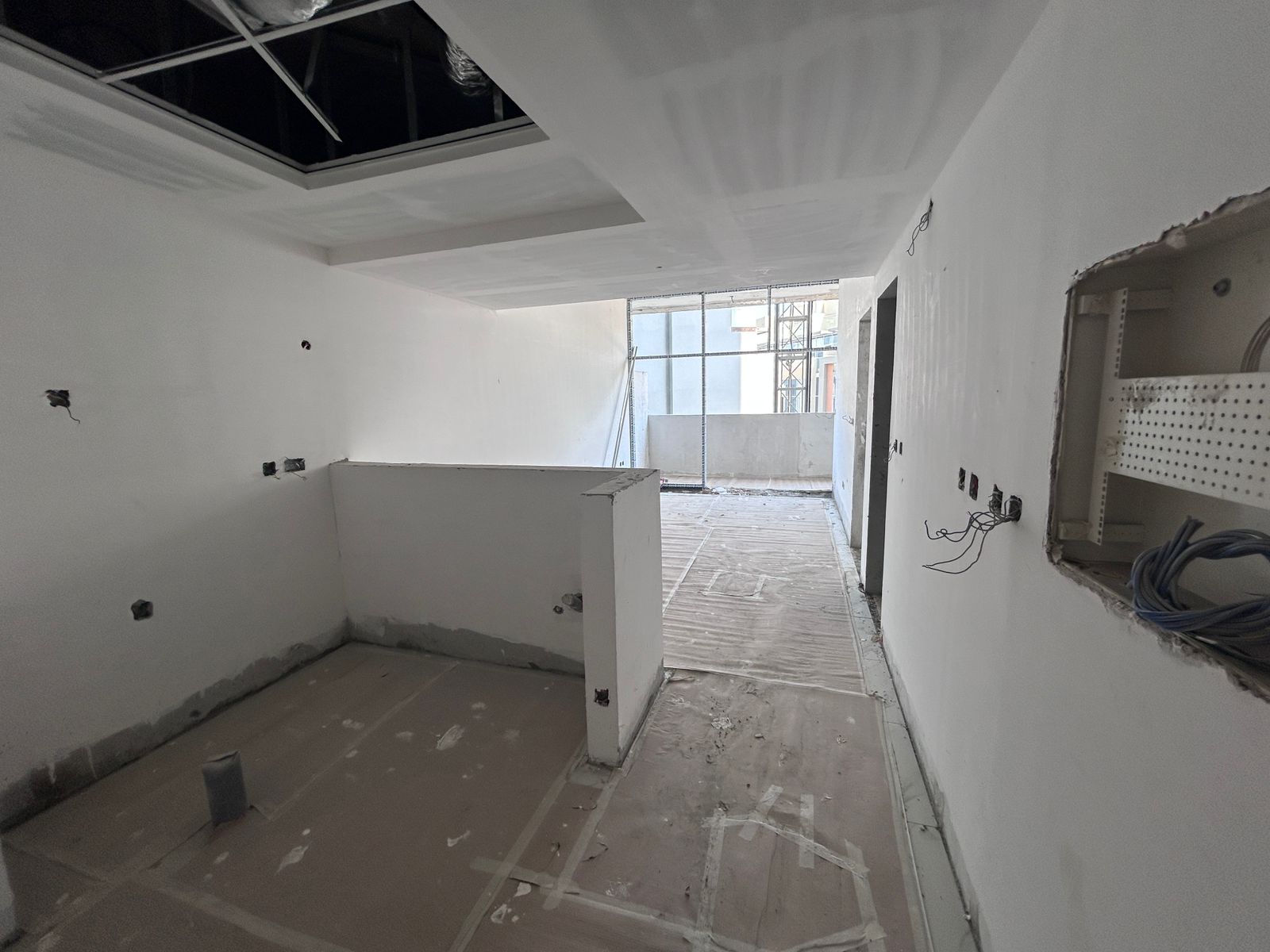

6 February 202694% built

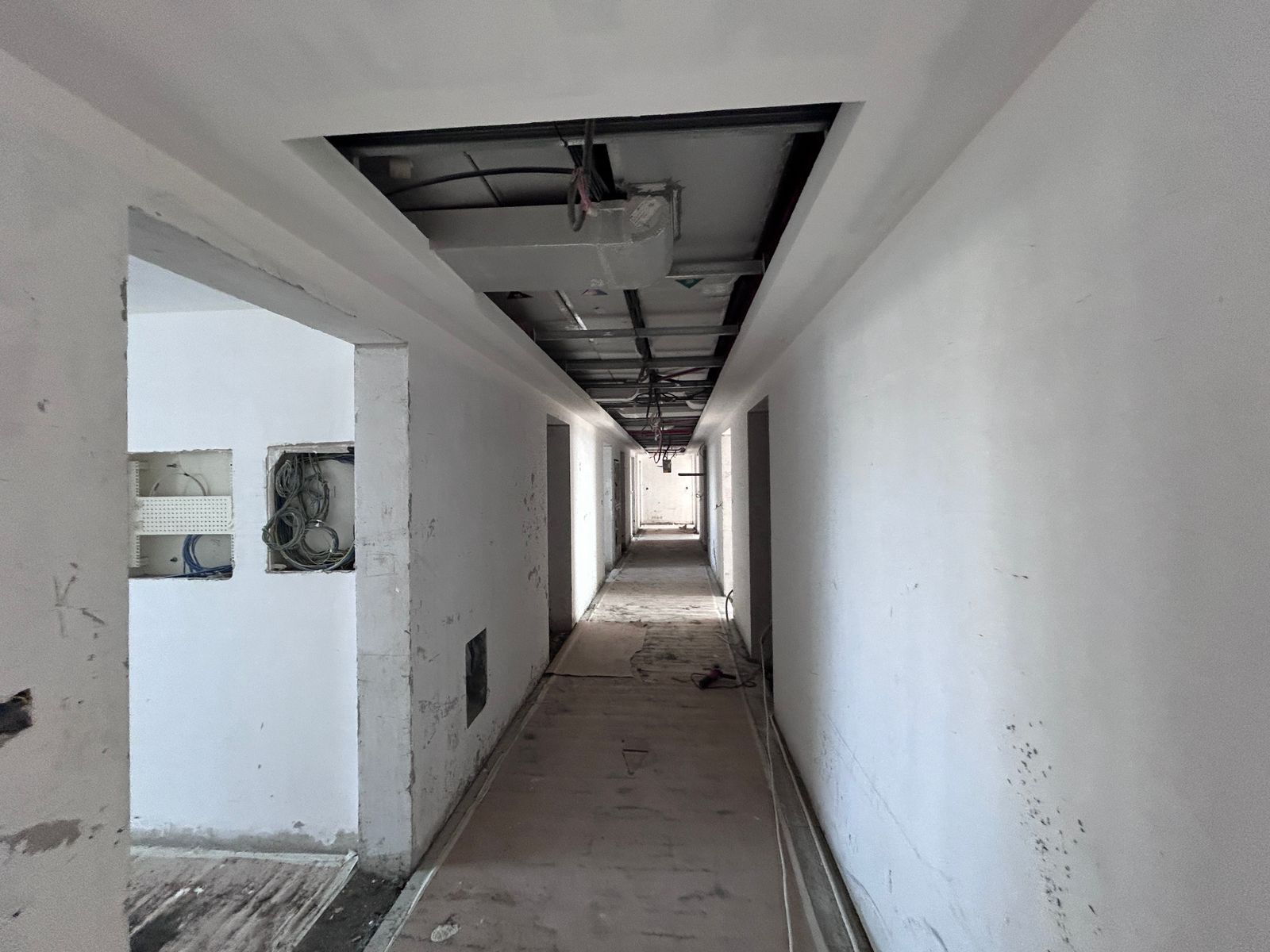

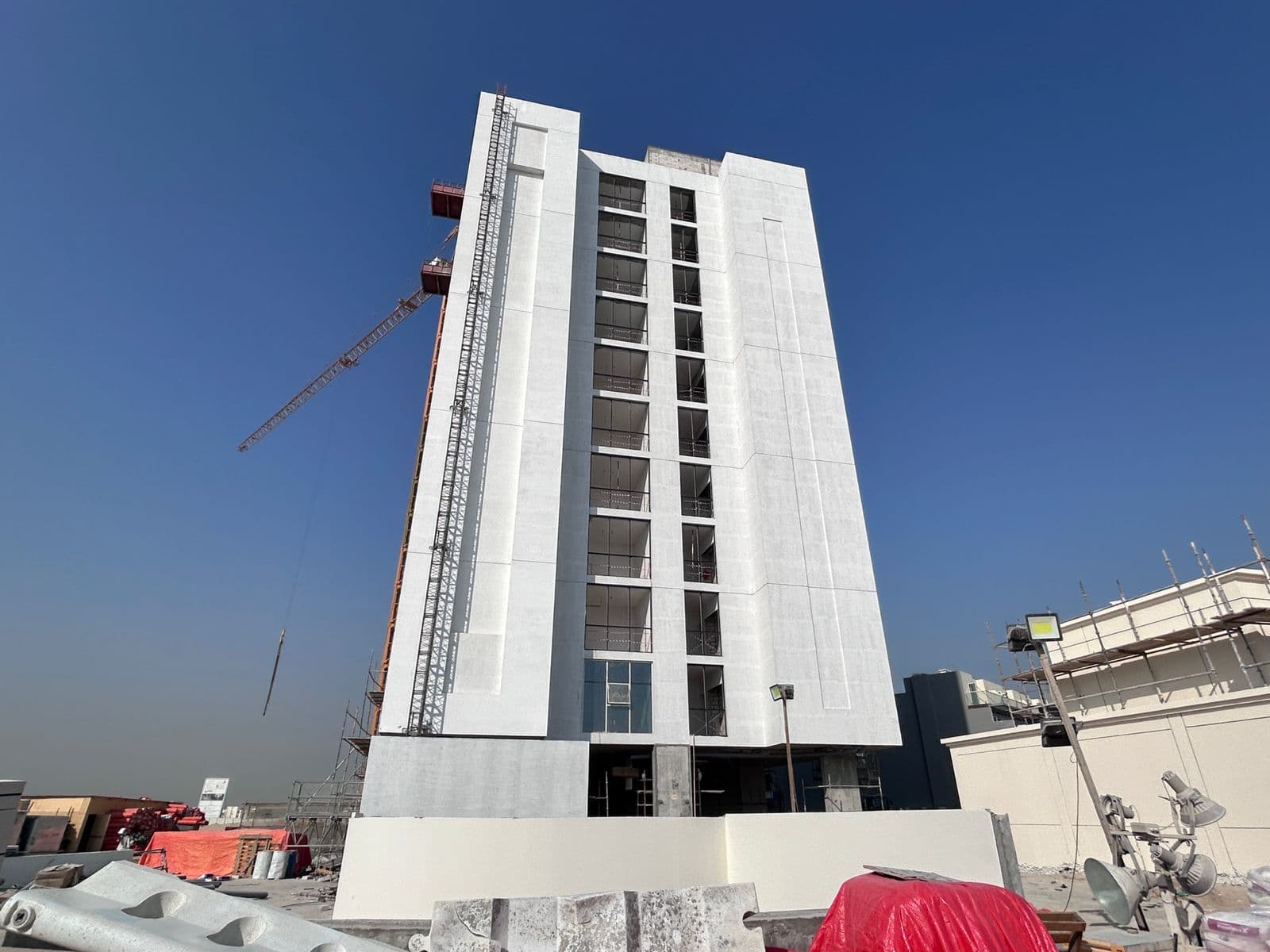

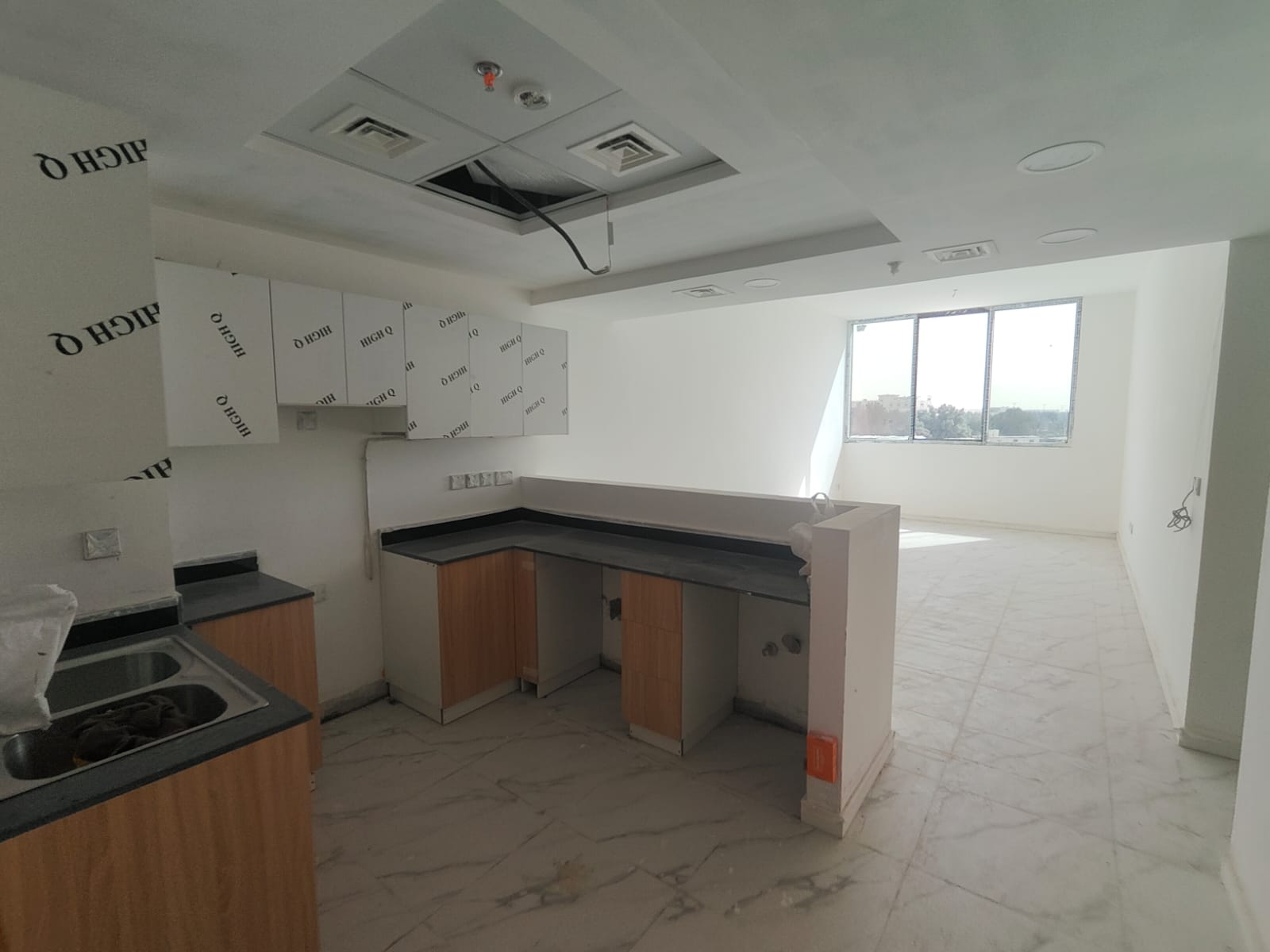

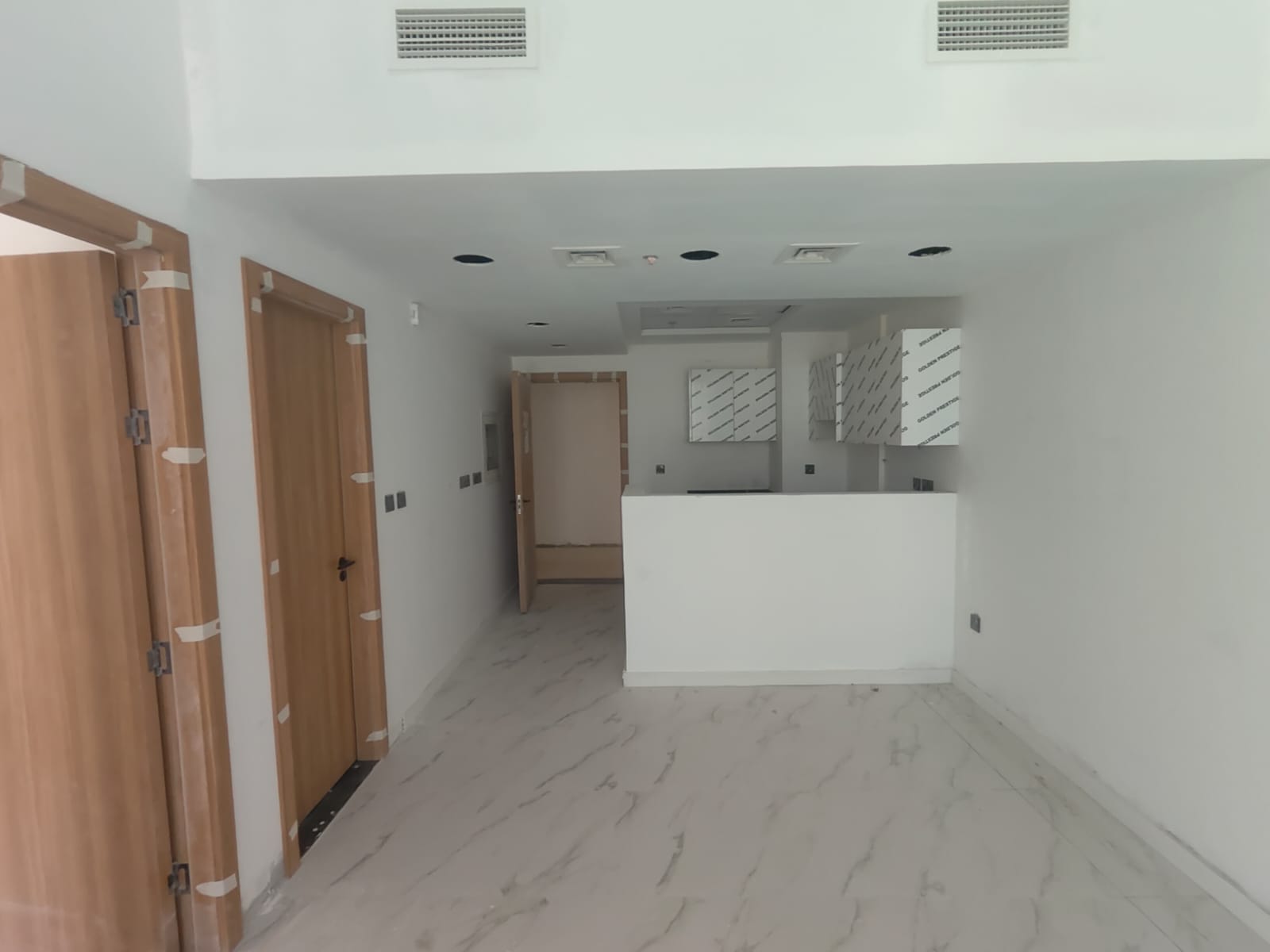

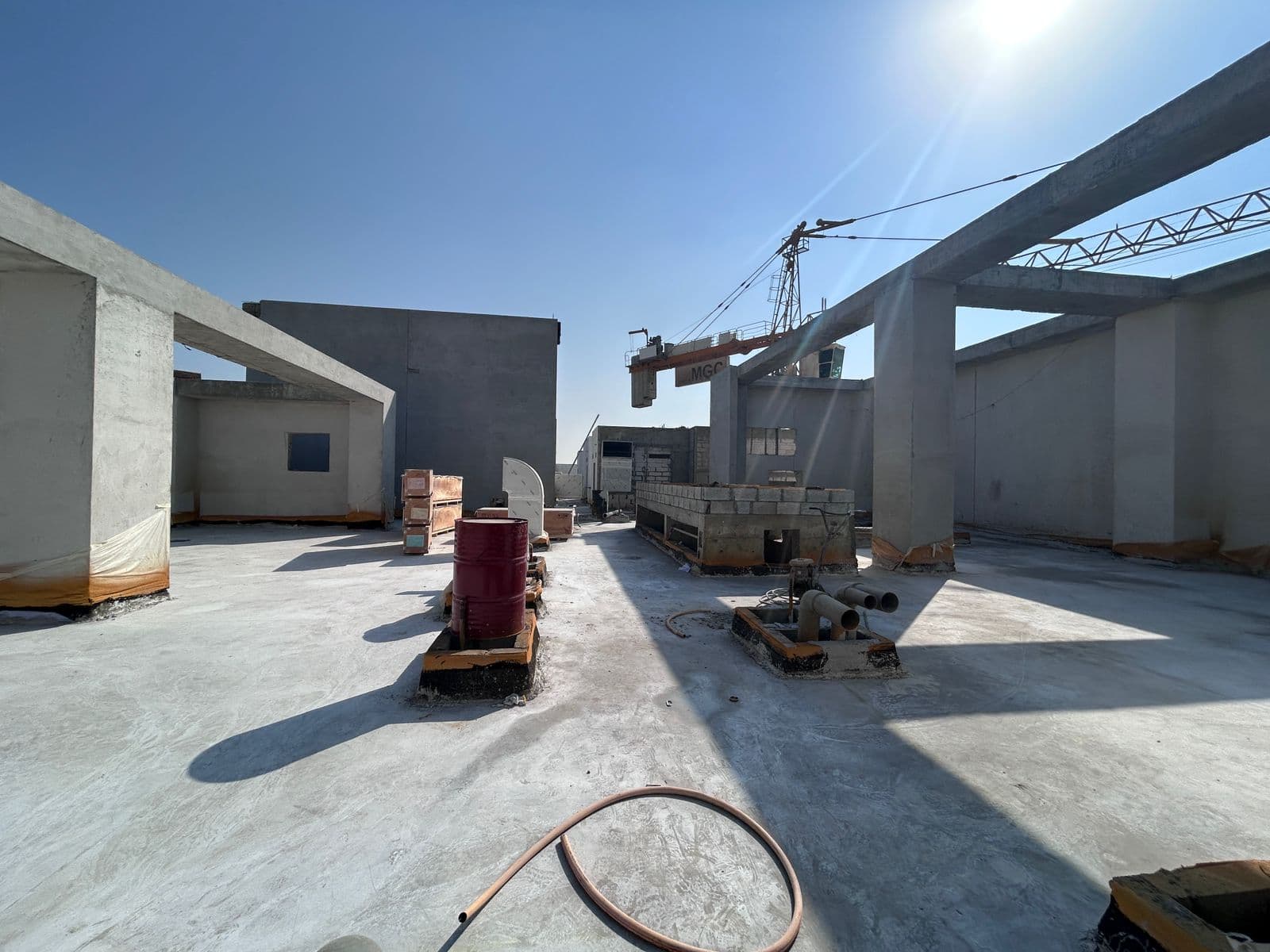

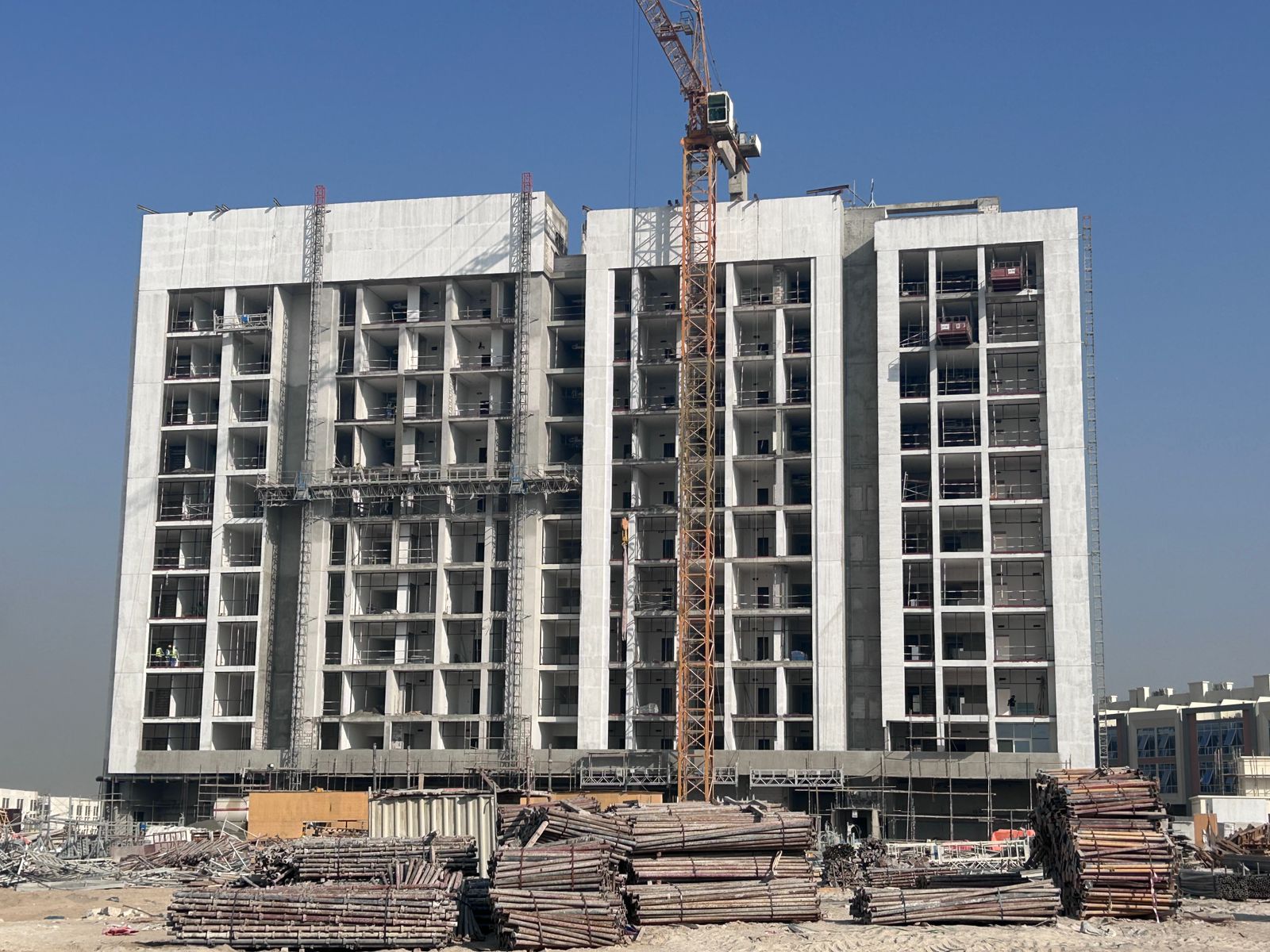

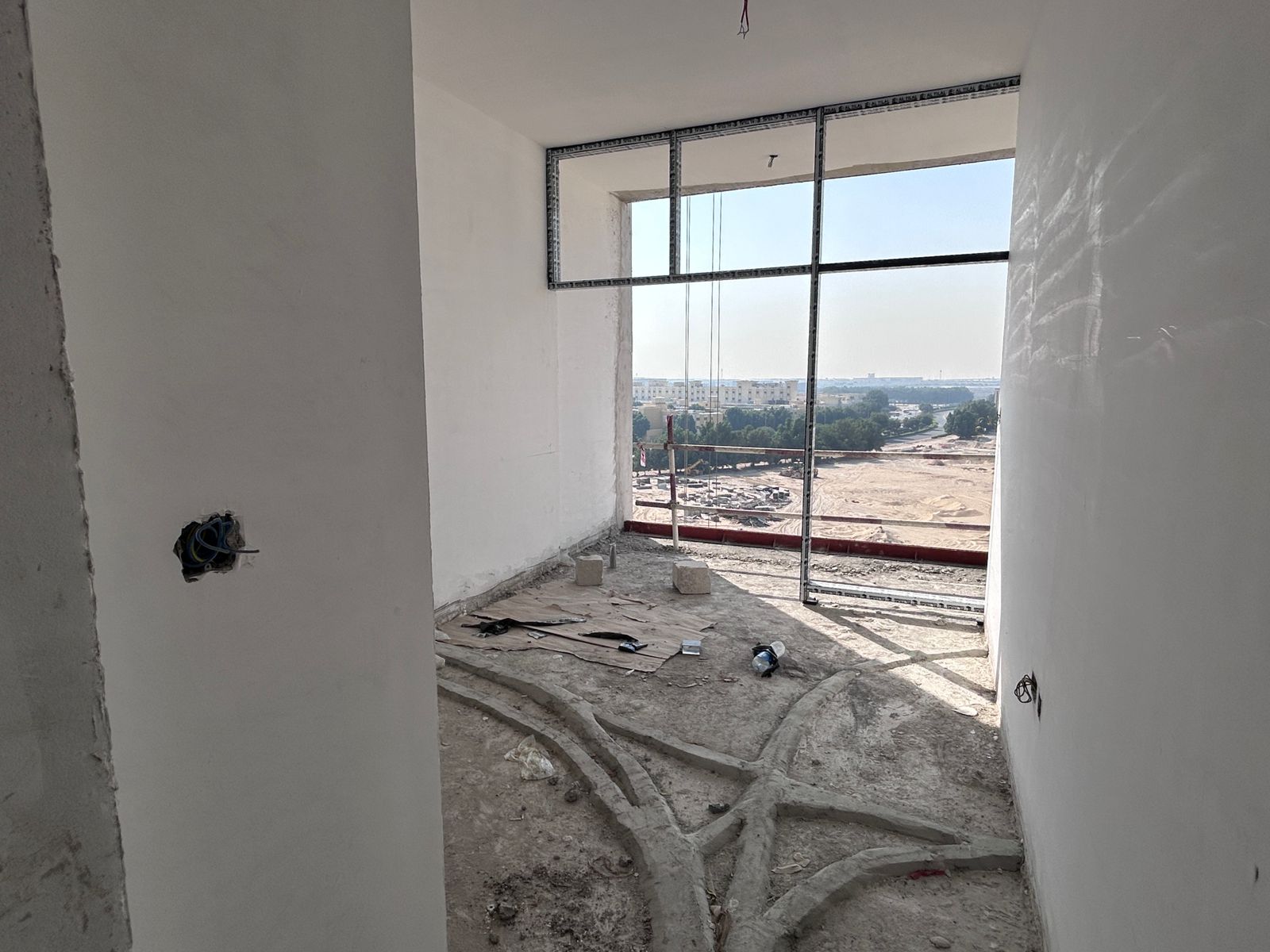

20 October 202568% built

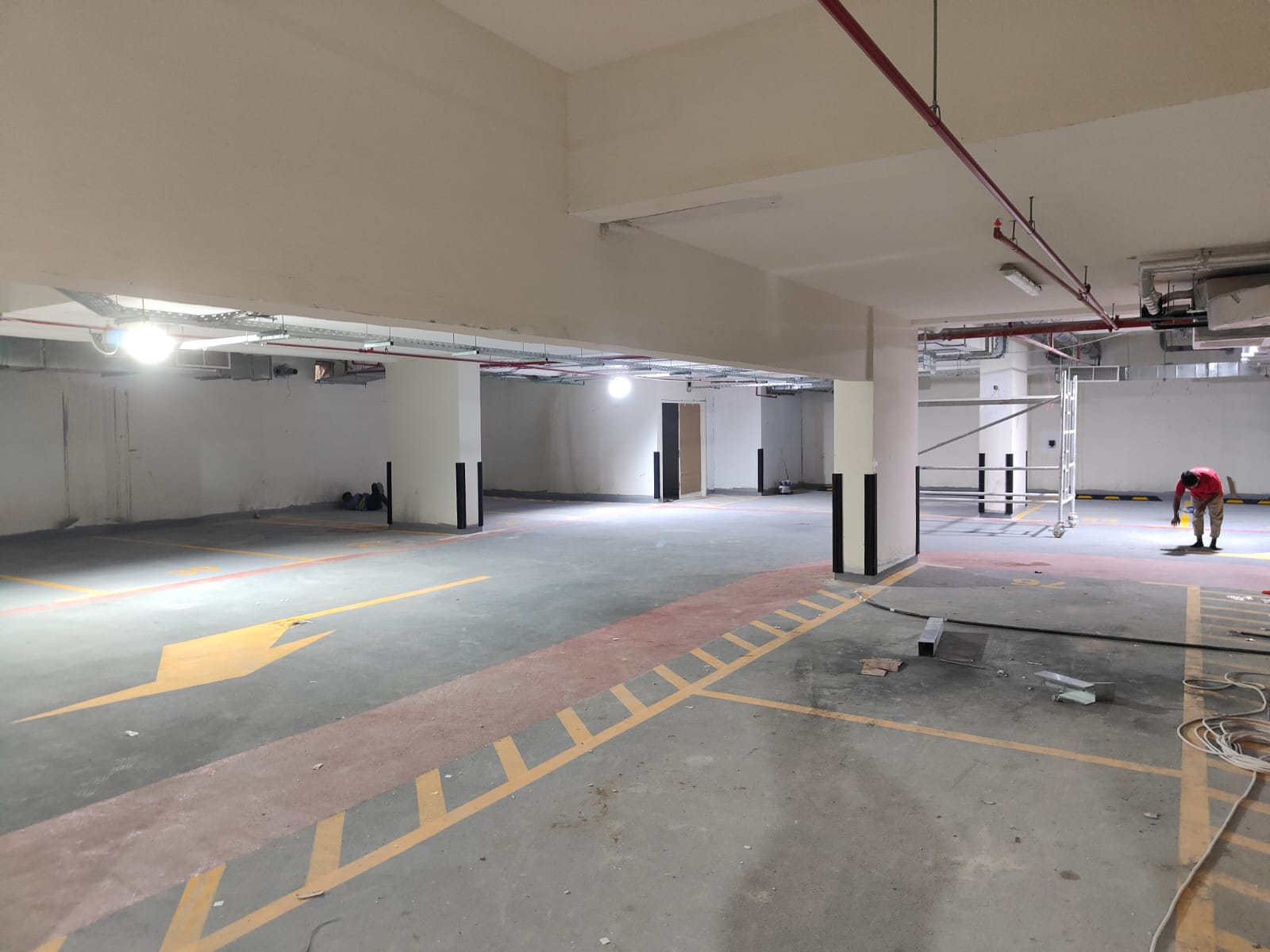

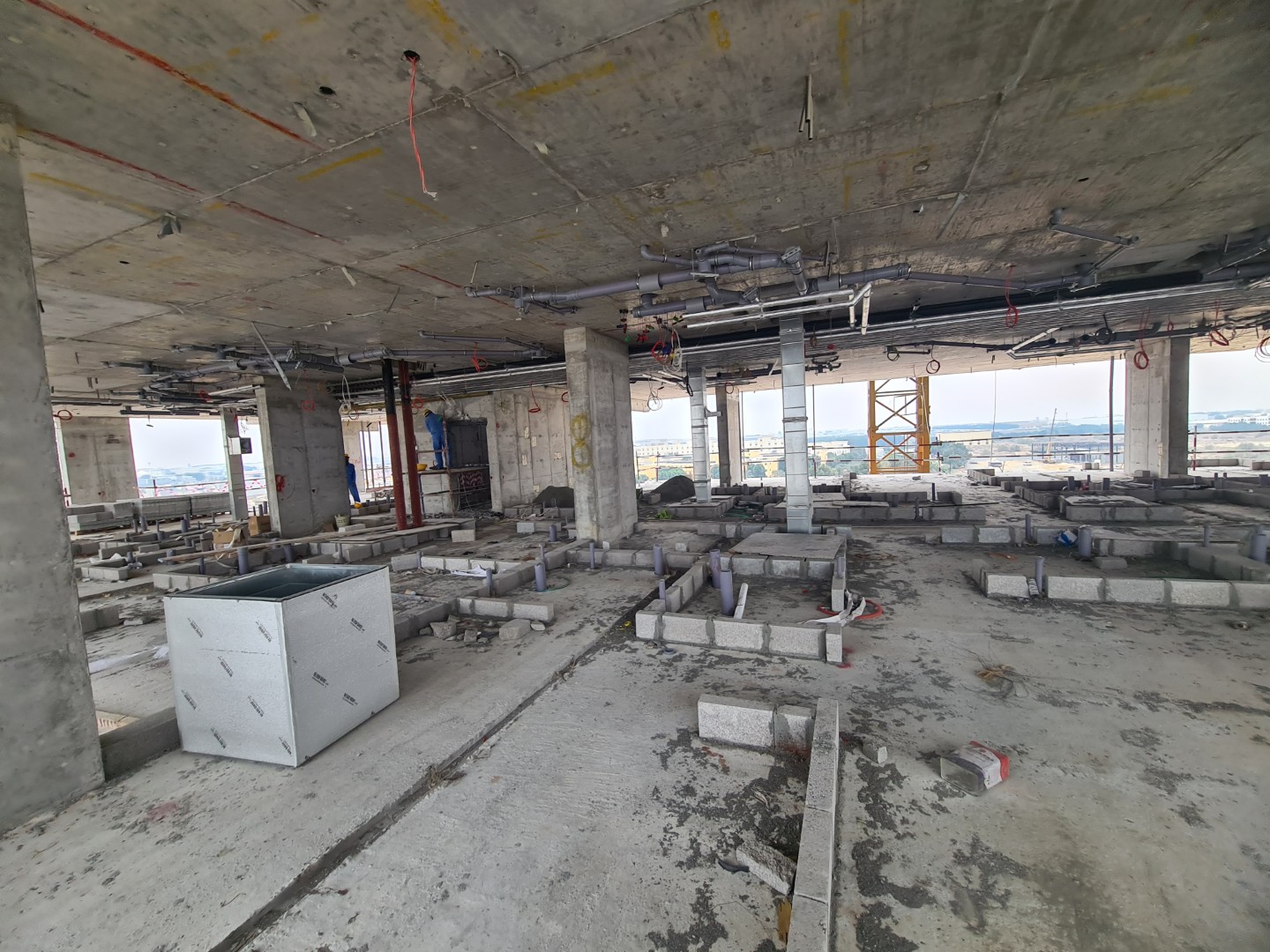

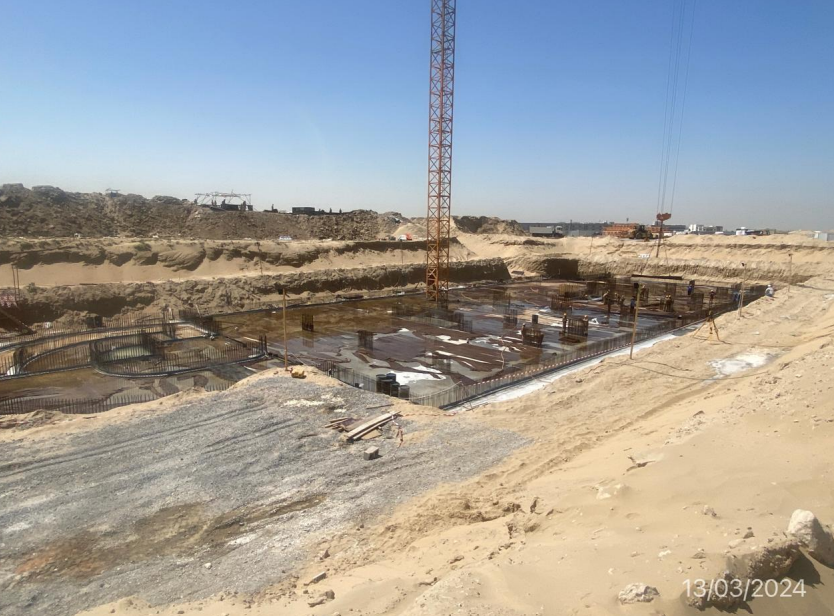

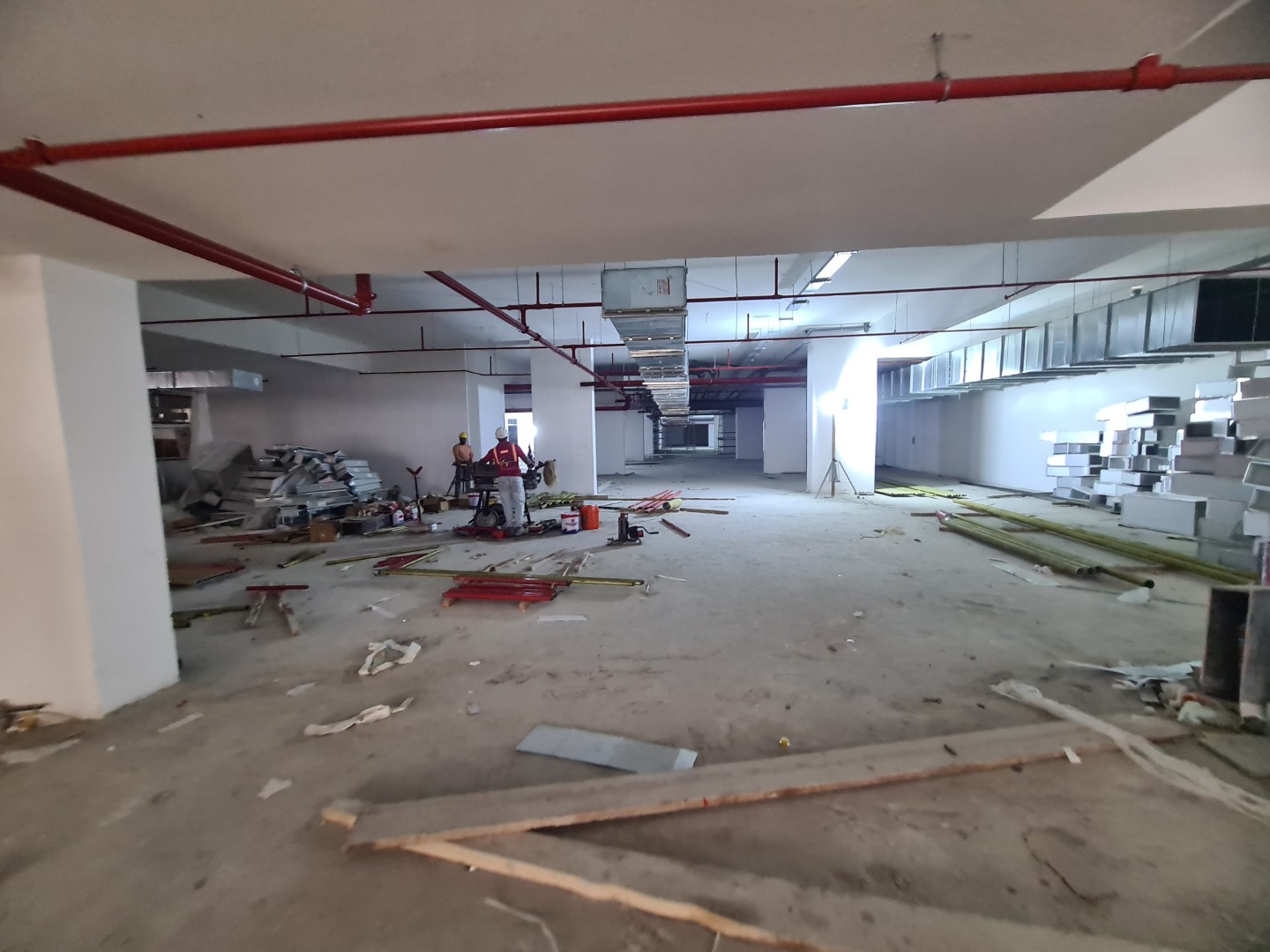

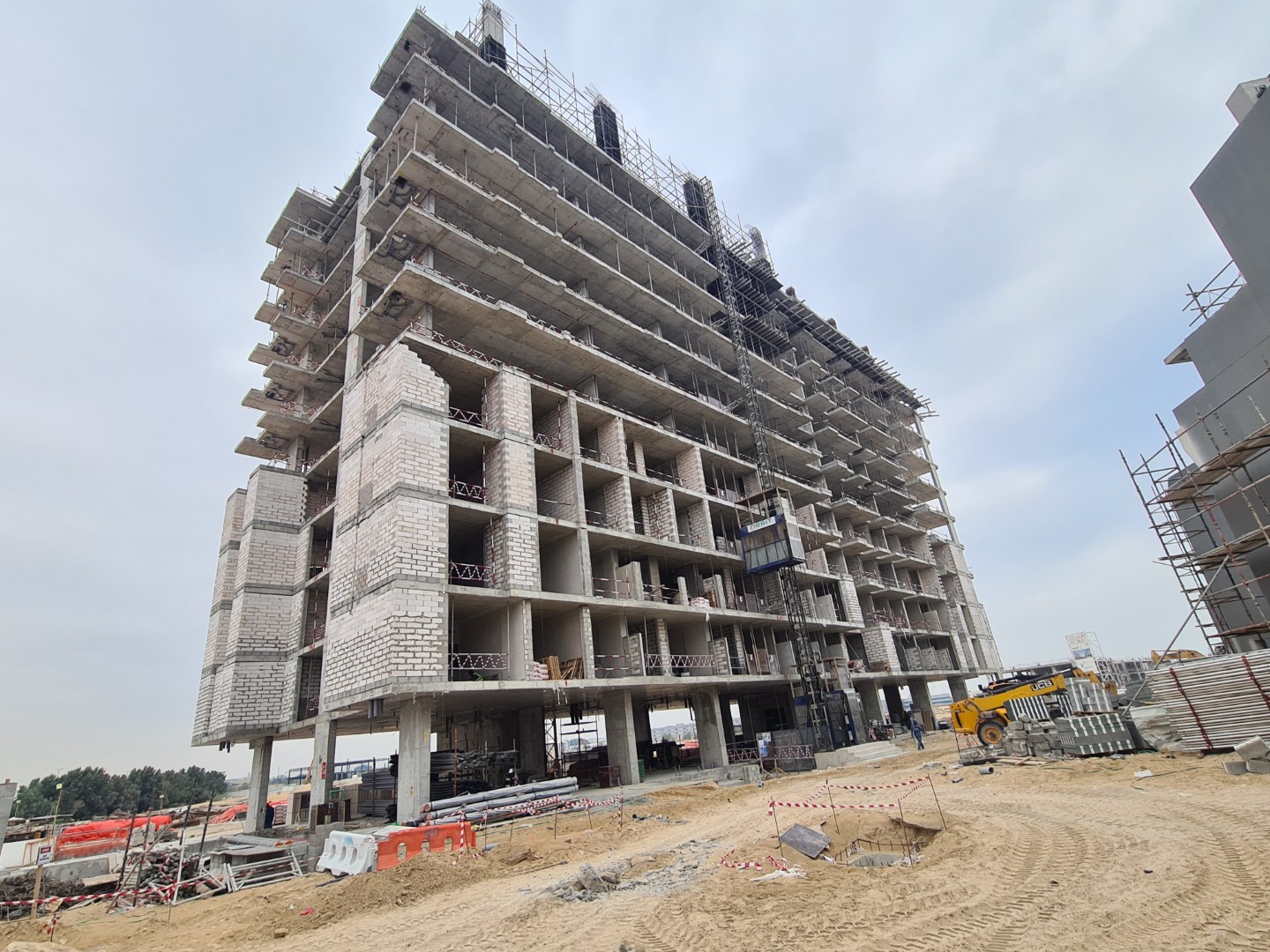

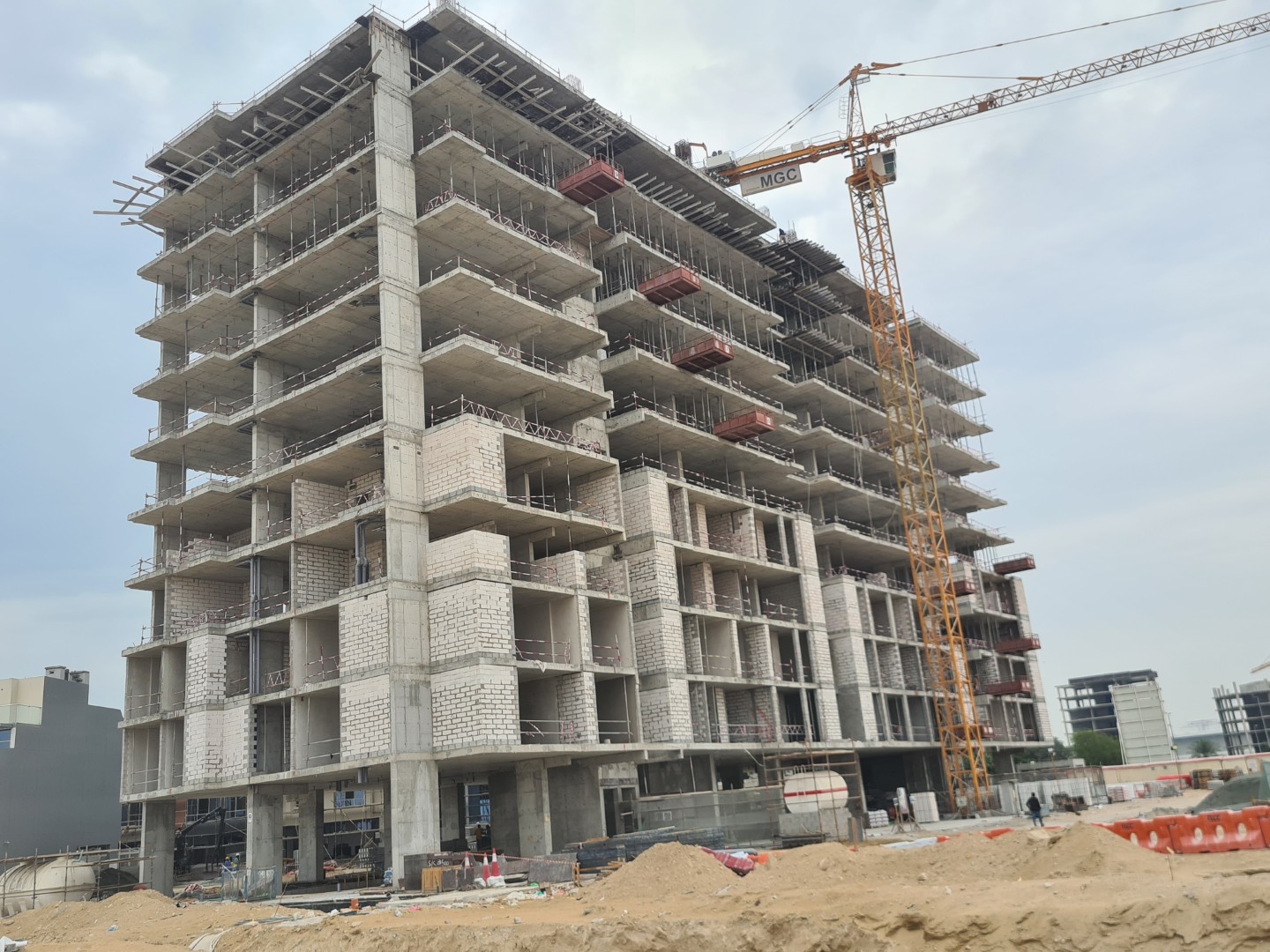

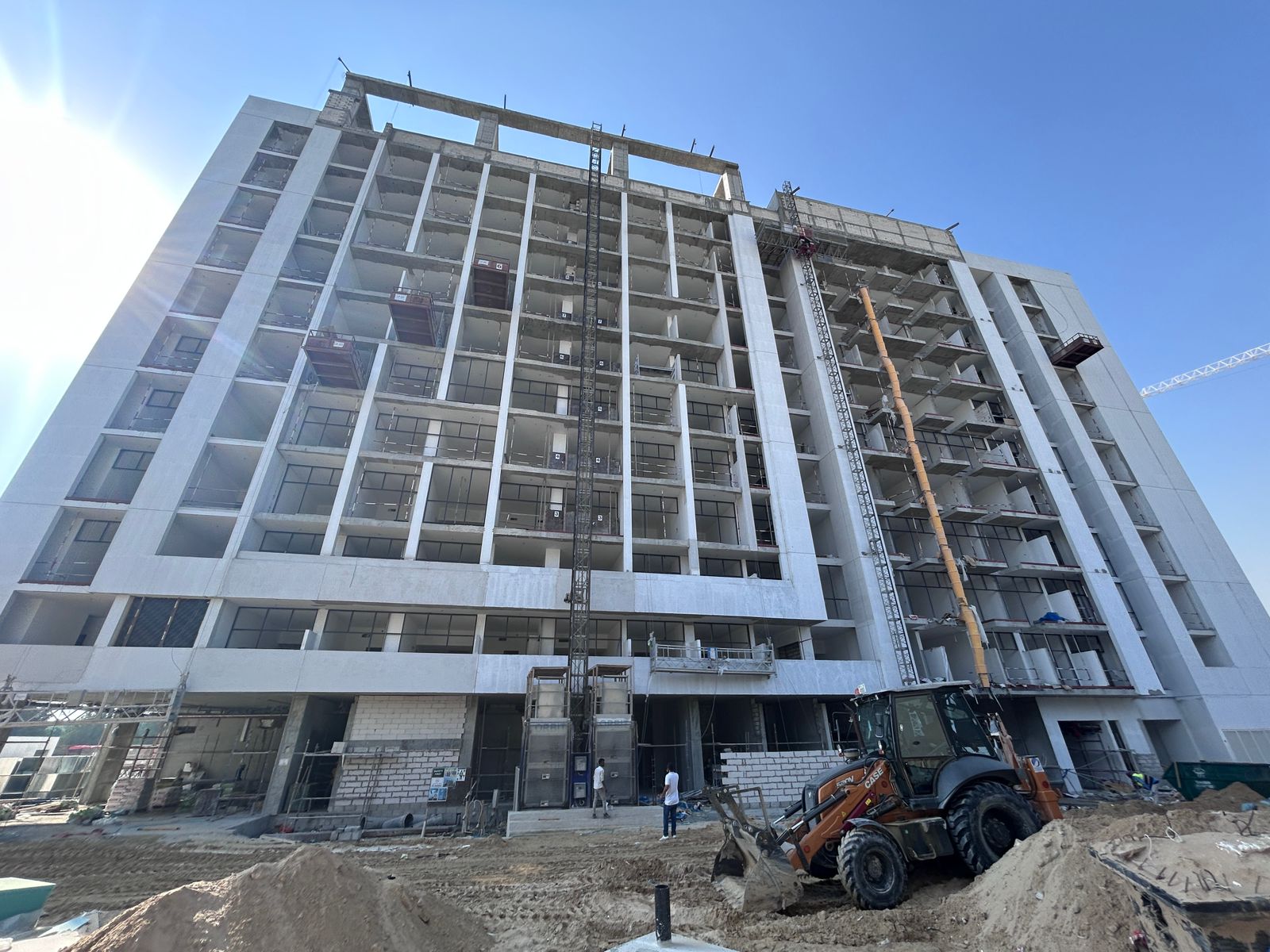

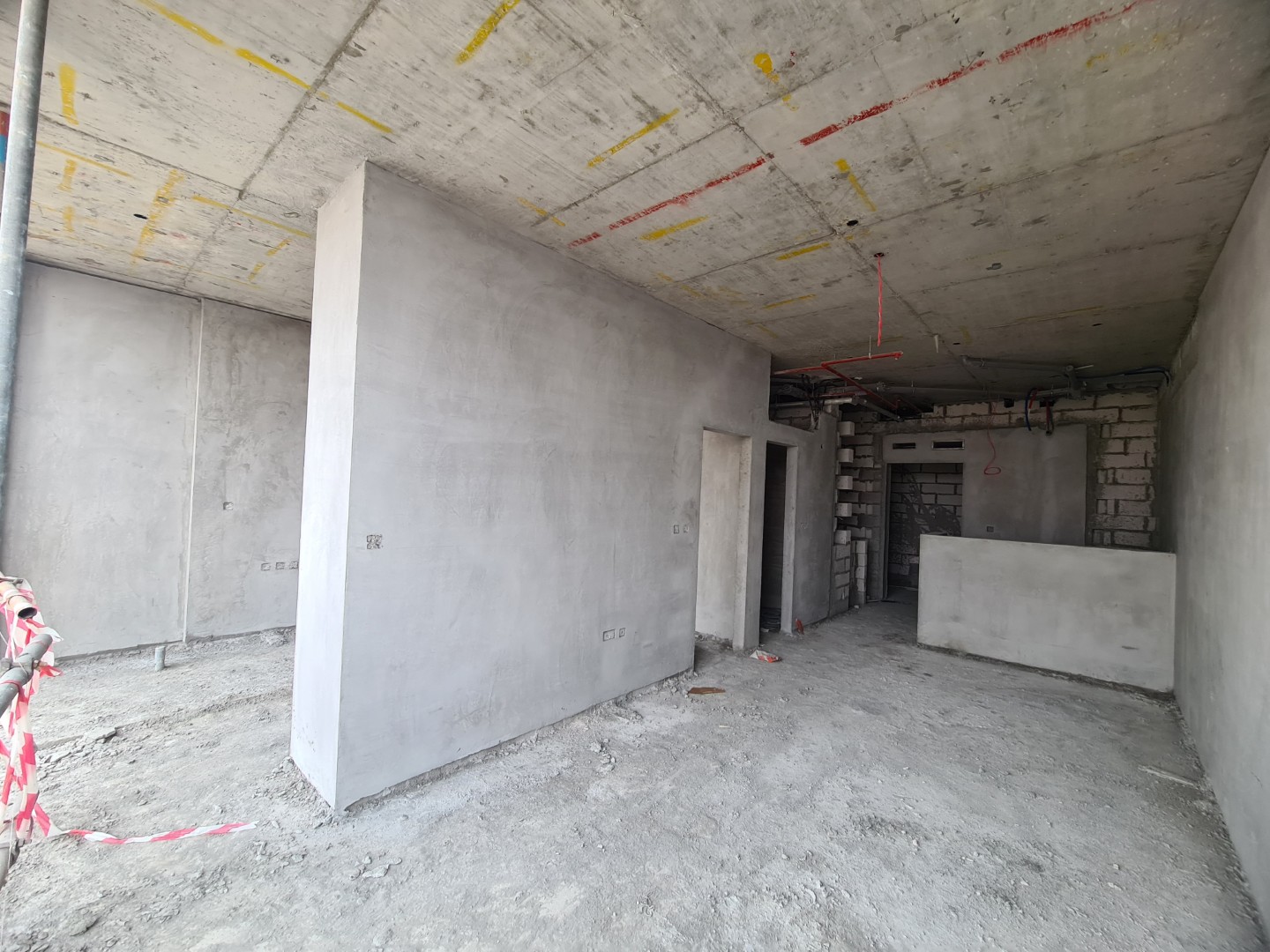

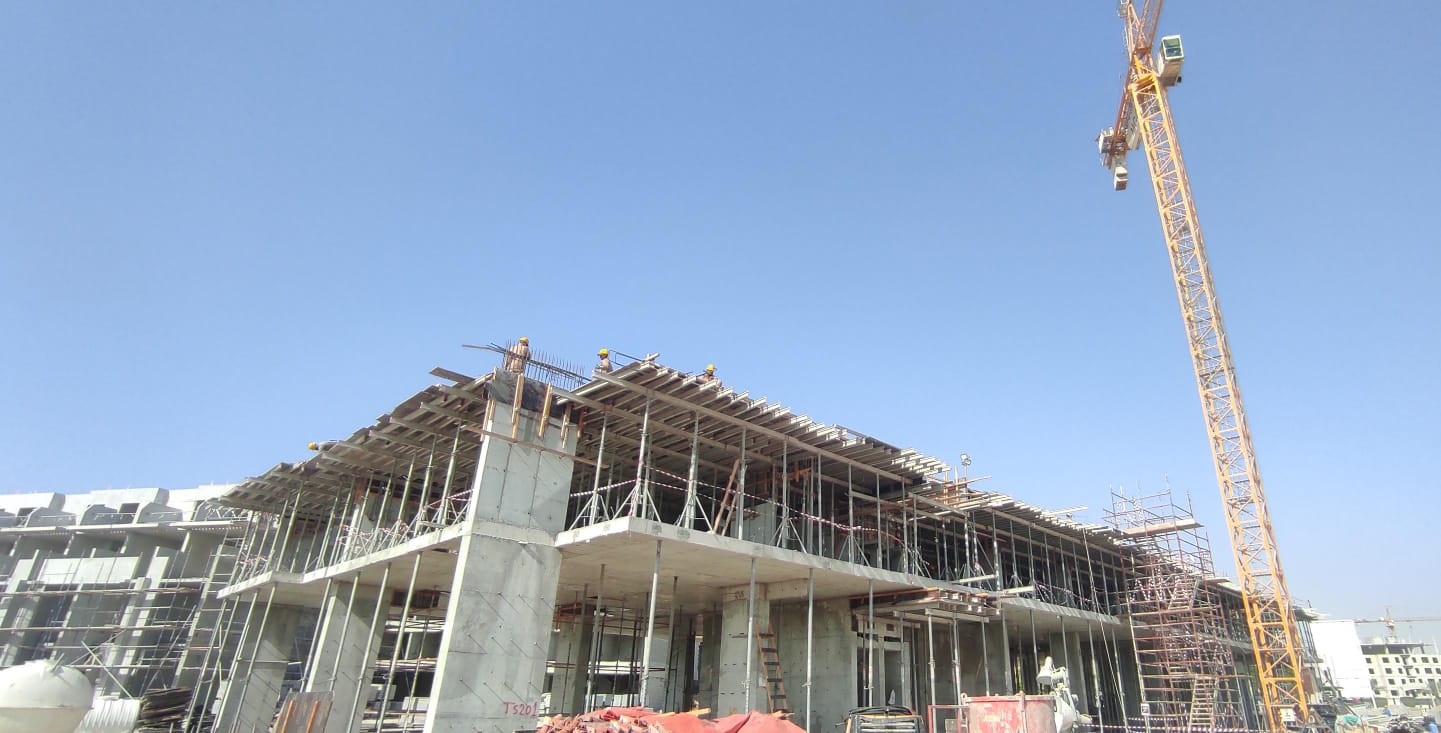

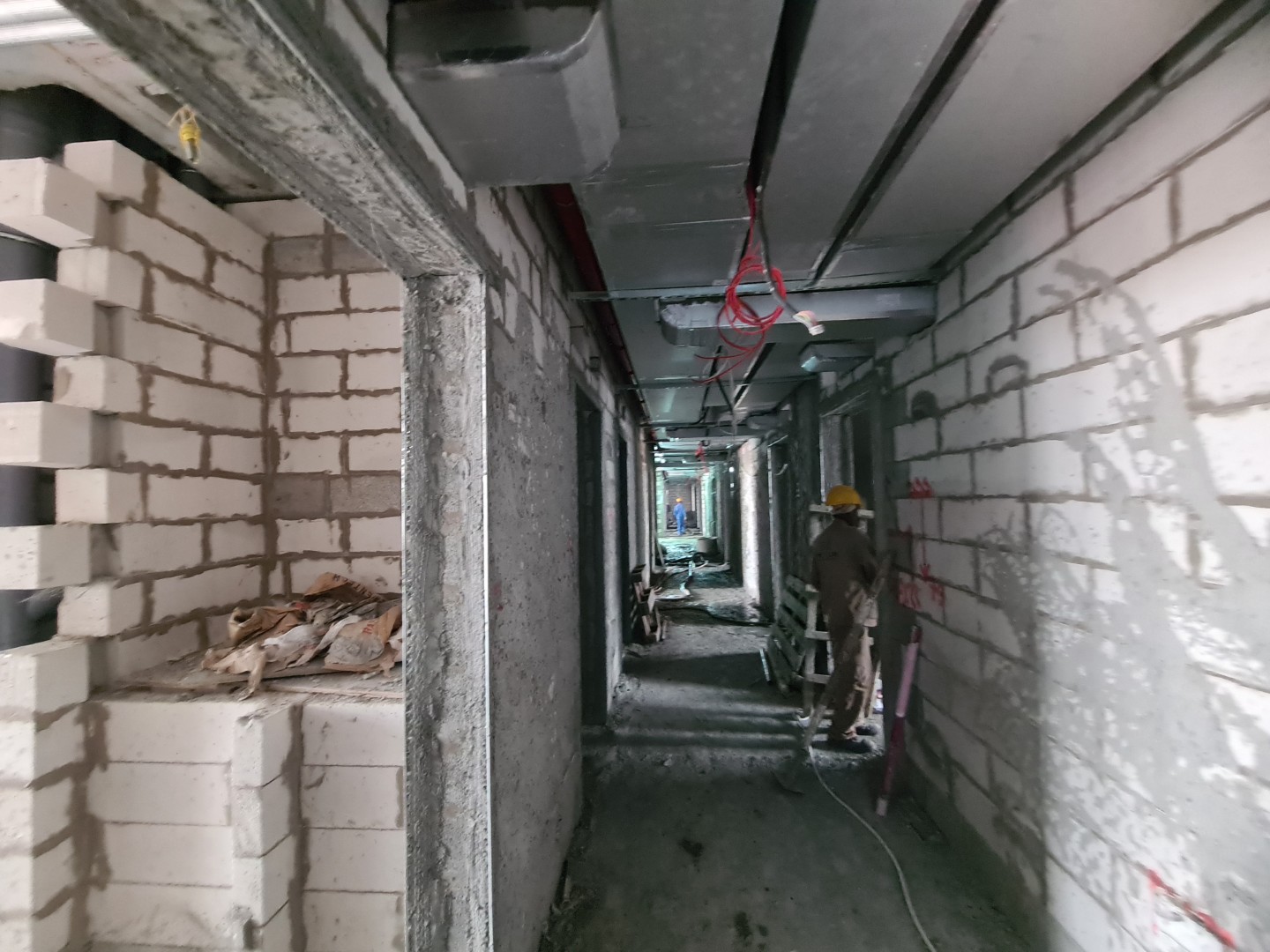

17 March 202543% built

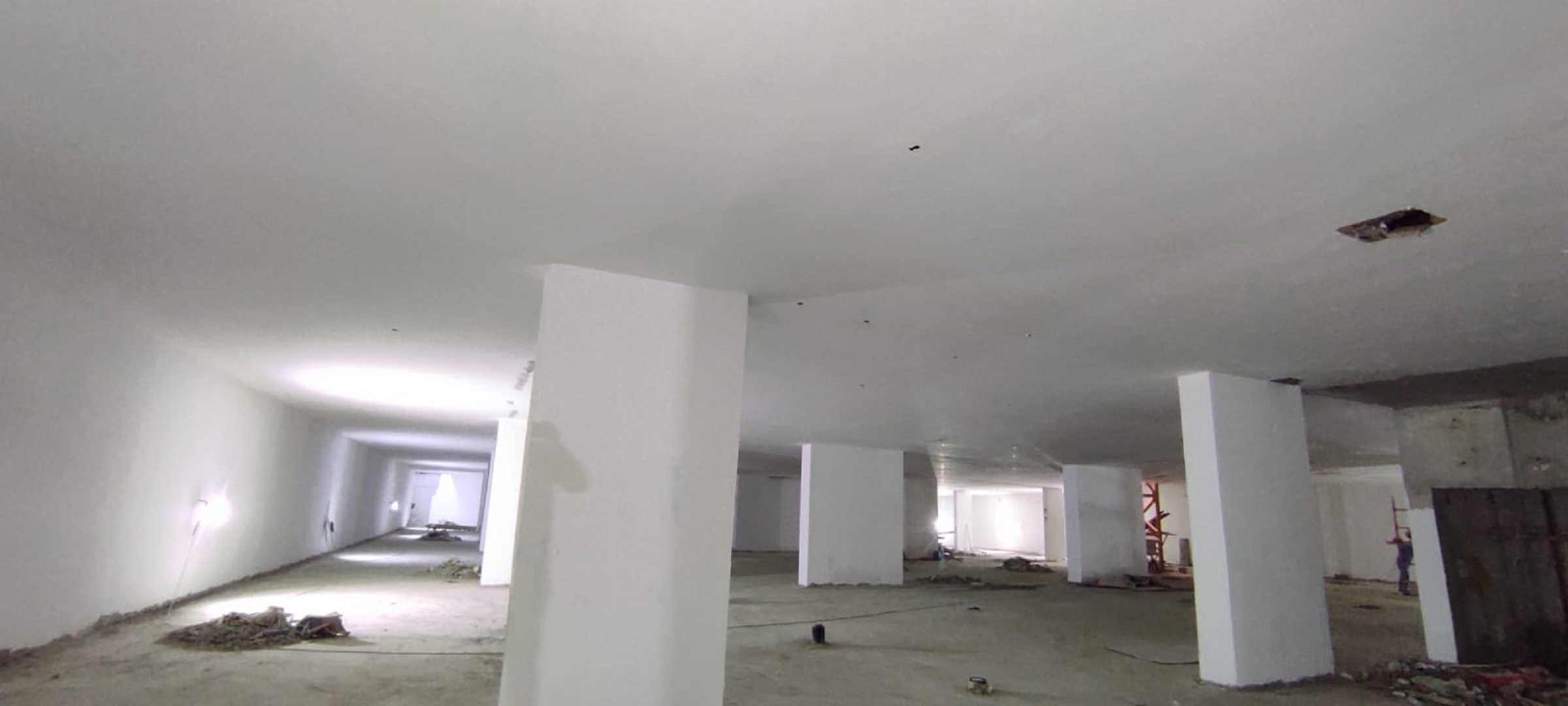

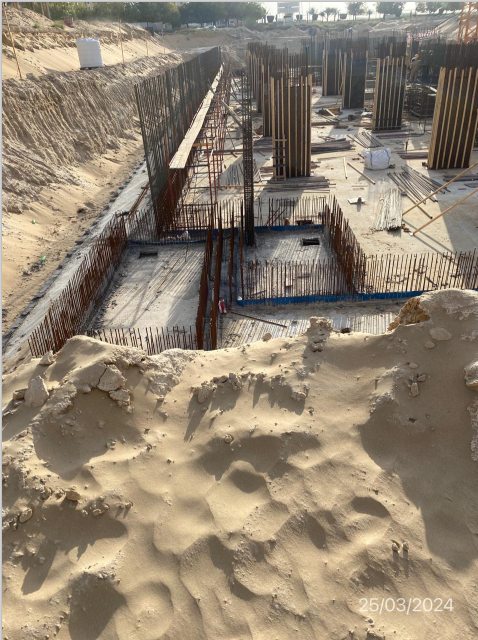

18 September 202419% built

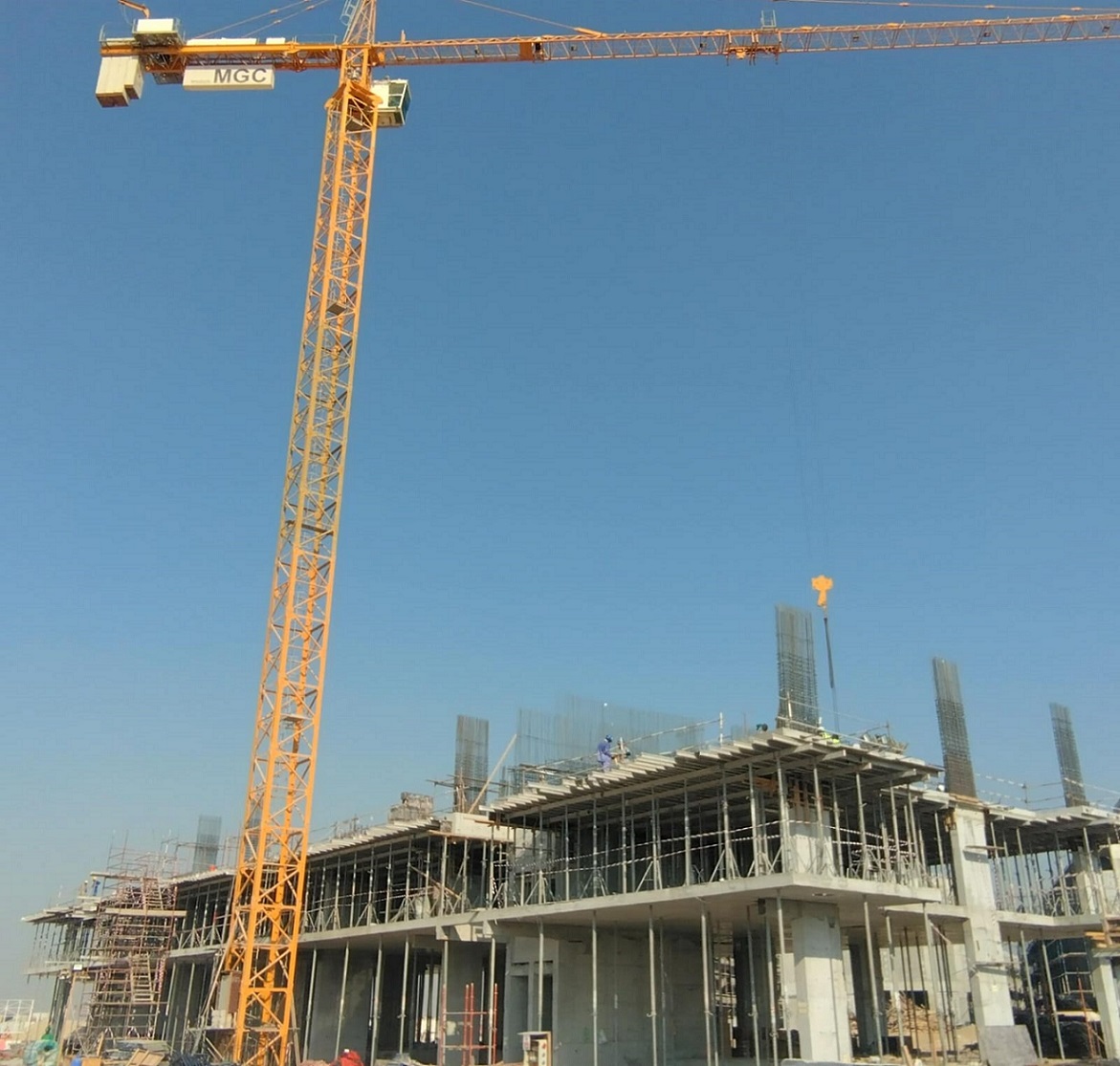

26 March 20246.5% built

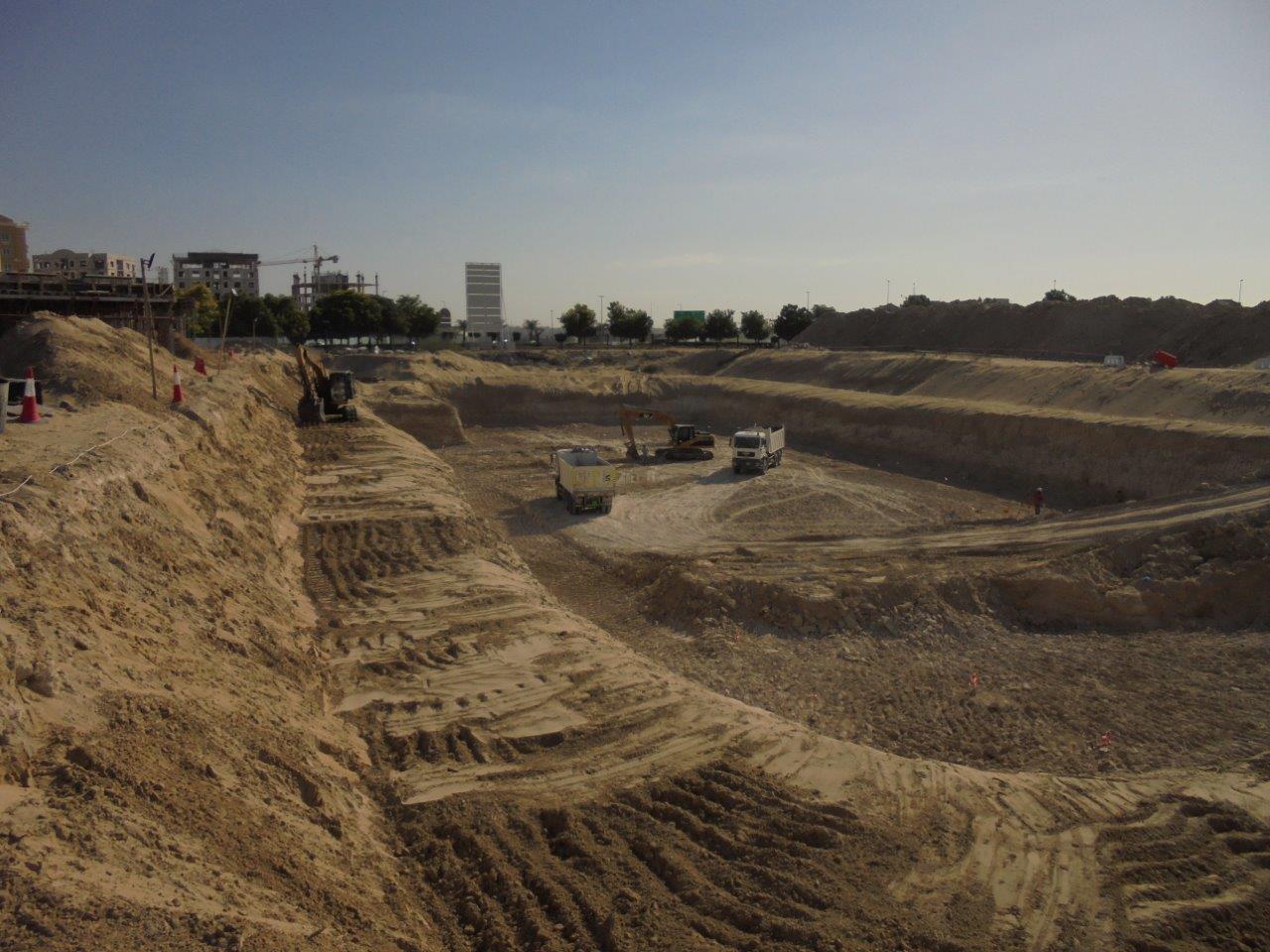

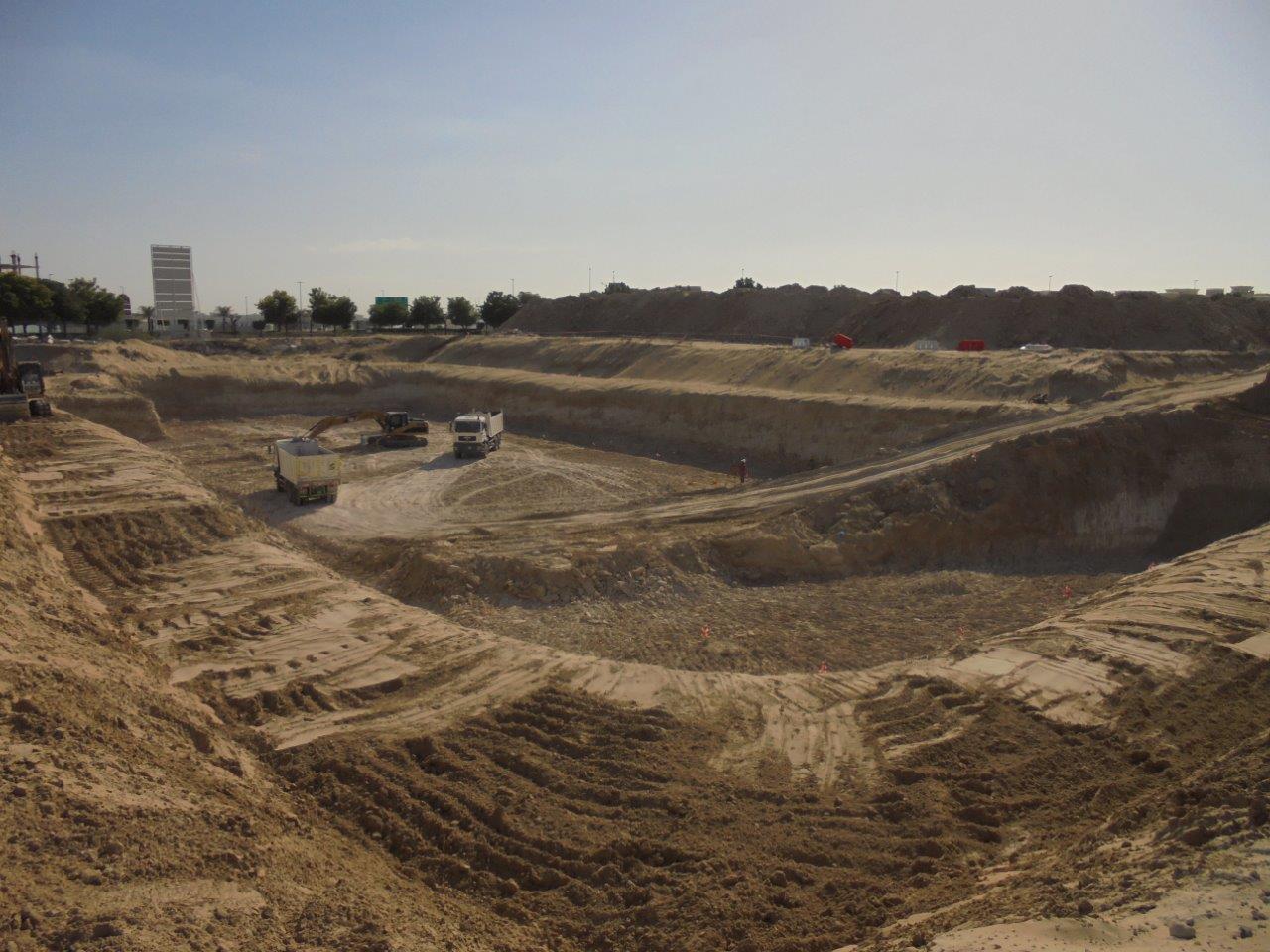

6 December 20232.0% built

26 July 20230.1% built

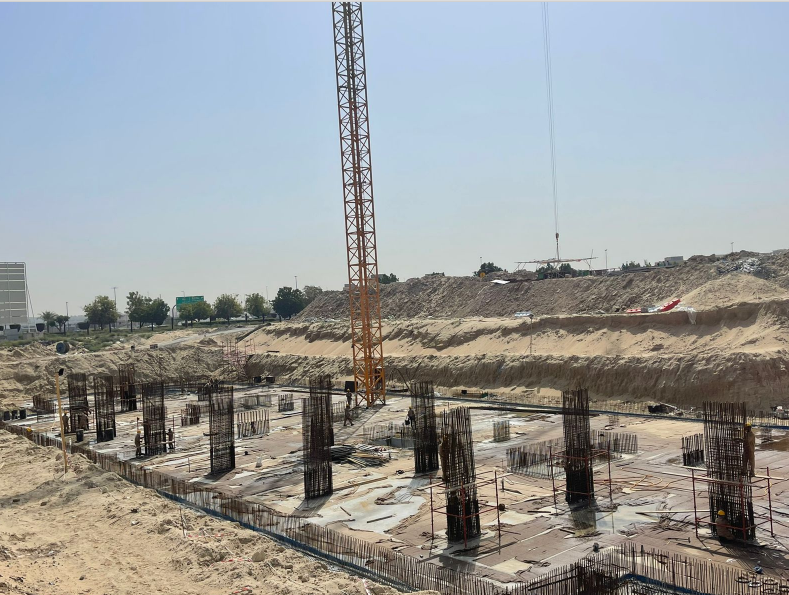

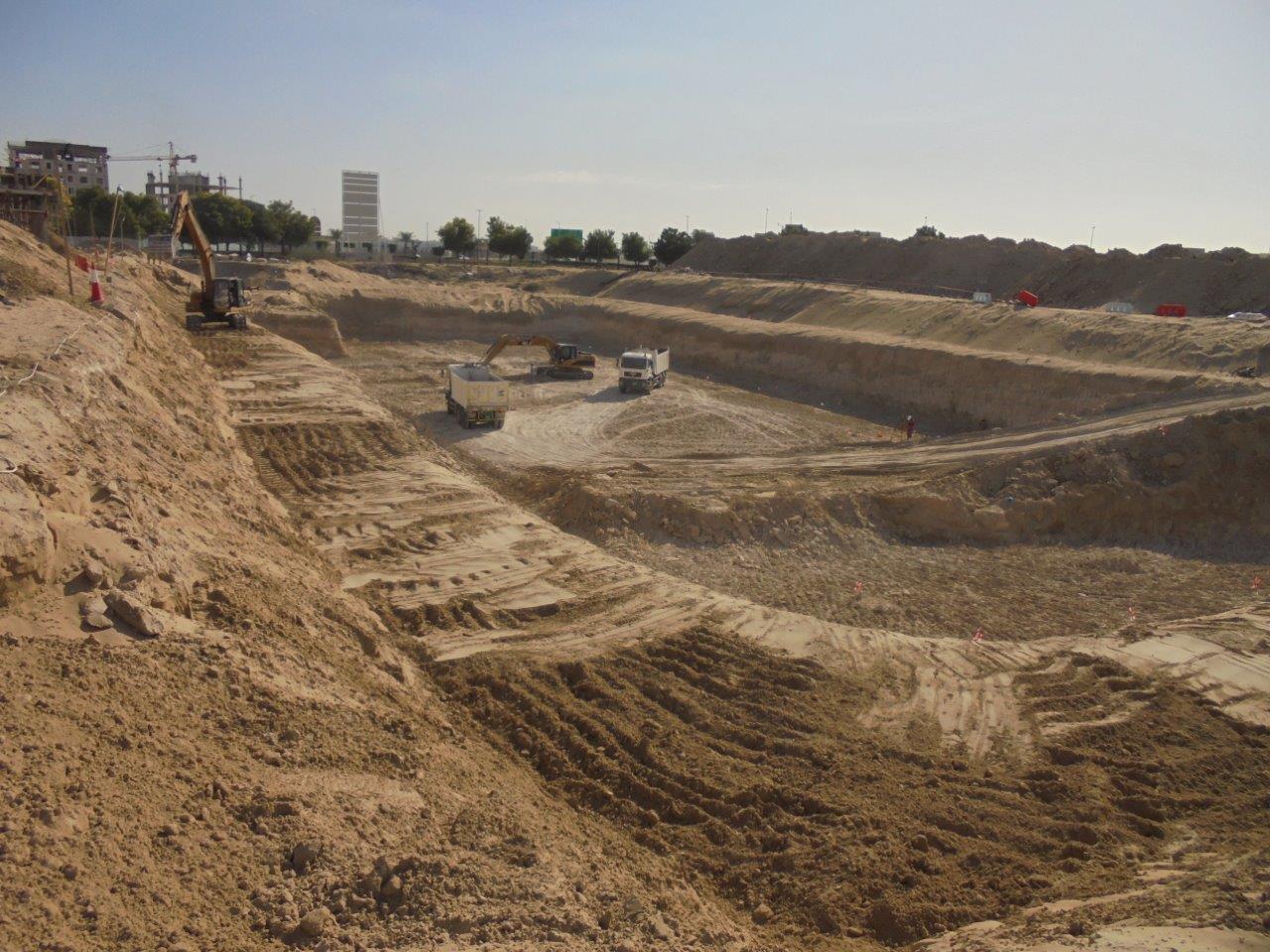

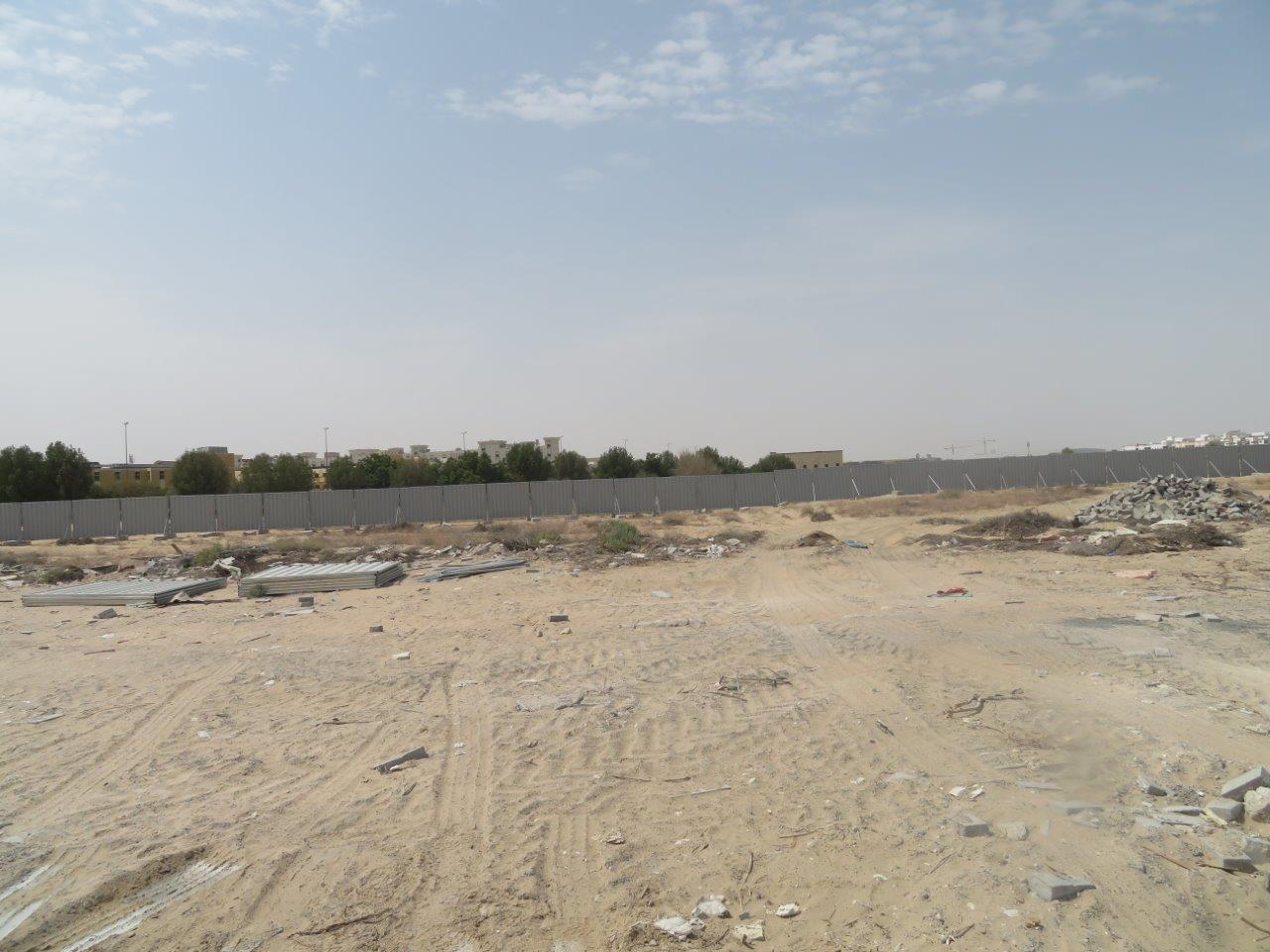

27 October 20220% built

Back to Verdana Residence construction progress

All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
