Altai Tower construction progress

The register lists Altai Tower in Jumeirah Village Triangle as complete, with a registered completion date of January 2026. Its last site inspection on record was in September 2026. The developer is Tiger Properties.

100%

Built, at the site inspection of 29 September 2026

Construction complete

Registered completion date
January 2026
Construction started
June 2023
First registered
June 2023
Units
239
Escrow bank
Abu Dhabi Commercial Bank
Name in Arabic
التاي تاور
Project number
2636
Site inspections
8

Schedule

The register lists Altai Tower as 100% built. Handover of individual units follows on the developer's schedule, which it does not show.

0%25%50%75%100%202420252026
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

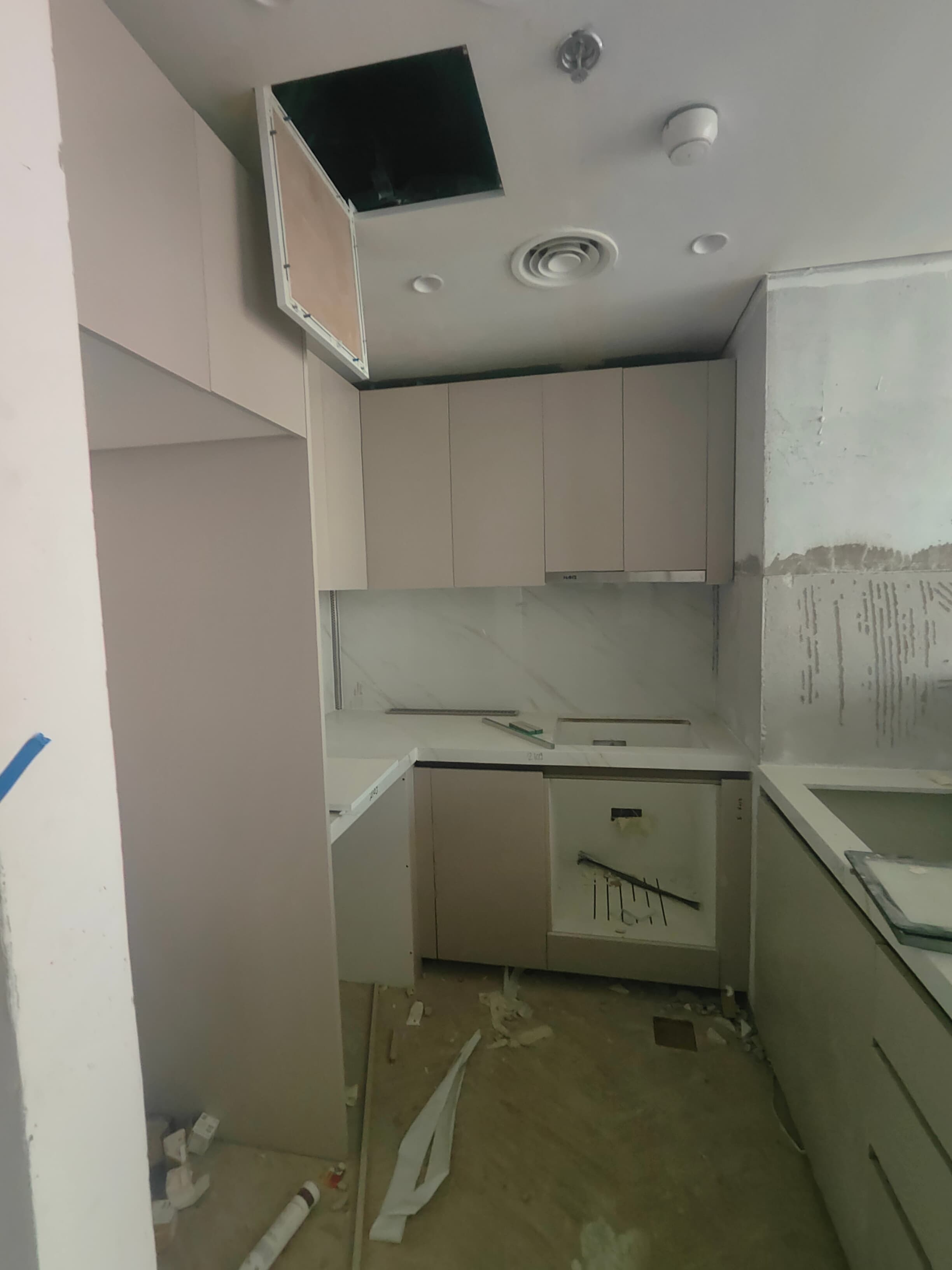

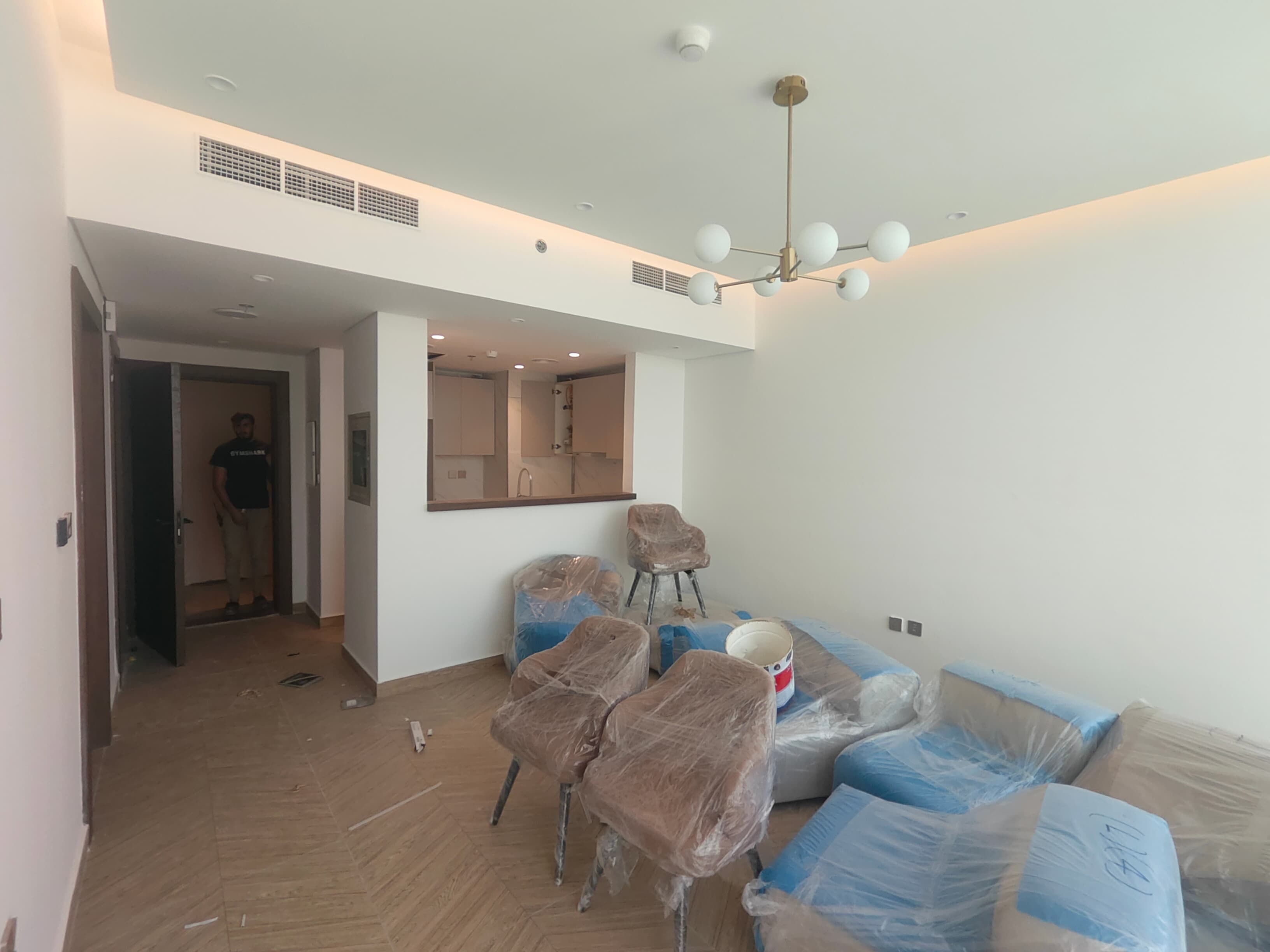

29 September 2026

98%+3.4 pts

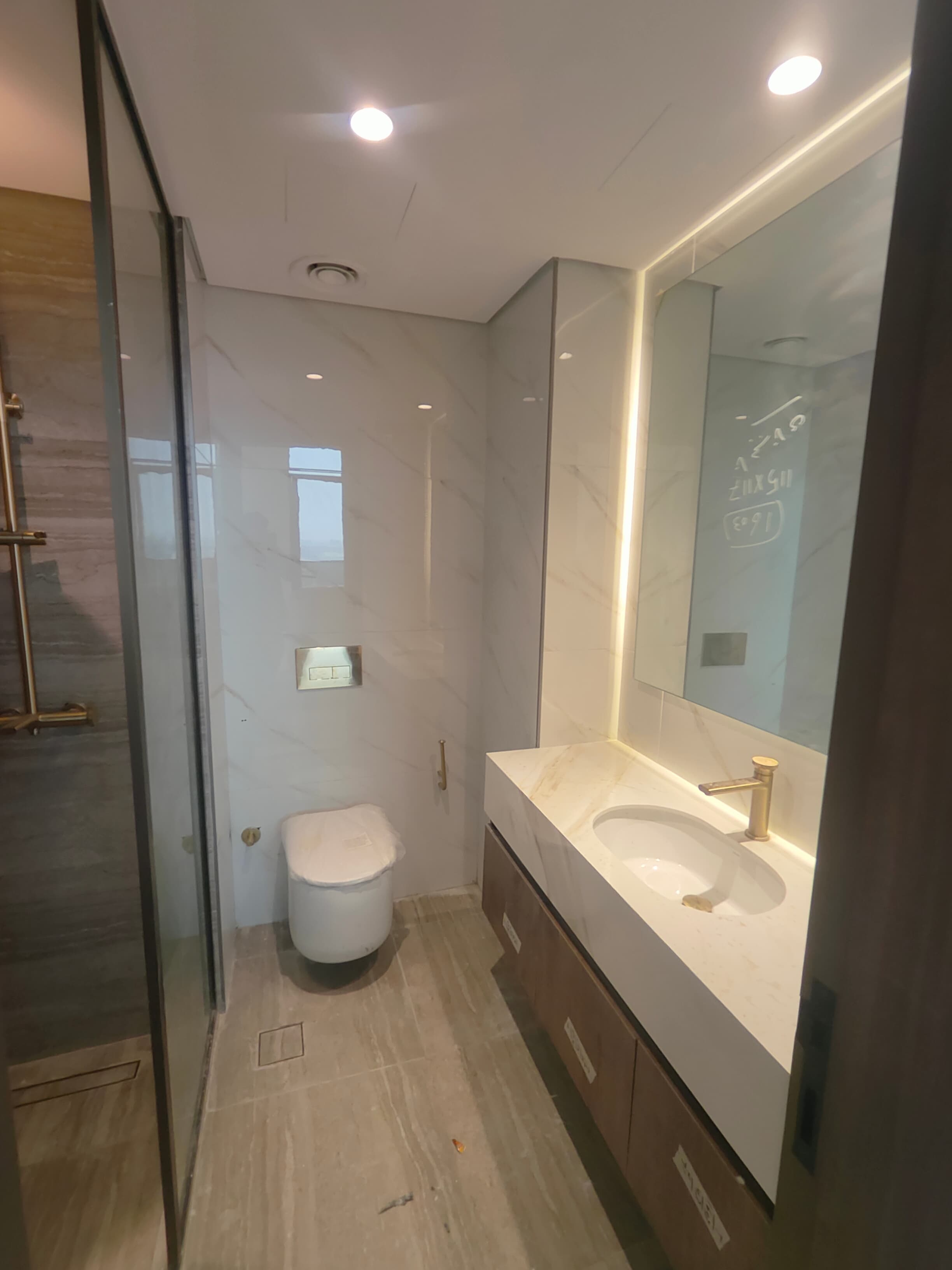

  • Altai Tower construction site, inspection photo 1, 29 September 2026
  • Altai Tower construction site, inspection photo 2, 29 September 2026
  • Altai Tower construction site, inspection photo 3, 29 September 2026
  • Altai Tower construction site, inspection photo 4, 29 September 2026

11 August 2026

95%+13 pts

  • Altai Tower construction site, inspection photo 1, 11 August 2026
  • Altai Tower construction site, inspection photo 2, 11 August 2026
  • Altai Tower construction site, inspection photo 3, 11 August 2026
  • Altai Tower construction site, inspection photo 4, 11 August 2026

27 April 2026

82%+16 pts

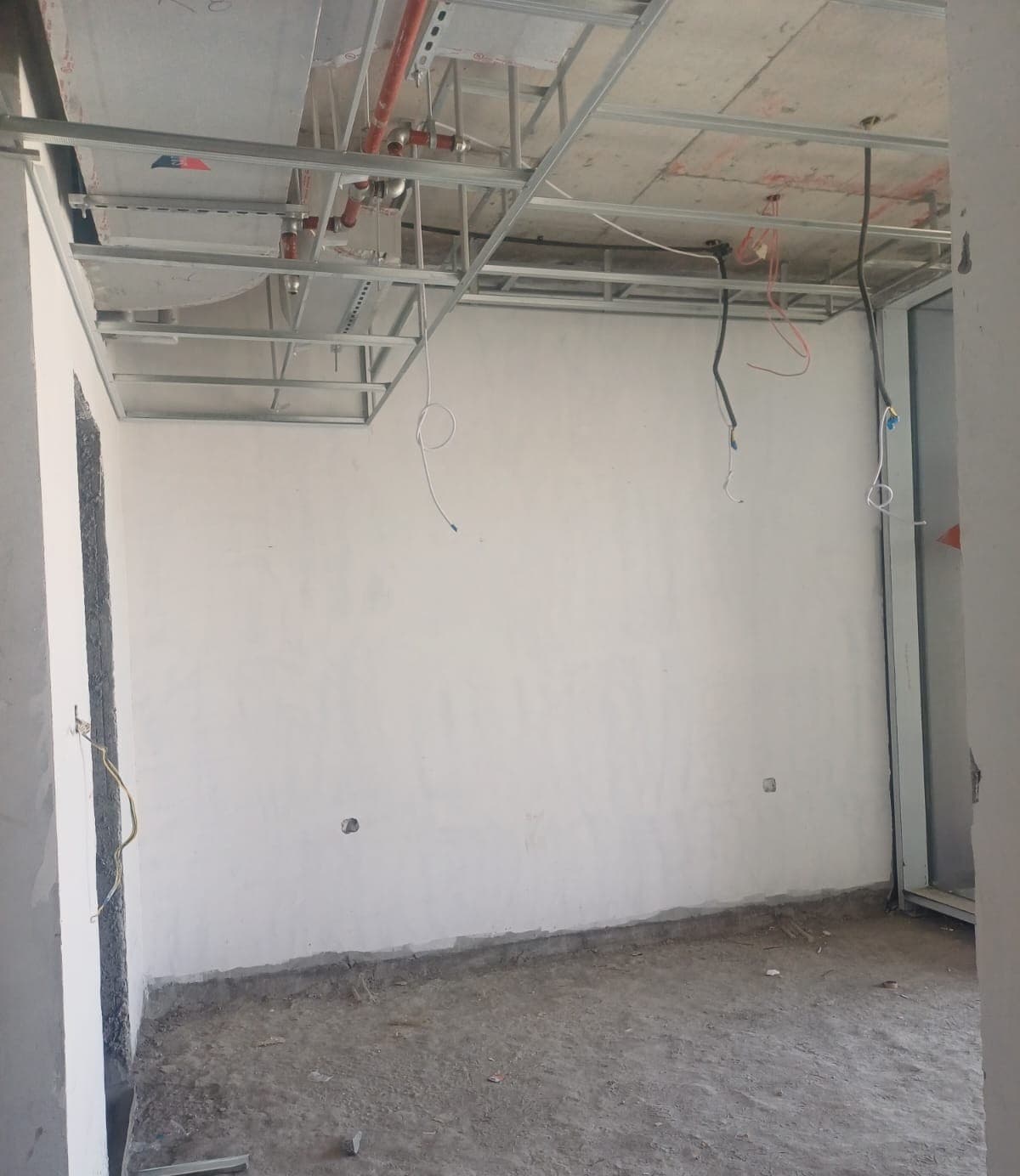

  • Altai Tower construction site, inspection photo 1, 27 April 2026

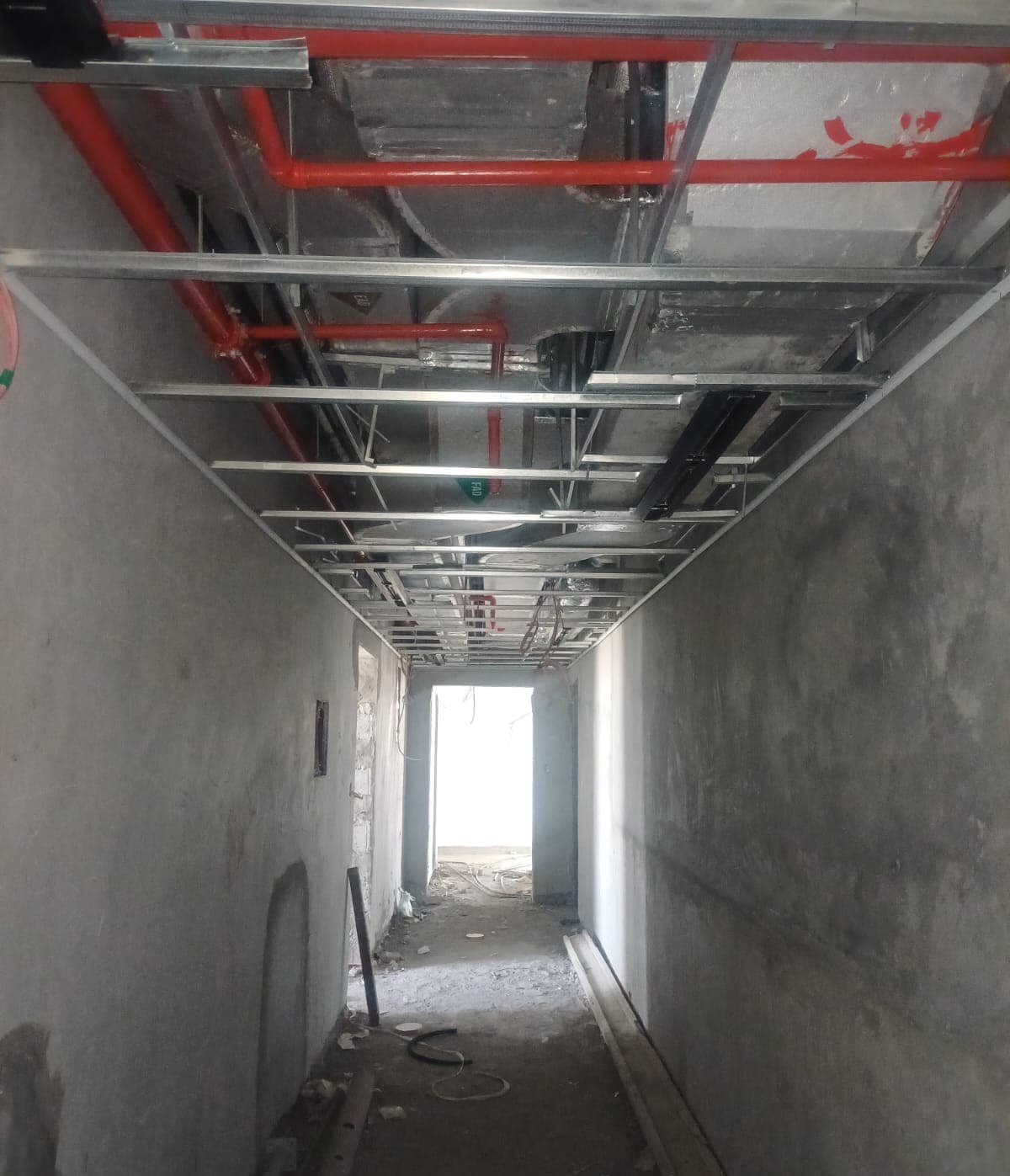

  • Altai Tower construction site, inspection photo 2, 27 April 2026

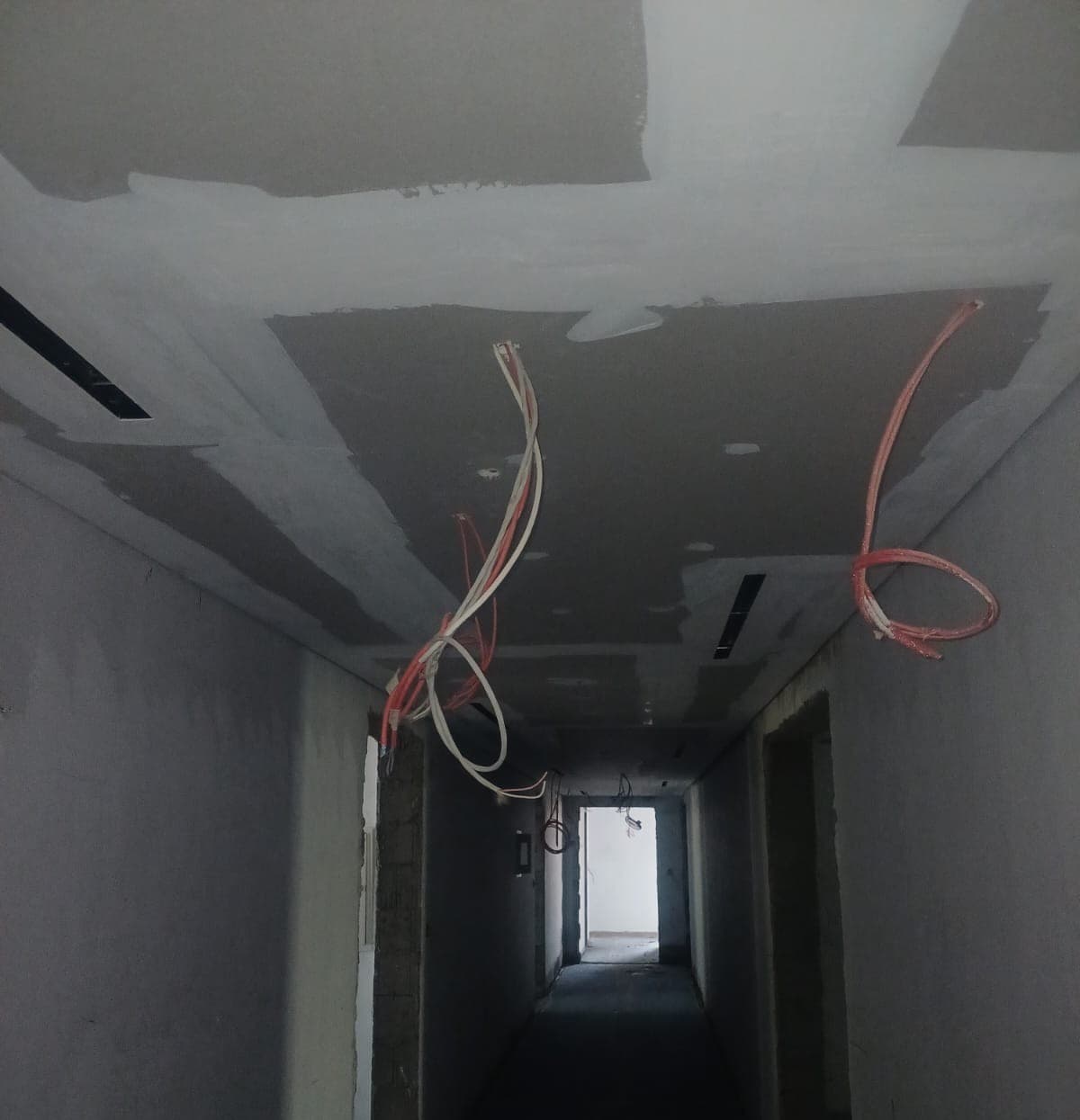

  • Altai Tower construction site, inspection photo 3, 27 April 2026
  • Altai Tower construction site, inspection photo 4, 27 April 2026

29 December 2025

66%+35 pts

  • Altai Tower construction site, inspection photo 1, 29 December 2025
  • Altai Tower construction site, inspection photo 2, 29 December 2025
  • Altai Tower construction site, inspection photo 3, 29 December 2025
  • Altai Tower construction site, inspection photo 4, 29 December 2025

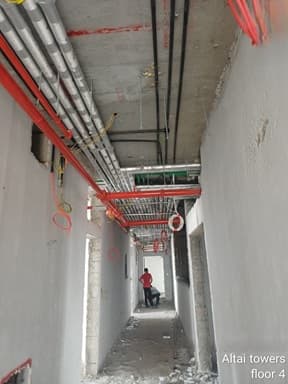

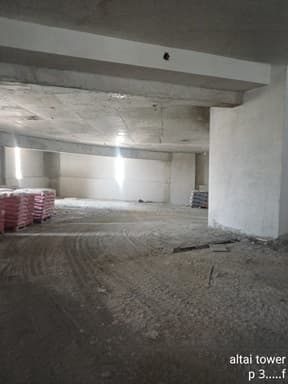

22 July 2025

31%+17 pts

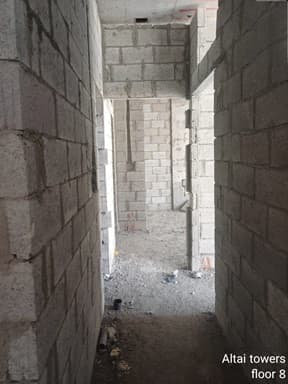

  • Altai Tower construction site, inspection photo 1, 22 July 2025
  • Altai Tower construction site, inspection photo 2, 22 July 2025
  • Altai Tower construction site, inspection photo 3, 22 July 2025
  • Altai Tower construction site, inspection photo 4, 22 July 2025

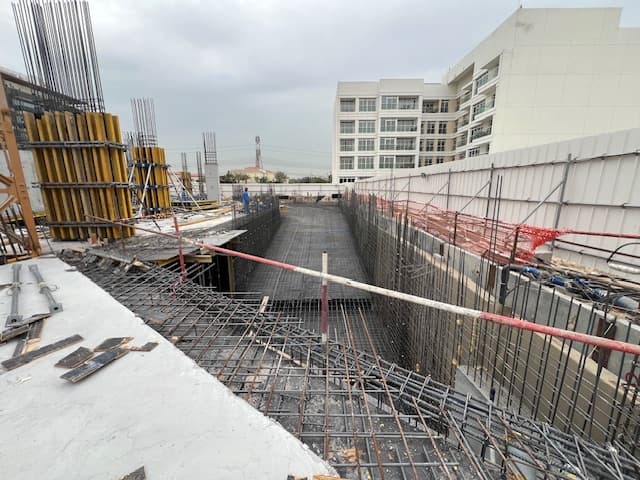

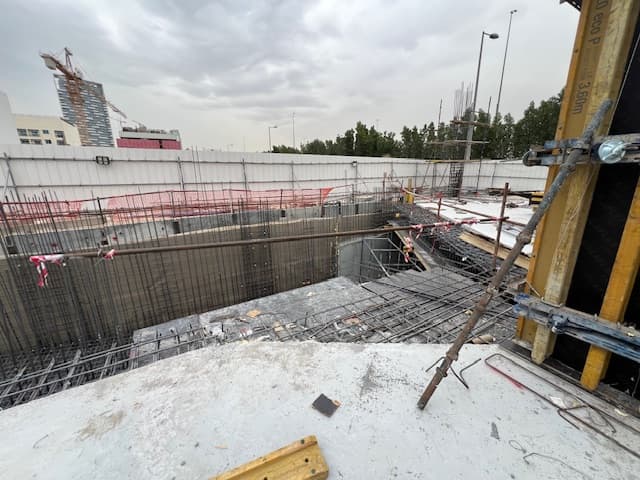

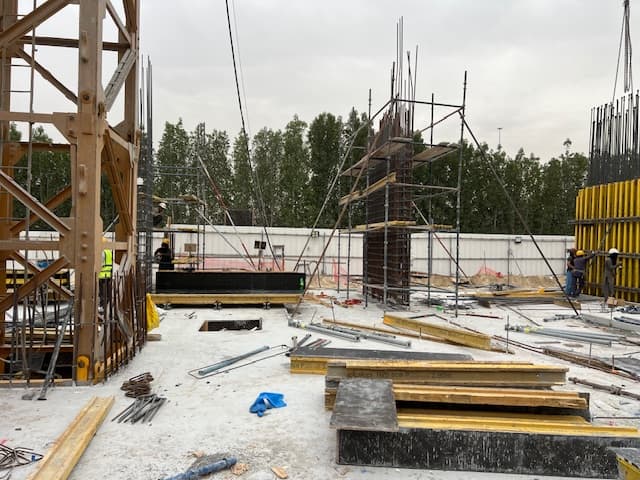

18 February 2025

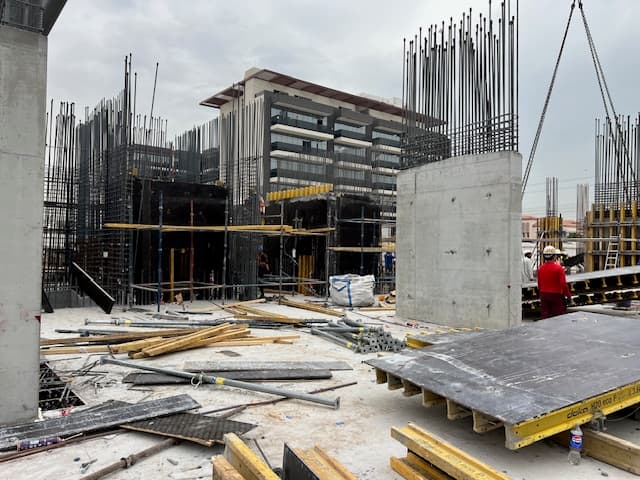

13%+13 pts

  • Altai Tower construction site, inspection photo 1, 18 February 2025
  • Altai Tower construction site, inspection photo 2, 18 February 2025
  • Altai Tower construction site, inspection photo 3, 18 February 2025
  • Altai Tower construction site, inspection photo 4, 18 February 2025

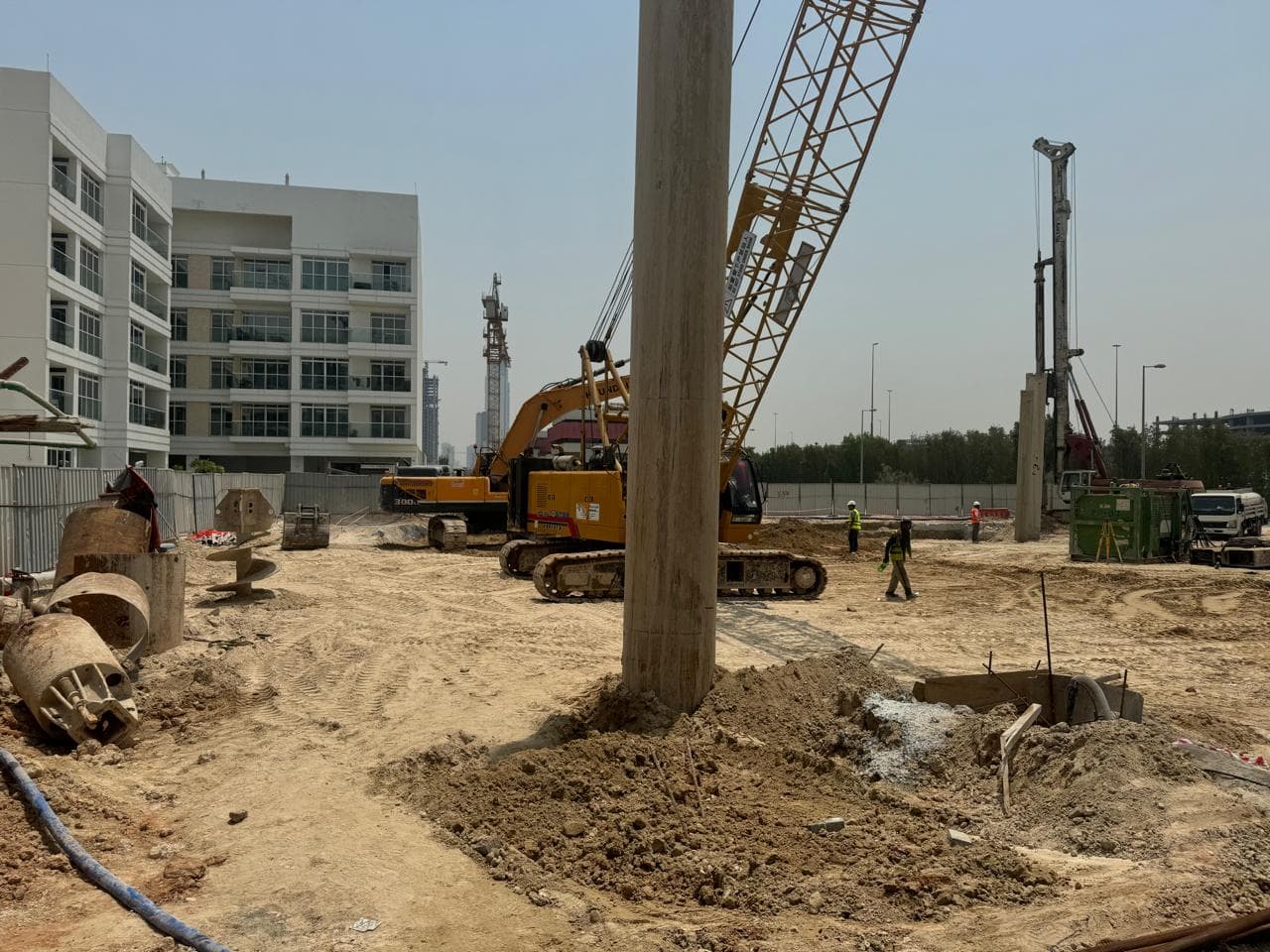

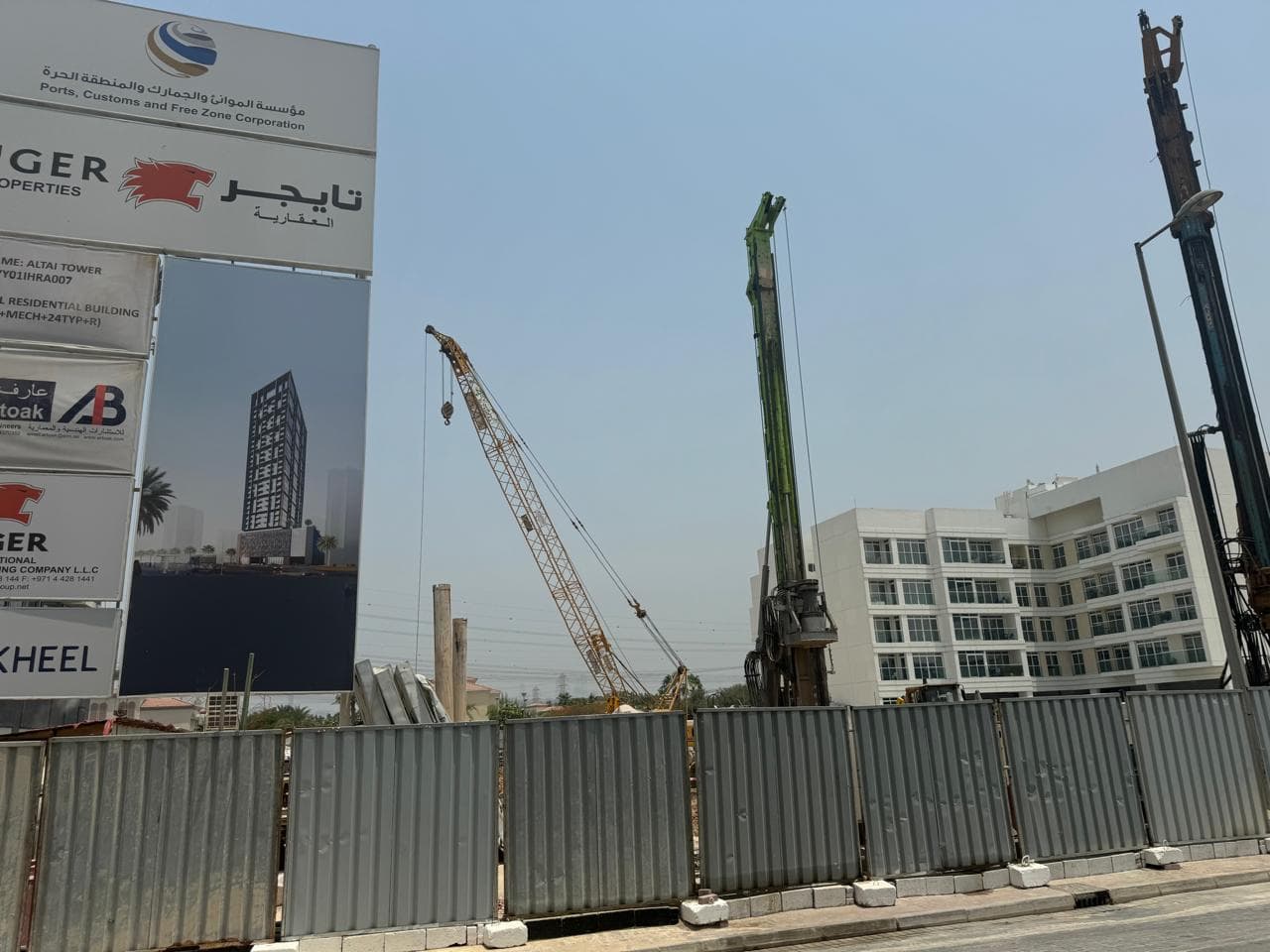

8 July 2024

0.7%+0.7 pts

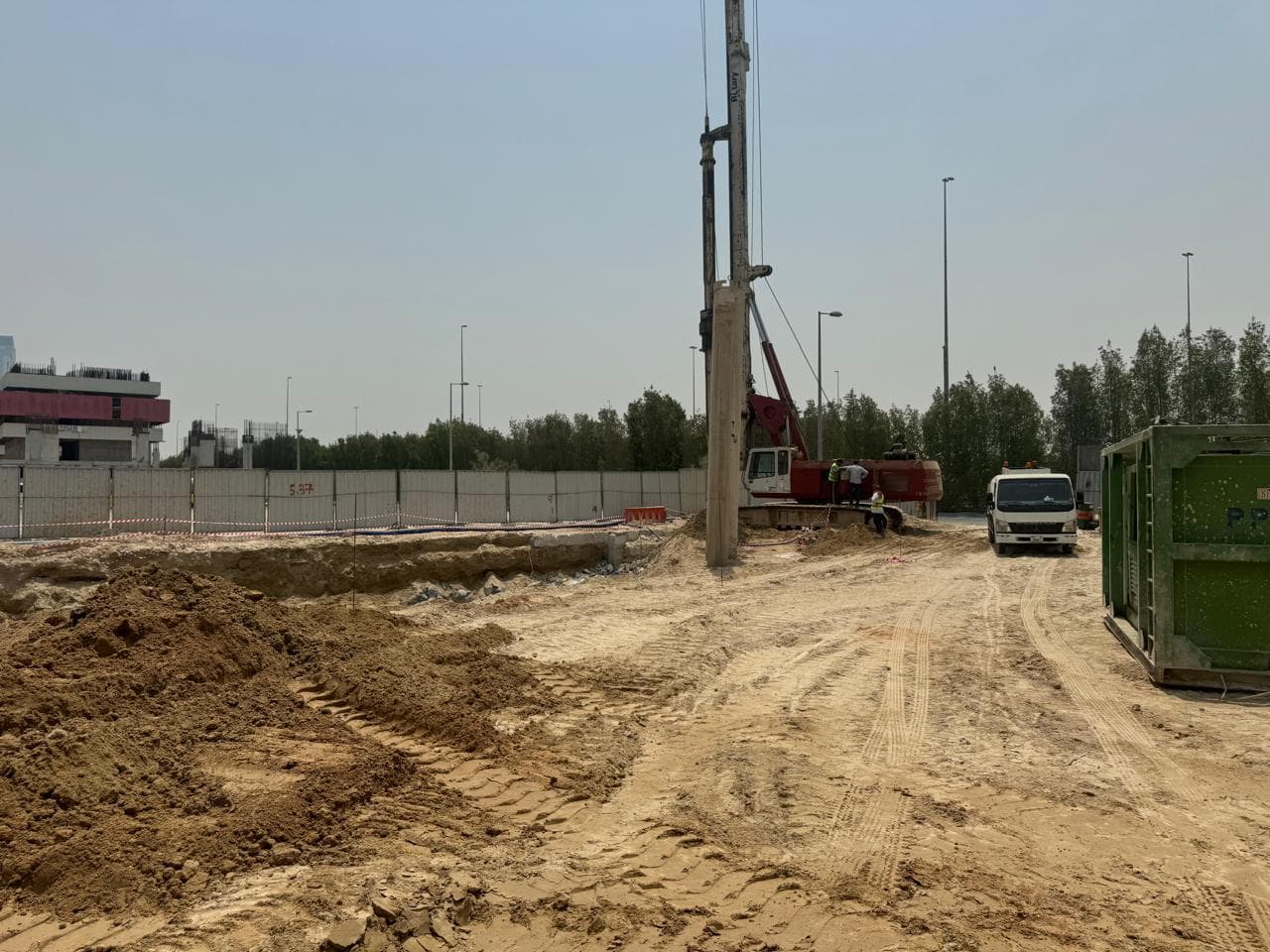

  • Altai Tower construction site, inspection photo 1, 8 July 2024
  • Altai Tower construction site, inspection photo 2, 8 July 2024
  • Altai Tower construction site, inspection photo 3, 8 July 2024

25 May 2023

0%

  • Altai Tower construction site, inspection photo 1, 25 May 2023
  • Altai Tower construction site, inspection photo 2, 25 May 2023
  • Altai Tower construction site, inspection photo 3, 25 May 2023

All 70 site photos, by inspection date

Context

Jumeirah Village Triangle has 29 projects under construction, 27% built on average.

Tiger Properties has 8 projects under construction in Dubai, none past their registered completion dates.

Own a unit in Altai Tower?

The building is finished, so now come the snagging, the handover papers, finding a tenant and keeping an eye on what the unit is worth. Mulki keeps all of that in one private app.

Notify me when it launches

Questions

When is the Altai Tower handover date?
Construction of Altai Tower is recorded as complete, with a registered completion date of January 2026. Handover of individual units follows on the developer's schedule, which the register does not show.
What is the latest construction update on Altai Tower?
Altai Tower was 100% built at the site inspection on 29 September 2026. The site has been inspected 8 times since May 2023. The Land Department took 70 site photos at its inspections.
Is Altai Tower delayed?
The register lists construction as complete.
Who is building Altai Tower?
The registered developer is Tiger Properties. It has 8 other projects under construction in Dubai.
Which bank holds the escrow account for Altai Tower?
Abu Dhabi Commercial Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
