Time 2 construction photos
61 photos taken by Dubai Land Department engineers at 8 site inspections, newest first. The percentage is how much of Time 2 was built on the day of each visit.
28 April 202687% built
8 December 202572% built

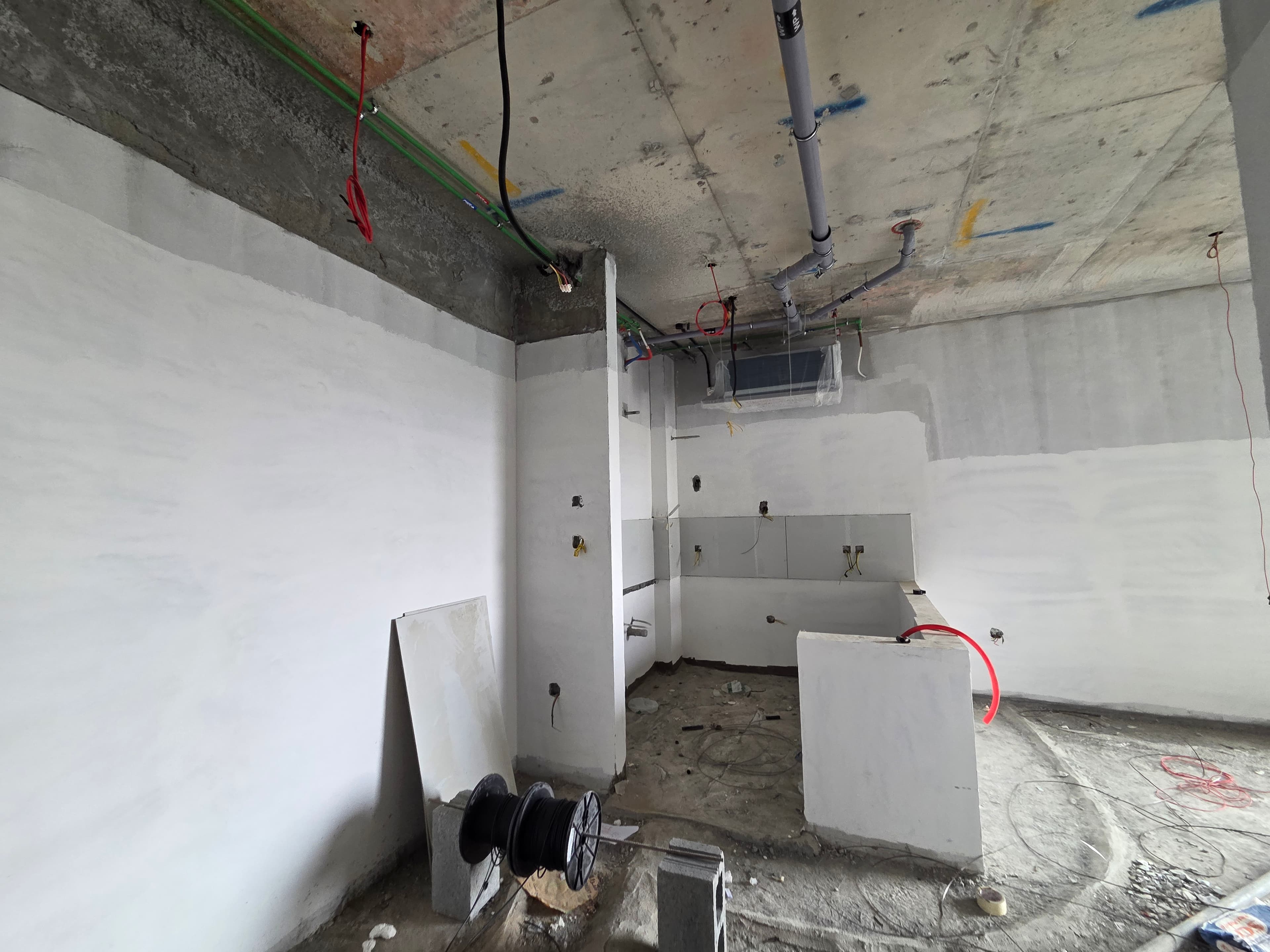

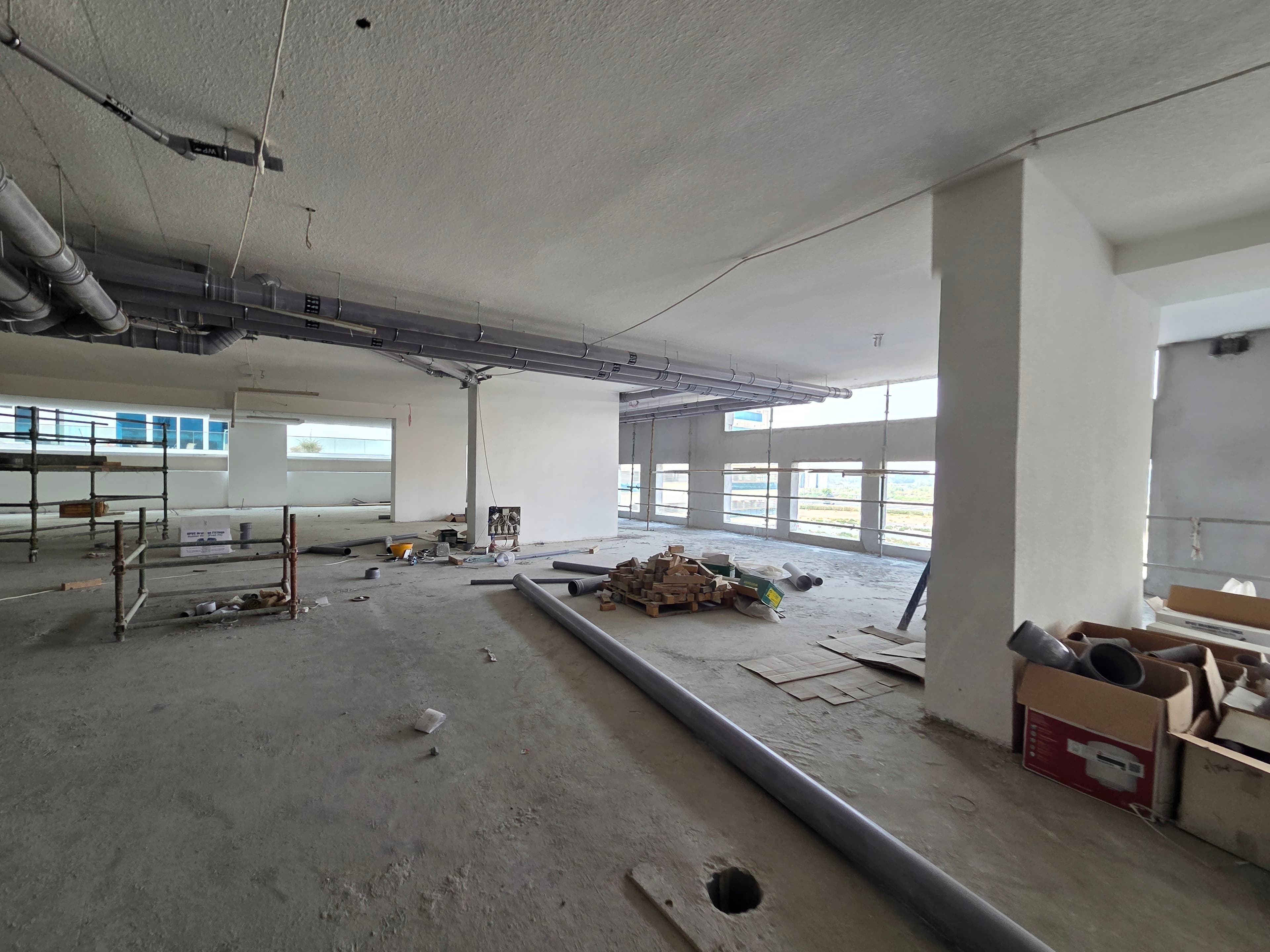

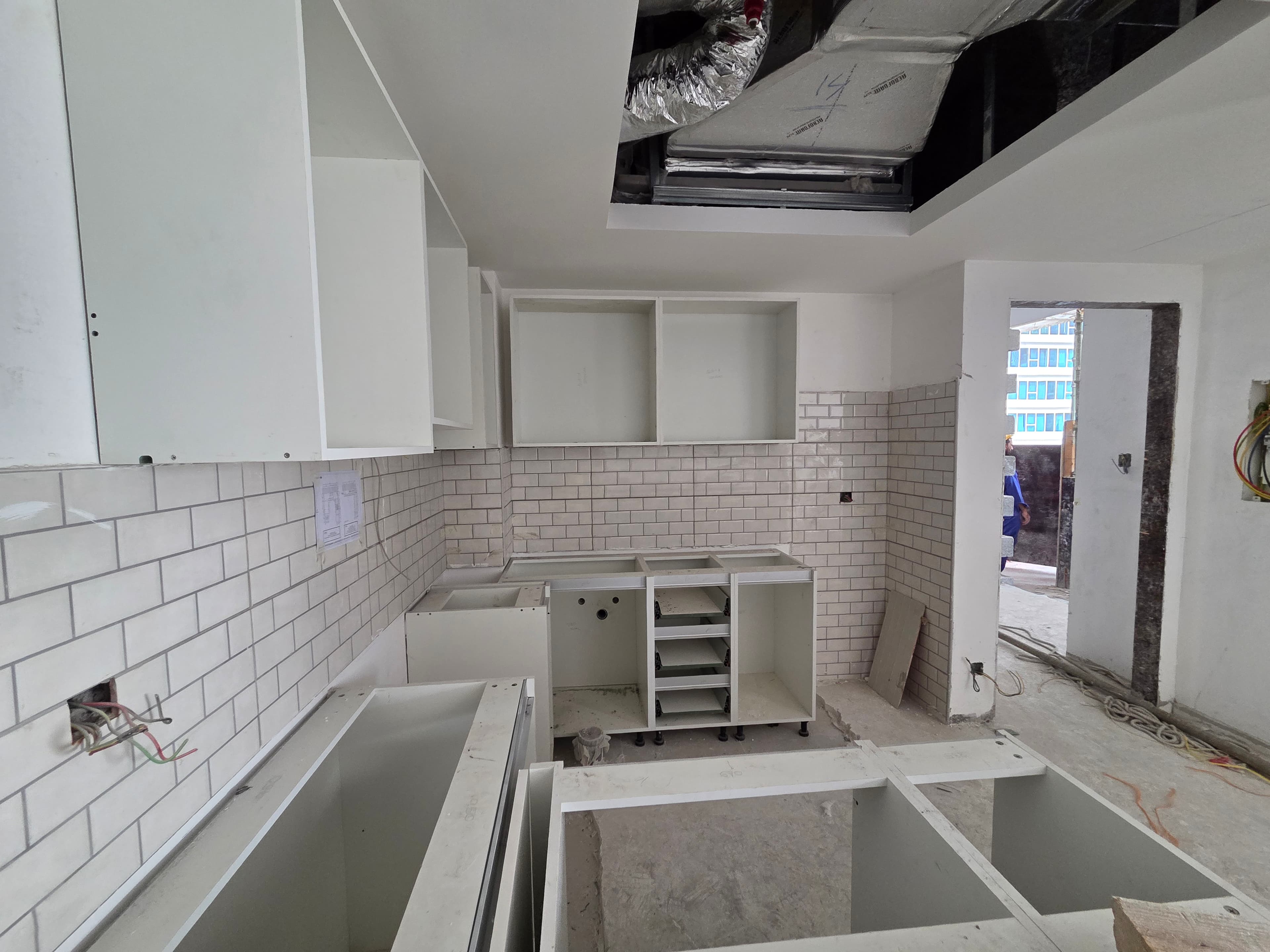

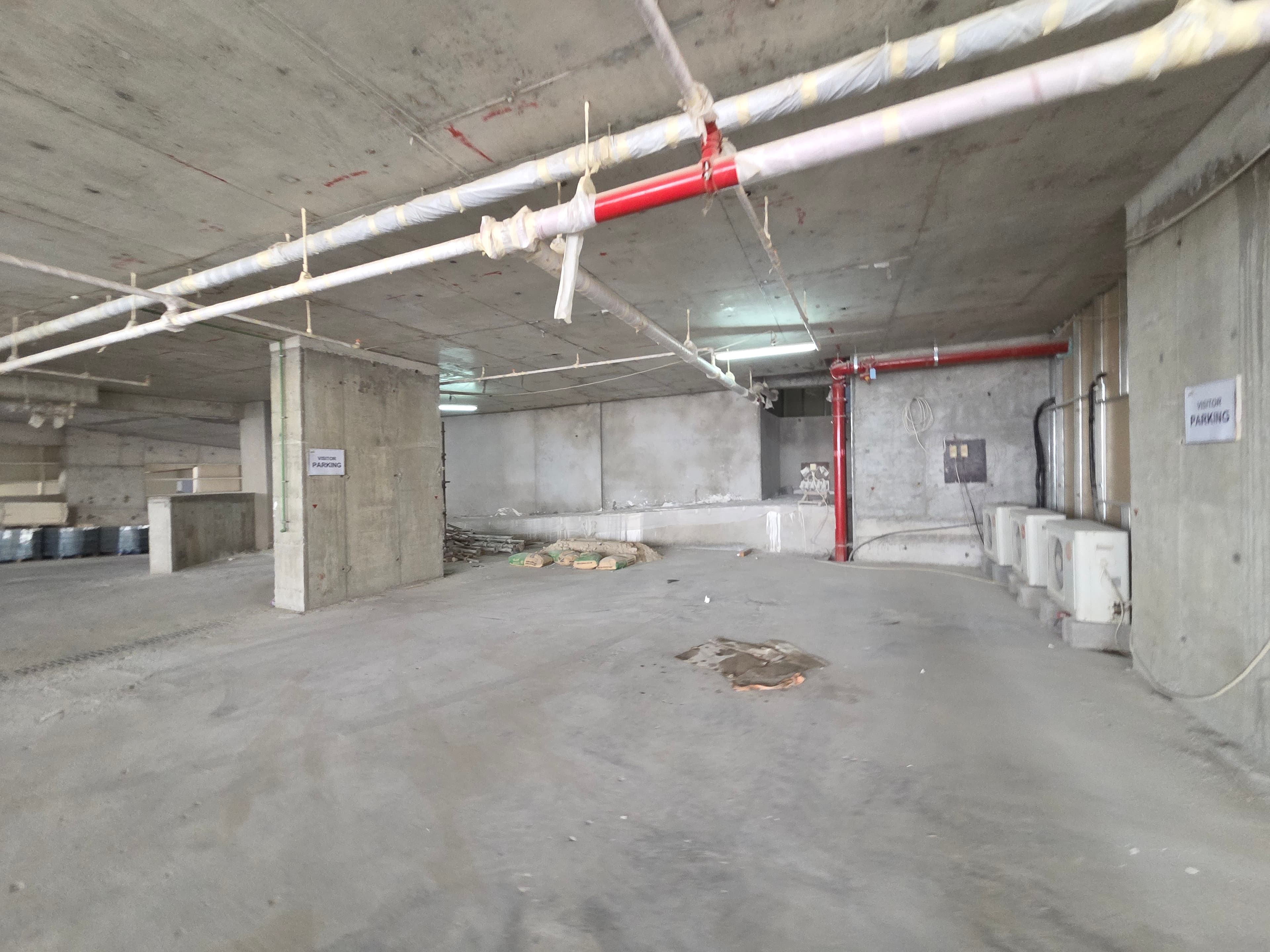

31 July 202559% built

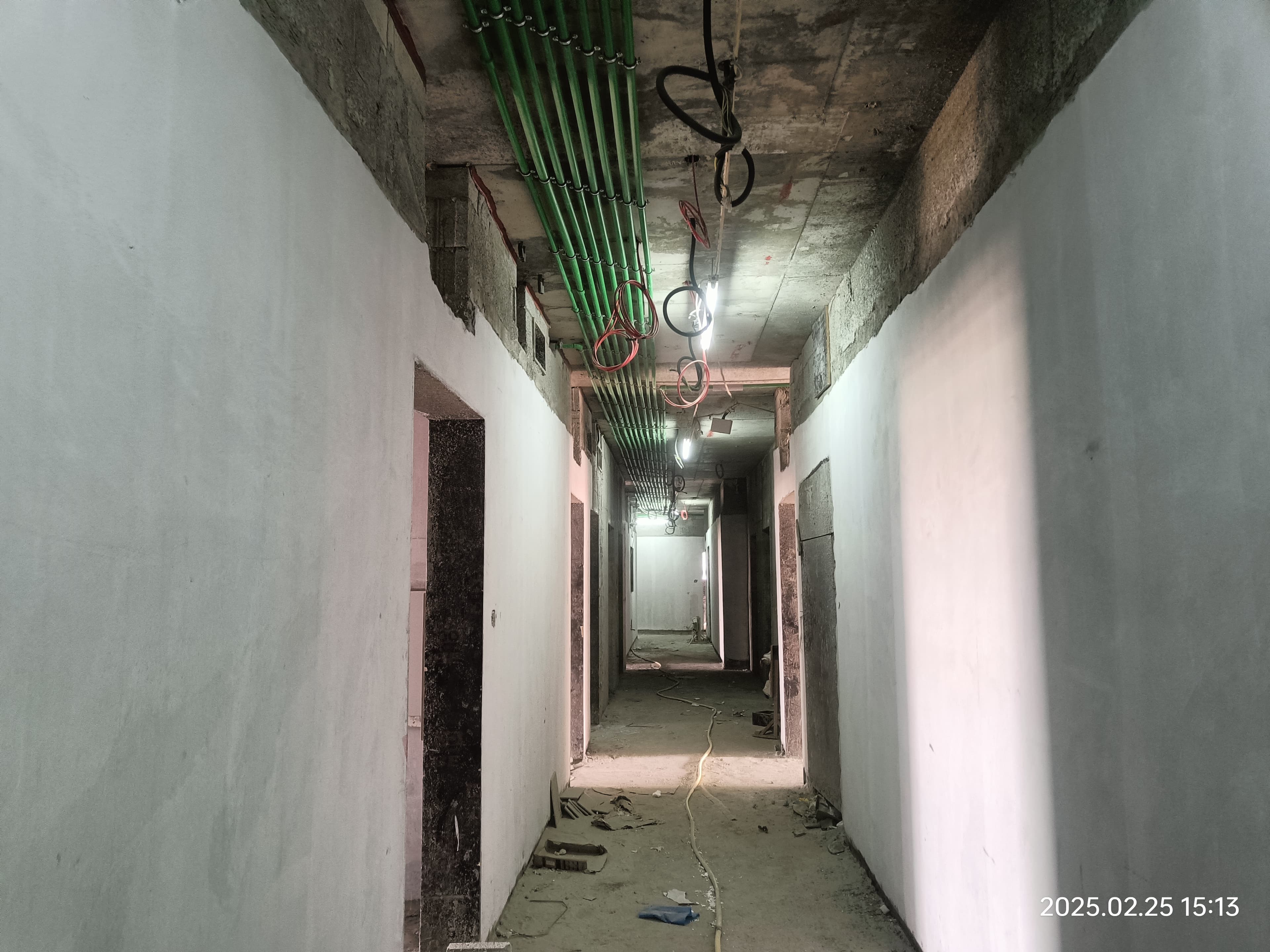

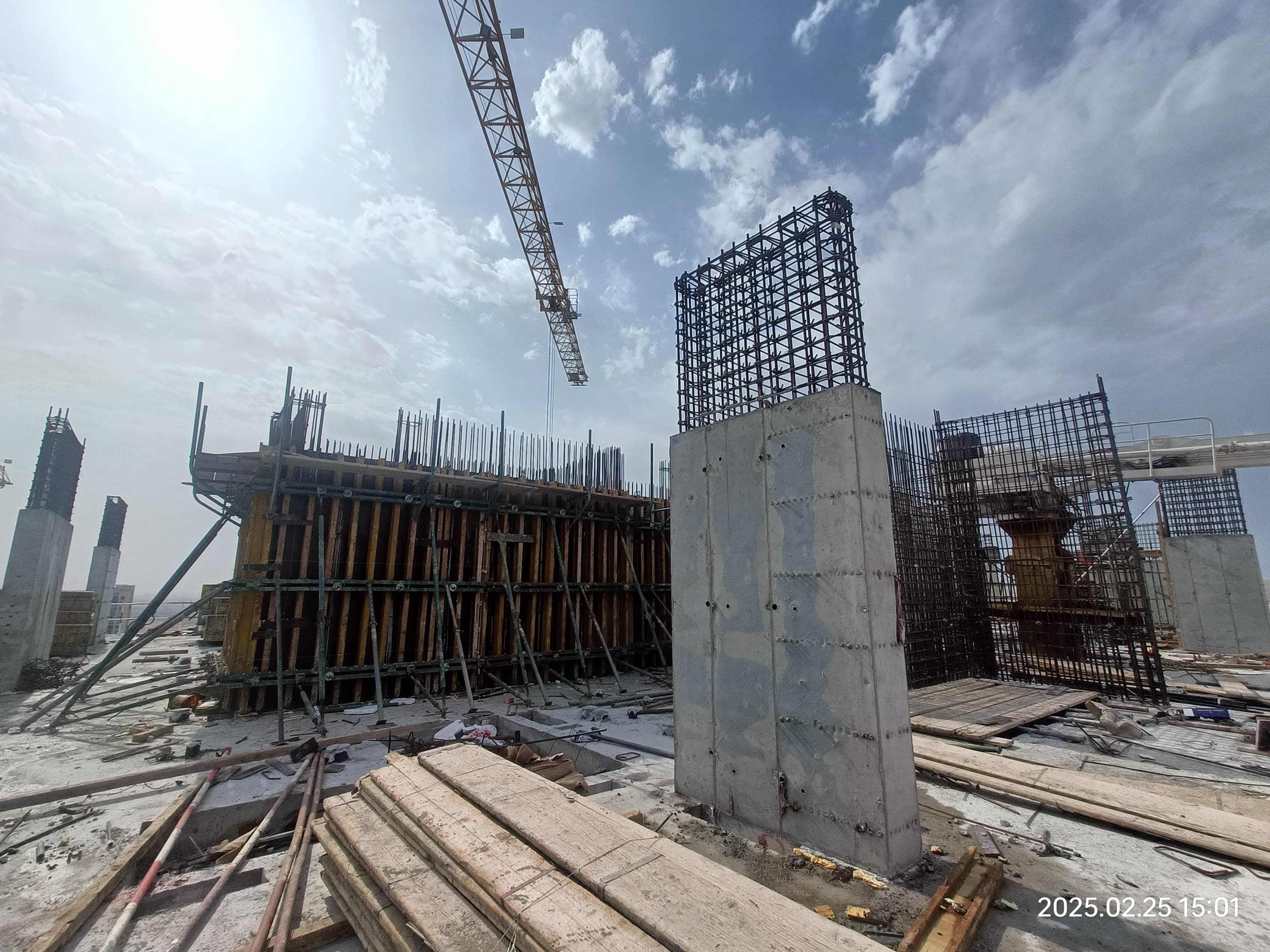

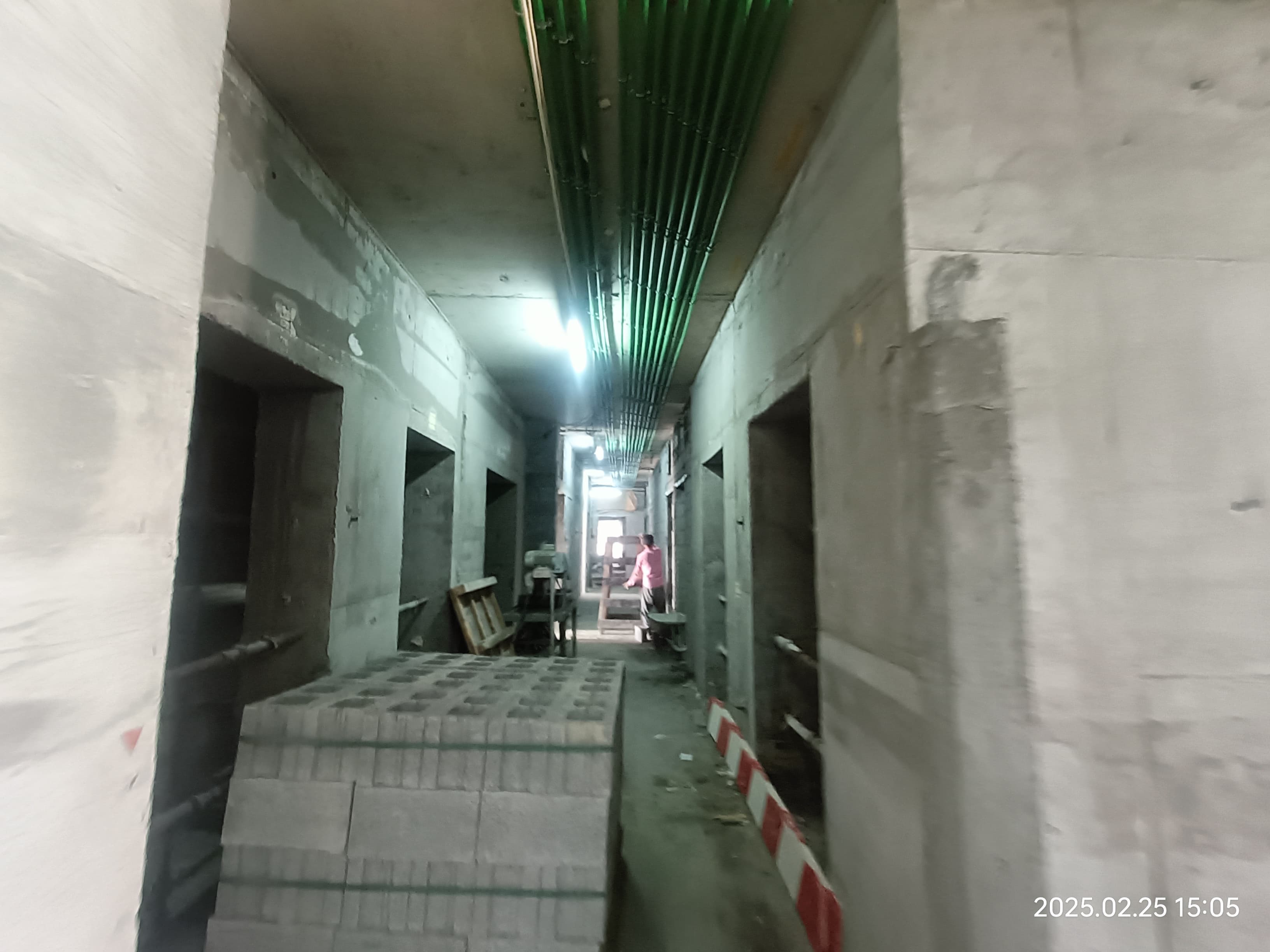

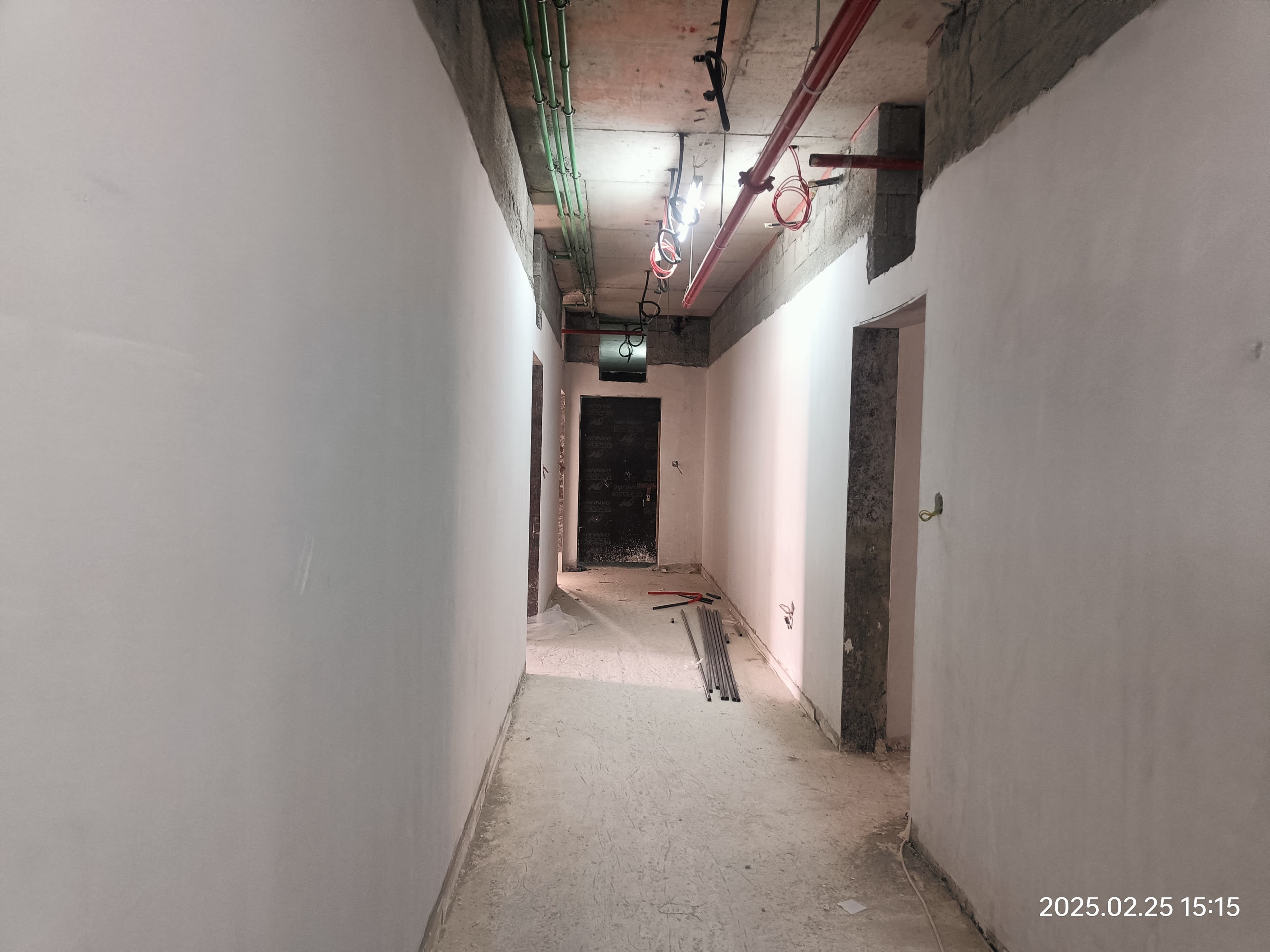

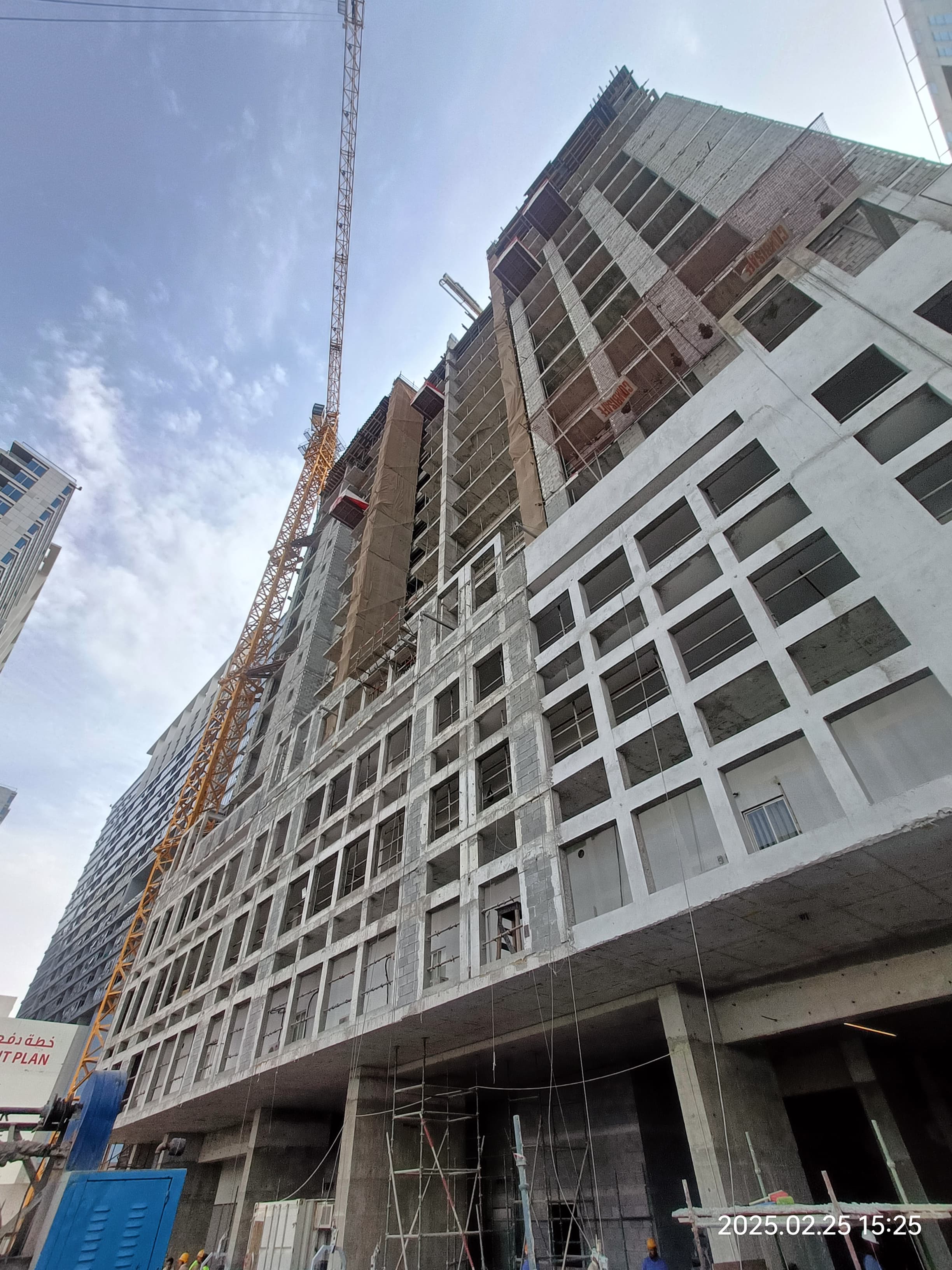

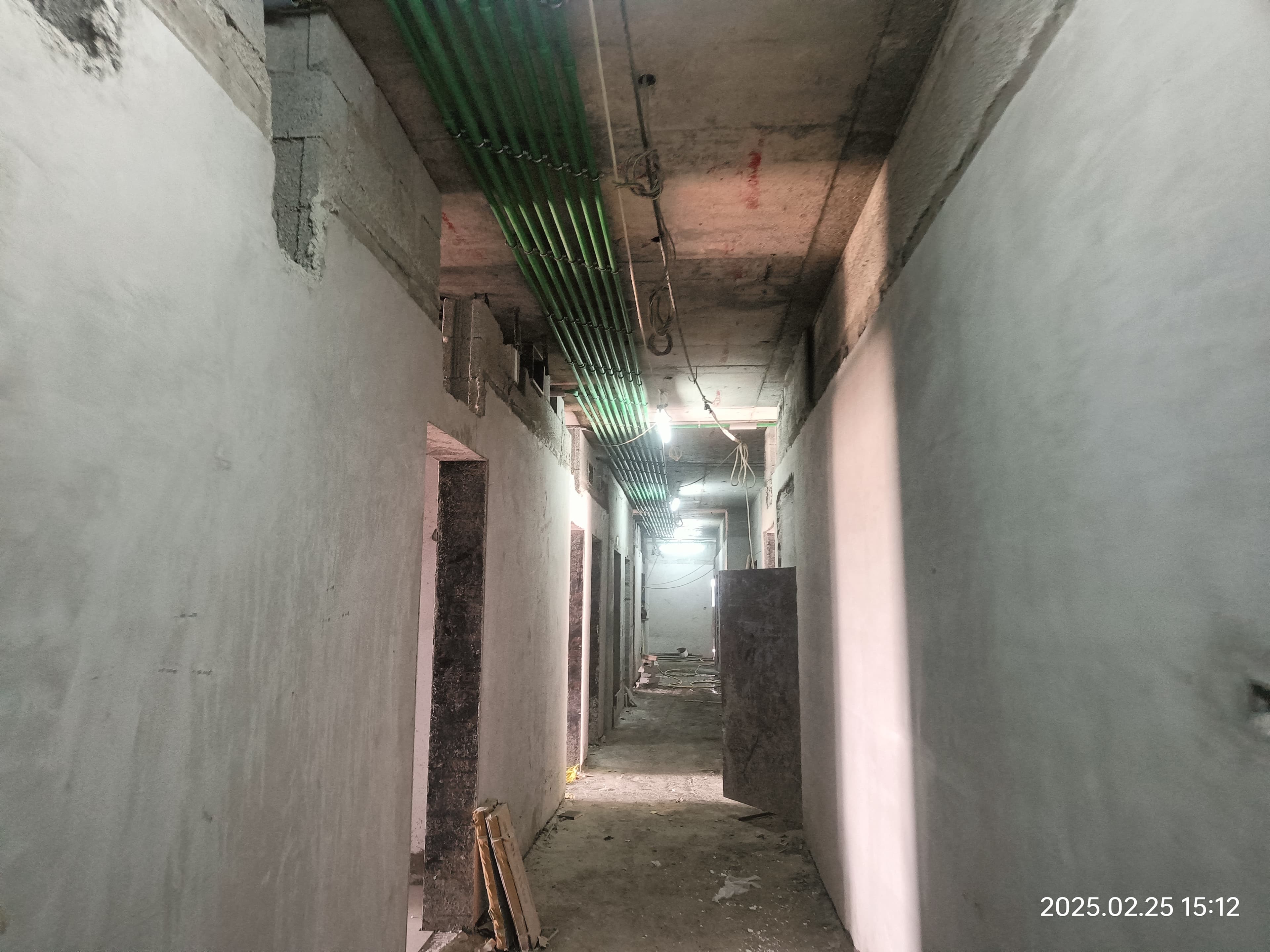

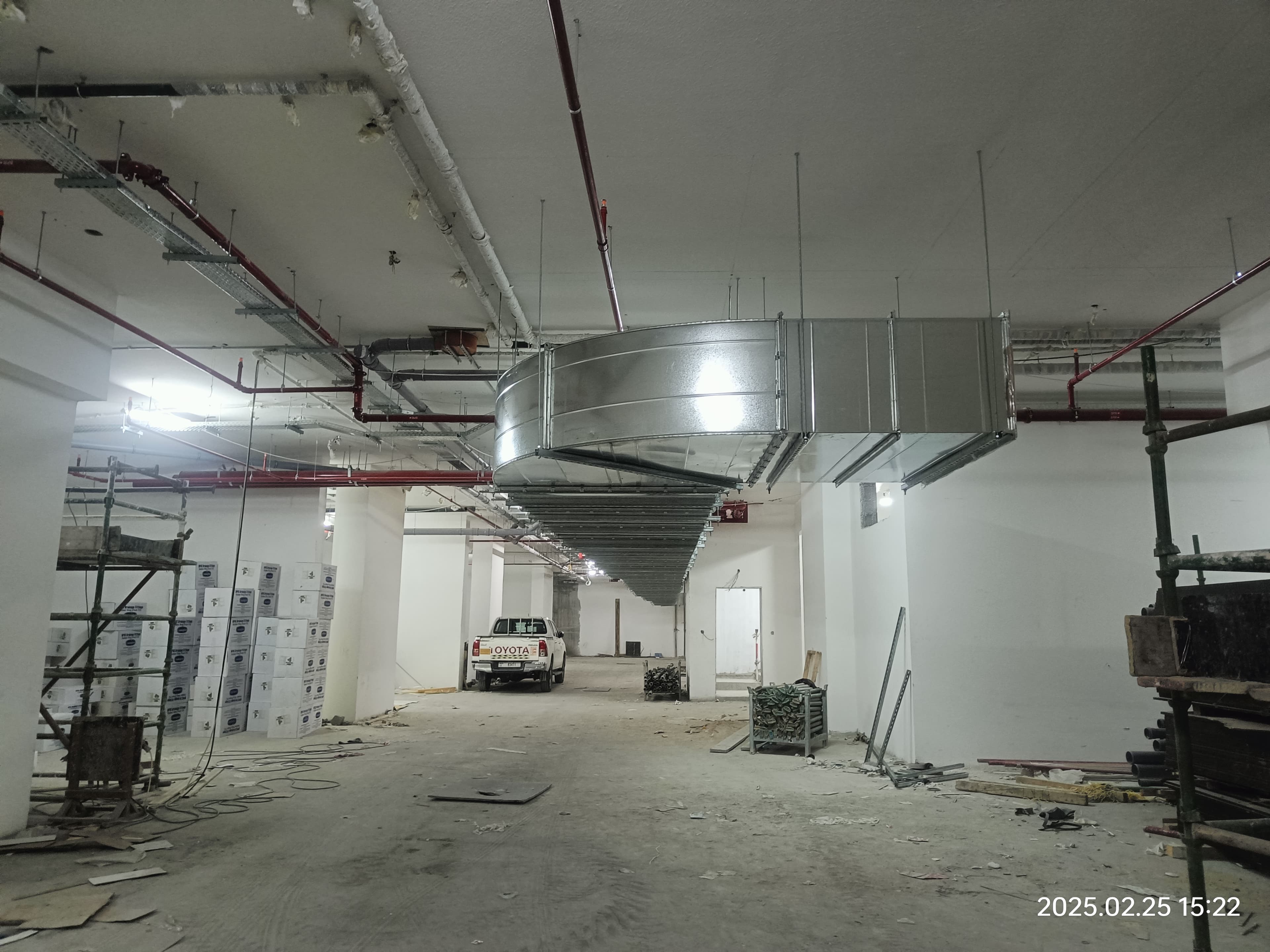

25 February 202545% built

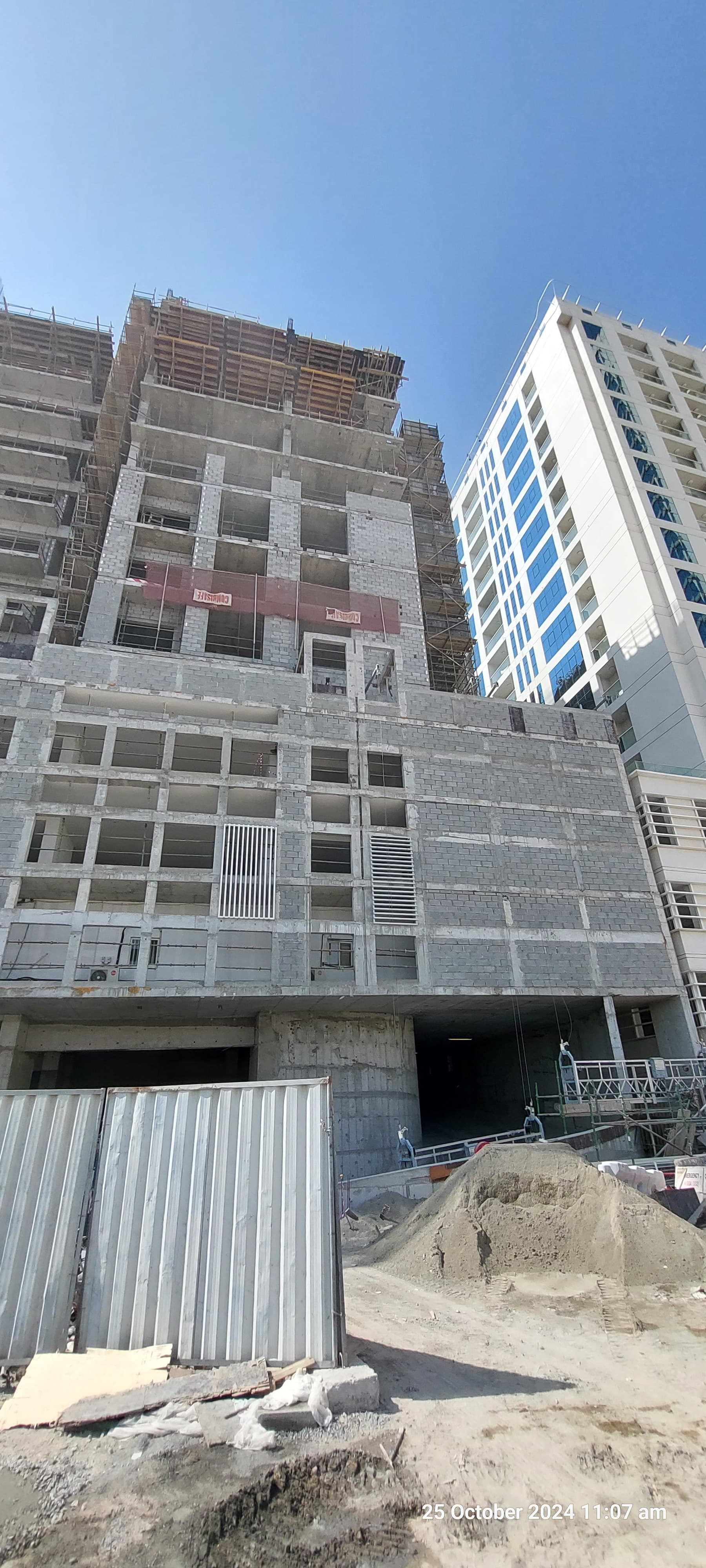

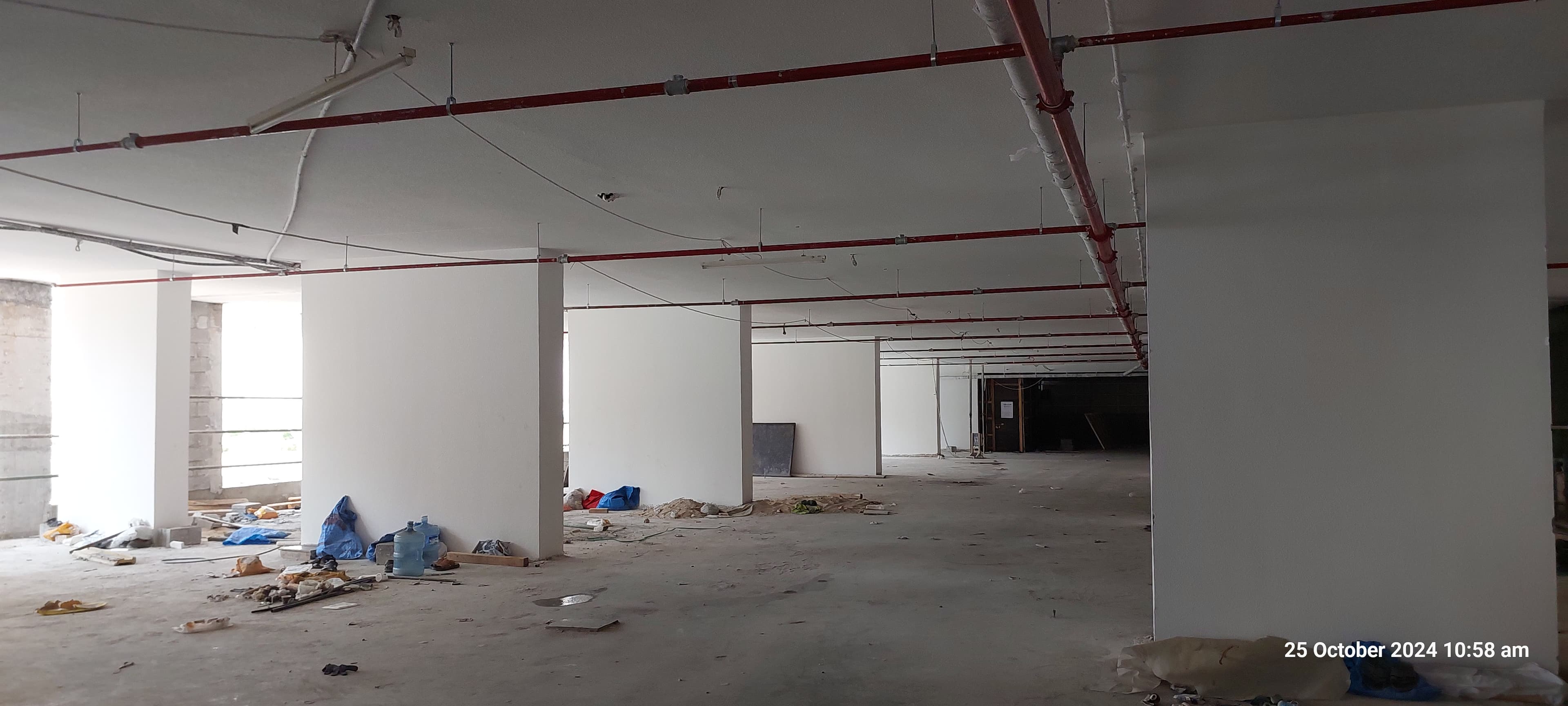

8 November 202431% built
4 June 202422% built

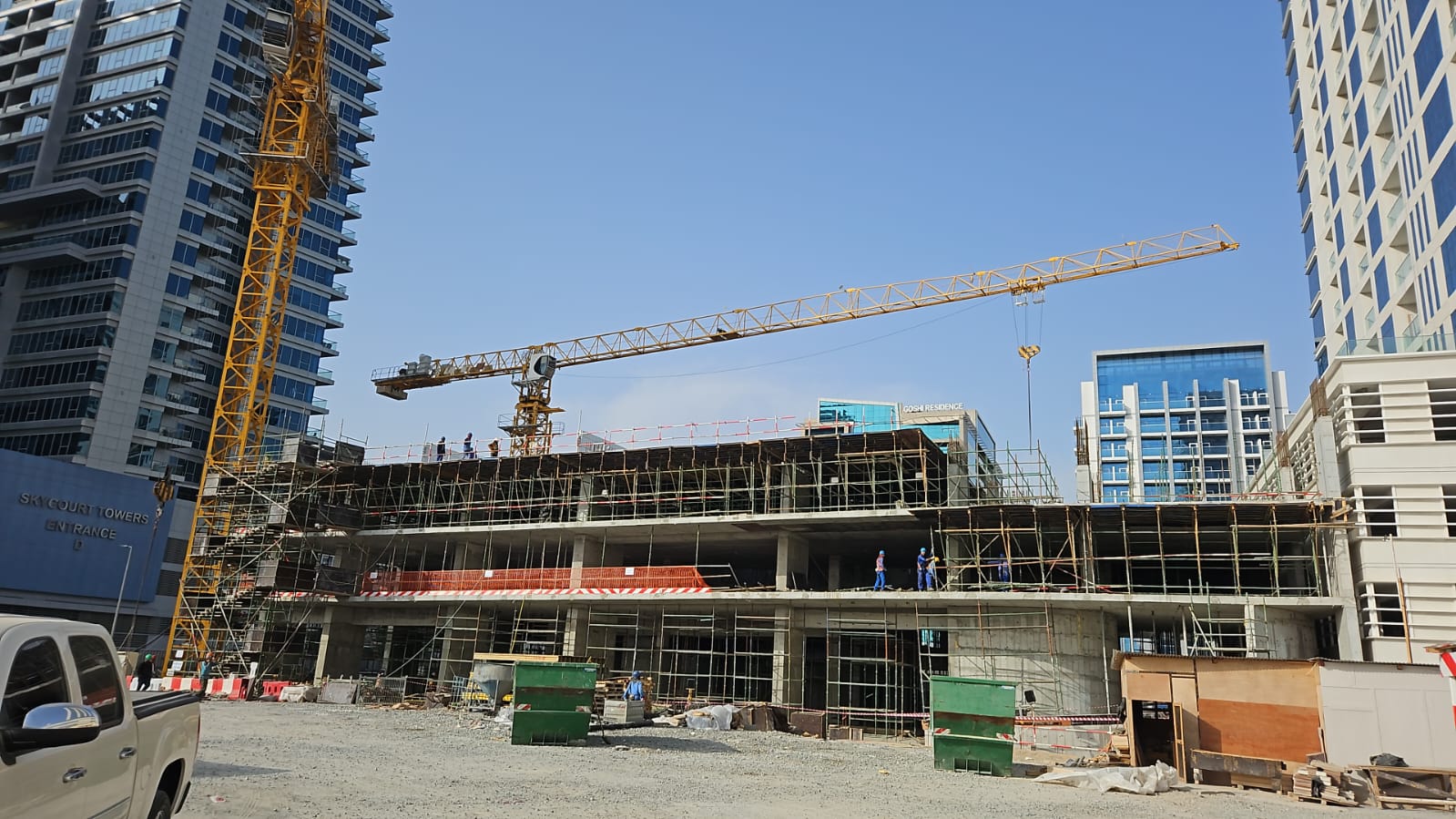

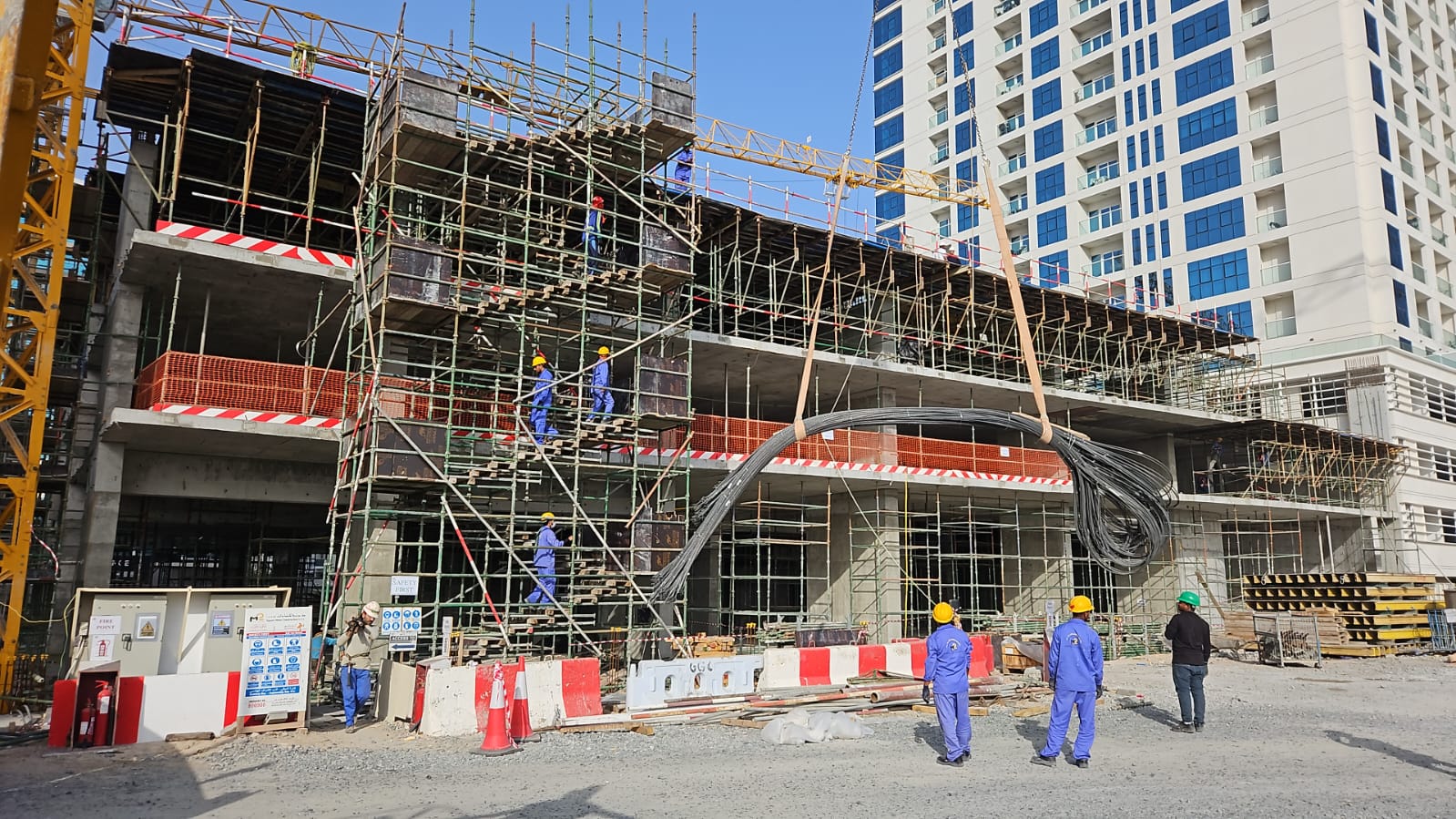

14 March 202418% built

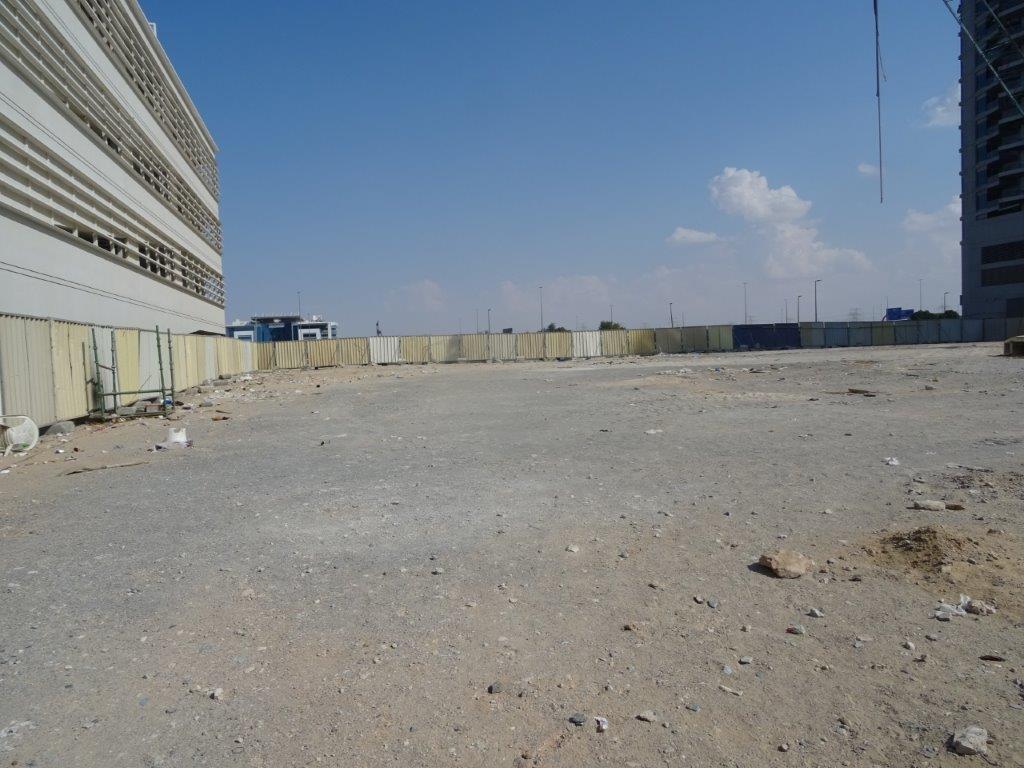

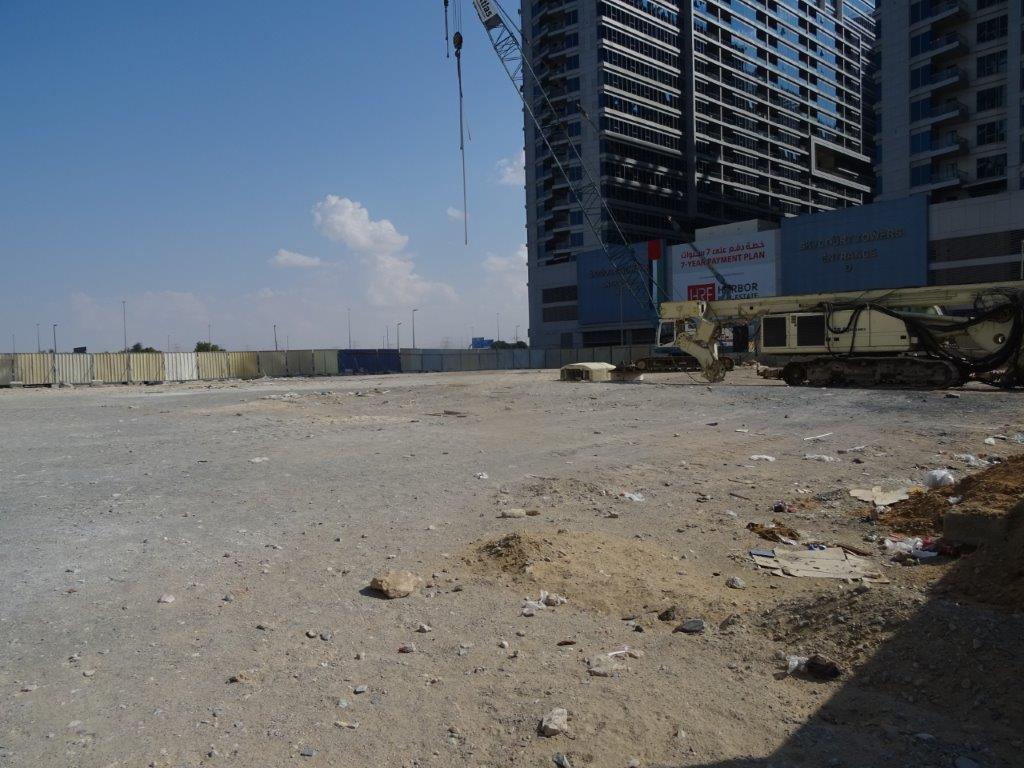

20 December 20220% built
All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
