Grand Polo - Selvara 2 construction progress
The registered completion date for Grand Polo - Selvara 2 in Dubai Investment Park Second is April 2029. At the last site inspection, in November 2026, it was 20% built. The developer is Emaar Development.
20%
Built, at the site inspection of 23 November 2026
Running behind its date
- Registered completion date
- April 2029
- Finish at recent pace
- June 2030
- Construction started
- November 2025
- First registered
- June 2025
- Developer
- Emaar Development
- Community
- Dubai Investment Park Second
- Units
- 246
- Escrow bank
- National Bank of Ras Al Khaimah
- Name in Arabic
- جراند بولو - سيلفارا 2
- Project number
- 3823
- Site inspections
- 4
Schedule
Between January 2026 and November 2026 the site added about 1.9 points a month. At that rate it would finish around June 2030, more than three months after its registered date of April 2029.
Site inspections
23 November 2026
20%+16 pts

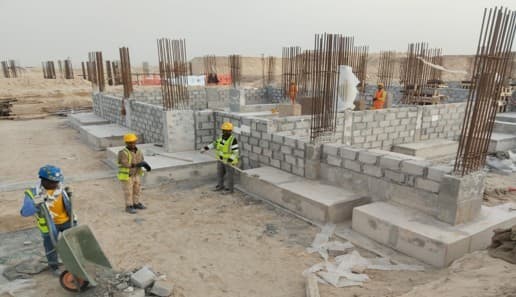

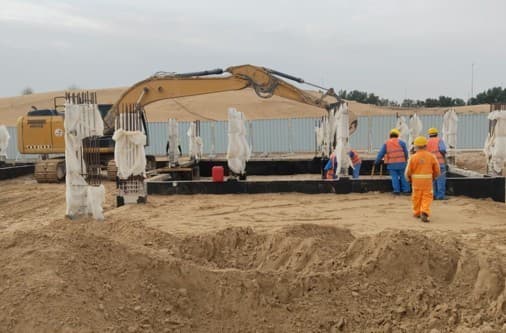

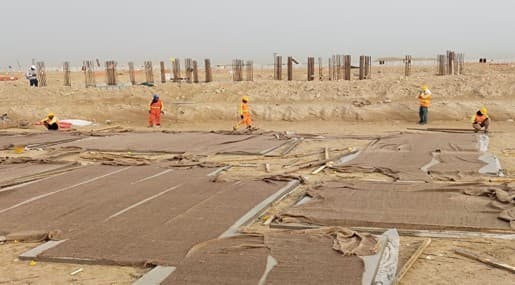

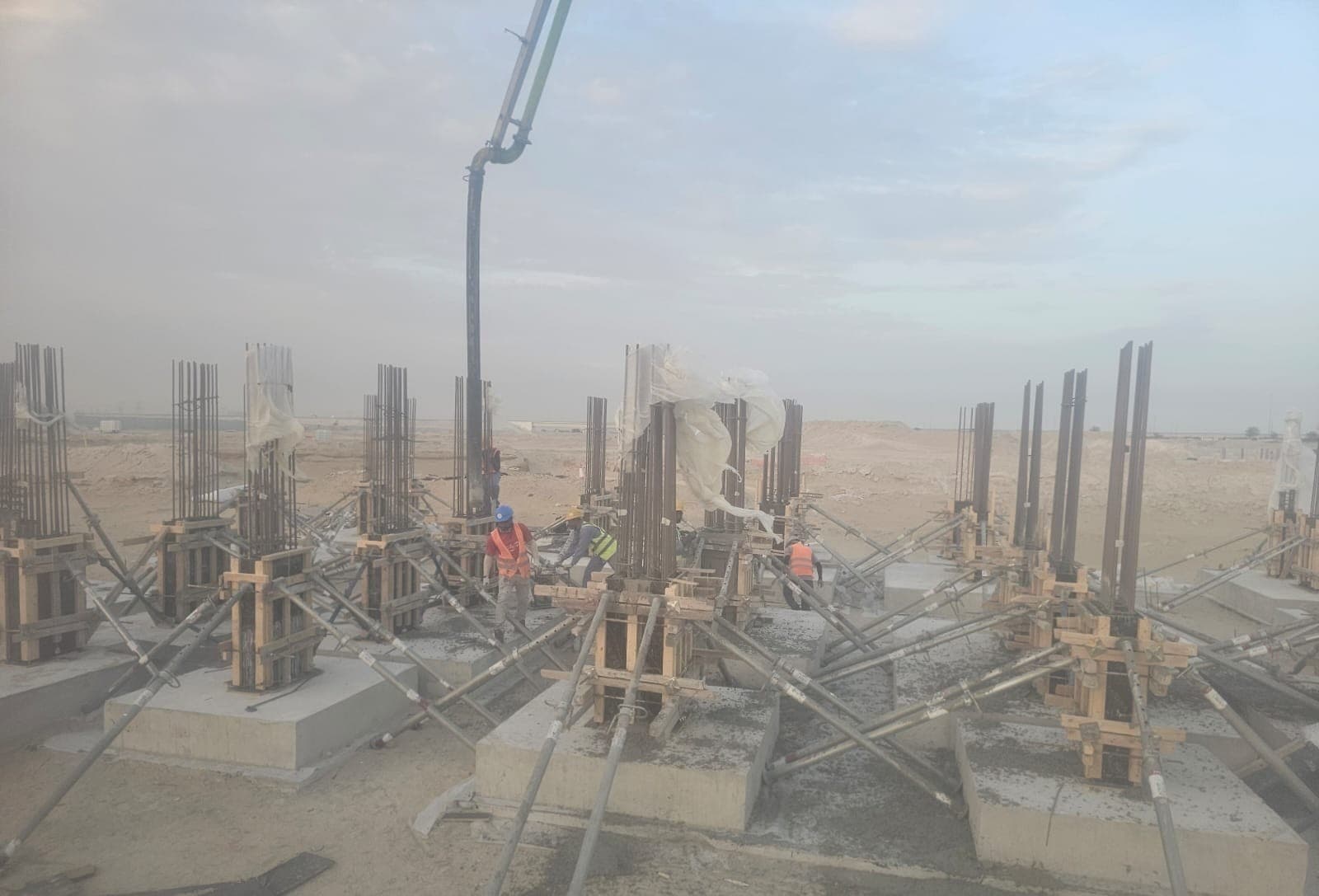

14 May 2026
4.0%+3.4 pts

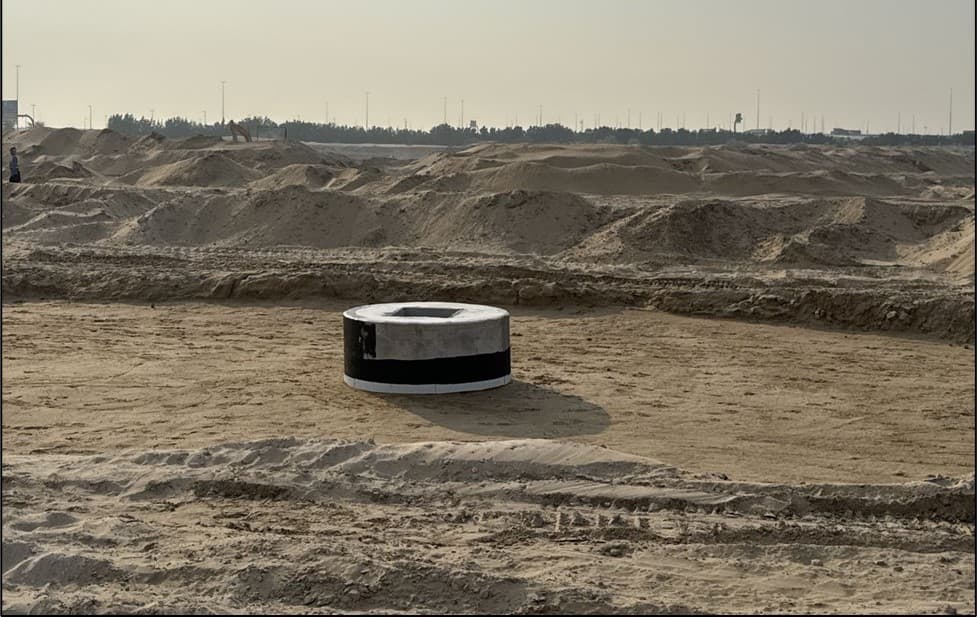

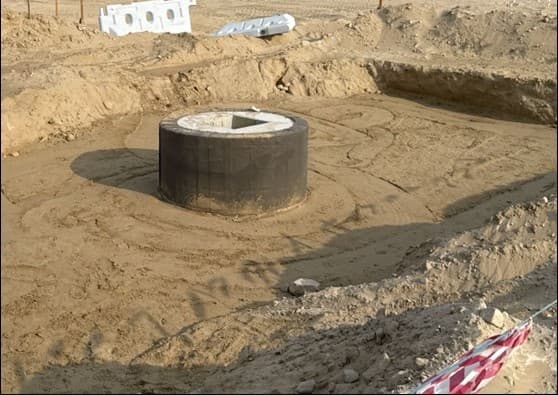

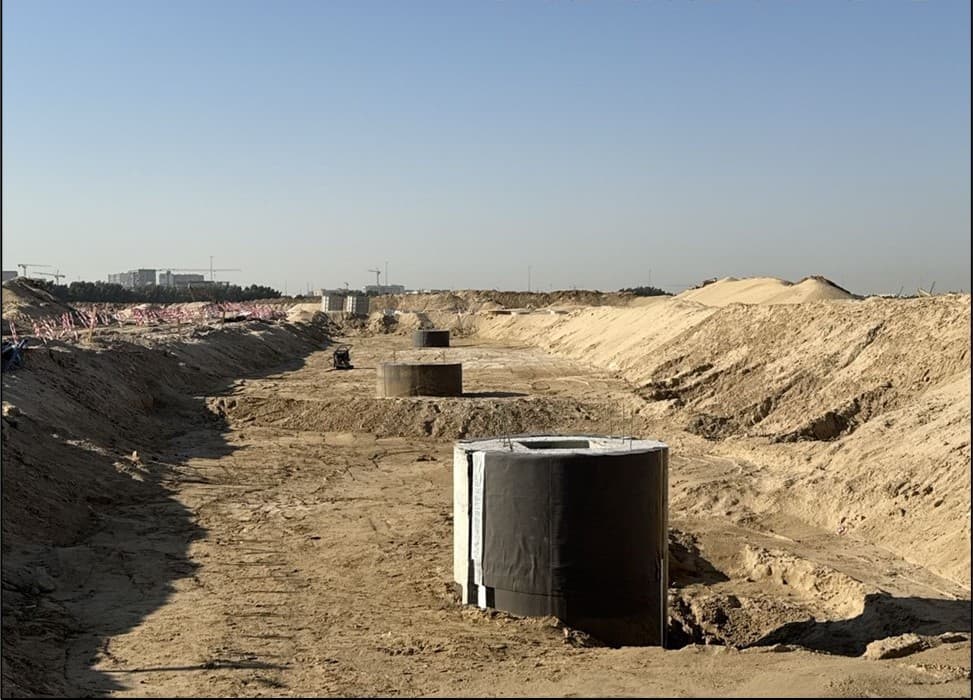

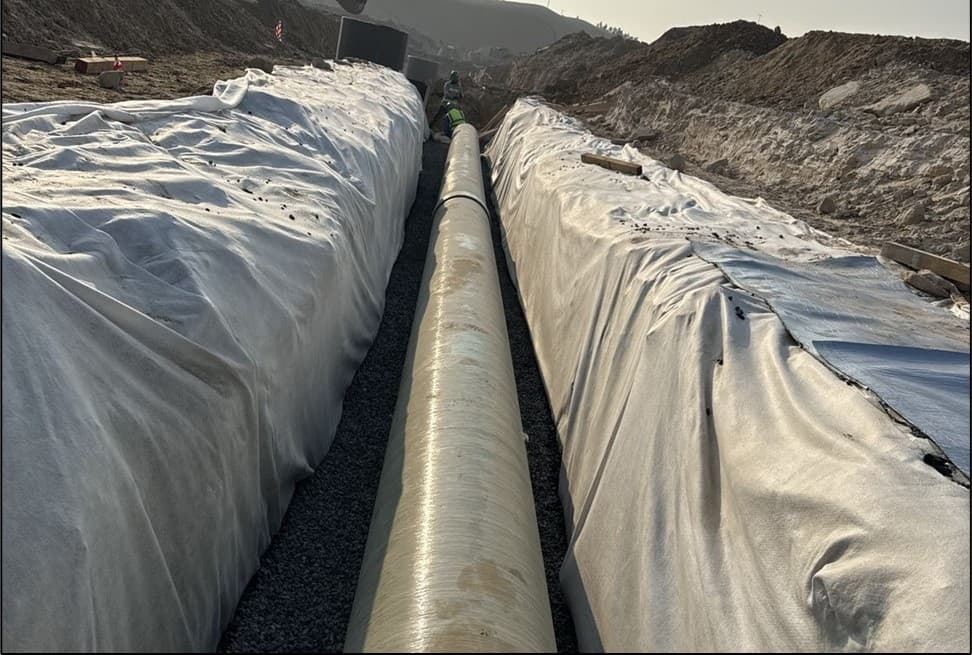

5 January 2026
0.7%+0.7 pts

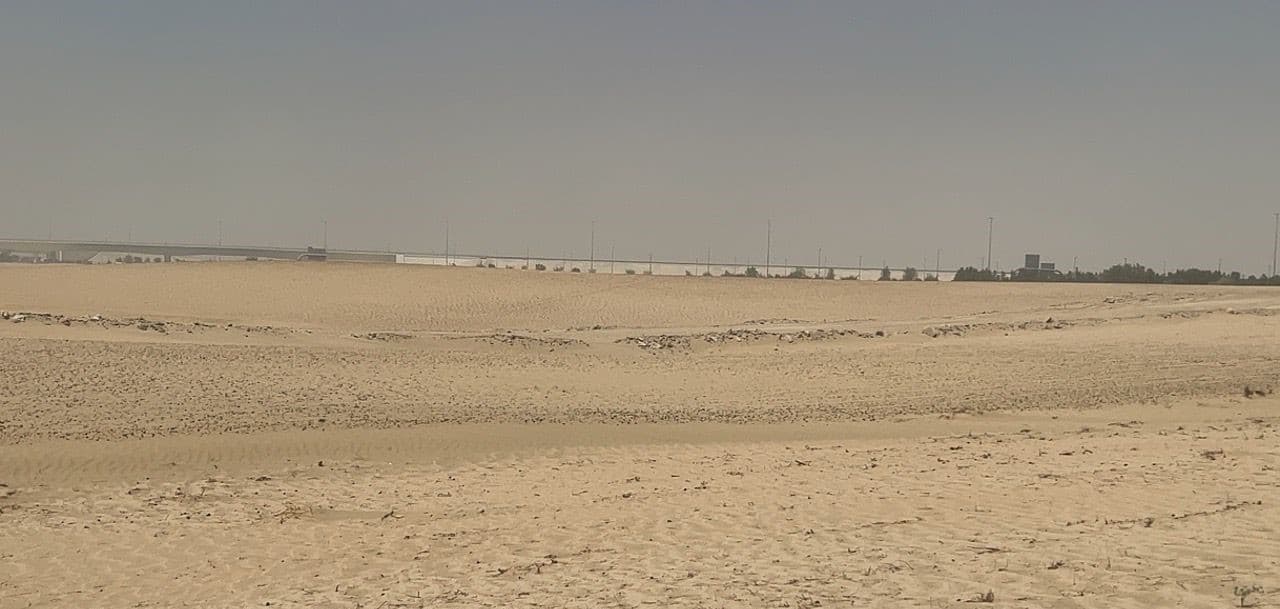

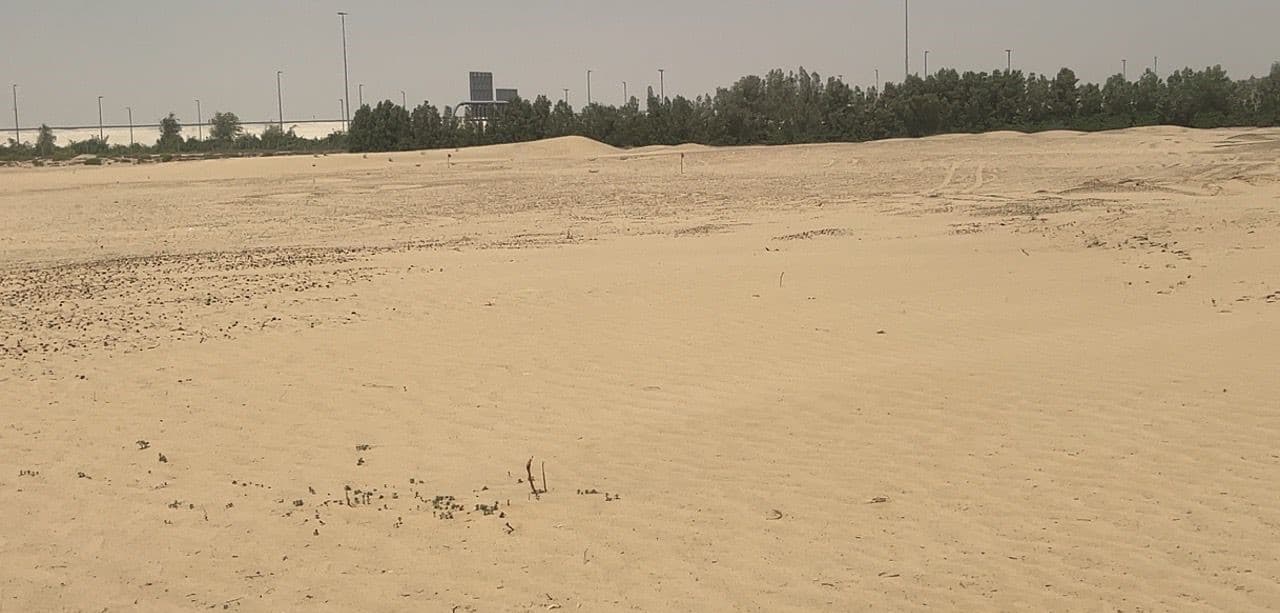

9 June 2025
0%
Context
Dubai Investment Park Second has 27 projects under construction, 12% built on average.
Emaar Development has 52 projects under construction in Dubai, none past their registered completion dates.
Own a unit in Grand Polo - Selvara 2?
Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When is the Grand Polo - Selvara 2 handover date?
- The registered completion date is April 2029. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around June 2030. RERA asks developers to update their dates as projects move, so check the register before relying on it.
- What is the latest construction update on Grand Polo - Selvara 2?
- Grand Polo - Selvara 2 was 20% built at the site inspection on 23 November 2026. The site has been inspected 4 times since June 2025. The Land Department took 20 site photos at its inspections.
- Is Grand Polo - Selvara 2 delayed?
- It is running behind. At the rate of the last year it would finish more than three months after its registered date of April 2029.
- Who is building Grand Polo - Selvara 2?
- The registered developer is Emaar Development. It has 51 other projects under construction in Dubai.
- Which bank holds the escrow account for Grand Polo - Selvara 2?
- National Bank of Ras Al Khaimah. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- The St. Regis Residences, Downtown DubaiAlso by Emaar Development. 76%, Due December 2026.
- Address The BayAlso by Emaar Development. 70%, Due December 2026.
- SeapointAlso by Emaar Development. 37%, Due March 2028.
- BayviewAlso by Emaar Development. 63%, Due July 2028.
- Damac Riverside - LushNearby in Dubai Investment Park Second. 42%, Due December 2027.
- Damac Riverside - IvyNearby in Dubai Investment Park Second. 38%, Due December 2027.
- Damac Riverside - SageNearby in Dubai Investment Park Second. 13%, Due December 2027.
- Damac Riverside Views - Marine 1Nearby in Dubai Investment Park Second. 12%, Due May 2028.
- Checking an off-plan project's progressHow to read the completion percentage and what escrow allows when a payment runs ahead.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
