Skip to content

Al Vista construction progress

The registered completion date for Al Vista in Bukadra is October 2027. At the last site inspection, in October 2026, it was 9.5% built. The developer is Dubai Investment Real Estate.

9.5%

Built, at the site inspection of 28 October 2026

Running behind its date

Registered completion date
October 2027
Finish at recent pace
March 2034
Construction started
October 2025
First registered
November 2025
Community
Bukadra
Units
381
Escrow bank
Mashreq Bank
Name in Arabic
الفيستا
Project number
3802
Site inspections
3

Schedule

Between July 2026 and October 2026 the site added about 1.0 points a month. At that rate it would finish around March 2034, more than three months after its registered date of October 2027.

0%25%50%75%100%20262027
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

28 October 2026

9.5%+4.0 pts

  • Al Vista construction site, inspection photo 1, 28 October 2026
  • Al Vista construction site, inspection photo 2, 28 October 2026
  • Al Vista construction site, inspection photo 3, 28 October 2026
  • Al Vista construction site, inspection photo 4, 28 October 2026

1 July 2026

5.5%+5.5 pts

  • Al Vista construction site, inspection photo 1, 1 July 2026
  • Al Vista construction site, inspection photo 2, 1 July 2026
  • Al Vista construction site, inspection photo 3, 1 July 2026

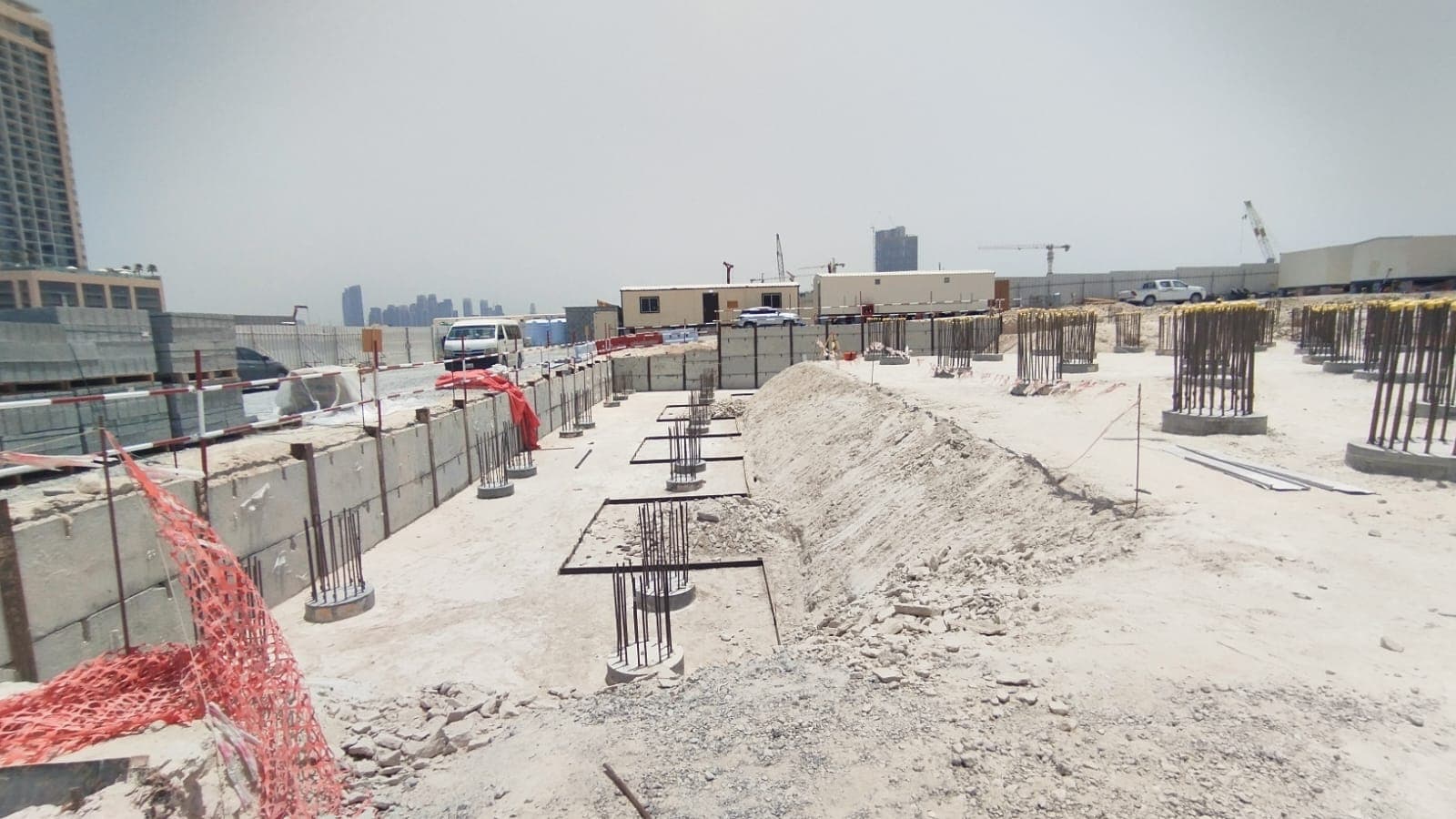

  • Al Vista construction site, inspection photo 4, 1 July 2026

10 June 2025

0%

  • Al Vista construction site, inspection photo 1, 10 June 2025
  • Al Vista construction site, inspection photo 2, 10 June 2025

All 13 site photos, by inspection date

Context

Bukadra has 21 projects under construction, 27% built on average.

Dubai Investment Real Estate has 3 projects under construction in Dubai; 1 has passed its registered completion date.

Own a unit in Al Vista?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Al Vista handover date?
The registered completion date is October 2027. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around March 2034. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Al Vista?
Al Vista was 9.5% built at the site inspection on 28 October 2026. The site has been inspected 3 times since June 2025. The Land Department took 13 site photos at its inspections.
Is Al Vista delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of October 2027.
Who is building Al Vista?
The registered developer is Dubai Investment Real Estate. It has 2 other projects under construction in Dubai.
Which bank holds the escrow account for Al Vista?
Mashreq Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
