Primero Residences By Main Realty construction progress

Primero Residences By Main Realty in Al Furjan was registered to complete in June 2026 and is still under construction. At the last site inspection, in October 2026, it was 21% built. The developer is Main Realty Real Estate.

21%

Built, at the site inspection of 1 October 2026

6 months past its registered completion date

Registered completion date
June 2026
Finish at recent pace
June 2032
Construction started
June 2024
First registered
May 2024
Developer
Main Realty Real Estate
Community
Al Furjan
Units
86
Escrow bank
United Bank Limited
Name in Arabic
بريميرو ريزيدنسيز باي مين ريالتي
Project number
3005
Site inspections
9

Schedule

Primero Residences By Main Realty was registered to complete in June 2026, 6 months ago, and is still under construction. Over the last year of inspections it has added about 1.1 points a month. Kept at that rate, the site would reach 100% around June 2032.

0%25%50%75%100%20252026
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

1 October 2026

21%+1.1 pts

  • Primero Residences By Main Realty construction site, inspection photo 1, 1 October 2026
  • Primero Residences By Main Realty construction site, inspection photo 2, 1 October 2026
  • Primero Residences By Main Realty construction site, inspection photo 3, 1 October 2026
  • Primero Residences By Main Realty construction site, inspection photo 4, 1 October 2026

11 August 2026

20%+5.3 pts

  • Primero Residences By Main Realty construction site, inspection photo 1, 11 August 2026
  • Primero Residences By Main Realty construction site, inspection photo 2, 11 August 2026
  • Primero Residences By Main Realty construction site, inspection photo 3, 11 August 2026
  • Primero Residences By Main Realty construction site, inspection photo 4, 11 August 2026

23 April 2026

15%+4.3 pts

  • Primero Residences By Main Realty construction site, inspection photo 1, 23 April 2026
  • Primero Residences By Main Realty construction site, inspection photo 2, 23 April 2026
  • Primero Residences By Main Realty construction site, inspection photo 3, 23 April 2026
  • Primero Residences By Main Realty construction site, inspection photo 4, 23 April 2026

23 December 2025

10%+2.3 pts

  • Primero Residences By Main Realty construction site, inspection photo 1, 23 December 2025
  • Primero Residences By Main Realty construction site, inspection photo 2, 23 December 2025
  • Primero Residences By Main Realty construction site, inspection photo 3, 23 December 2025
  • Primero Residences By Main Realty construction site, inspection photo 4, 23 December 2025

22 September 2025

8.2%+3.5 pts

  • Primero Residences By Main Realty construction site, inspection photo 1, 22 September 2025
  • Primero Residences By Main Realty construction site, inspection photo 2, 22 September 2025
  • Primero Residences By Main Realty construction site, inspection photo 3, 22 September 2025
  • Primero Residences By Main Realty construction site, inspection photo 4, 22 September 2025

11 June 2025

4.7%+1.8 pts

  • Primero Residences By Main Realty construction site, inspection photo 1, 11 June 2025
  • Primero Residences By Main Realty construction site, inspection photo 2, 11 June 2025
  • Primero Residences By Main Realty construction site, inspection photo 3, 11 June 2025
  • Primero Residences By Main Realty construction site, inspection photo 4, 11 June 2025

8 May 2025

2.9%+2.9 pts

  • Primero Residences By Main Realty construction site, inspection photo 1, 8 May 2025
  • Primero Residences By Main Realty construction site, inspection photo 2, 8 May 2025
  • Primero Residences By Main Realty construction site, inspection photo 3, 8 May 2025
  • Primero Residences By Main Realty construction site, inspection photo 4, 8 May 2025

13 December 2024

0.1%+0.1 pts

  • Primero Residences By Main Realty construction site, inspection photo 1, 13 December 2024
  • Primero Residences By Main Realty construction site, inspection photo 2, 13 December 2024
  • Primero Residences By Main Realty construction site, inspection photo 3, 13 December 2024
  • Primero Residences By Main Realty construction site, inspection photo 4, 13 December 2024

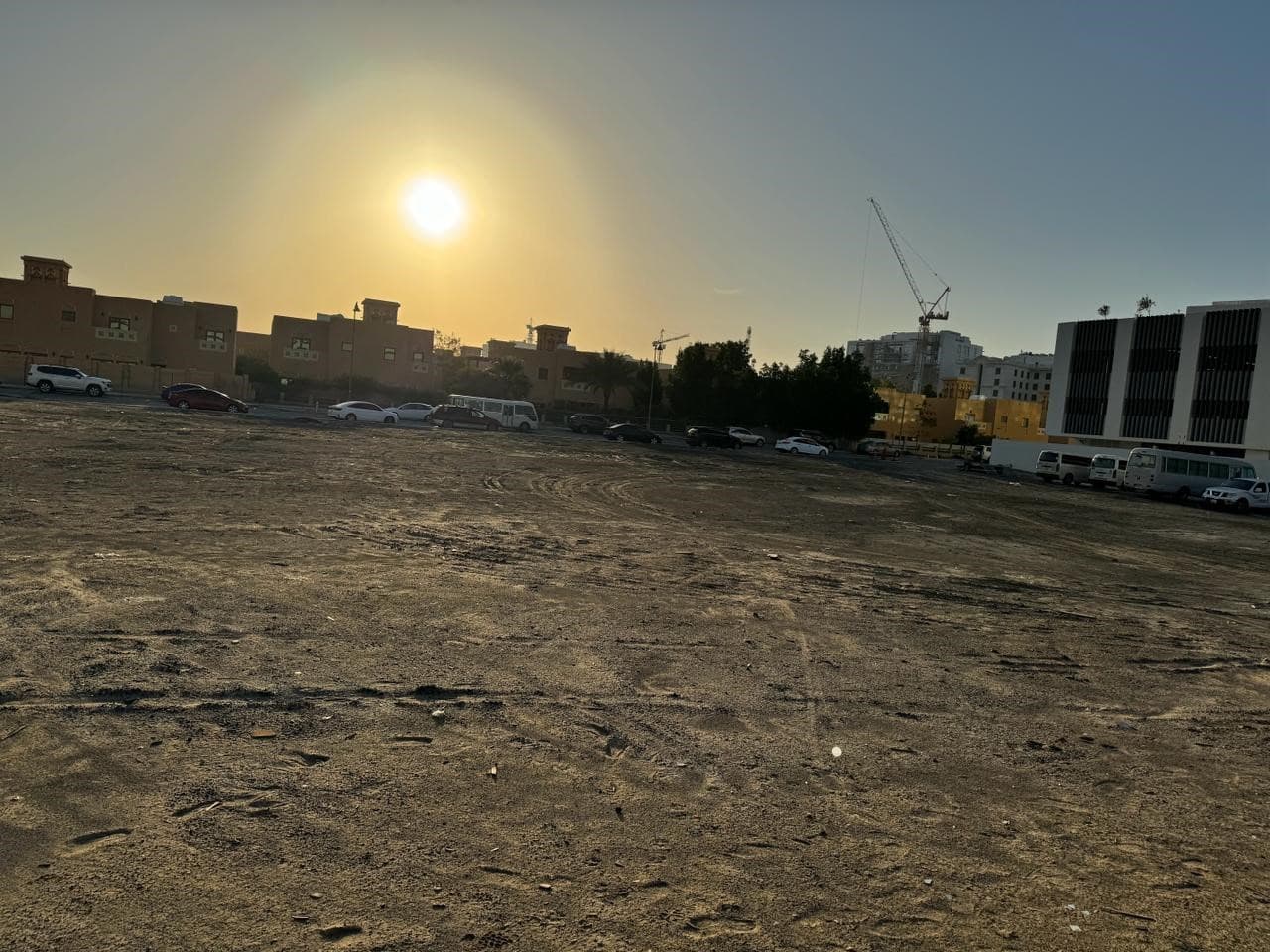

4 April 2024

0%

  • Primero Residences By Main Realty construction site, inspection photo 1, 4 April 2024
  • Primero Residences By Main Realty construction site, inspection photo 2, 4 April 2024
  • Primero Residences By Main Realty construction site, inspection photo 3, 4 April 2024

All 46 site photos, by inspection date

Context

Al Furjan has 38 projects under construction, 32% built on average.

Main Realty Real Estate has 2 projects under construction in Dubai; 1 has passed its registered completion date.

Own a unit in Primero Residences By Main Realty?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Primero Residences By Main Realty handover date?
The registered completion date was June 2026, and the register still lists Primero Residences By Main Realty as under construction. At the pace of its recent inspections the site would reach 100% around June 2032. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Primero Residences By Main Realty?
Primero Residences By Main Realty was 21% built at the site inspection on 1 October 2026. The site has been inspected 9 times since April 2024. The Land Department took 46 site photos at its inspections.
Is Primero Residences By Main Realty delayed?
Yes. Its registered completion date of June 2026 has passed and the project is still listed as under construction.
Who is building Primero Residences By Main Realty?
The registered developer is Main Realty Real Estate. It has 1 other project under construction in Dubai.
Which bank holds the escrow account for Primero Residences By Main Realty?
United Bank Limited. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
