Orvessa Residences By Michel Adam construction progress

The registered completion date for Orvessa Residences By Michel Adam in Al Furjan is September 2028. At the last site inspection, in September 2026, it was 1.5% built. The developer is Bnw Echjay Real Estate Development.

1.5%

Built, at the site inspection of 10 September 2026

Running behind its date

Registered completion date
September 2028
Finish at recent pace
January 2087
Construction started
October 2025
First registered
February 2026
Developer
Bnw Echjay Real Estate Development
Community
Al Furjan
Units
92
Escrow bank
Al Maryah Community Bank
Name in Arabic
أورفيسا ريزيدنسز من ميشيل آدم
Project number
3434
Site inspections
3

Schedule

Between October 2025 and September 2026 the site added about 0.1 points a month. At that rate it would finish around January 2087, more than three months after its registered date of September 2028.

0%25%50%75%100%2025202620272028
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

10 September 2026

1.5%+1.5 pts

  • Orvessa Residences By Michel Adam construction site, inspection photo 1, 10 September 2026
  • Orvessa Residences By Michel Adam construction site, inspection photo 2, 10 September 2026
  • Orvessa Residences By Michel Adam construction site, inspection photo 3, 10 September 2026
  • Orvessa Residences By Michel Adam construction site, inspection photo 4, 10 September 2026

16 October 2025

0%

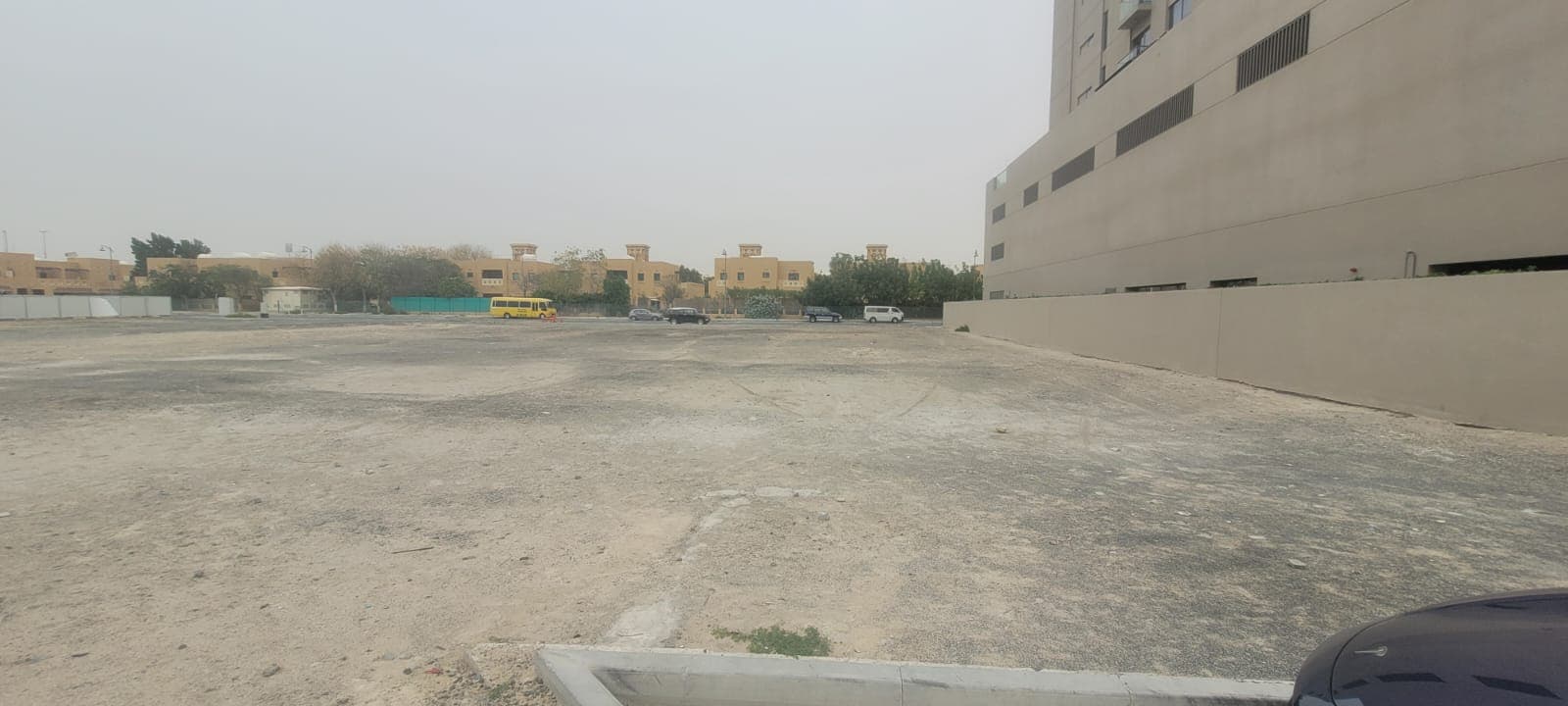

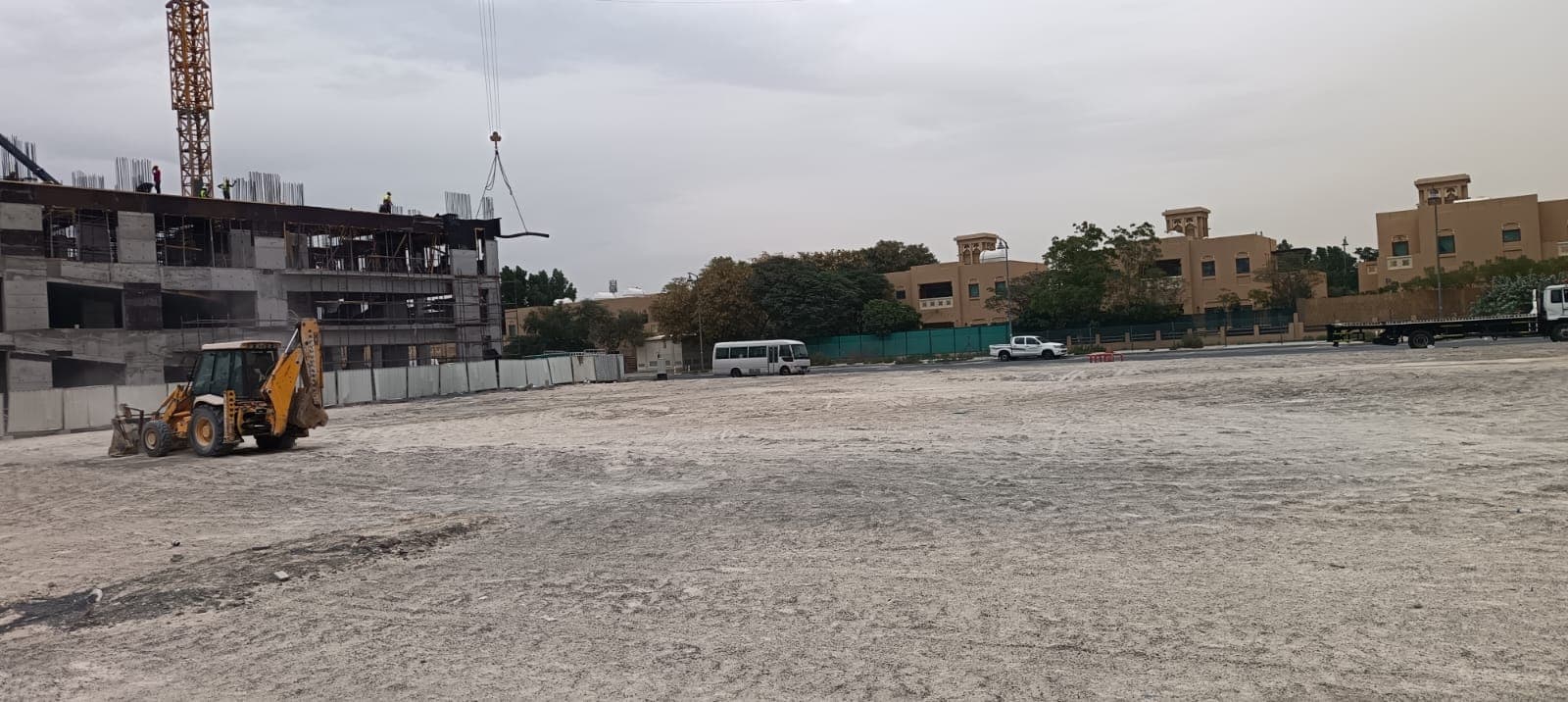

  • Orvessa Residences By Michel Adam construction site, inspection photo 1, 16 October 2025
  • Orvessa Residences By Michel Adam construction site, inspection photo 2, 16 October 2025

26 December 2024

0%

  • Orvessa Residences By Michel Adam construction site, inspection photo 1, 26 December 2024
  • Orvessa Residences By Michel Adam construction site, inspection photo 2, 26 December 2024

All 8 site photos, by inspection date

Context

Al Furjan has 38 projects under construction, 32% built on average.

Own a unit in Orvessa Residences By Michel Adam?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Orvessa Residences By Michel Adam handover date?
The registered completion date is September 2028. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around January 2087. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Orvessa Residences By Michel Adam?
Orvessa Residences By Michel Adam was 1.5% built at the site inspection on 10 September 2026. The site has been inspected 3 times since December 2024. The Land Department took 8 site photos at its inspections.
Is Orvessa Residences By Michel Adam delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of September 2028.
Who is building Orvessa Residences By Michel Adam?
The registered developer is Bnw Echjay Real Estate Development.
Which bank holds the escrow account for Orvessa Residences By Michel Adam?
Al Maryah Community Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
