Skip to content

Samana Hills South construction progress

The registered completion date for Samana Hills South in Saih Shuaib 2 is May 2028. At the last site inspection, in September 2026, it was 12% built. The developer is Samana Signature Real Estate Developments.

12%

Built, at the site inspection of 28 September 2026

Running behind its date

Registered completion date
May 2028
Finish at recent pace
March 2033
Construction started
June 2025
First registered
June 2025
Community
Saih Shuaib 2
Units
510
Escrow bank
Abu Dhabi Commercial Bank
Name in Arabic
سامانا هيلز جنوب
Project number
3796
Site inspections
5

Schedule

Between December 2025 and September 2026 the site added about 1.1 points a month. At that rate it would finish around March 2033, more than three months after its registered date of May 2028.

0%25%50%75%100%202620272028
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

28 September 2026

12%+7.3 pts

  • Samana Hills South construction site, inspection photo 1, 28 September 2026
  • Samana Hills South construction site, inspection photo 2, 28 September 2026
  • Samana Hills South construction site, inspection photo 3, 28 September 2026
  • Samana Hills South construction site, inspection photo 4, 28 September 2026

22 June 2026

4.8%+0.3 pts

  • Samana Hills South construction site, inspection photo 1, 22 June 2026
  • Samana Hills South construction site, inspection photo 2, 22 June 2026
  • Samana Hills South construction site, inspection photo 3, 22 June 2026
  • Samana Hills South construction site, inspection photo 4, 22 June 2026

17 April 2026

4.5%+3.1 pts

  • Samana Hills South construction site, inspection photo 1, 17 April 2026
  • Samana Hills South construction site, inspection photo 2, 17 April 2026
  • Samana Hills South construction site, inspection photo 3, 17 April 2026
  • Samana Hills South construction site, inspection photo 4, 17 April 2026

17 December 2025

1.5%+1.5 pts

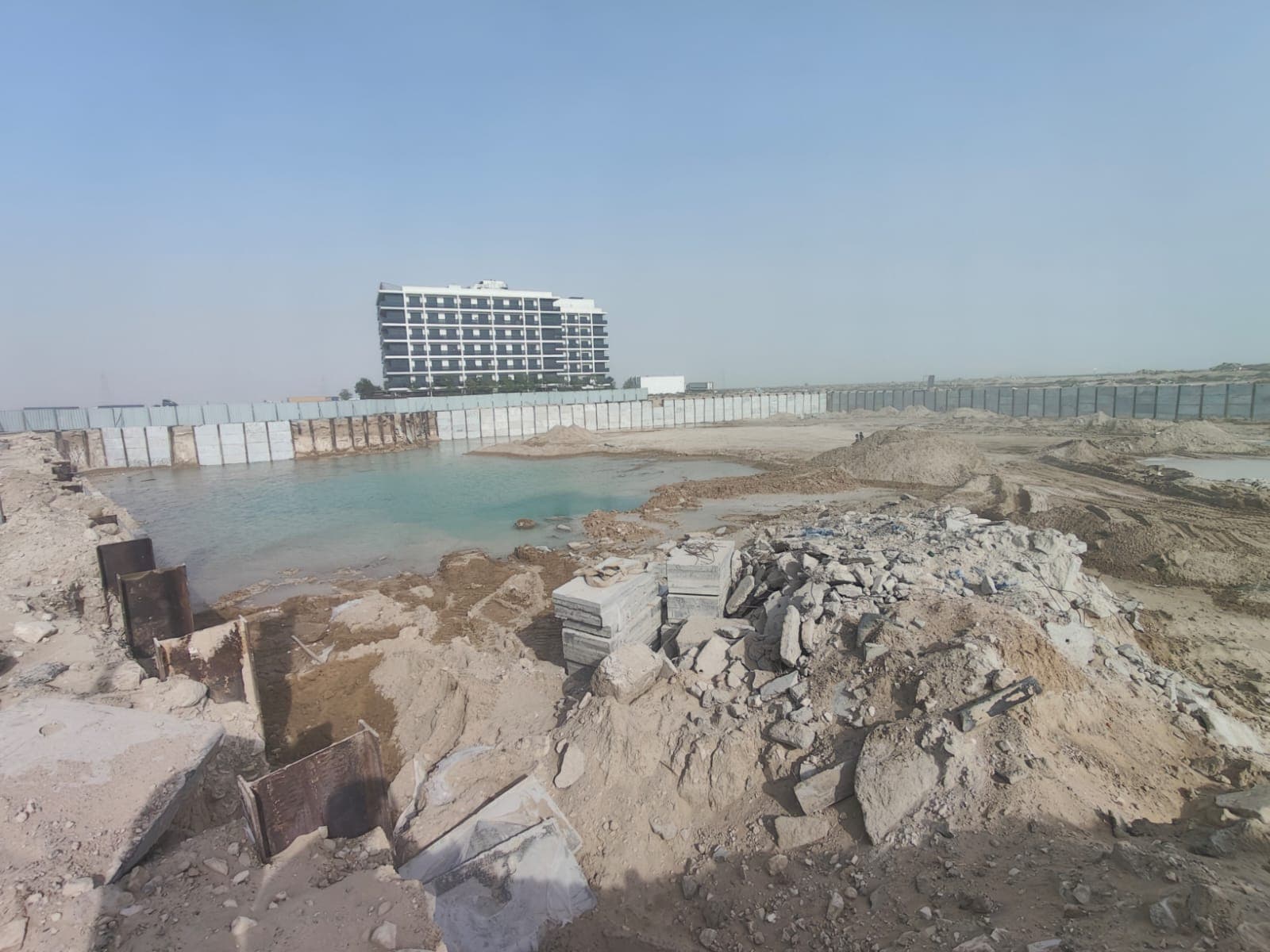

  • Samana Hills South construction site, inspection photo 1, 17 December 2025
  • Samana Hills South construction site, inspection photo 2, 17 December 2025
  • Samana Hills South construction site, inspection photo 3, 17 December 2025

1 June 2025

0%

  • Samana Hills South construction site, inspection photo 1, 1 June 2025
  • Samana Hills South construction site, inspection photo 2, 1 June 2025

All 19 site photos, by inspection date

Context

Saih Shuaib 2 has 6 projects under construction, 26% built on average.

Samana Signature Real Estate Developments has 12 projects under construction in Dubai; 1 has passed its registered completion date.

Own a unit in Samana Hills South?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Samana Hills South handover date?
The registered completion date is May 2028. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around March 2033. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Samana Hills South?
Samana Hills South was 12% built at the site inspection on 28 September 2026. The site has been inspected 5 times since June 2025. The Land Department took 19 site photos at its inspections.
Is Samana Hills South delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of May 2028.
Who is building Samana Hills South?
The registered developer is Samana Signature Real Estate Developments. It has 11 other projects under construction in Dubai.
Which bank holds the escrow account for Samana Hills South?
Abu Dhabi Commercial Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
