Lucky Royale Residence construction progress
Lucky Royale Residence in Jumeirah Village Circle is 98% built at the Land Department inspection of September 2026. Developer Lucky Aeon Real Estate Development. Completion registered for December 2025.
98%
Built, at the Land Department site inspection of 4 September 2026
9 months past its registered completion date
- Completion date (Land Department)
- December 2025
- Finish at recent pace
- November 2026
- Construction started
- September 2023
- Registered with the Land Department
- July 2023
- Developer
- Lucky Aeon Real Estate Development
- Community
- Jumeirah Village Circle
- Units
- 147
- Escrow bank
- Abu Dhabi Commercial Bank
- Name in Arabic
- لكي رويال ريزيدنس
- Land Department project number
- 2655
- Land Department site inspections
- 8
Schedule
Lucky Royale Residence was registered to complete in December 2025, 9 months ago, and is still under construction. Over the last year of inspections it has added about 0.9 points a month. Kept at that rate, the site would reach 100% around November 2026.
Site inspections

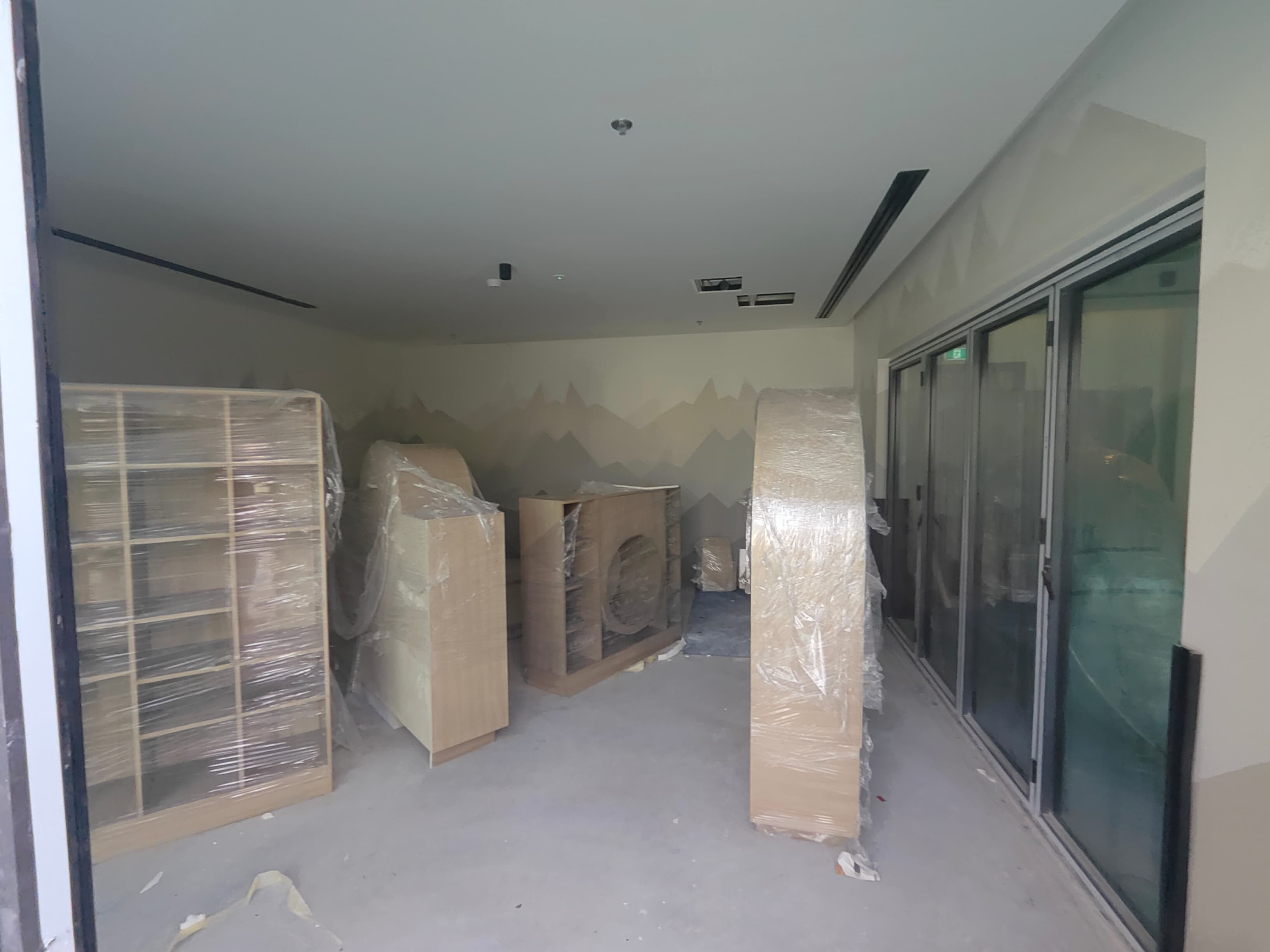

4 September 2026
98%+1.0 pts
6 April 2026
97%+8.6 pts
22 October 2025
88%+29 pts

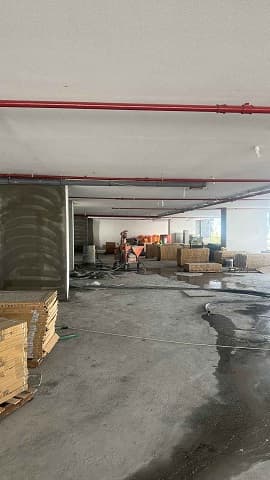

9 June 2025
59%+6.1 pts
5 February 2025
53%+25 pts
19 September 2024
28%+15 pts
6 May 2024
13%+13 pts
22 May 2023
0%
Context
Jumeirah Village Circle has 119 projects under construction, 40% built on average.
Lucky Aeon Real Estate Development has 2 projects under construction in Dubai; 2 have passed their registered completion date.
Own a unit in Lucky Royale Residence?
Mulki follows this project for you: each new Land Department inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When will Lucky Royale Residence be completed?
- The completion date registered with the Dubai Land Department is December 2025. At the pace of its recent inspections the site would reach 100% around November 2026. Developers can apply to the Land Department to extend the date, so check the register before relying on it.
- How much of Lucky Royale Residence is built?
- 98%, measured at the Land Department site inspection on 4 September 2026. The Land Department engineers have inspected the site 8 times since May 2023.
- Is Lucky Royale Residence delayed?
- Yes. Its registered completion date of December 2025 has passed and the Land Department still lists it as under construction.
- Who is building Lucky Royale Residence?
- The registered developer is Lucky Aeon Real Estate Development. It has 1 other project under construction in Dubai.
- Which bank holds the escrow account for Lucky Royale Residence?
- Abu Dhabi Commercial Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- Lucky Oasis ResidenceAlso by Lucky Aeon Real Estate Development. 20%, Due June 2026, passed.
- German Supreme Tower 2Nearby in Jumeirah Village Circle. 42%, Due January 2013, passed.
- Serenity Lakes 2Nearby in Jumeirah Village Circle. 50%, Due November 2025, passed.
- Dusit Princess RijasNearby in Jumeirah Village Circle. 64%, Due April 2027.
- Samana WavesNearby in Jumeirah Village Circle. 90%, Due April 2026, passed.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of Land Department inspections, not a forecast from the developer. Site photos belong to the Dubai Land Department. See how Mulki works with Land Department data.











.jpeg&w=3840&q=75)
