Binghatti Etherea construction progress
The registered completion date for Binghatti Etherea is December 2027. At the last site inspection, in September 2026, it was 7.2% built. The developer is Binghatti Developers.
7.2%
Built, at the site inspection of 15 September 2026
Running behind its date
- Registered completion date
- December 2027
- Finish at recent pace
- March 2036
- Construction started
- January 2026
- First registered
- January 2026
- Developer
- Binghatti Developers
- Units
- 287
- Escrow bank
- Mashreq Bank
- Name in Arabic
- بن غاطي إيثيريا
- Project number
- 4303
- Site inspections
- 2
Schedule
Between December 2025 and September 2026 the site added about 0.8 points a month. At that rate it would finish around March 2036, more than three months after its registered date of December 2027.
Site inspections
15 September 2026
7.2%+7.2 pts

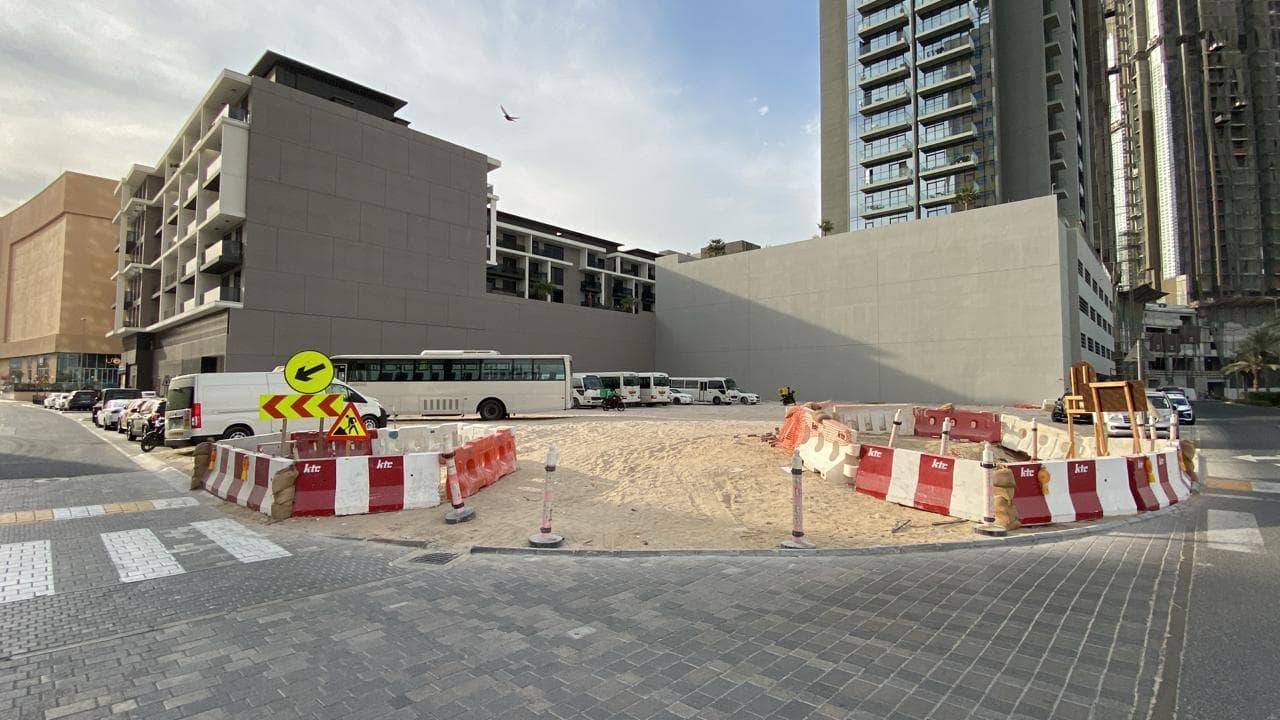

17 December 2025
0%
Context
Binghatti Developers has 38 projects under construction in Dubai; 14 have passed their registered completion date.
Own a unit in Binghatti Etherea?
Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When is the Binghatti Etherea handover date?
- The registered completion date is December 2027. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around March 2036. RERA asks developers to update their dates as projects move, so check the register before relying on it.
- What is the latest construction update on Binghatti Etherea?
- Binghatti Etherea was 7.2% built at the site inspection on 15 September 2026. The site has been inspected 2 times since December 2025. The Land Department took 7 site photos at its inspections.
- Is Binghatti Etherea delayed?
- It is running behind. At the rate of the last year it would finish more than three months after its registered date of December 2027.
- Who is building Binghatti Etherea?
- The registered developer is Binghatti Developers. It has 37 other projects under construction in Dubai.
- Which bank holds the escrow account for Binghatti Etherea?
- Mashreq Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- Burj Binghatti Jacob & Co. ResidencesAlso by Binghatti Developers. 52%, Due June 2026, passed.
- Mercedes-Benz Places | BinghattiAlso by Binghatti Developers. 65%, Due December 2026.
- Bugatti Residences By BinghattiAlso by Binghatti Developers. 66%, Due December 2025, passed.
- Binghatti HillsAlso by Binghatti Developers. 90%.
- Checking an off-plan project's progressHow to read the completion percentage and what escrow allows when a payment runs ahead.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.





.jpeg&w=3840&q=75)
