Rove Home Dubai Marina construction progress

The registered completion date for Rove Home Dubai Marina in Dubai Marina is March 2028. At the last site inspection, in July 2026, it was 7.8% built. The developer is Irth Elite Development.

7.8%

Built, at the site inspection of 6 July 2026

Running behind its date

Registered completion date
March 2028
Finish at recent pace
February 2044
Construction started
December 2024
First registered
November 2024
Developer
Irth Elite Development
Community
Dubai Marina
Units
682
Escrow bank
Commercial Bank of Dubai
Name in Arabic
روف منازل دبي مارينا
Project number
3393
Site inspections
6

Schedule

Between July 2025 and July 2026 the site added about 0.4 points a month. At that rate it would finish around February 2044, more than three months after its registered date of March 2028.

0%25%50%75%100%2025202620272028
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

6 July 2026

7.8%+0.3 pts

  • Rove Home Dubai Marina construction site, inspection photo 1, 6 July 2026
  • Rove Home Dubai Marina construction site, inspection photo 2, 6 July 2026
  • Rove Home Dubai Marina construction site, inspection photo 3, 6 July 2026
  • Rove Home Dubai Marina construction site, inspection photo 4, 6 July 2026

23 March 2026

7.5%+0.3 pts

  • Rove Home Dubai Marina construction site, inspection photo 1, 23 March 2026
  • Rove Home Dubai Marina construction site, inspection photo 2, 23 March 2026
  • Rove Home Dubai Marina construction site, inspection photo 3, 23 March 2026
  • Rove Home Dubai Marina construction site, inspection photo 4, 23 March 2026

3 December 2025

7.1%+4.2 pts

  • Rove Home Dubai Marina construction site, inspection photo 1, 3 December 2025
  • Rove Home Dubai Marina construction site, inspection photo 2, 3 December 2025
  • Rove Home Dubai Marina construction site, inspection photo 3, 3 December 2025

30 July 2025

2.9%+2.8 pts

  • Rove Home Dubai Marina construction site, inspection photo 1, 30 July 2025
  • Rove Home Dubai Marina construction site, inspection photo 2, 30 July 2025
  • Rove Home Dubai Marina construction site, inspection photo 3, 30 July 2025
  • Rove Home Dubai Marina construction site, inspection photo 4, 30 July 2025

20 April 2025

0.1%+0.1 pts

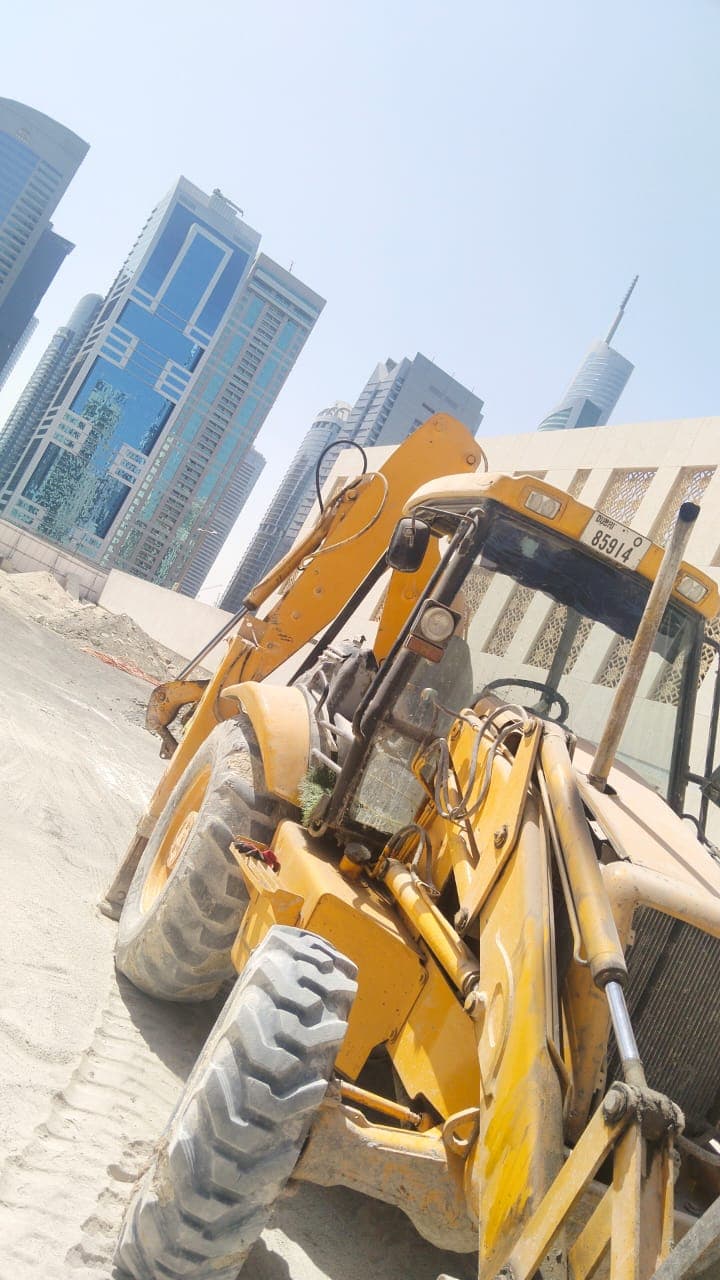

  • Rove Home Dubai Marina construction site, inspection photo 1, 20 April 2025
  • Rove Home Dubai Marina construction site, inspection photo 2, 20 April 2025
  • Rove Home Dubai Marina construction site, inspection photo 3, 20 April 2025

8 November 2024

0%

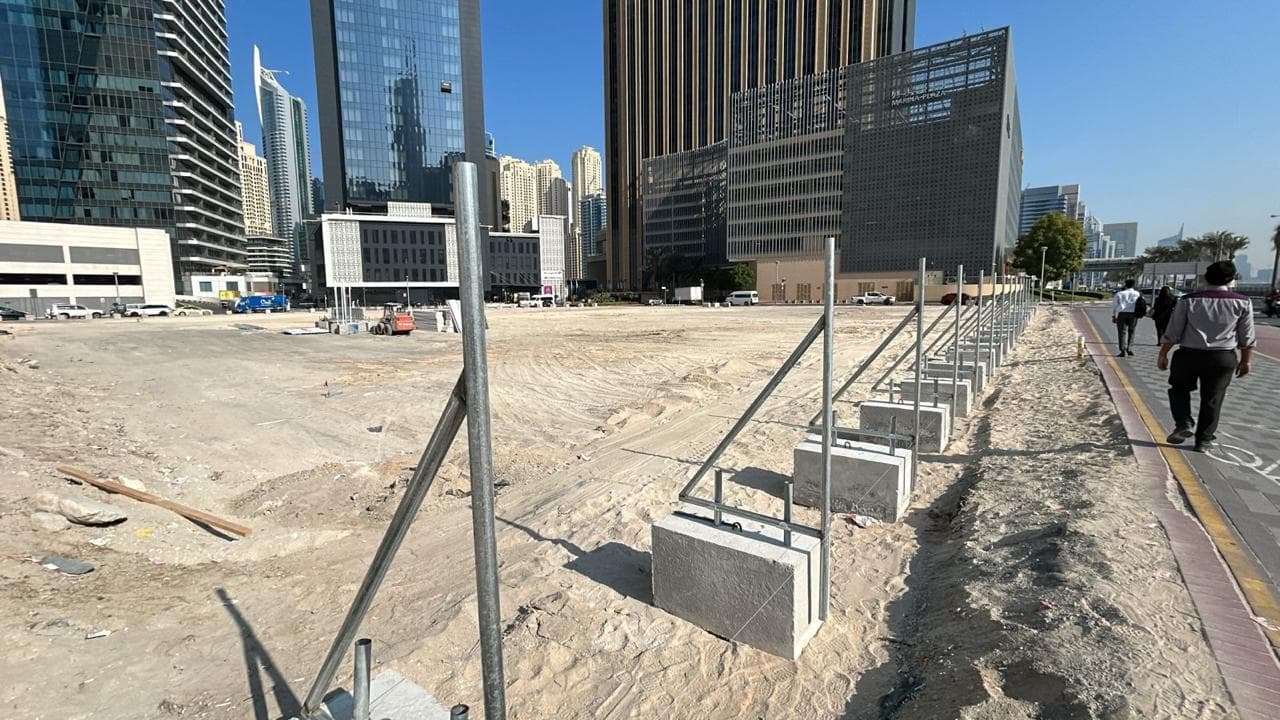

  • Rove Home Dubai Marina construction site, inspection photo 1, 8 November 2024
  • Rove Home Dubai Marina construction site, inspection photo 2, 8 November 2024

All 22 site photos, by inspection date

Context

Dubai Marina has 13 projects under construction, 46% built on average.

Own a unit in Rove Home Dubai Marina?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Rove Home Dubai Marina handover date?
The registered completion date is March 2028. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around February 2044. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Rove Home Dubai Marina?
Rove Home Dubai Marina was 7.8% built at the site inspection on 6 July 2026. The site has been inspected 6 times since November 2024. The Land Department took 22 site photos at its inspections.
Is Rove Home Dubai Marina delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of March 2028.
Who is building Rove Home Dubai Marina?
The registered developer is Irth Elite Development.
Which bank holds the escrow account for Rove Home Dubai Marina?
Commercial Bank of Dubai. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
