Park Gate construction progress

No completion date is registered for Park Gate in Dubai Hills yet. At the last site inspection, in August 2026, it was 90% built. The developer is Dubai Hills Estate.

90%

Built, at the site inspection of 11 August 2026

Finish at recent pace
October 2026
Construction started
May 2024
First registered
November 2023
Community
Dubai Hills
Units
47
Escrow bank
Emirates NBD
Name in Arabic
بارك جيت
Project number
2846
Site inspections
9

Schedule

Since September 2025 Park Gate has added about 3.7 points a month. At that rate the site reaches 100% around October 2026. No completion date is on record to compare it with.

0%25%50%75%100%202420252026
Progress at each site inspection

Site inspections

11 August 2026

90%+7.2 pts

  • Park Gate construction site, inspection photo 1, 11 August 2026
  • Park Gate construction site, inspection photo 2, 11 August 2026
  • Park Gate construction site, inspection photo 3, 11 August 2026
  • Park Gate construction site, inspection photo 4, 11 August 2026

3 June 2026

83%+12 pts

  • Park Gate construction site, inspection photo 1, 3 June 2026
  • Park Gate construction site, inspection photo 2, 3 June 2026
  • Park Gate construction site, inspection photo 3, 3 June 2026
  • Park Gate construction site, inspection photo 4, 3 June 2026

12 February 2026

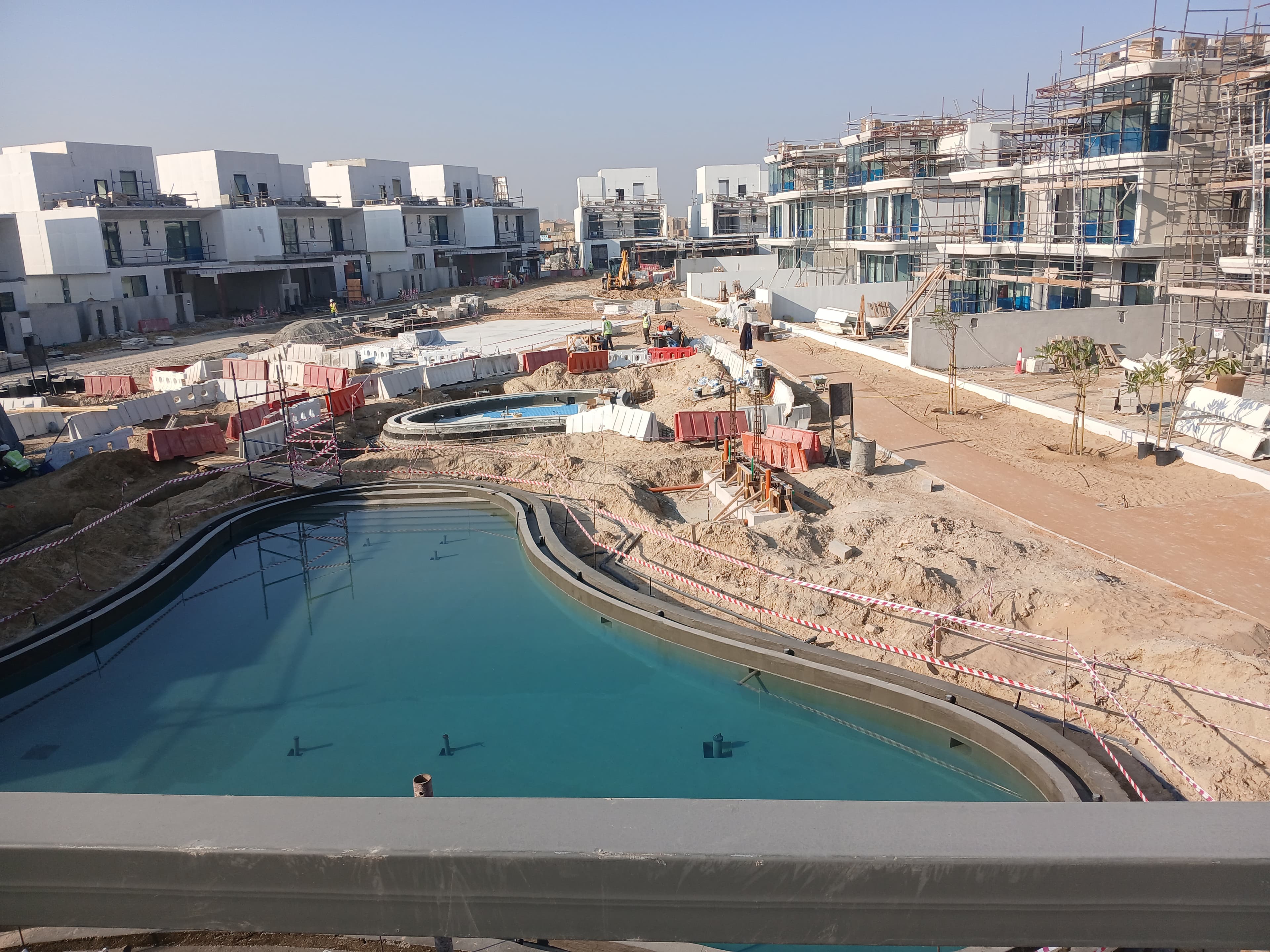

72%+5.7 pts

  • Park Gate construction site, inspection photo 1, 12 February 2026
  • Park Gate construction site, inspection photo 2, 12 February 2026
  • Park Gate construction site, inspection photo 3, 12 February 2026
  • Park Gate construction site, inspection photo 4, 12 February 2026

5 January 2026

66%+16 pts

  • Park Gate construction site, inspection photo 1, 5 January 2026
  • Park Gate construction site, inspection photo 2, 5 January 2026
  • Park Gate construction site, inspection photo 3, 5 January 2026
  • Park Gate construction site, inspection photo 4, 5 January 2026

19 September 2025

50%+29 pts

  • Park Gate construction site, inspection photo 1, 19 September 2025
  • Park Gate construction site, inspection photo 2, 19 September 2025
  • Park Gate construction site, inspection photo 3, 19 September 2025
  • Park Gate construction site, inspection photo 4, 19 September 2025

18 April 2025

21%+14 pts

  • Park Gate construction site, inspection photo 1, 18 April 2025
  • Park Gate construction site, inspection photo 2, 18 April 2025
  • Park Gate construction site, inspection photo 3, 18 April 2025
  • Park Gate construction site, inspection photo 4, 18 April 2025

18 November 2024

7.2%+6.1 pts

  • Park Gate construction site, inspection photo 1, 18 November 2024
  • Park Gate construction site, inspection photo 2, 18 November 2024

  • Park Gate construction site, inspection photo 3, 18 November 2024
  • Park Gate construction site, inspection photo 4, 18 November 2024

6 June 2024

1.1%+1.1 pts

  • Park Gate construction site, inspection photo 1, 6 June 2024
  • Park Gate construction site, inspection photo 2, 6 June 2024

14 November 2023

0%

  • Park Gate construction site, inspection photo 1, 14 November 2023
  • Park Gate construction site, inspection photo 2, 14 November 2023

All 78 site photos, by inspection date

Context

Dubai Hills has 2 projects under construction, 73% built on average.

Dubai Hills Estate has 18 projects under construction in Dubai, none past their registered completion dates.

Own a unit in Park Gate?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Park Gate handover date?
No completion date is on record for Park Gate yet. Handover follows completion, so there is no date to give.
What is the latest construction update on Park Gate?
Park Gate was 90% built at the site inspection on 11 August 2026. The site has been inspected 9 times since November 2023. The Land Department took 78 site photos at its inspections.
Who is building Park Gate?
The registered developer is Dubai Hills Estate. It has 17 other projects under construction in Dubai.
Which bank holds the escrow account for Park Gate?
Emirates NBD. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
