Oria construction progress

No completion date is registered for Oria in Dubai Creek Harbour yet. At the last site inspection, in November 2026, it was 89% built. The developer is Dubai Creek Harbour.

89%

Built, at the site inspection of 9 November 2026

Finish at recent pace
January 2027
Construction started
June 2024
First registered
February 2024
Units
163
Escrow bank
Emirates NBD
Name in Arabic
اوريا
Project number
2941
Site inspections
9

Schedule

Since January 2026 Oria has added about 4.2 points a month. At that rate the site reaches 100% around January 2027. No completion date is on record to compare it with.

0%25%50%75%100%20252026
Progress at each site inspection

Site inspections

9 November 2026

89%+18 pts

  • Oria construction site, inspection photo 1, 9 November 2026
  • Oria construction site, inspection photo 2, 9 November 2026
  • Oria construction site, inspection photo 3, 9 November 2026
  • Oria construction site, inspection photo 4, 9 November 2026

29 July 2026

71%+11 pts

  • Oria construction site, inspection photo 1, 29 July 2026
  • Oria construction site, inspection photo 2, 29 July 2026
  • Oria construction site, inspection photo 3, 29 July 2026
  • Oria construction site, inspection photo 4, 29 July 2026

22 April 2026

60%+11 pts

  • Oria construction site, inspection photo 1, 22 April 2026
  • Oria construction site, inspection photo 2, 22 April 2026
  • Oria construction site, inspection photo 3, 22 April 2026

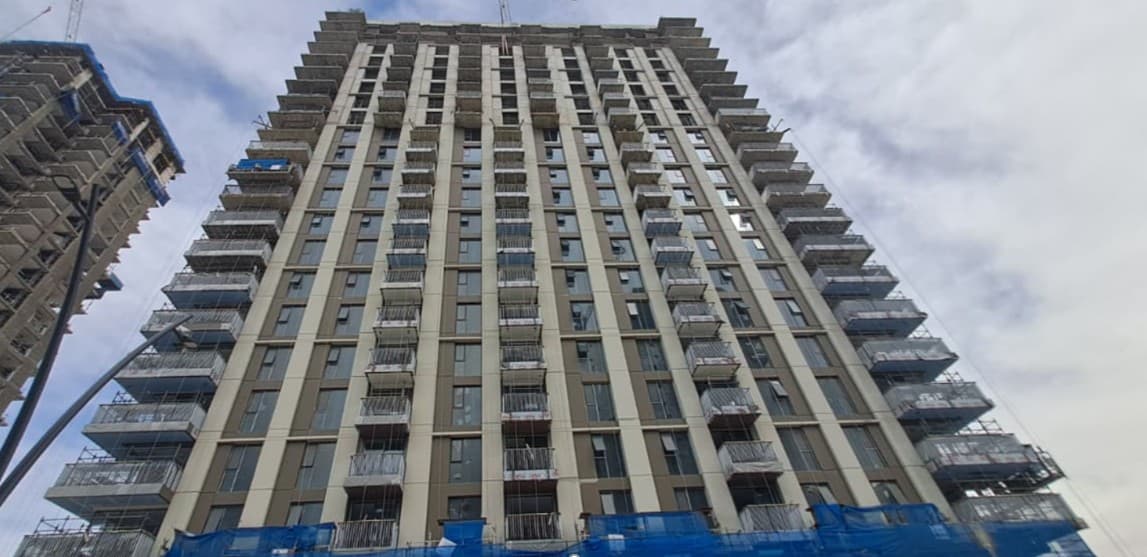

  • Oria construction site, inspection photo 4, 22 April 2026

22 January 2026

49%+20 pts

  • Oria construction site, inspection photo 1, 22 January 2026
  • Oria construction site, inspection photo 2, 22 January 2026
  • Oria construction site, inspection photo 3, 22 January 2026
  • Oria construction site, inspection photo 4, 22 January 2026

30 October 2025

29%+9.1 pts

  • Oria construction site, inspection photo 1, 30 October 2025
  • Oria construction site, inspection photo 2, 30 October 2025
  • Oria construction site, inspection photo 3, 30 October 2025
  • Oria construction site, inspection photo 4, 30 October 2025

25 July 2025

20%+9.5 pts

  • Oria construction site, inspection photo 1, 25 July 2025
  • Oria construction site, inspection photo 2, 25 July 2025
  • Oria construction site, inspection photo 3, 25 July 2025
  • Oria construction site, inspection photo 4, 25 July 2025

10 April 2025

10%+6.1 pts

  • Oria construction site, inspection photo 1, 10 April 2025
  • Oria construction site, inspection photo 2, 10 April 2025
  • Oria construction site, inspection photo 3, 10 April 2025
  • Oria construction site, inspection photo 4, 10 April 2025

5 September 2024

4.3%+4.3 pts

  • Oria construction site, inspection photo 1, 5 September 2024
  • Oria construction site, inspection photo 2, 5 September 2024
  • Oria construction site, inspection photo 3, 5 September 2024

24 January 2024

0%

  • Oria construction site, inspection photo 1, 24 January 2024
  • Oria construction site, inspection photo 2, 24 January 2024

All 63 site photos, by inspection date

Context

Dubai Creek Harbour has 14 projects under construction, 53% built on average.

Dubai Creek Harbour has 15 projects under construction in Dubai, none past their registered completion dates.

Own a unit in Oria?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Oria handover date?
No completion date is on record for Oria yet. Handover follows completion, so there is no date to give.
What is the latest construction update on Oria?
Oria was 89% built at the site inspection on 9 November 2026. The site has been inspected 9 times since January 2024. The Land Department took 63 site photos at its inspections.
Who is building Oria?
The registered developer is Dubai Creek Harbour. It has 14 other projects under construction in Dubai.
Which bank holds the escrow account for Oria?
Emirates NBD. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
