The Valley - Velora construction progress
The registered completion date for The Valley - Velora in Al Yufrah 1 is August 2028. At the last site inspection, in June 2026, it was 50% built. The developer is Emaar Development.
50%
Built, at the site inspection of 9 June 2026
On pace for its date
- Registered completion date
- August 2028
- Finish at recent pace
- June 2027
- Construction started
- August 2024
- First registered
- June 2024
- Developer
- Emaar Development
- Community
- Al Yufrah 1
- Units
- 488
- Escrow bank
- First Abu Dhabi Bank
- Name in Arabic
- ذا فالي - فيلورا
- Project number
- 3153
- Site inspections
- 6
Schedule
Since July 2025 The Valley - Velora has added about 4.0 points a month. That puts 100% around June 2027, within three months of its registered completion date of August 2028.
Site inspections
9 June 2026
50%+10 pts
24 February 2026
40%+13 pts

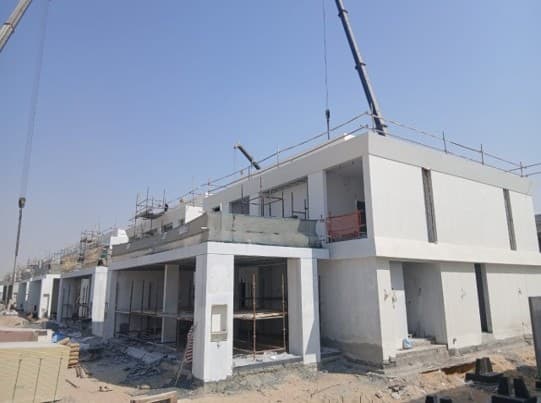

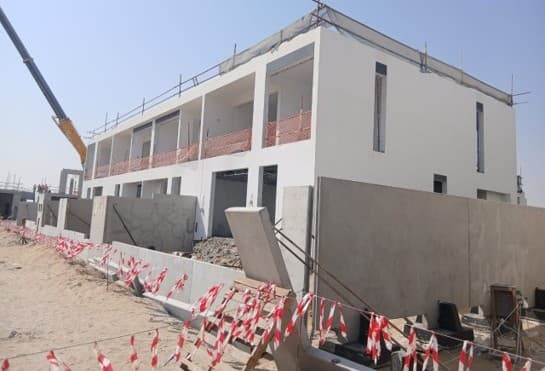

6 November 2025
27%+19 pts
23 July 2025
8.3%+7.5 pts

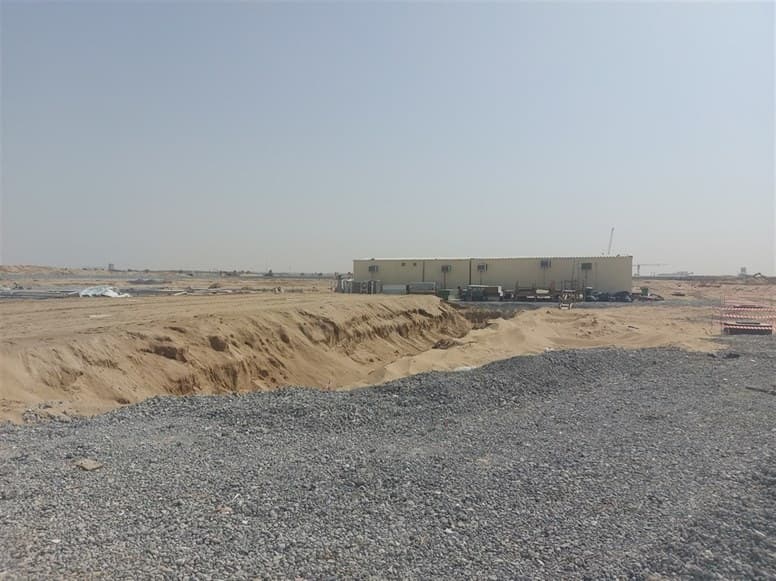

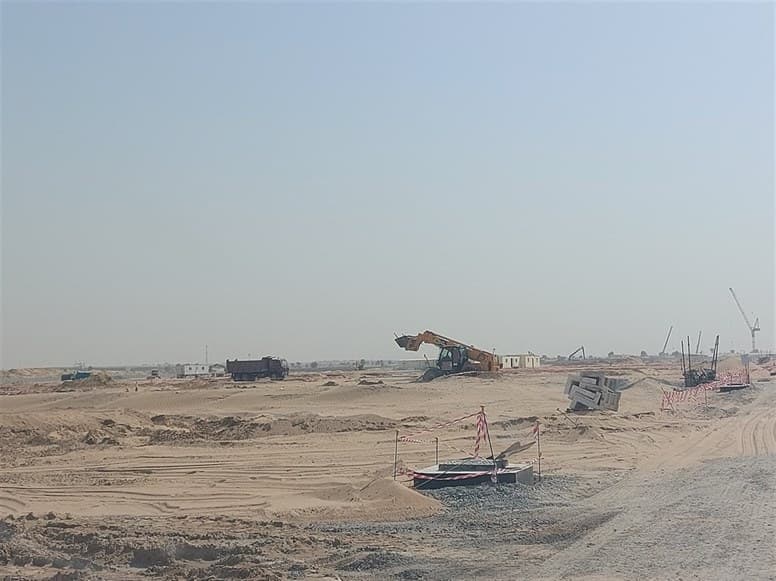

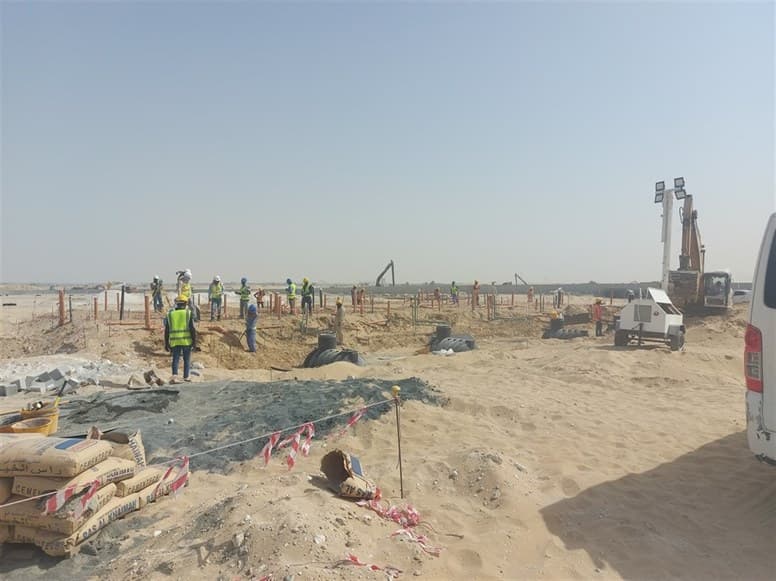

14 April 2025
0.8%+0.8 pts

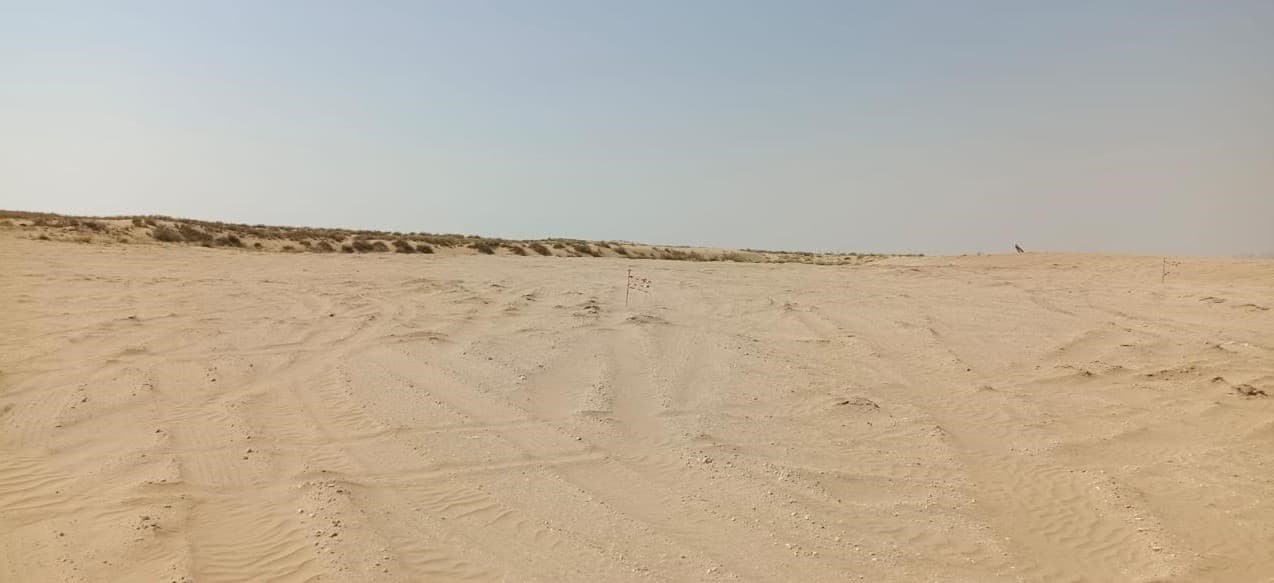

21 June 2024
0%
Context
Al Yufrah 1 has 17 projects under construction, 40% built on average.
Emaar Development has 52 projects under construction in Dubai, none past their registered completion dates.
Own a unit in The Valley - Velora?
Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When is the The Valley - Velora handover date?
- The registered completion date is August 2028. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around June 2027. RERA asks developers to update their dates as projects move, so check the register before relying on it.
- What is the latest construction update on The Valley - Velora?
- The Valley - Velora was 50% built at the site inspection on 9 June 2026. The site has been inspected 6 times since June 2024. The Land Department took 35 site photos at its inspections.
- Is The Valley - Velora delayed?
- Not on current figures. At the rate of the last year it finishes within three months of its registered date of August 2028.
- Who is building The Valley - Velora?
- The registered developer is Emaar Development. It has 51 other projects under construction in Dubai.
- Which bank holds the escrow account for The Valley - Velora?
- First Abu Dhabi Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- The St. Regis Residences, Downtown DubaiAlso by Emaar Development. 76%, Due December 2026.
- Address The BayAlso by Emaar Development. 70%, Due December 2026.
- SeapointAlso by Emaar Development. 37%, Due March 2028.
- BayviewAlso by Emaar Development. 63%, Due July 2028.
- Elwood EstatesNearby in Al Yufrah 1. 14%, Due June 2028.
- Checking an off-plan project's progressHow to read the completion percentage and what escrow allows when a payment runs ahead.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
.jpg&w=3840&q=75)
.jpg&w=3840&q=75)
.jpg&w=3840&q=75)


.jpg&w=3840&q=75)
.jpg&w=3840&q=75)
