Avenue Residence 7 By Nabni construction progress

The registered completion date for Avenue Residence 7 By Nabni in Al Furjan is October 2027. At the last site inspection, in September 2026, it was 17% built. The developer is Nabni Real Estate Development.

17%

Built, at the site inspection of 1 September 2026

Running behind its date

Registered completion date
October 2027
Finish at recent pace
January 2030
Construction started
September 2024
First registered
October 2024
Developer
Nabni Real Estate Development
Community
Al Furjan
Units
166
Escrow bank
The National Bank of Fujairah
Name in Arabic
افينيو ريذدنس 7 من نبني
Project number
3300
Site inspections
5

Schedule

Between January 2026 and September 2026 the site added about 2.0 points a month. At that rate it would finish around January 2030, more than three months after its registered date of October 2027.

0%25%50%75%100%202520262027
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

1 September 2026

17%+11 pts

  • Avenue Residence 7 By Nabni construction site, inspection photo 1, 1 September 2026
  • Avenue Residence 7 By Nabni construction site, inspection photo 2, 1 September 2026
  • Avenue Residence 7 By Nabni construction site, inspection photo 3, 1 September 2026
  • Avenue Residence 7 By Nabni construction site, inspection photo 4, 1 September 2026

30 April 2026

5.9%+4.0 pts

  • Avenue Residence 7 By Nabni construction site, inspection photo 1, 30 April 2026
  • Avenue Residence 7 By Nabni construction site, inspection photo 2, 30 April 2026
  • Avenue Residence 7 By Nabni construction site, inspection photo 3, 30 April 2026
  • Avenue Residence 7 By Nabni construction site, inspection photo 4, 30 April 2026

13 January 2026

1.9%+1.9 pts

  • Avenue Residence 7 By Nabni construction site, inspection photo 1, 13 January 2026
  • Avenue Residence 7 By Nabni construction site, inspection photo 2, 13 January 2026
  • Avenue Residence 7 By Nabni construction site, inspection photo 3, 13 January 2026
  • Avenue Residence 7 By Nabni construction site, inspection photo 4, 13 January 2026

7 July 2025

0%+0.0 pts

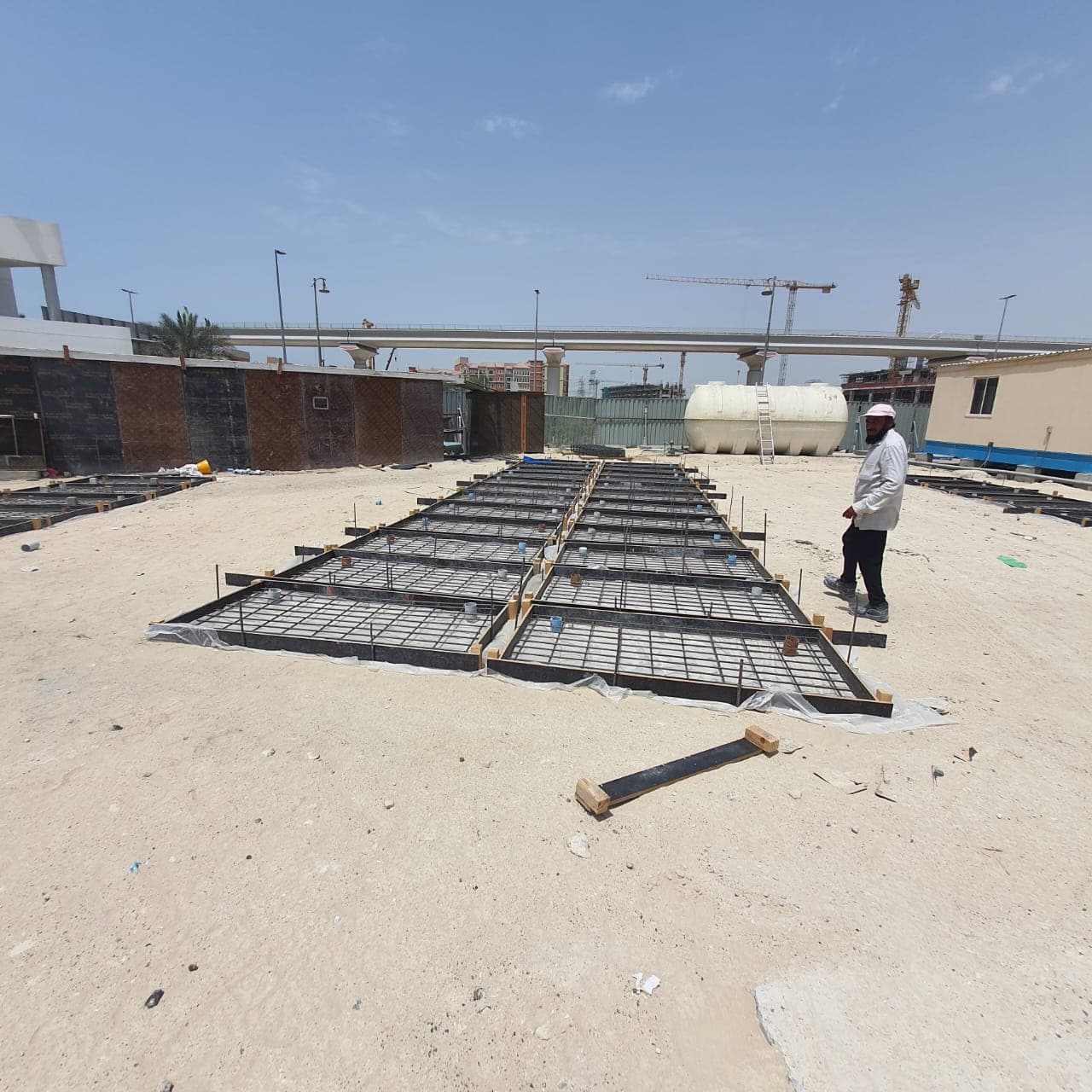

  • Avenue Residence 7 By Nabni construction site, inspection photo 1, 7 July 2025
  • Avenue Residence 7 By Nabni construction site, inspection photo 2, 7 July 2025
  • Avenue Residence 7 By Nabni construction site, inspection photo 3, 7 July 2025

27 September 2024

0%

  • Avenue Residence 7 By Nabni construction site, inspection photo 1, 27 September 2024

All 20 site photos, by inspection date

Context

Al Furjan has 38 projects under construction, 32% built on average.

Own a unit in Avenue Residence 7 By Nabni?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Avenue Residence 7 By Nabni handover date?
The registered completion date is October 2027. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around January 2030. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Avenue Residence 7 By Nabni?
Avenue Residence 7 By Nabni was 17% built at the site inspection on 1 September 2026. The site has been inspected 5 times since September 2024. The Land Department took 20 site photos at its inspections.
Is Avenue Residence 7 By Nabni delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of October 2027.
Who is building Avenue Residence 7 By Nabni?
The registered developer is Nabni Real Estate Development.
Which bank holds the escrow account for Avenue Residence 7 By Nabni?
The National Bank of Fujairah. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
