Skip to content

South Garden B construction progress

The registered completion date for South Garden B in Wasl Gate is December 2027. At the last site inspection, in September 2026, it was 16% built. The developer is Jag Development.

16%

Built, at the site inspection of 7 September 2026

Running behind its date

Registered completion date
December 2027
Finish at recent pace
February 2032
Construction started
January 2025
First registered
September 2024
Community
Wasl Gate
Units
258
Escrow bank
Emirates NBD
Name in Arabic
B ساوث غاردن
Project number
3140
Site inspections
4

Schedule

Between February 2026 and September 2026 the site added about 1.3 points a month. At that rate it would finish around February 2032, more than three months after its registered date of December 2027.

0%25%50%75%100%202520262027
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

7 September 2026

16%+8.2 pts

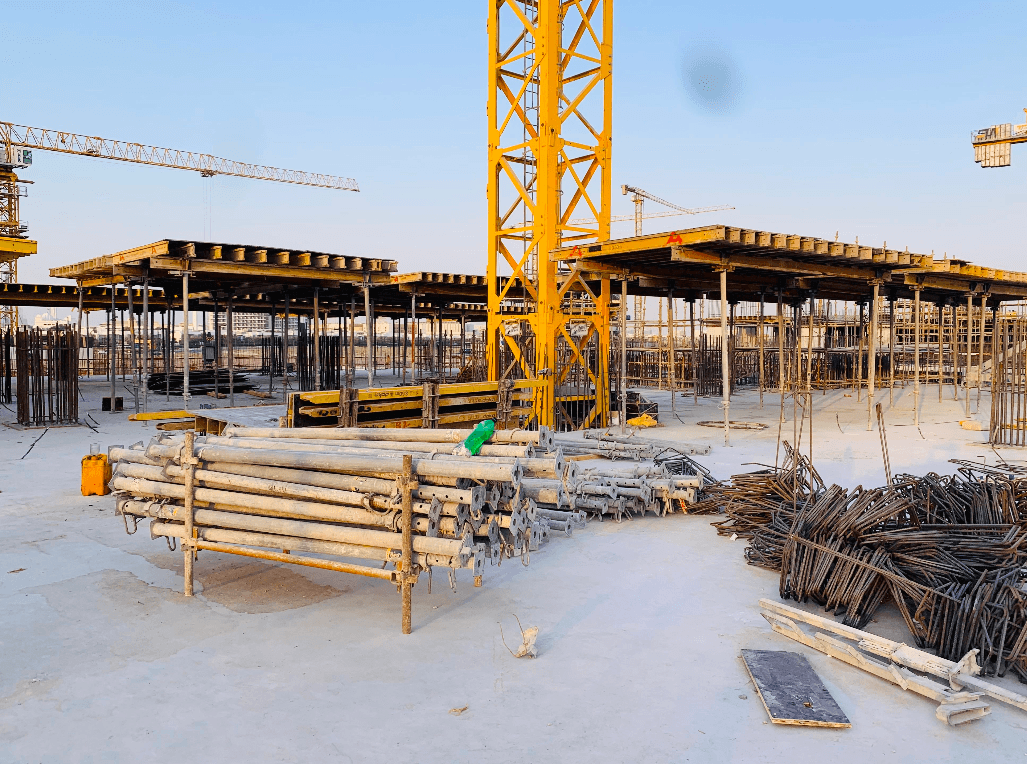

  • South Garden B construction site, inspection photo 1, 7 September 2026

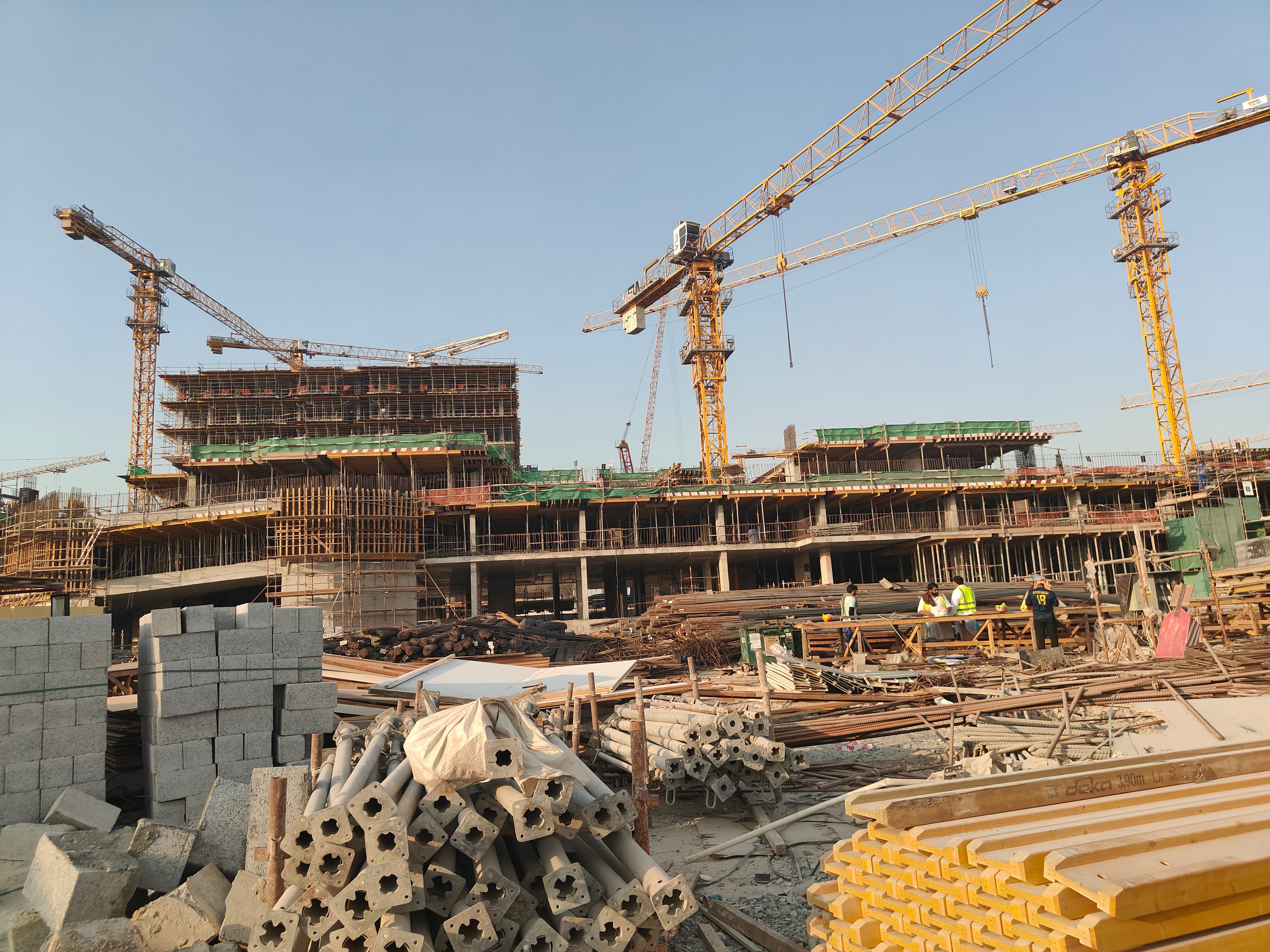

  • South Garden B construction site, inspection photo 2, 7 September 2026

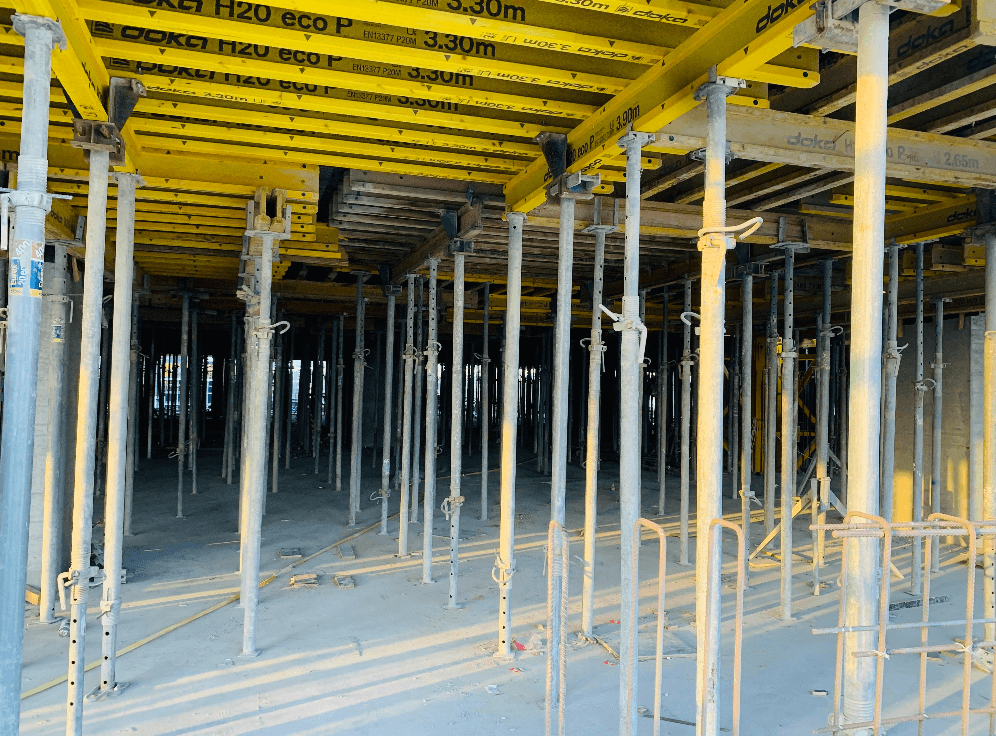

  • South Garden B construction site, inspection photo 3, 7 September 2026

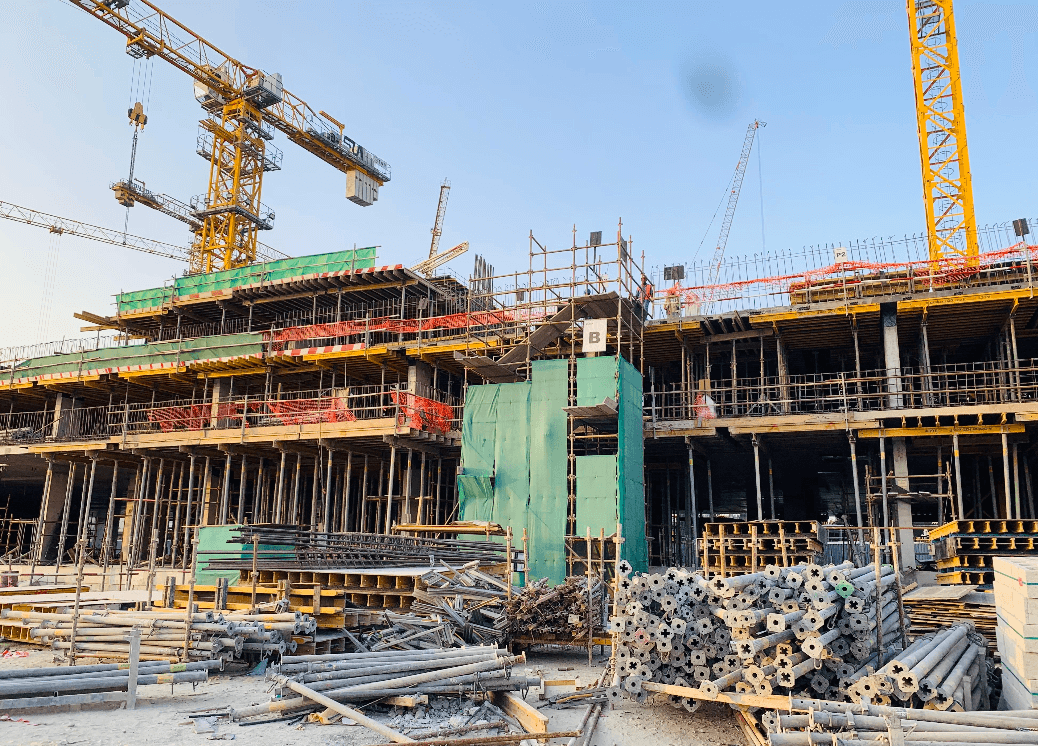

  • South Garden B construction site, inspection photo 4, 7 September 2026

24 February 2026

8.0%+7.4 pts

  • South Garden B construction site, inspection photo 1, 24 February 2026
  • South Garden B construction site, inspection photo 2, 24 February 2026
  • South Garden B construction site, inspection photo 3, 24 February 2026

21 July 2025

0.6%+0.6 pts

  • South Garden B construction site, inspection photo 1, 21 July 2025
  • South Garden B construction site, inspection photo 2, 21 July 2025
  • South Garden B construction site, inspection photo 3, 21 July 2025

6 August 2024

0%

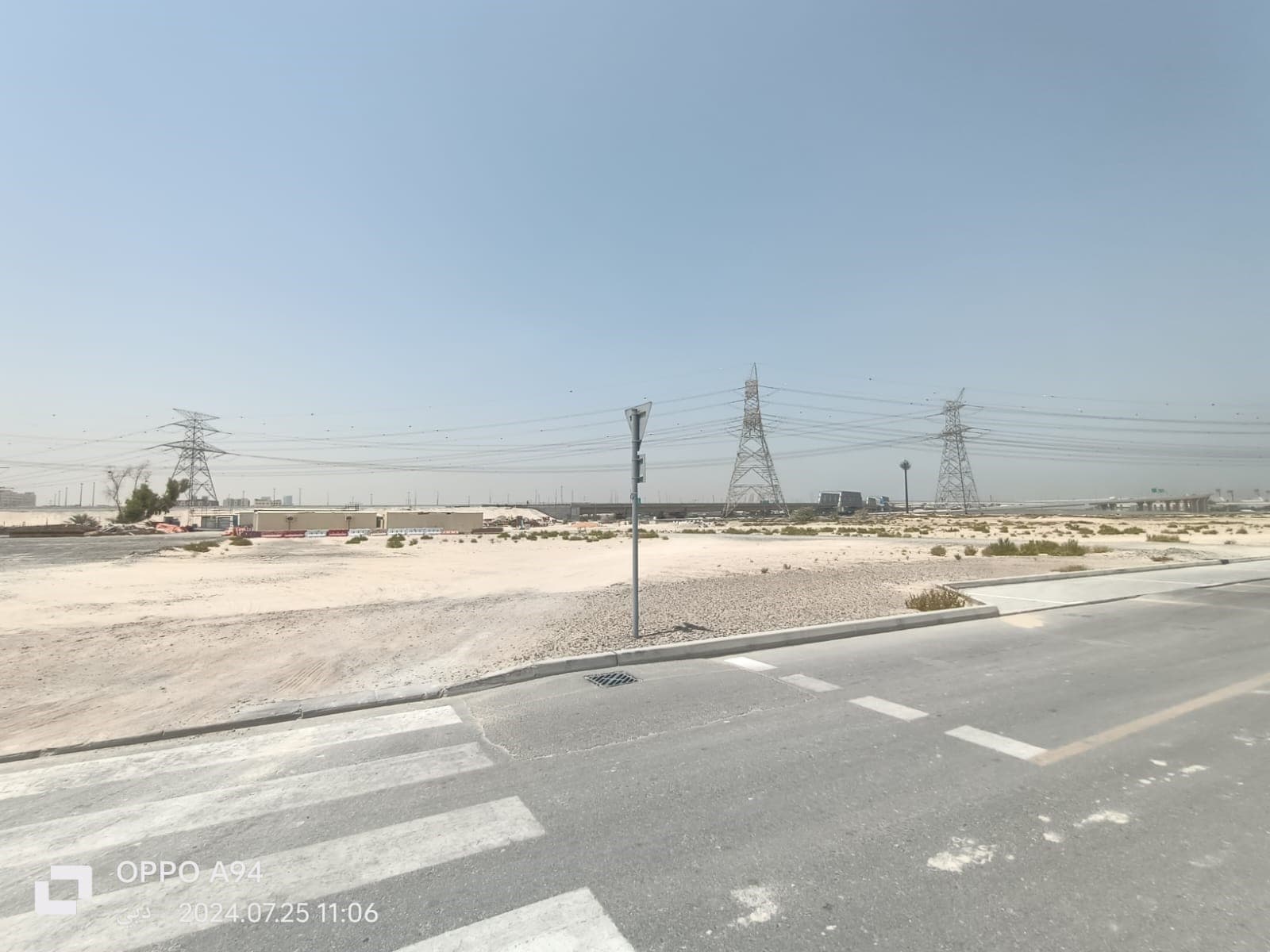

  • South Garden B construction site, inspection photo 1, 6 August 2024

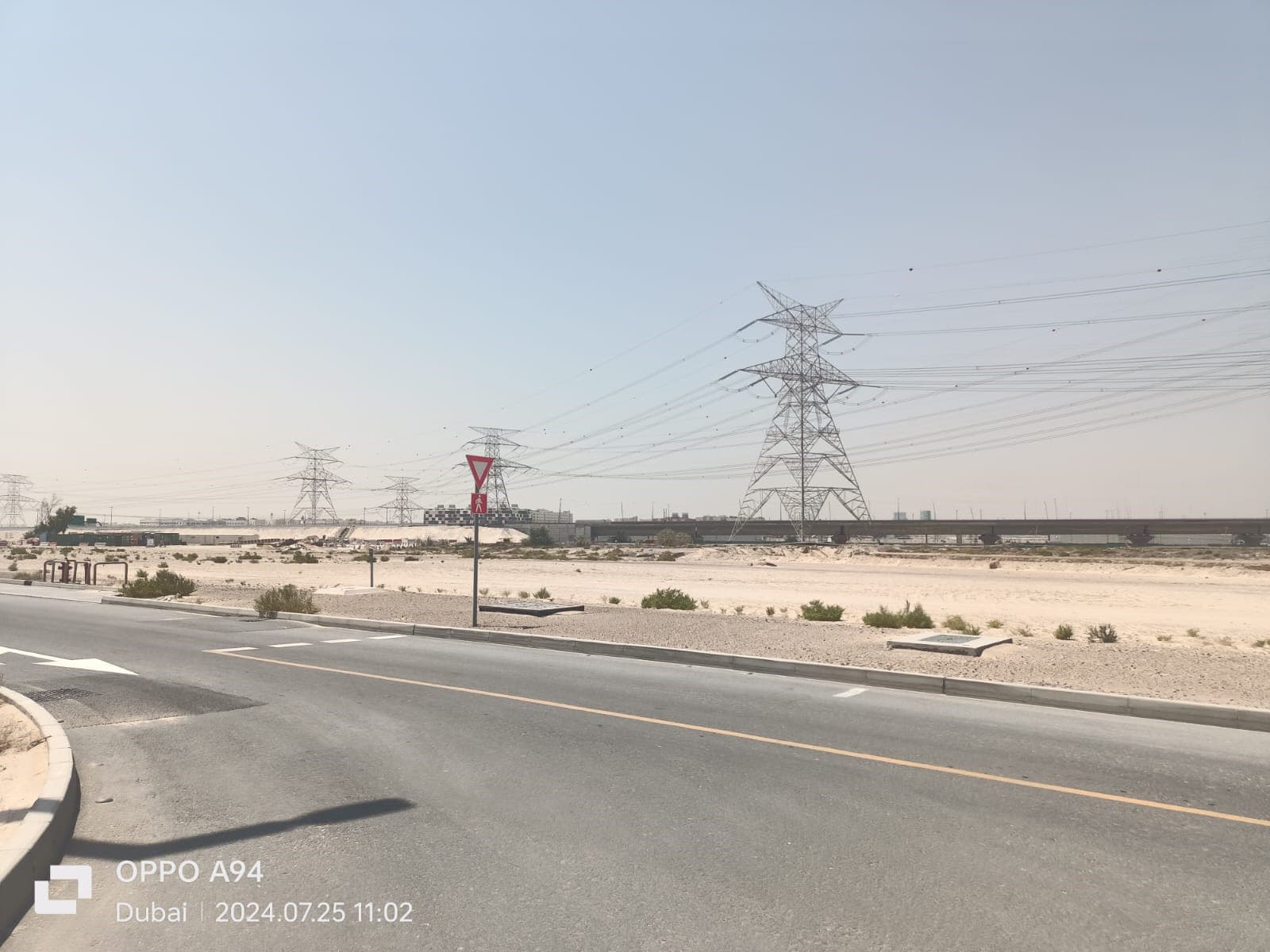

  • South Garden B construction site, inspection photo 2, 6 August 2024

All 12 site photos, by inspection date

Context

Wasl Gate has 13 projects under construction, 21% built on average.

Jag Development has 12 projects under construction in Dubai, none past their registered completion dates.

Own a unit in South Garden B?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the South Garden B handover date?
The registered completion date is December 2027. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around February 2032. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on South Garden B?
South Garden B was 16% built at the site inspection on 7 September 2026. The site has been inspected 4 times since August 2024. The Land Department took 12 site photos at its inspections.
Is South Garden B delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of December 2027.
Who is building South Garden B?
The registered developer is Jag Development. It has 11 other projects under construction in Dubai.
Which bank holds the escrow account for South Garden B?
Emirates NBD. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
