Solen Residence By Jamal Living construction progress
The registered completion date for Solen Residence By Jamal Living in Silicon Oasis is October 2027. At the last site inspection, in August 2026, it was 22% built. The developer is Mohammad Abuhijleh Real Estate Development.
22%
Built, at the site inspection of 13 August 2026
Running behind its date
- Registered completion date
- October 2027
- Finish at recent pace
- January 2030
- Construction started
- August 2025
- First registered
- October 2025
- Developer
- Mohammad Abuhijleh Real Estate Development
- Community
- Silicon Oasis
- Units
- 87
- Escrow bank
- Mashreq Bank
- Name in Arabic
- إقامة سولن من جمال ليفينغ
- Project number
- 4048
- Site inspections
- 4
Schedule
Between September 2025 and August 2026 the site added about 1.9 points a month. At that rate it would finish around January 2030, more than three months after its registered date of October 2027.
Site inspections

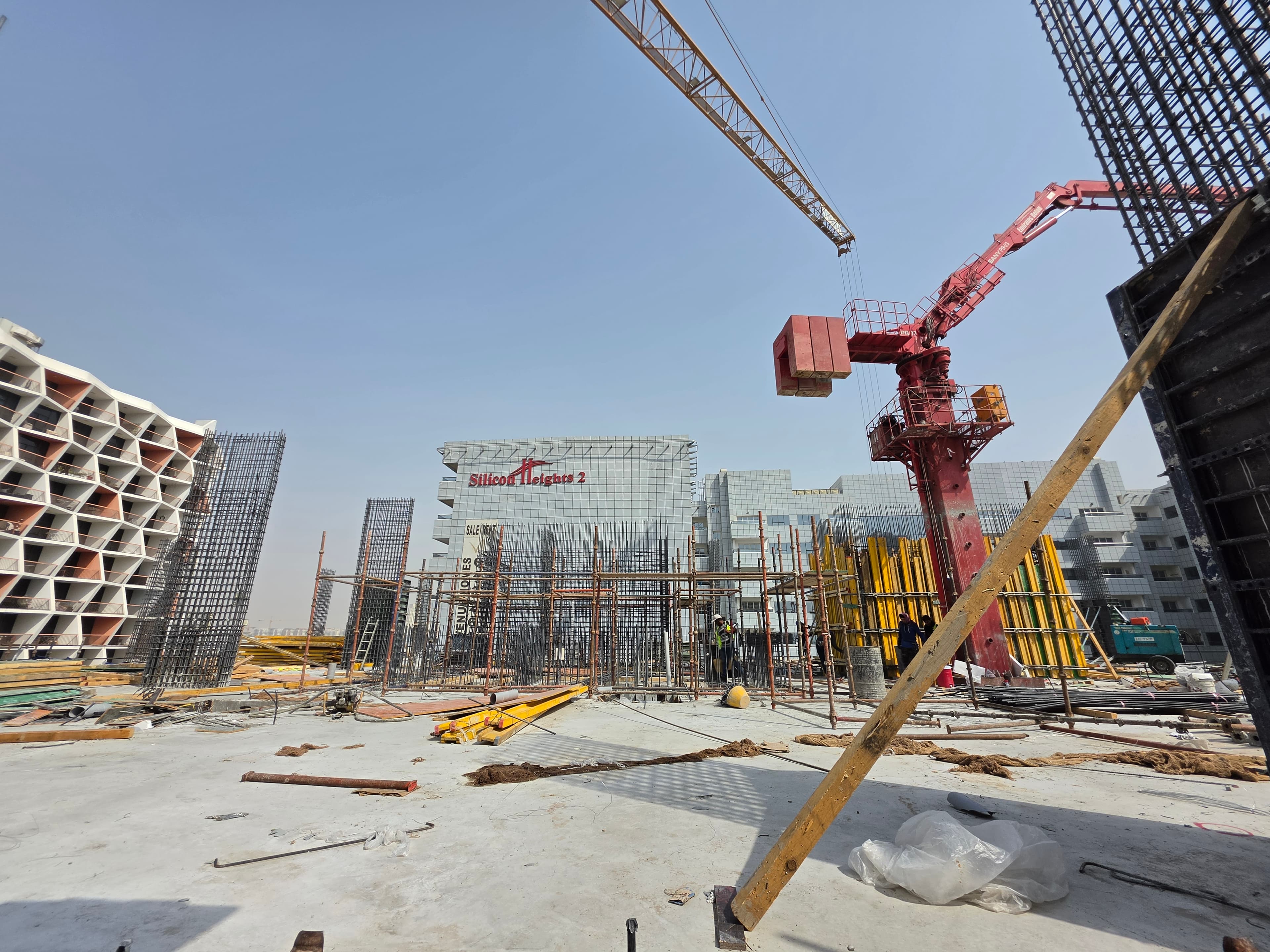

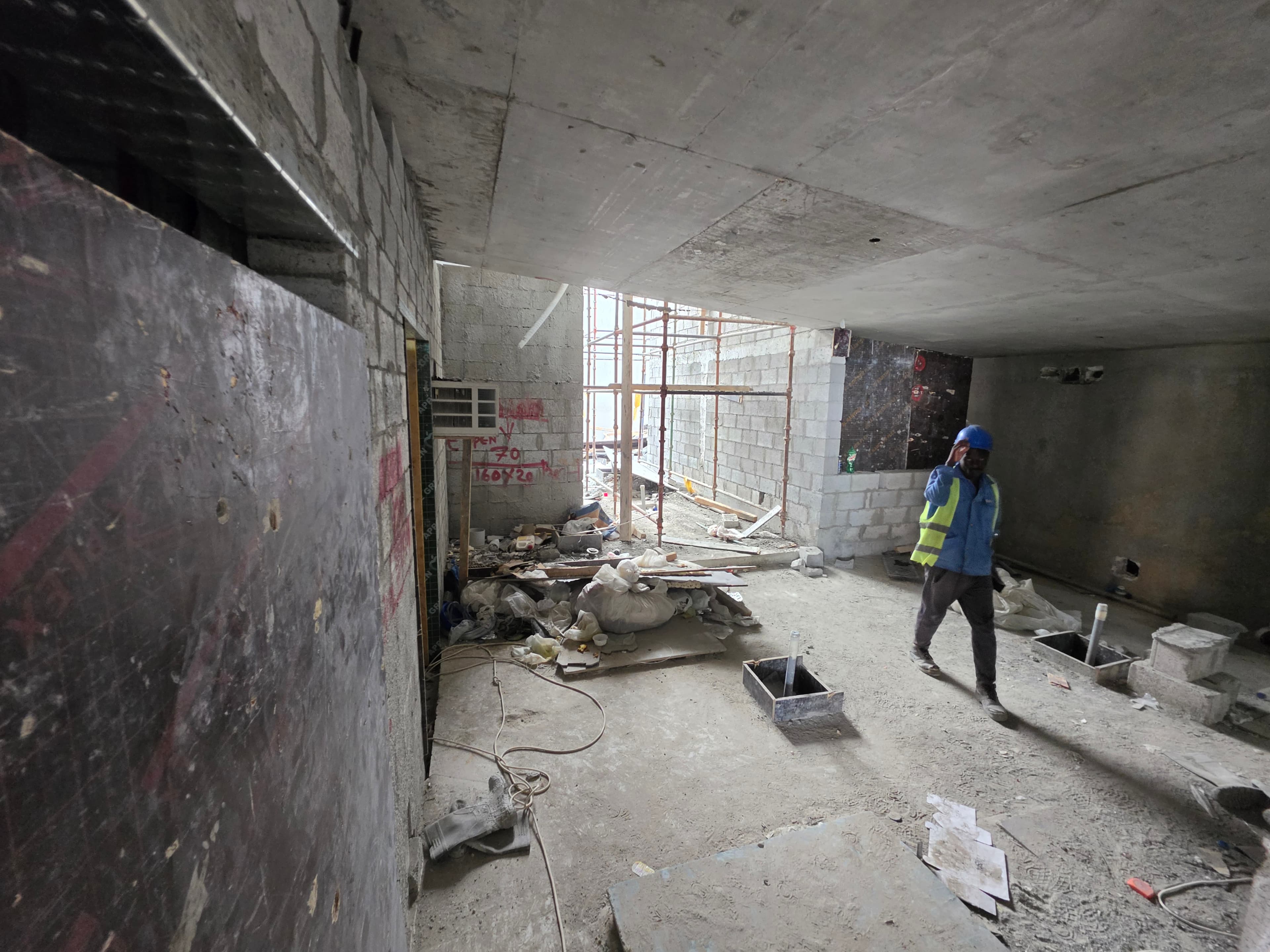

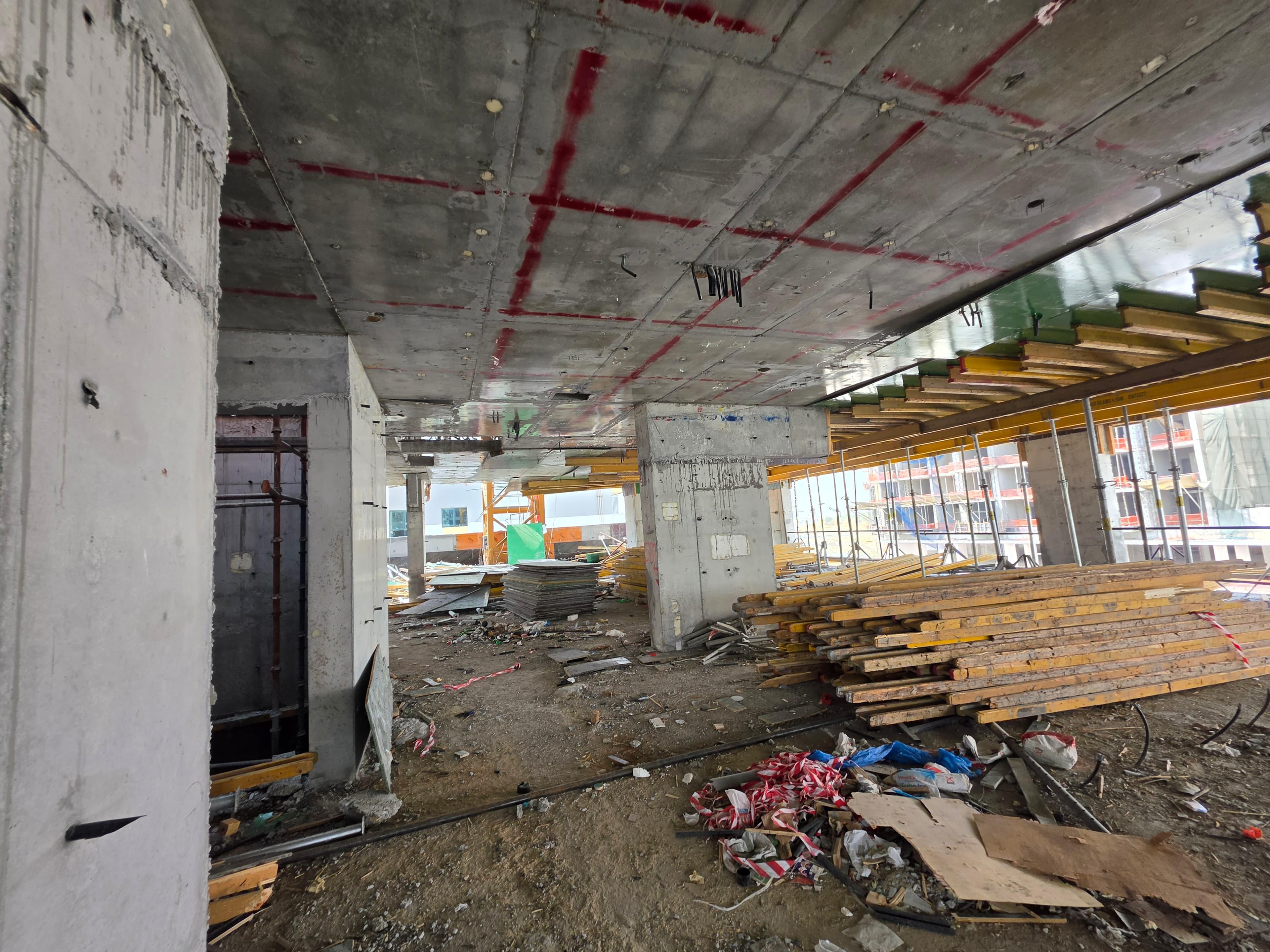

13 August 2026
22%+8.6 pts
30 April 2026
13%+10 pts
21 January 2026
2.8%+2.8 pts

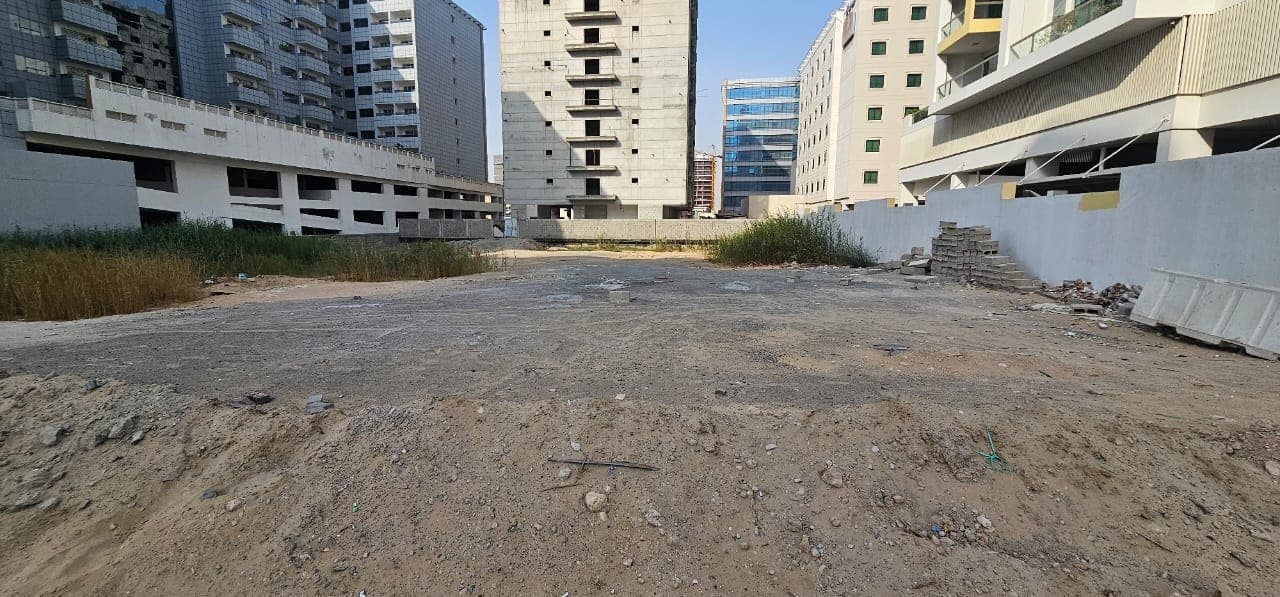

4 September 2025
0%
Context
Silicon Oasis has 10 projects under construction, 28% built on average.
Own a unit in Solen Residence By Jamal Living?
Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When is the Solen Residence By Jamal Living handover date?
- The registered completion date is October 2027. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around January 2030. RERA asks developers to update their dates as projects move, so check the register before relying on it.
- What is the latest construction update on Solen Residence By Jamal Living?
- Solen Residence By Jamal Living was 22% built at the site inspection on 13 August 2026. The site has been inspected 4 times since September 2025. The Land Department took 17 site photos at its inspections.
- Is Solen Residence By Jamal Living delayed?
- It is running behind. At the rate of the last year it would finish more than three months after its registered date of October 2027.
- Who is building Solen Residence By Jamal Living?
- The registered developer is Mohammad Abuhijleh Real Estate Development.
- Which bank holds the escrow account for Solen Residence By Jamal Living?
- Mashreq Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- SerenovaNearby in Silicon Oasis. 1.6%, Due March 2028.
- Aura EliteNearby in Silicon Oasis. 51%, Due April 2026, passed.
- Oasiz 1 By DanubeNearby in Silicon Oasis. 38%, Due November 2027.
- Oasiz 2 By DanubeNearby in Silicon Oasis. 38%, Due November 2027.
- Checking an off-plan project's progressHow to read the completion percentage and what escrow allows when a payment runs ahead.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.


.jpg&w=3840&q=75)
%255B1%255D.jpg&w=3840&q=75)
.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)

.jpeg&w=3840&q=75)
