Beach Walk Grand By Imtiaz construction progress

The registered completion date for Beach Walk Grand By Imtiaz in Palm Deira is December 2026. At the last site inspection, in November 2026, it was 68% built. The developer is Imtiaz Bwg Real Estate Development.

68%

Built, at the site inspection of 9 November 2026

Running behind its date

Registered completion date
December 2026
Finish at recent pace
June 2027
Construction started
December 2024
First registered
December 2024
Developer
Imtiaz Bwg Real Estate Development
Community
Palm Deira
Units
112
Escrow bank
First Abu Dhabi Bank
Name in Arabic
بيتش ووك جراند من امتياز
Project number
3367
Site inspections
8

Schedule

Between February 2026 and November 2026 the site added about 4.6 points a month. At that rate it would finish around June 2027, more than three months after its registered date of December 2026.

0%25%50%75%100%20252026
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

9 November 2026

68%+15 pts

  • Beach Walk Grand By Imtiaz construction site, inspection photo 1, 9 November 2026
  • Beach Walk Grand By Imtiaz construction site, inspection photo 2, 9 November 2026
  • Beach Walk Grand By Imtiaz construction site, inspection photo 3, 9 November 2026
  • Beach Walk Grand By Imtiaz construction site, inspection photo 4, 9 November 2026

10 August 2026

53%+8.6 pts

  • Beach Walk Grand By Imtiaz construction site, inspection photo 1, 10 August 2026

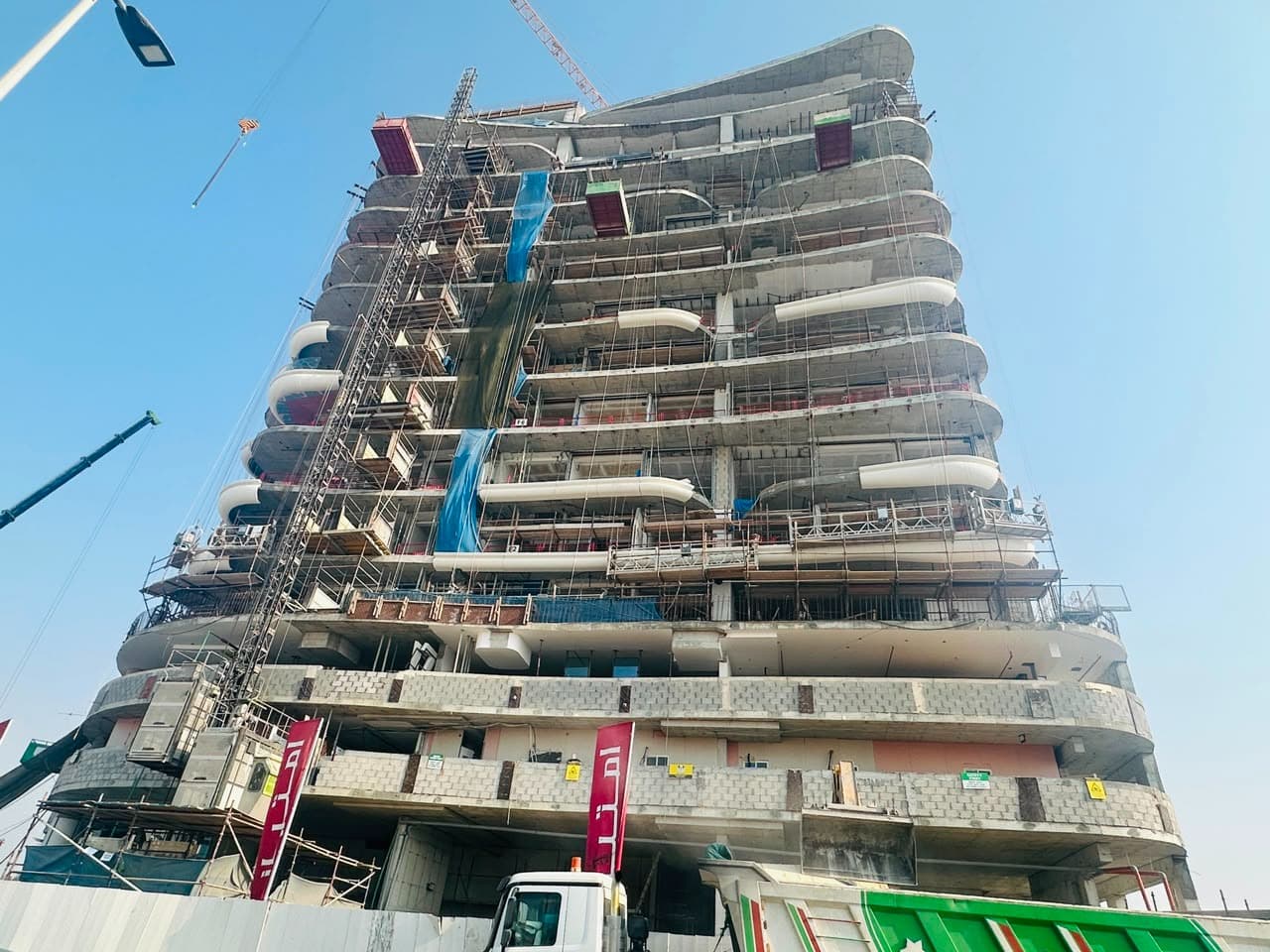

  • Beach Walk Grand By Imtiaz construction site, inspection photo 2, 10 August 2026
  • Beach Walk Grand By Imtiaz construction site, inspection photo 3, 10 August 2026
  • Beach Walk Grand By Imtiaz construction site, inspection photo 4, 10 August 2026

1 June 2026

45%+16 pts

  • Beach Walk Grand By Imtiaz construction site, inspection photo 1, 1 June 2026
  • Beach Walk Grand By Imtiaz construction site, inspection photo 2, 1 June 2026
  • Beach Walk Grand By Imtiaz construction site, inspection photo 3, 1 June 2026
  • Beach Walk Grand By Imtiaz construction site, inspection photo 4, 1 June 2026

20 February 2026

29%+15 pts

  • Beach Walk Grand By Imtiaz construction site, inspection photo 1, 20 February 2026
  • Beach Walk Grand By Imtiaz construction site, inspection photo 2, 20 February 2026
  • Beach Walk Grand By Imtiaz construction site, inspection photo 3, 20 February 2026
  • Beach Walk Grand By Imtiaz construction site, inspection photo 4, 20 February 2026

7 November 2025

14%+7.8 pts

  • Beach Walk Grand By Imtiaz construction site, inspection photo 1, 7 November 2025
  • Beach Walk Grand By Imtiaz construction site, inspection photo 2, 7 November 2025
  • Beach Walk Grand By Imtiaz construction site, inspection photo 3, 7 November 2025
  • Beach Walk Grand By Imtiaz construction site, inspection photo 4, 7 November 2025

4 August 2025

6.1%+5.9 pts

  • Beach Walk Grand By Imtiaz construction site, inspection photo 1, 4 August 2025
  • Beach Walk Grand By Imtiaz construction site, inspection photo 2, 4 August 2025
  • Beach Walk Grand By Imtiaz construction site, inspection photo 3, 4 August 2025
  • Beach Walk Grand By Imtiaz construction site, inspection photo 4, 4 August 2025

23 April 2025

0.2%+0.2 pts

  • Beach Walk Grand By Imtiaz construction site, inspection photo 1, 23 April 2025
  • Beach Walk Grand By Imtiaz construction site, inspection photo 2, 23 April 2025
  • Beach Walk Grand By Imtiaz construction site, inspection photo 3, 23 April 2025

4 November 2024

0%

  • Beach Walk Grand By Imtiaz construction site, inspection photo 1, 4 November 2024
  • Beach Walk Grand By Imtiaz construction site, inspection photo 2, 4 November 2024

All 54 site photos, by inspection date

Context

Palm Deira has 94 projects under construction, 24% built on average.

Own a unit in Beach Walk Grand By Imtiaz?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Beach Walk Grand By Imtiaz handover date?
The registered completion date is December 2026. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around June 2027. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Beach Walk Grand By Imtiaz?
Beach Walk Grand By Imtiaz was 68% built at the site inspection on 9 November 2026. The site has been inspected 8 times since November 2024. The Land Department took 54 site photos at its inspections.
Is Beach Walk Grand By Imtiaz delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of December 2026.
Who is building Beach Walk Grand By Imtiaz?
The registered developer is Imtiaz Bwg Real Estate Development.
Which bank holds the escrow account for Beach Walk Grand By Imtiaz?
First Abu Dhabi Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
