Takaya construction progress
The registered completion date for Takaya in Motor City is December 2027. At the last site inspection, in August 2026, it was 16% built. The developer is Takaya Real Estate Development.
16%
Built, at the site inspection of 5 August 2026
Running behind its date
- Registered completion date
- December 2027
- Finish at recent pace
- October 2031
- Construction started
- July 2024
- First registered
- October 2024
- Developer
- Takaya Real Estate Development
- Community
- Motor City
- Units
- 822
- Escrow bank
- Dubai Islamic Bank
- Name in Arabic
- تاكايا
- Project number
- 3112
- Site inspections
- 5
Schedule
Between October 2025 and August 2026 the site added about 1.3 points a month. At that rate it would finish around October 2031, more than three months after its registered date of December 2027.
Site inspections
5 August 2026
16%+12 pts

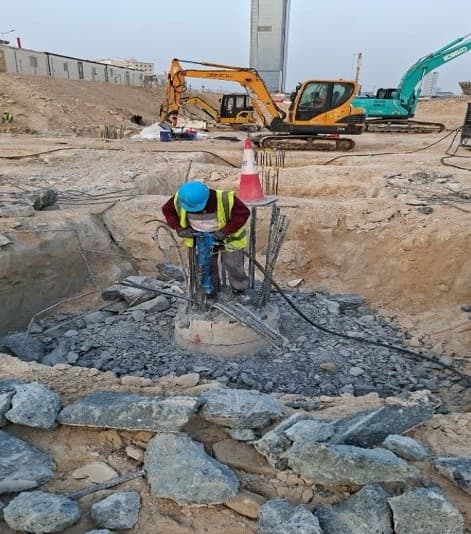

3 March 2026
3.7%+1.3 pts
10 October 2025
2.4%+1.3 pts
1 May 2025
1.1%+1.1 pts
3 June 2024
0%
Context
Motor City has 11 projects under construction, 20% built on average.
Own a unit in Takaya?
Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When is the Takaya handover date?
- The registered completion date is December 2027. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around October 2031. RERA asks developers to update their dates as projects move, so check the register before relying on it.
- What is the latest construction update on Takaya?
- Takaya was 16% built at the site inspection on 5 August 2026. The site has been inspected 5 times since June 2024. The Land Department took 23 site photos at its inspections.
- Is Takaya delayed?
- It is running behind. At the rate of the last year it would finish more than three months after its registered date of December 2027.
- Who is building Takaya?
- The registered developer is Takaya Real Estate Development.
- Which bank holds the escrow account for Takaya?
- Dubai Islamic Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- The Community Motor CityNearby in Motor City. 95%, Due October 2025, passed.
- Sobha OrbisNearby in Motor City. 22%, Due December 2028.
- Sobha SolisNearby in Motor City. 18%, Due December 2028.
- Capital OneNearby in Motor City. 20%, Due February 2027.
- Checking an off-plan project's progressHow to read the completion percentage and what escrow allows when a payment runs ahead.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.














.jpeg&w=3840&q=75)
