Mangrove 2 construction progress

Mangrove 2 in Majan was registered to complete in September 2026 and is still under construction. At the last site inspection, in August 2026, it was 38% built. The developer is Mangrove Real Estate Development.

38%

Built, at the site inspection of 10 August 2026

2 months past its registered completion date

Registered completion date
September 2026
Finish at recent pace
December 2027
Construction started
May 2025
First registered
July 2025
Developer
Mangrove Real Estate Development
Community
Majan
Units
18
Escrow bank
Arab Bank
Name in Arabic
مانجروف 2
Project number
3597
Site inspections
3

Schedule

Mangrove 2 was registered to complete in September 2026, 2 months ago, and is still under construction. Over the last year of inspections it has added about 3.7 points a month. Kept at that rate, the site would reach 100% around December 2027.

0%25%50%75%100%2026
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

10 August 2026

38%+25 pts

  • Mangrove 2 construction site, inspection photo 1, 10 August 2026
  • Mangrove 2 construction site, inspection photo 2, 10 August 2026
  • Mangrove 2 construction site, inspection photo 3, 10 August 2026
  • Mangrove 2 construction site, inspection photo 4, 10 August 2026

19 January 2026

13%+13 pts

  • Mangrove 2 construction site, inspection photo 1, 19 January 2026
  • Mangrove 2 construction site, inspection photo 2, 19 January 2026
  • Mangrove 2 construction site, inspection photo 3, 19 January 2026
  • Mangrove 2 construction site, inspection photo 4, 19 January 2026

3 July 2025

0%

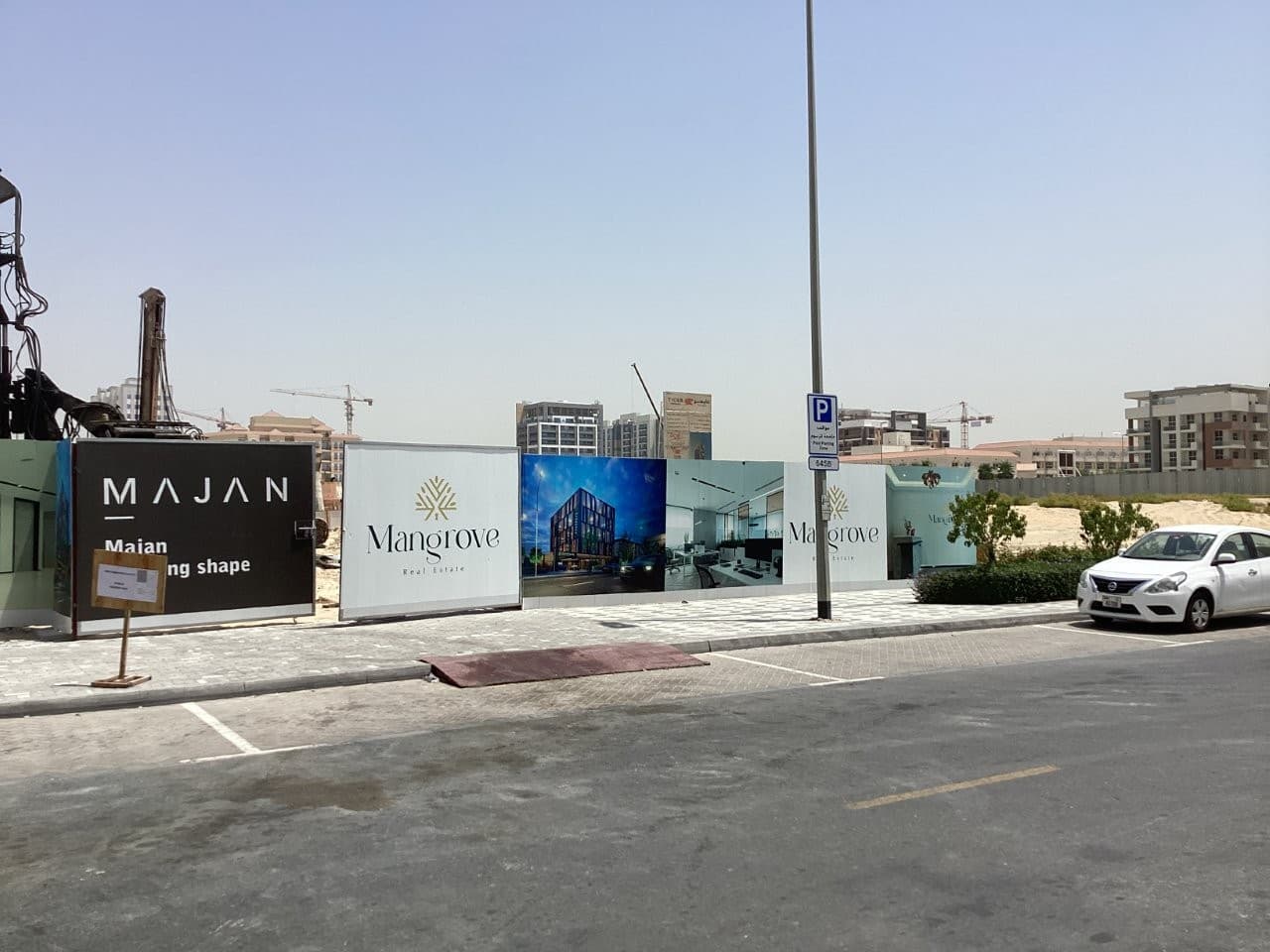

  • Mangrove 2 construction site, inspection photo 1, 3 July 2025
  • Mangrove 2 construction site, inspection photo 2, 3 July 2025

All 19 site photos, by inspection date

Context

Majan has 25 projects under construction, 28% built on average.

Own a unit in Mangrove 2?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Mangrove 2 handover date?
The registered completion date was September 2026, and the register still lists Mangrove 2 as under construction. At the pace of its recent inspections the site would reach 100% around December 2027. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Mangrove 2?
Mangrove 2 was 38% built at the site inspection on 10 August 2026. The site has been inspected 3 times since July 2025. The Land Department took 19 site photos at its inspections.
Is Mangrove 2 delayed?
Yes. Its registered completion date of September 2026 has passed and the project is still listed as under construction.
Who is building Mangrove 2?
The registered developer is Mangrove Real Estate Development.
Which bank holds the escrow account for Mangrove 2?
Arab Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
