Living Legends Phase 4 construction progress
Living Legends Phase 4 in Living Legends is 62% built at the Land Department inspection of March 2026. Developer Amer Alghurair Real Estate Development Co. Completion registered for March 2027.
62%
Built, at the Land Department site inspection of 13 March 2026
On pace for its date
- Completion date (Land Department)
- March 2027
- Finish at recent pace
- May 2027
- Construction started
- June 2024
- Registered with the Land Department
- June 2024
- Developer
- Amer Alghurair Real Estate Development Co
- Community
- Living Legends
- Units
- 555
- Escrow bank
- Abu Dhabi Islamic Bank
- Name in Arabic
- الأساطير الحية المرحلة 4
- Land Department project number
- 1323
- Land Department site inspections
- 18
Schedule
Since July 2025 Living Legends Phase 4 has added about 2.8 points a month. That puts 100% around May 2027, within three months of its registered completion date of March 2027.
Site inspections
13 March 2026
62%+22 pts
15 July 2025
40%+7.3 pts
5 December 2024
33%+2.2 pts

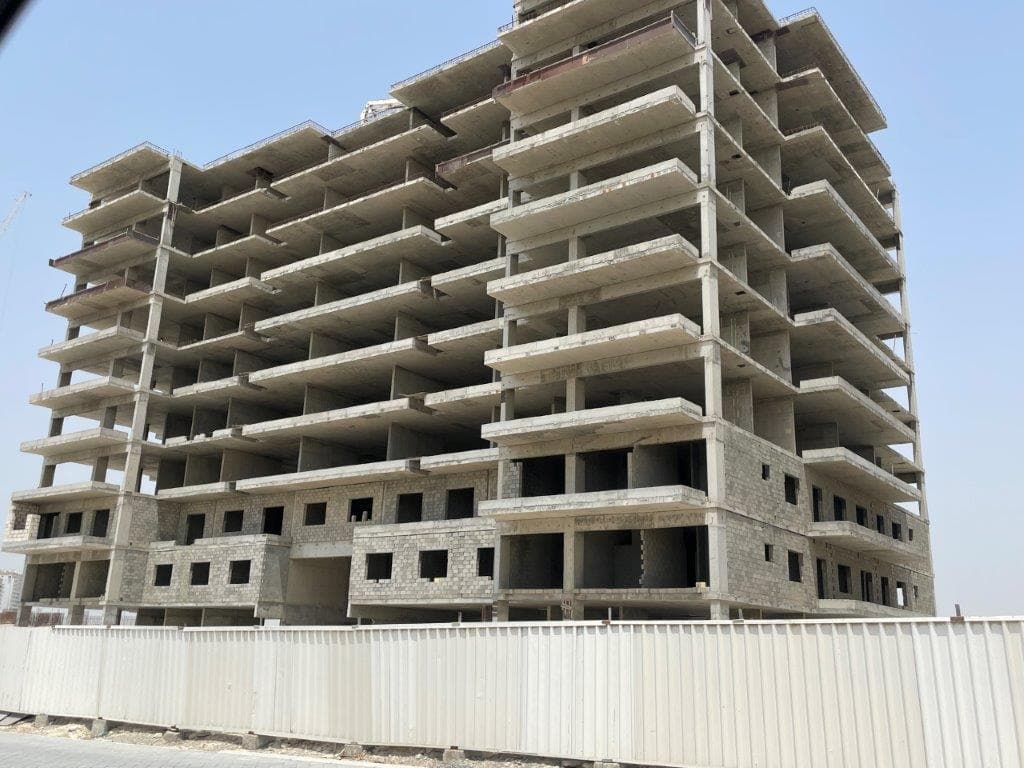

31 October 2024
31%+2.4 pts
28 April 2021
28%
28 May 2020
28%
23 July 2019
28%
10 March 2019
30%
8 May 2018
30%+0.5 pts
14 February 2017
29%+5.2 pts
Context
Living Legends has 6 projects under construction, 49% built on average. Living Legends Phase 4 is ahead of that average.
Amer Alghurair Real Estate Development Co has 2 projects under construction in Dubai; 1 has passed its registered completion date.
Own a unit in Living Legends Phase 4?
Mulki follows this project for you: each new Land Department inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Track the handoverQuestions
- When will Living Legends Phase 4 be completed?
- The completion date registered with the Dubai Land Department is March 2027. At the pace of its recent inspections the site would reach 100% around May 2027. Developers can apply to the Land Department to extend the date, so check the register before relying on it.
- How much of Living Legends Phase 4 is built?
- 62%, measured at the Land Department site inspection on 13 March 2026. The Land Department engineers have inspected the site 18 times since November 2012.
- Is Living Legends Phase 4 delayed?
- Not on current figures. At the rate of the last year it finishes within three months of its registered date of March 2027.
- Who is building Living Legends Phase 4?
- The registered developer is Amer Alghurair Real Estate Development Co. It has 1 other project under construction in Dubai.
- Which bank holds the escrow account for Living Legends Phase 4?
- Abu Dhabi Islamic Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- Living Legends Phase 5Also by Amer Alghurair Real Estate Development Co. 49%, Due March 2025, passed.
- Living Legends Phase 6Nearby in Living Legends. 77%, Due July 2026, passed.
- Living Legends Phase 7Nearby in Living Legends. 92%, Due September 2021, passed.
- The Wilds 1Nearby in Living Legends. 7.5%, Due January 2029.
- The Wilds 2Nearby in Living Legends. 5.7%, Due February 2029.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of Land Department inspections, not a forecast from the developer. Site photos belong to the Dubai Land Department. See how Mulki works with Land Department data.
.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)
