Alfal Residences construction progress
The registered completion date for Alfal Residences in Jumeirah Village Circle is February 2027. At the last site inspection, in September 2026, it was 25% built. The developer is Dubuild Real Estate Development.
25%
Built, at the site inspection of 25 September 2026
Running behind its date
- Registered completion date
- February 2027
- Finish at recent pace
- September 2030
- Construction started
- July 2024
- First registered
- August 2024
- Developer
- Dubuild Real Estate Development
- Community
- Jumeirah Village Circle
- Units
- 285
- Escrow bank
- Emirates Islamic Bank
- Name in Arabic
- الفال ريزيدنسيز
- Project number
- 3190
- Site inspections
- 5
Schedule
Between November 2025 and September 2026 the site added about 1.6 points a month. At that rate it would finish around September 2030, more than three months after its registered date of February 2027.
Site inspections

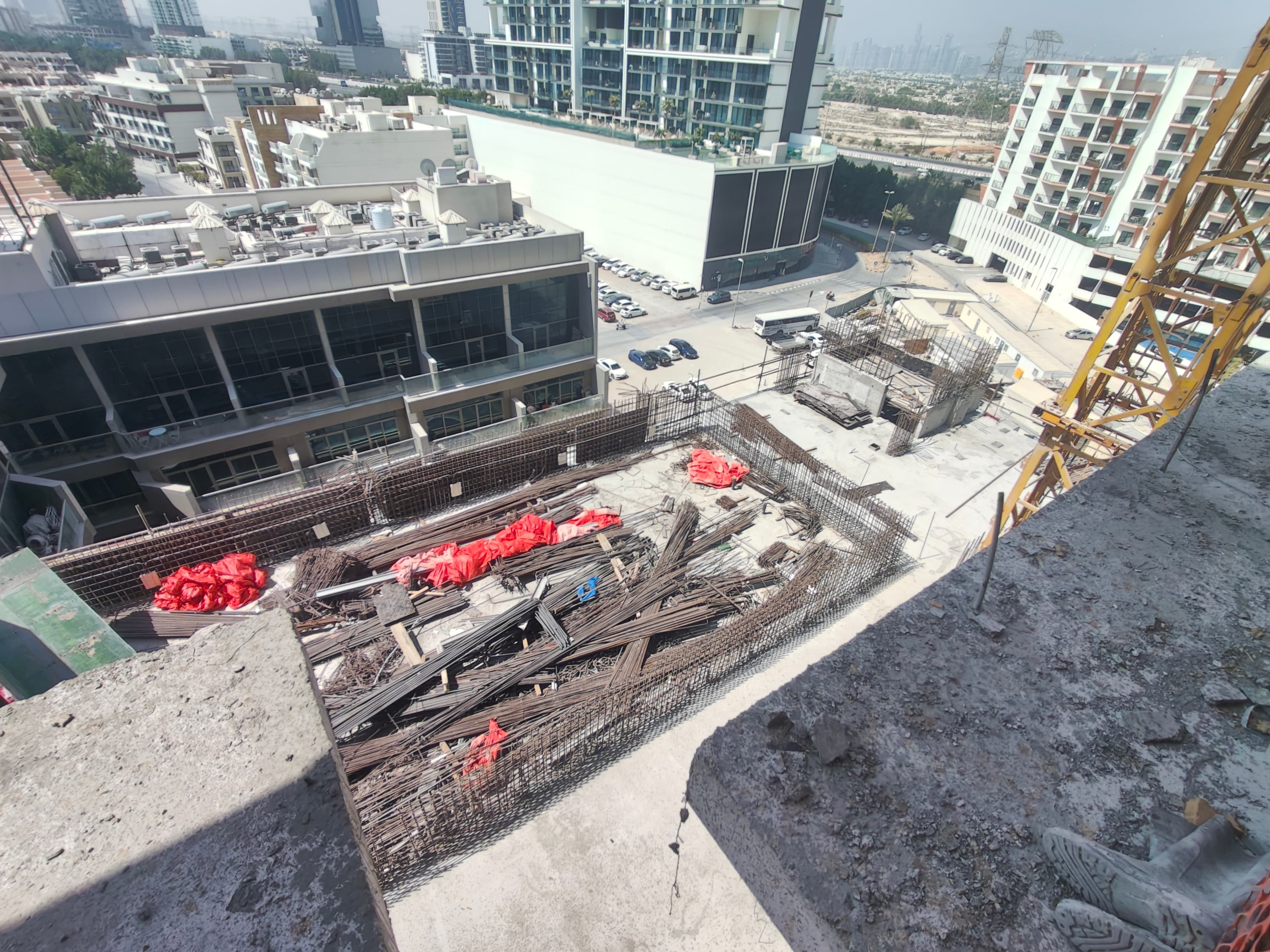

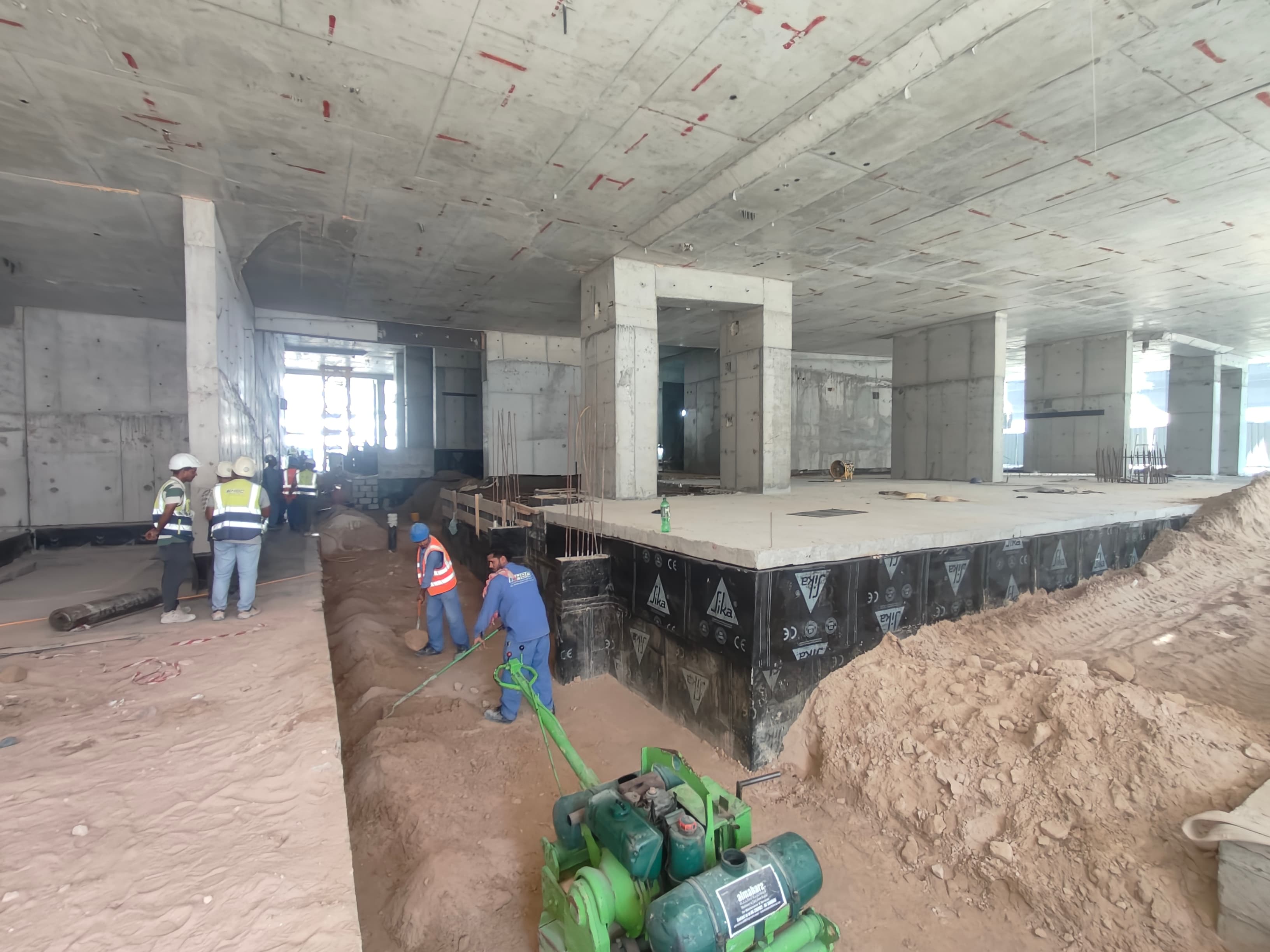

25 September 2026
25%+11 pts

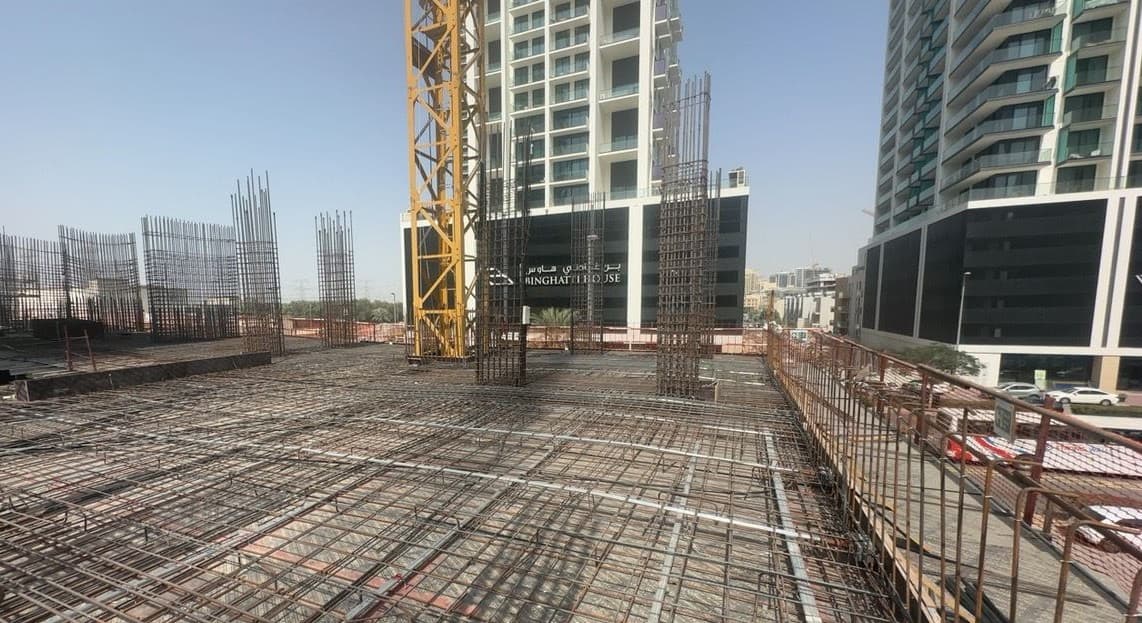

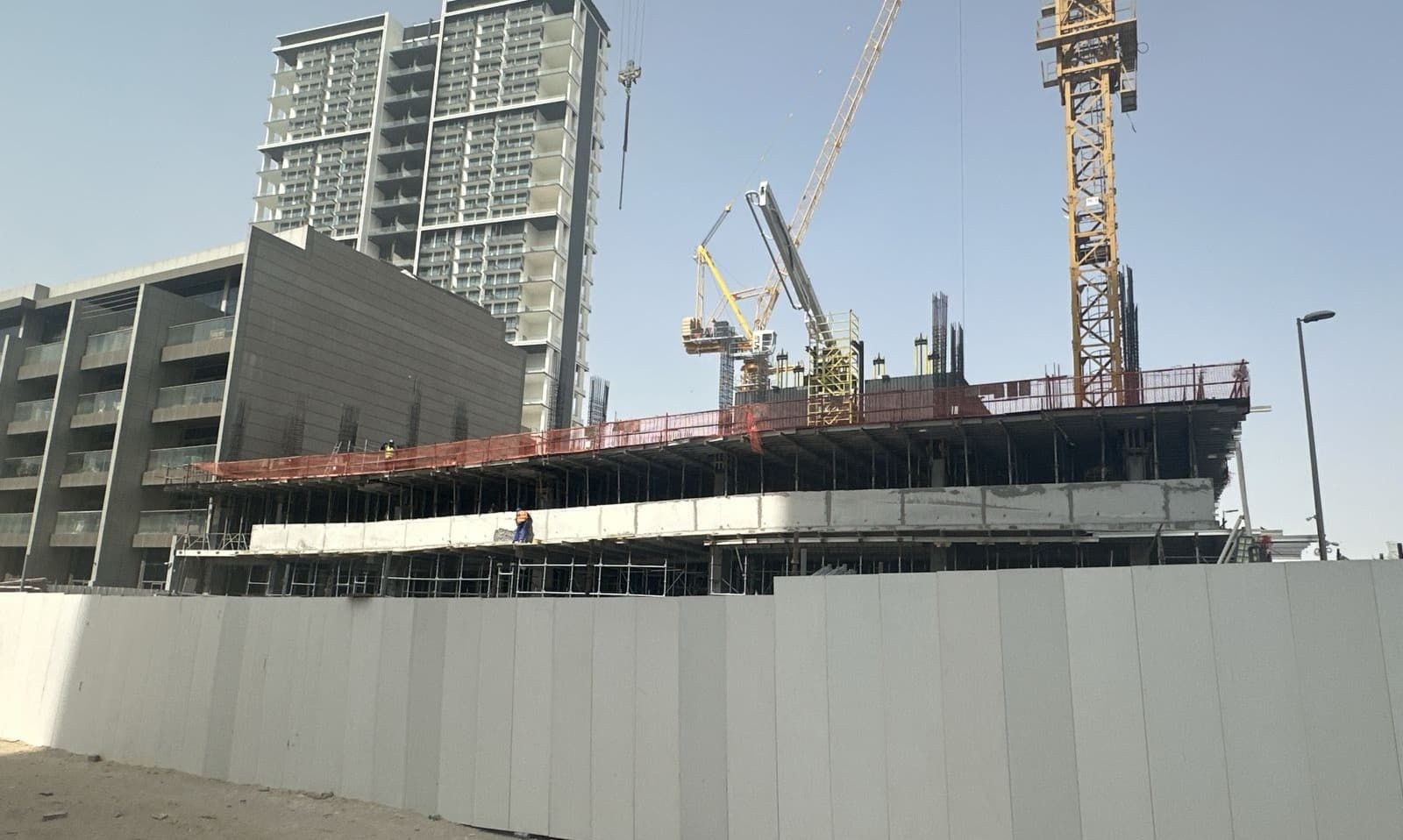

4 March 2026
14%+4.4 pts

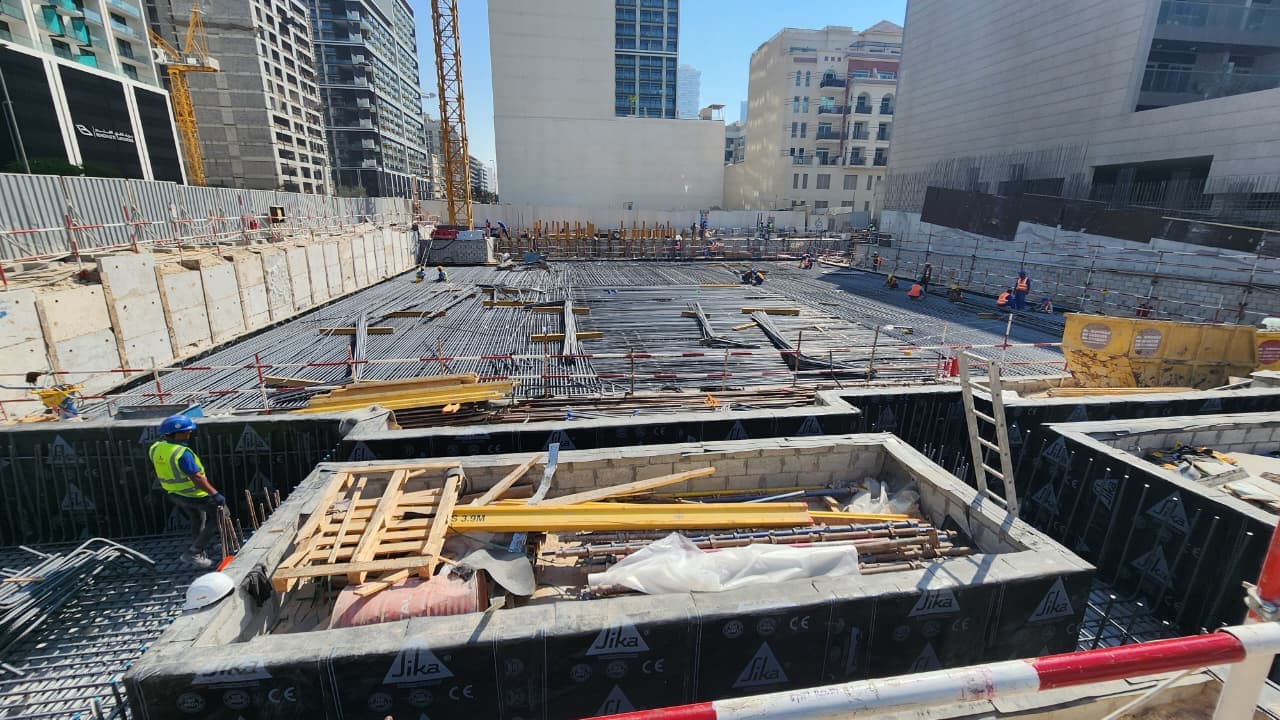

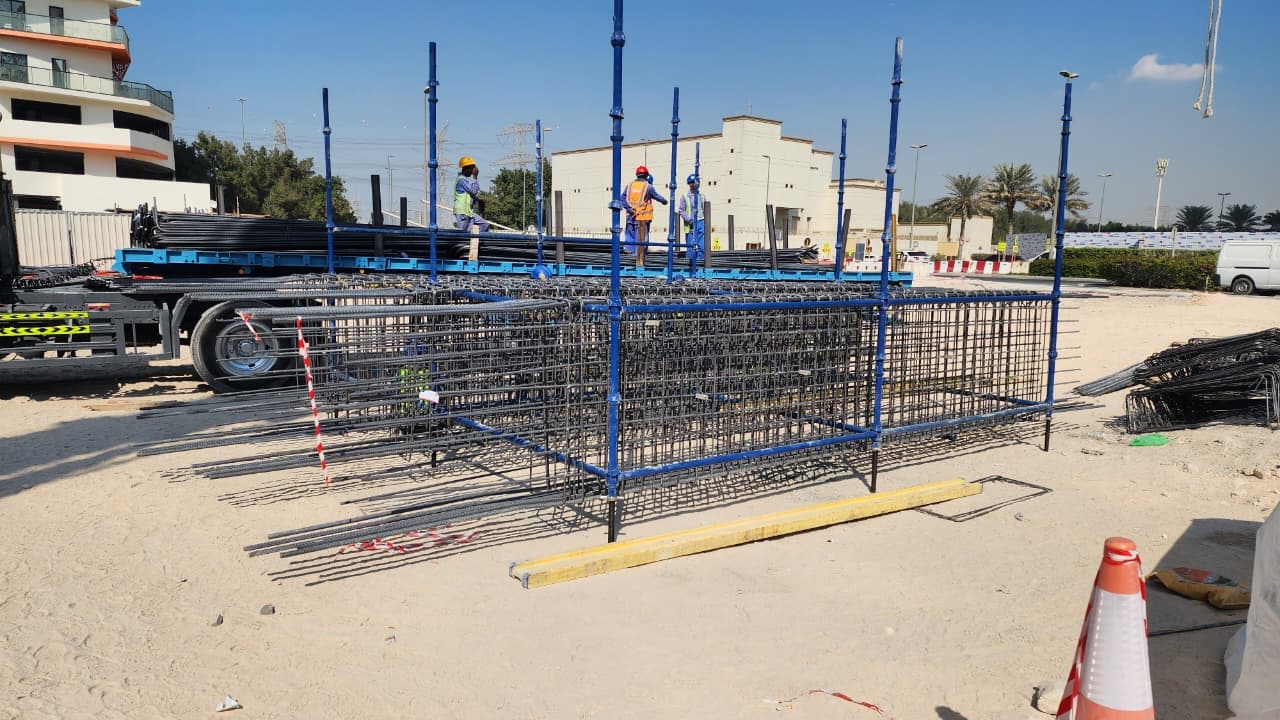

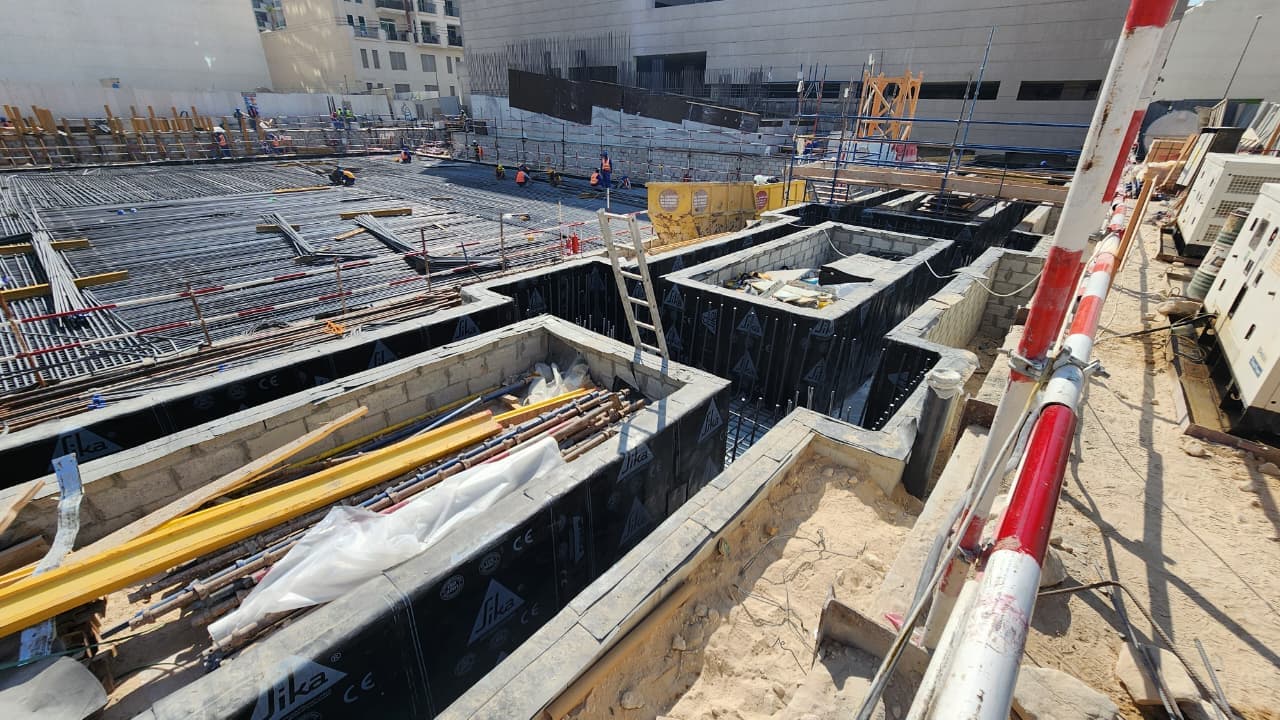

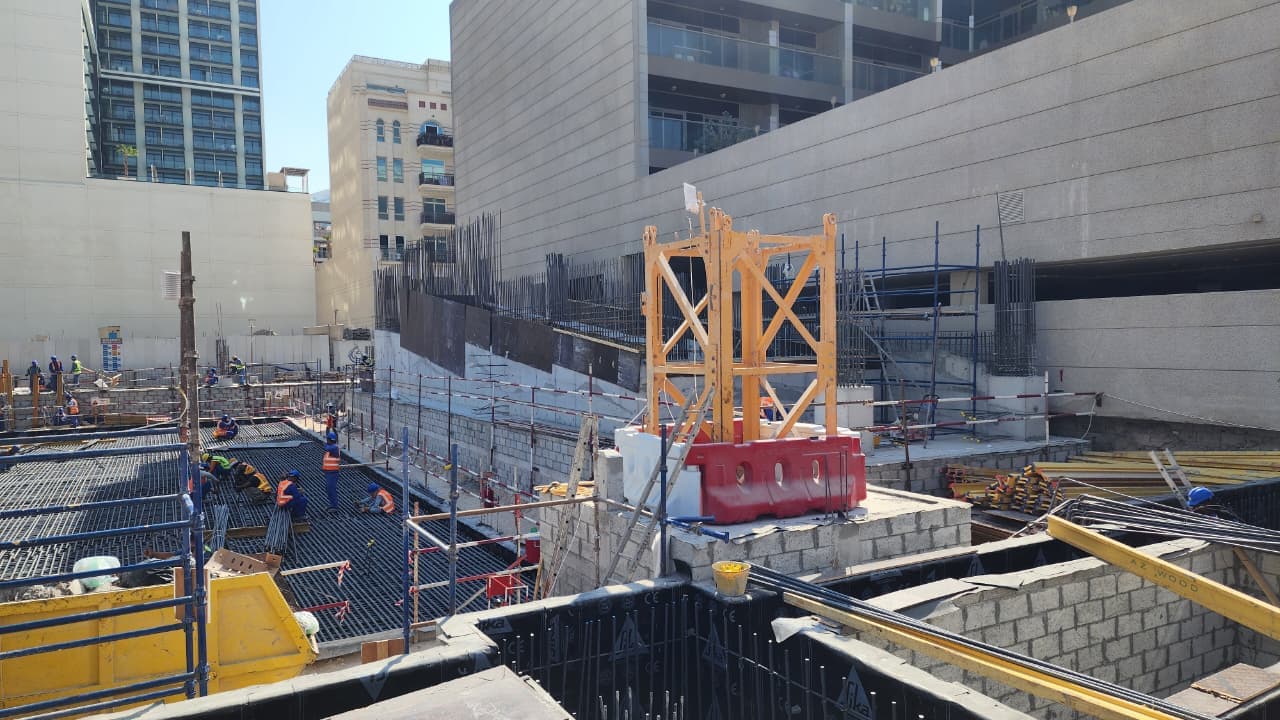

26 November 2025
9.3%+1.5 pts

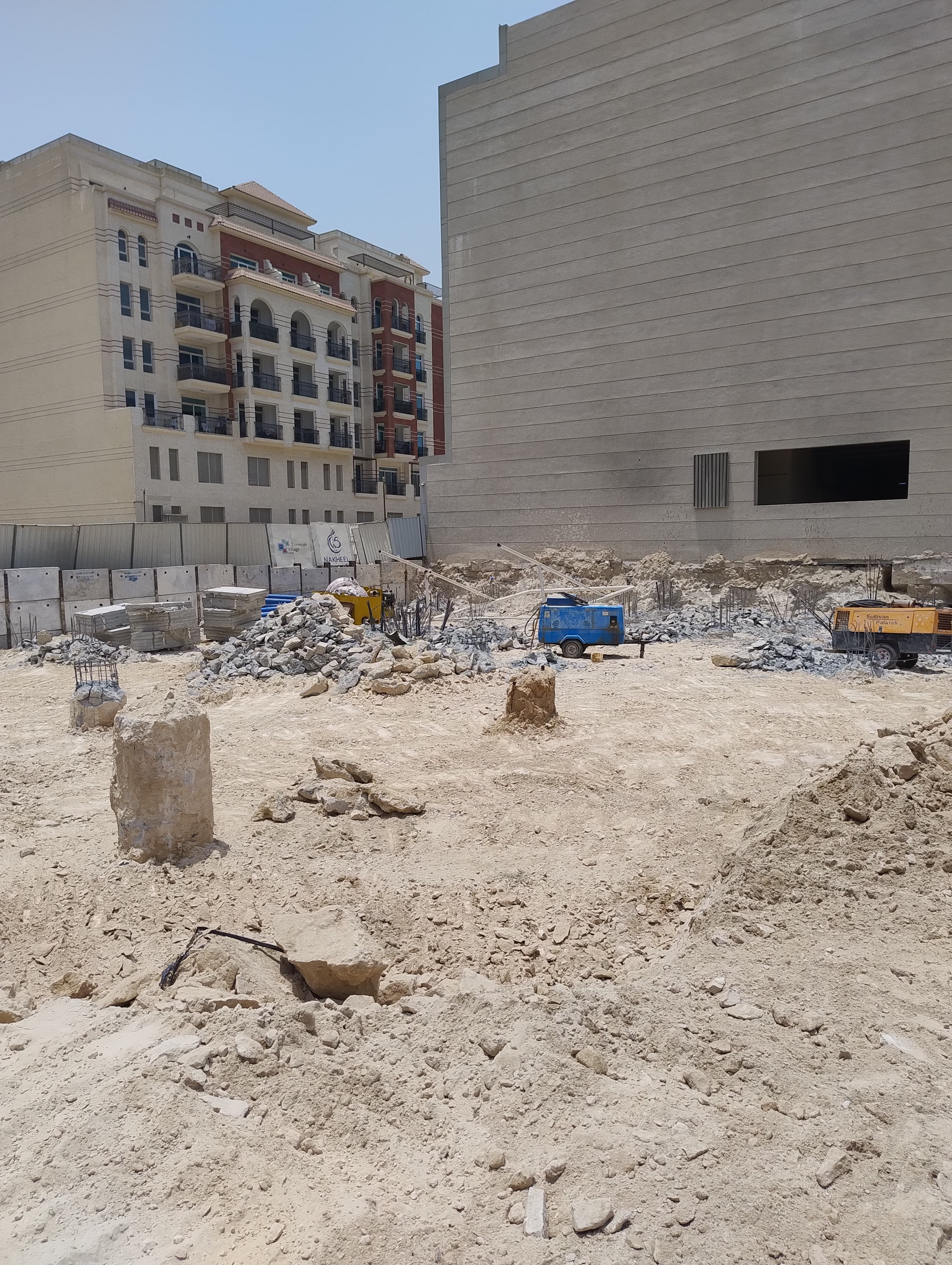

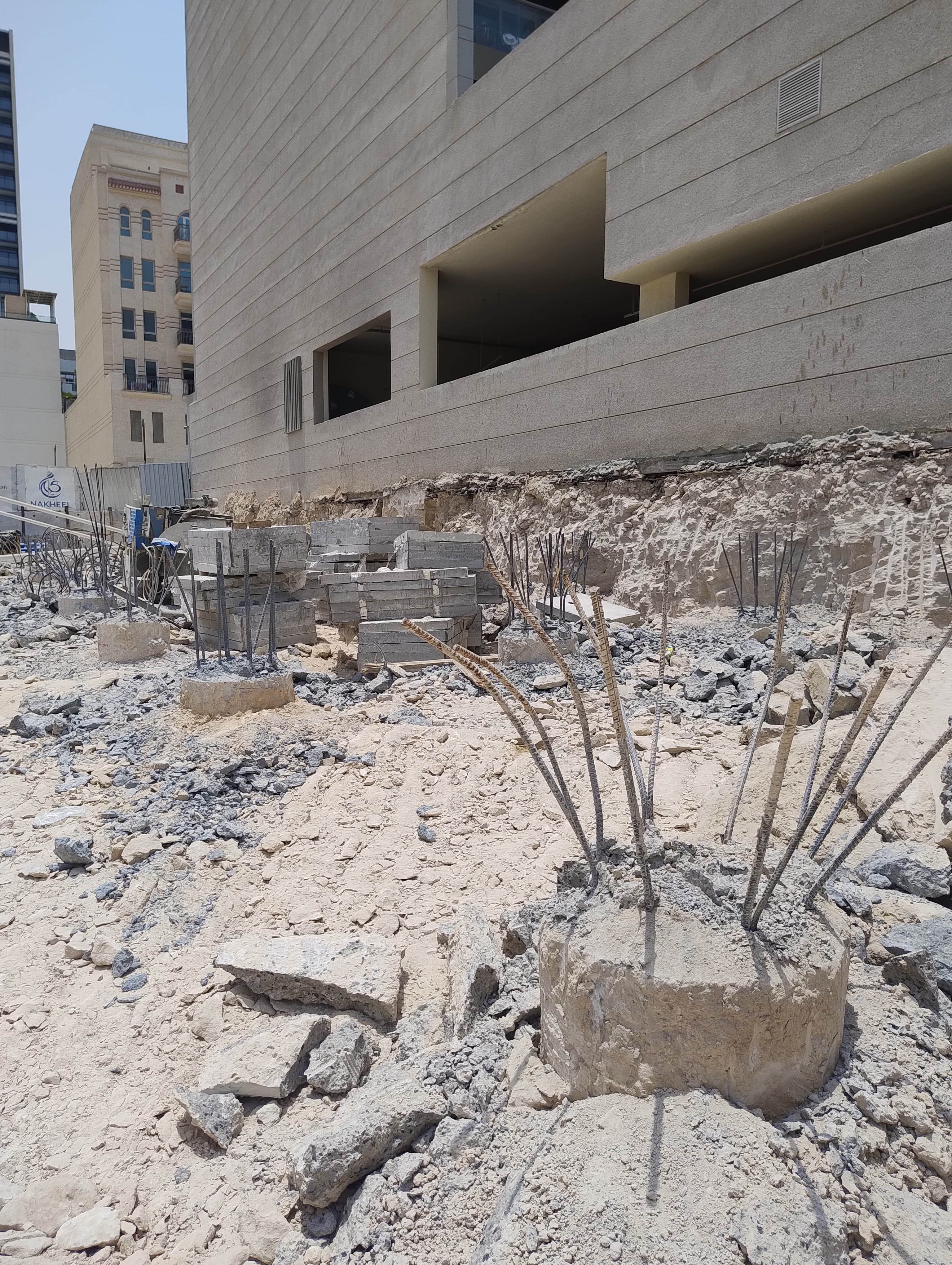

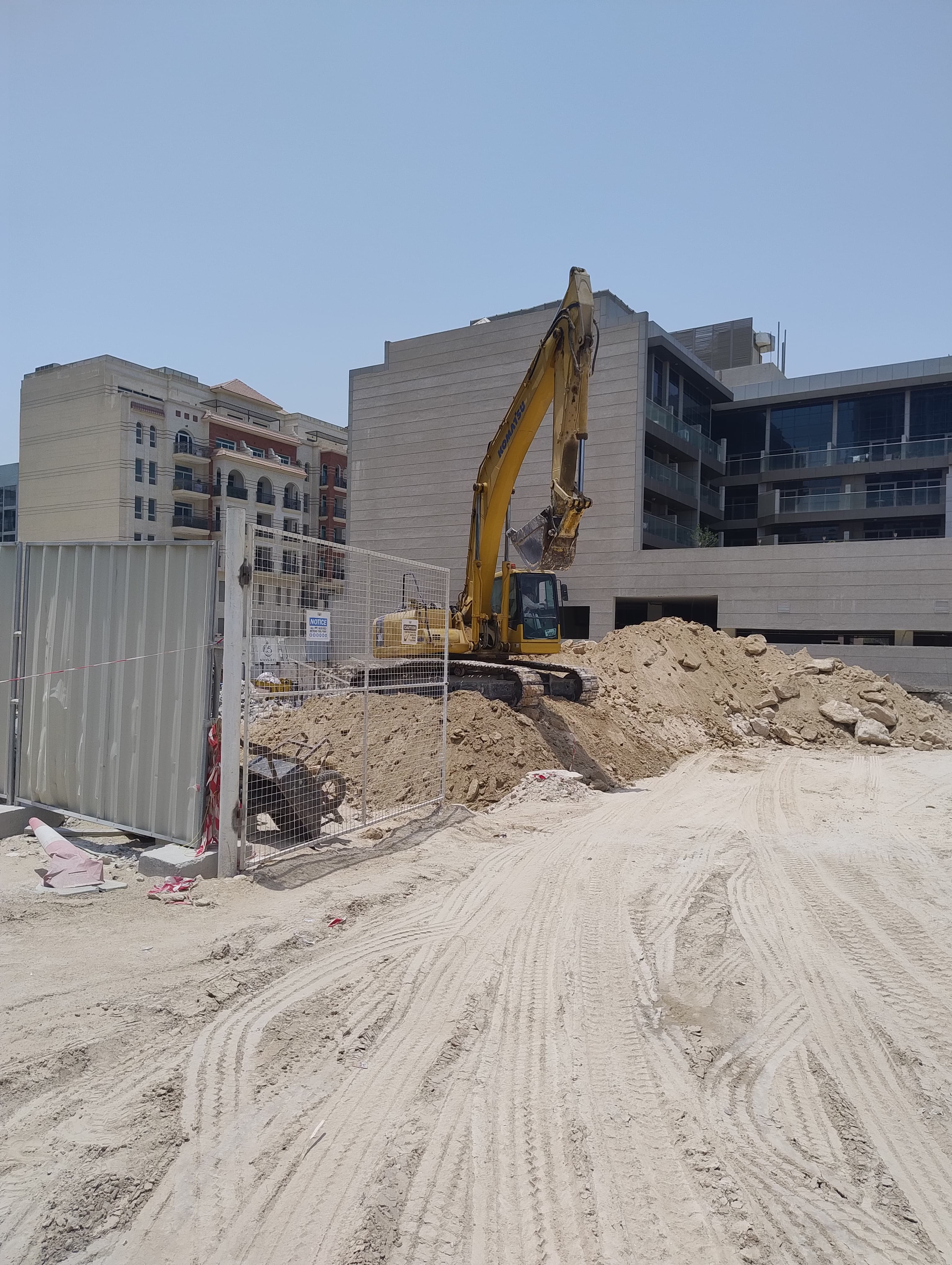

9 July 2025
7.7%+7.7 pts

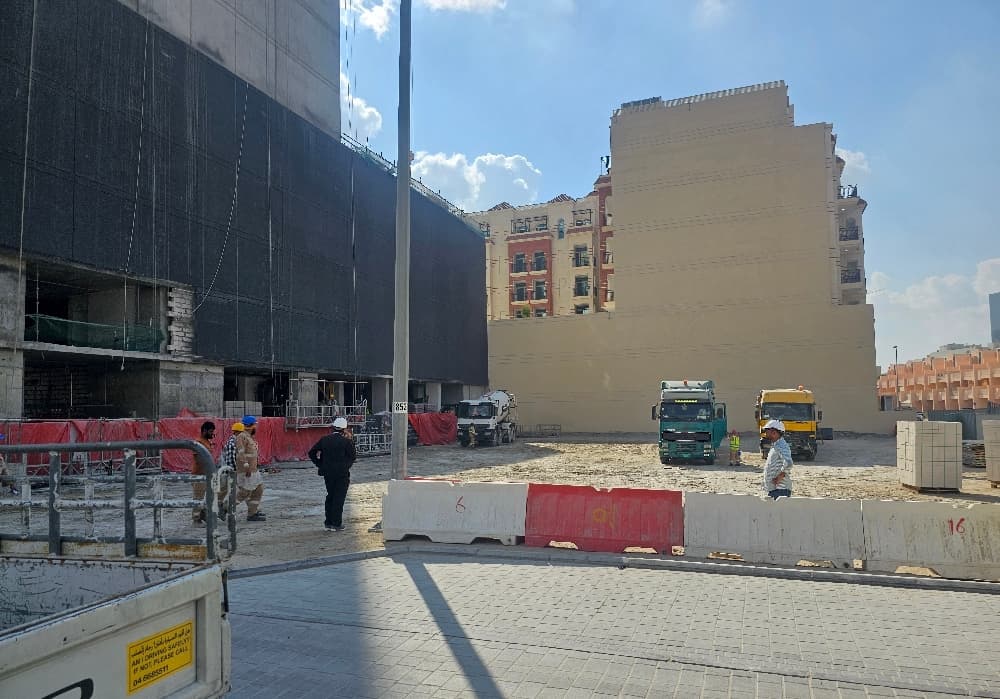

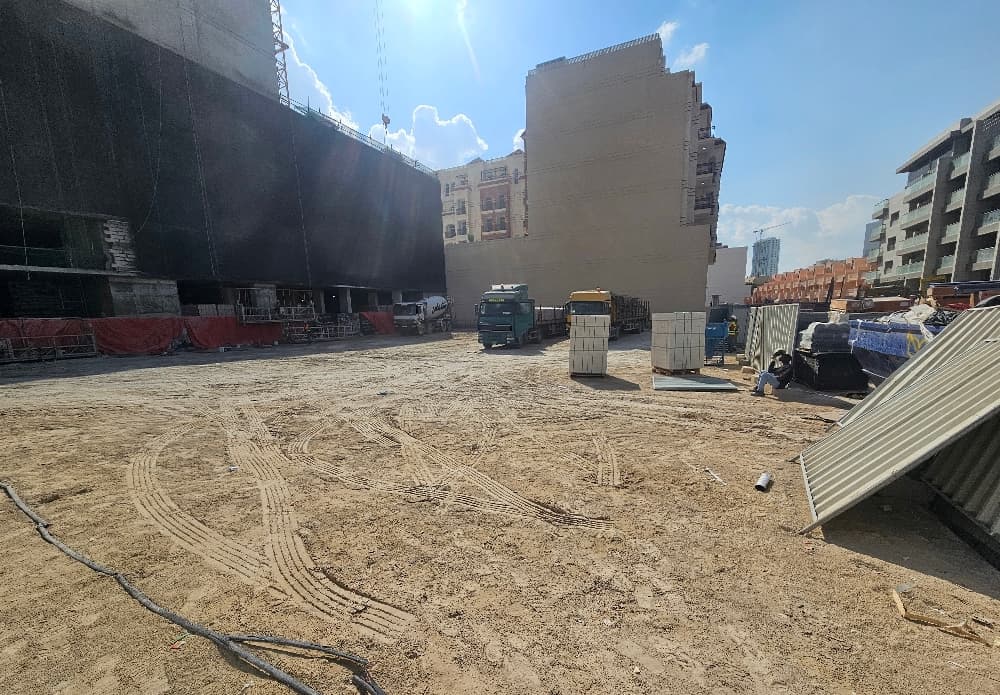

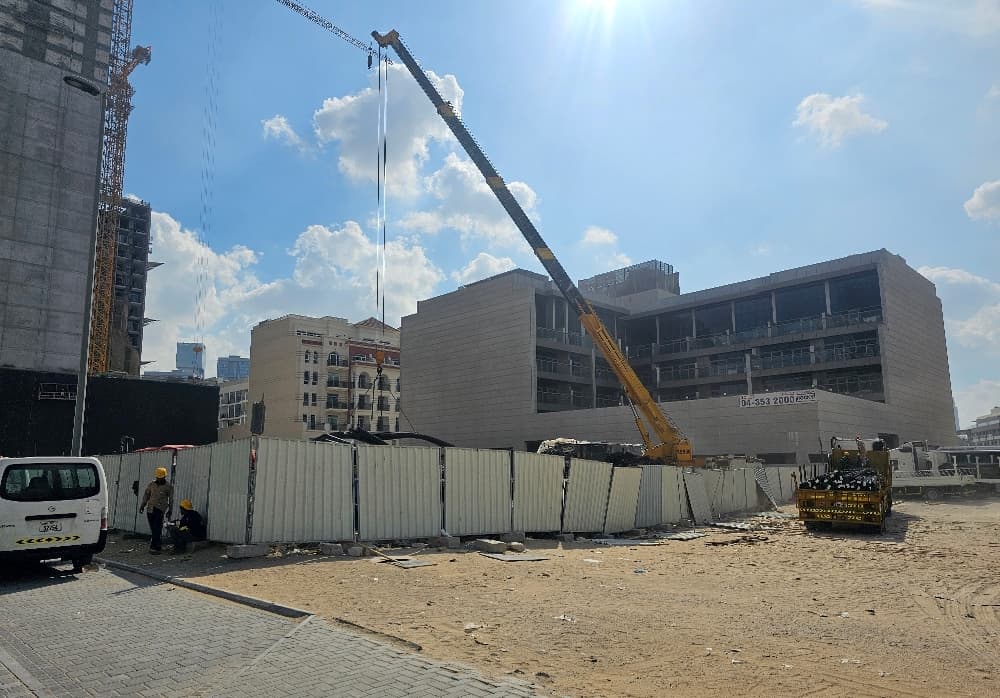

6 August 2024
0%
Context
Jumeirah Village Circle has 118 projects under construction, 42% built on average.
Own a unit in Alfal Residences?
Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When is the Alfal Residences handover date?
- The registered completion date is February 2027. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around September 2030. RERA asks developers to update their dates as projects move, so check the register before relying on it.
- What is the latest construction update on Alfal Residences?
- Alfal Residences was 25% built at the site inspection on 25 September 2026. The site has been inspected 5 times since August 2024. The Land Department took 29 site photos at its inspections.
- Is Alfal Residences delayed?
- It is running behind. At the rate of the last year it would finish more than three months after its registered date of February 2027.
- Who is building Alfal Residences?
- The registered developer is Dubuild Real Estate Development.
- Which bank holds the escrow account for Alfal Residences?
- Emirates Islamic Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- German Supreme Tower 2Nearby in Jumeirah Village Circle. 45%, Due January 2029.
- Aliva GreenNearby in Jumeirah Village Circle. 52%, Due November 2025, passed.
- Dusit Princess RijasNearby in Jumeirah Village Circle. 64%, Due April 2027.
- Samana WavesNearby in Jumeirah Village Circle. 91%, Due April 2026, passed.
- Checking an off-plan project's progressHow to read the completion percentage and what escrow allows when a payment runs ahead.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.







.jpeg&w=3840&q=75)
